# Avalanche L1s (/docs/avalanche-l1s)
---
title: Avalanche L1s
description: Explore the multi-chain architecture of Avalanche ecosystem.
---
An Avalanche L1 is a sovereign network which defines its own rules regarding its membership and token economics. It is composed of a dynamic subset of Avalanche validators working together to achieve consensus on the state of one or more blockchains. Each blockchain is validated by exactly one Avalanche L1, while an Avalanche L1 can validate many blockchains.

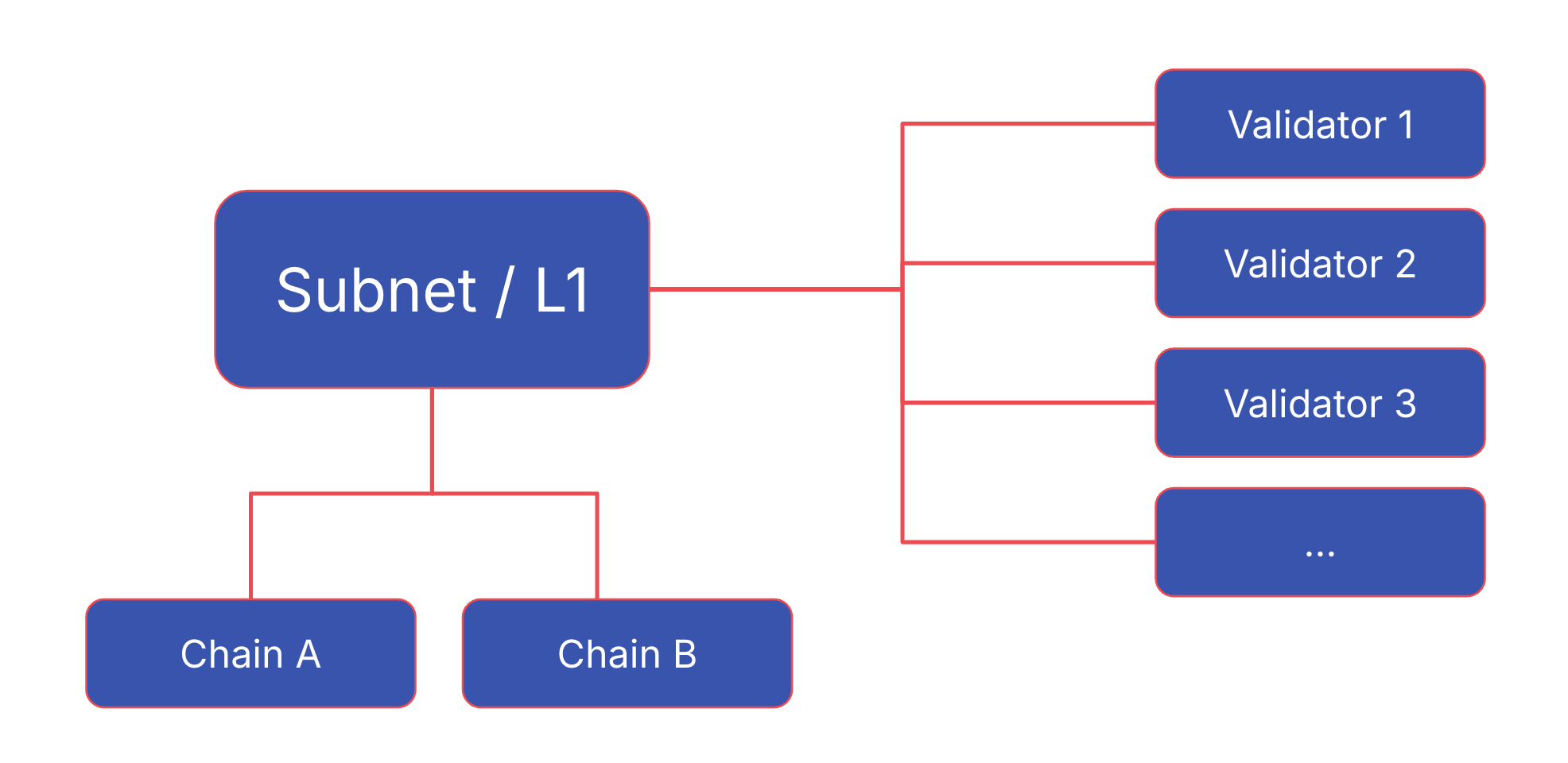

Avalanche's [Primary Network](/docs/primary-network) is a special Avalanche L1 running three blockchains:
- The Platform Chain [(P-Chain)](/docs/primary-network#p-chain-platform-chain)
- The Contract Chain [(C-Chain)](/docs/primary-network#c-chain-contract-chain)
- The Exchange Chain [(X-Chain)](/docs/primary-network#x-chain-exchange-chain)

Every validator of an Avalanche L1 **must** sync the P-Chain of the Primary Network for interoperability.
Node operators that validate an Avalanche L1 with multiple chains do not need to run multiple machines for validation. For example, the Primary Network is an Avalanche L1 with three coexisting chains, all of which can be validated by a single node, or a single machine.
## Advantages
### Independent Networks
- Avalanche L1s use virtual machines to specify their own execution logic, determine their own fee regime, maintain their own state, facilitate their own networking, and provide their own security.
- Each Avalanche L1's performance is isolated from other Avalanche L1s in the ecosystem, so increased usage on one Avalanche L1 won't affect another.
- Avalanche L1s can have their own token economics with their own native tokens, fee markets, and incentives determined by the Avalanche L1 deployer.
- One Avalanche L1 can host multiple blockchains with customized [virtual machines](/docs/primary-network/virtual-machines).
### Native Interoperability
Avalanche Warp Messaging enables native cross-Avalanche L1 communication and allows Virtual Machine (VM) developers to implement arbitrary communication protocols between any two Avalanche L1s.
### Accommodate App-Specific Requirements
Different blockchain-based applications may require validators to have certain properties such as large amounts of RAM or CPU power.
an Avalanche L1 could require that validators meet certain [hardware requirements](/docs/nodes/system-requirements#hardware-and-operating-systems) so that the application doesn't suffer from low performance due to slow validators.
### Launch Networks Designed With Compliance
Avalanche's L1 architecture makes regulatory compliance manageable. As mentioned above, an Avalanche L1 may require validators to meet a set of requirements.
Some examples of requirements the creators of an Avalanche L1 may choose include:
- Validators must be located in a given country.
- Validators must pass KYC/AML checks.
- Validators must hold a certain license.
### Control Privacy of On-Chain Data
Avalanche L1s are ideal for organizations interested in keeping their information private.
Institutions conscious of their stakeholders' privacy can create a private Avalanche L1 where the contents of the blockchains would be visible only to a set of pre-approved validators.
Define this at creation with a [single parameter](/docs/nodes/configure/avalanche-l1-configs#private-avalanche-l1).
### Validator Sovereignty
In a heterogeneous network of blockchains, some validators will not want to validate certain blockchains because they simply have no interest in those blockchains.
The Avalanche L1 model enables validators to concern themselves only with blockchain networks they choose to participate in. This greatly reduces the computational burden on validators.
## Why Build Your Own Avalanche L1
There are many advantages to running your own Avalanche L1. If you find one or more of these a good match for your project then an Avalanche L1 might be a good solution for you.
### We Want Our Own Gas Token
C-Chain is an Ethereum Virtual Machine (EVM) chain; it requires the gas fees to be paid in its native token. That is, the application may create its own utility tokens (ERC-20) on the C-Chain, but the gas must be paid in AVAX. In the meantime, [Subnet-EVM](https://github.com/ava-labs/subnet-evm) effectively creates an application-specific EVM-chain with full control over native(gas) coins. The operator can pre-allocate the native tokens in the chain genesis, and mint more using the [Subnet-EVM](https://github.com/ava-labs/subnet-evm) precompile contract. And these fees can be either burned (as AVAX burns in C-Chain) or configured to be sent to an address which can be a smart contract.
Note that the Avalanche L1 gas token is specific to the application in the chain, thus unknown to the external parties. Moving assets to other chains requires trusted bridge contracts (or upcoming cross Avalanche L1 communication feature).
### We Want Higher Throughput
The primary goal of the gas limit on C-Chain is to restrict the block size and therefore prevent network saturation. If a block can be arbitrarily large, it takes longer to propagate, potentially degrading the network performance. The C-Chain gas limit acts as a deterrent against any system abuse but can be quite limiting for high throughput applications. Unlike C-Chain, Avalanche L1 can be single-tenant, dedicated to the specific application, and thus host its own set of validators with higher bandwidth requirements, which allows for a higher gas limit thus higher transaction throughput. Plus, [Subnet-EVM](https://github.com/ava-labs/subnet-evm) supports fee configuration upgrades that can be adaptive to the surge in application traffic.
Avalanche L1 workloads are isolated from the Primary Network; which means, the noisy neighbor effect of one workload (for example NFT mint on C-Chain) cannot destabilize the Avalanche L1 or surge its gas price. This failure isolation model in the Avalanche L1 can provide higher application reliability.
### We Want Strict Access Control
The C-Chain is open and permissionless where anyone can deploy and interact with contracts. However, for regulatory reasons, some applications may need a consistent access control mechanism for all on-chain transactions. With [Subnet-EVM](https://github.com/ava-labs/subnet-evm), an application can require that "only authorized users may deploy contracts or make transactions." Allow-lists are only updated by the administrators, and the allow list itself is implemented within the precompile contract, thus more transparent and auditable for compliance matters.
### We Need EVM Customization
If your project is deployed on the C-Chain then your execution environment is dictated by the setup of the C-Chain. Changing any of the execution parameters means that the configuration of the C-Chain would need to change, and that is expensive, complex and difficult to change. So if your project needs some other capabilities, different execution parameters or precompiles that C-Chain does not provide, then Avalanche L1s are a solution you need. You can configure the EVM in an Avalanche L1 to run however you want, adding precompiles, and setting runtime parameters to whatever your project needs.
### We Need Custom Validator Management
With the Etna upgrade, L1s can implement their own validator management logic through a _ValidatorManager_ smart contract. This gives you complete control over your validator set, allowing you to define custom staking rules, implement permissionless proof-of-stake with your own token, or create permissioned proof-of-authority networks. The validator management can be handled directly through smart contracts, giving you programmatic control over validator selection and rewards distribution.
### We Want to Build a Sovereign Network
L1s on Avalanche are truly sovereign networks that operate independently without relying on other systems. You have complete control over your network's consensus mechanisms, transaction processing, and security protocols. This independence allows you to scale horizontally without dependencies on other networks while maintaining full control over your network parameters and upgrades. This sovereignty is particularly important for projects that need complete autonomy over their blockchain's operation and evolution.
## When to Choose an Avalanche L1
Here we presented some considerations in favor of running your own Avalanche L1 vs. deploying on the C-Chain.
If an application has relatively low transaction rate and no special circumstances that would make the C-Chain a non-starter, you can begin with C-Chain deployment to leverage existing technical infrastructure, and later expand to an Avalanche L1. That way you can focus on working on the core of your project and once you have a solid product/market fit and have gained enough traction that the C-Chain is constricting you, plan a move to your own Avalanche L1.
Of course, we're happy to talk to you about your architecture and help you choose the best path forward. Feel free to reach out to us on [Discord](https://chat.avalabs.org/) or other [community channels](https://www.avax.network/community) we run.
## Develop Your Own Avalanche L1
Avalanche L1s on Avalanche are deployed by default with [Subnet-EVM](https://github.com/ava-labs/subnet-evm#subnet-evm), a fork of go-ethereum. It implements the Ethereum Virtual Machine and supports Solidity smart contracts as well as most other Ethereum client functionality.
To get started, check out our [L1 Toolbox](/tools/l1-toolbox) or the tutorials in the [Avalanche CLI](/docs/tooling/avalanche-cli) section.
# Simple VM in Any Language (/docs/avalanche-l1s/simple-vm-any-language)
---
title: Simple VM in Any Language
description: Learn how to implement a simple virtual machine in any language.
---
This is a language-agnostic high-level documentation explaining the basics of how to get started at implementing your own virtual machine from scratch.
Avalanche virtual machines are grpc servers implementing Avalanche's [Proto interfaces](https://buf.build/ava-labs/avalanche). This means that it can be done in [any language that has a grpc implementation](https://grpc.io/docs/languages/).
## Minimal Implementation
To get the process started, at the minimum, you will to implement the following interfaces:
- [`vm.Runtime`](https://buf.build/ava-labs/avalanche/docs/main:vm.runtime) (Client)
- [`vm.VM`](https://buf.build/ava-labs/avalanche/docs/main:vm) (Server)
To build a blockchain taking advantage of AvalancheGo's consensus to build blocks, you will need to implement:
- [AppSender](https://buf.build/ava-labs/avalanche/docs/main:appsender) (Client)
- [Messenger](https://buf.build/ava-labs/avalanche/docs/main:messenger) (Client)
To have a json-RPC endpoint, `/ext/bc/subnetId/rpc` exposed by AvalancheGo, you will need to implement:
- [`Http`](https://buf.build/ava-labs/avalanche/docs/main:http) (Server)
You can and should use a tool like `buf` to generate the (Client/Server) code from the interfaces as stated in the [Avalanche module](https://buf.build/ava-labs/avalanche)'s page.
There are _server_ and _client_ interfaces to implement. AvalancheGo calls the _server_ interfaces exposed by your VM and your VM calls the _client_ interfaces exposed by AvalancheGo.
## Starting Process
Your VM is started by AvalancheGo launching your binary. Your binary is started as a sub-process of AvalancheGo. While launching your binary, AvalancheGo passes an environment variable `AVALANCHE_VM_RUNTIME_ENGINE_ADDR` containing an url. We must use this url to initialize a `vm.Runtime` client.
Your VM, after having started a grpc server implementing the VM interface must call the [`vm.Runtime.InitializeRequest`](https://buf.build/ava-labs/avalanche/docs/main:vm.runtime#vm.runtime.InitializeRequest) with the following parameters.
- `protocolVersion`: It must match the `supported plugin version` of the [AvalancheGo release](https://github.com/ava-labs/AvalancheGo/releases) you are using. It is always part of the release notes.
- `addr`: It is your grpc server's address. It must be in the following format `host:port` (example `localhost:12345`)
## VM Initialization
The service methods are described in the same order as they are called. You will need to implement these methods in your server.
### Pre-Initialization Sequence
AvalancheGo starts/stops your process multiple times before launching the real initialization sequence.
1. [VM.Version](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.Version)
- Return: your VM's version.
2. [VM.CreateStaticHandler](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.CreateStaticHandlers)
- Return: an empty array - (Not absolutely required).
3. [VM.Shutdown](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.Shutdown)
- You should gracefully stop your process.
- Return: Empty
### Initialization Sequence
1. [VM.CreateStaticHandlers](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.CreateStaticHandlers)
- Return an empty array - (Not absolutely required).
2. [VM.Initialize](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.Initialize)
- Param: an [InitializeRequest](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.InitializeRequest).
- You must use this data to initialize your VM.
- You should add the genesis block to your blockchain and set it as the last accepted block.
- Return: an [InitializeResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.InitializeResponse) containing data about the genesis extracted from the `genesis_bytes` that was sent in the request.
3. [VM.VerifyHeightIndex](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.VerifyHeightIndex)
- Return: a [VerifyHeightIndexResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VerifyHeightIndexResponse) with the code `ERROR_UNSPECIFIED` to indicate that no error has occurred.
4. [VM.CreateHandlers](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.CreateHandlers)
- To serve json-RPC endpoint, `/ext/bc/subnetId/rpc` exposed by AvalancheGo
- See [json-RPC](#json-rpc) for more detail
- Create a [`Http`](https://buf.build/ava-labs/avalanche/docs/main:http) server and get its url.
- Return: a `CreateHandlersResponse` containing a single item with the server's url. (or an empty array if not implementing the json-RPC endpoint)
5. [VM.StateSyncEnabled](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.StateSyncEnabled)
- Return: `true` if you want to enable StateSync, `false` otherwise.
6. [VM.SetState](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetState) _If you had specified `true` in the `StateSyncEnabled` result_
- Param: a [SetStateRequest](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateRequest) with the `StateSyncing` value
- Set your blockchain's state to `StateSyncing`
- Return: a [SetStateResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateResponse) built from the genesis block.
7. [VM.GetOngoingSyncStateSummary](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.GetOngoingSyncStateSummary) _If you had specified `true` in the `StateSyncEnabled` result_
- Return: a [GetOngoingSyncStateSummaryResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.GetOngoingSyncStateSummaryResponse) built from the genesis block.
8. [VM.SetState](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetState)
- Param: a [SetStateRequest](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateRequest) with the `Bootstrapping` value
- Set your blockchain's state to `Bootstrapping`
- Return: a [SetStateResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateResponse) built from the genesis block.
9. [VM.SetPreference](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetPreference)
- Param: `SetPreferenceRequest` containing the preferred block ID
- Return: Empty
10. [VM.SetState](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetState)
- Param: a [SetStateRequest](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateRequest) with the `NormalOp` value
- Set your blockchain's state to `NormalOp`
- Return: a [SetStateResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateResponse) built from the genesis block.
11. [VM.Connected](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.Connected) (for every other node validating this Avalanche L1 in the network)
- Param: a [ConnectedRequest](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.ConnectedRequest) with the NodeID and the version of AvalancheGo.
- Return: Empty
12. [VM.Health](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.Health)
- Param: Empty
- Return: a [HealthResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.HealthResponse) with an empty `details` property.
13. [VM.ParseBlock](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.ParseBlock)
- Param: A byte array containing a Block (the genesis block in this case)
- Return: a [ParseBlockResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.ParseBlockResponse) built from the last accepted block.
At this point, your VM is fully started and initialized.
### Building Blocks
#### Transaction Gossiping Sequence
When your VM receives transactions (for example using the [json-RPC](#json-rpc) endpoints), it can gossip them to the other nodes by using the [AppSender](https://buf.build/ava-labs/avalanche/docs/main:appsender) service.
Supposing we have a 3 nodes network with nodeX, nodeY, nodeZ. Let's say NodeX has received a new transaction on it's json-RPC endpoint.
[`AppSender.SendAppGossip`](https://buf.build/ava-labs/avalanche/docs/main:appsender#appsender.AppSender.SendAppGossip) (_client_): You must serialize your transaction data into a byte array and call the `SendAppGossip` to propagate the transaction.
AvalancheGo then propagates this to the other nodes.
[VM.AppGossip](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.AppGossip): You must deserialize the transaction and store it for the next block.
- Param: A byte array containing your transaction data, and the NodeID of the node which sent the gossip message.
- Return: Empty
#### Block Building Sequence
Whenever your VM is ready to build a new block, it will initiate the block building process by using the [Messenger](https://buf.build/ava-labs/avalanche/docs/main:messenger) service. Supposing that nodeY wants to build the block. you probably will implement some kind of background worker checking every second if there are any pending transactions:
_client_ [`Messenger.Notify`](https://buf.build/ava-labs/avalanche/docs/main:messenger#messenger.Messenger.Notify): You must issue a notify request to AvalancheGo by calling the method with the `MESSAGE_BUILD_BLOCK` value.
1. [VM.BuildBlock](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BuildBlock)
- Param: Empty
- You must build a block with your pending transactions. Serialize it to a byte array.
- Store this block in memory as a "pending blocks"
- Return: a [BuildBlockResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.BuildBlockResponse) from the newly built block and it's associated data (`id`, `parent_id`, `height`, `timestamp`).
2. [VM.BlockVerify](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockVerify)
- Param: The byte array containing the block data
- Return: the block's timestamp
3. [VM.SetPreference](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetPreference)
- Param: The block's ID
- You must mark this block as the next preferred block.
- Return: Empty
1. [VM.ParseBlock](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.ParseBlock)
- Param: A byte array containing a the newly built block's data
- Store this block in memory as a "pending blocks"
- Return: a [ParseBlockResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.ParseBlockResponse) built from the last accepted block.
2. [VM.BlockVerify](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockVerify)
- Param: The byte array containing the block data
- Return: the block's timestamp
3. [VM.SetPreference](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetPreference)
- Param: The block's ID
- You must mark this block as the next preferred block.
- Return: Empty
[VM.BlockAccept](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockAccept): You must accept this block as your last final block.
- Param: The block's ID
- Return: Empty
#### Managing Conflicts
Conflicts happen when two or more nodes propose the next block at the same time. AvalancheGo takes care of this and decides which block should be considered final, and which blocks should be rejected using Snowman consensus. On the VM side, all there is to do is implement the `VM.BlockAccept` and `VM.BlockReject` methods.
_nodeX proposes block `0x123...`, nodeY proposes block `0x321...` and nodeZ proposes block `0x456`_
There are three conflicting blocks (different hashes), and if we look at our VM's log files, we can see that AvalancheGo uses Snowman to decide which block must be accepted.
```bash
... snowman/voter.go:58 filtering poll results ...
... snowman/voter.go:65 finishing poll ...
... snowman/voter.go:87 Snowman engine can't quiesce
...
... snowman/voter.go:58 filtering poll results ...
... snowman/voter.go:65 finishing poll ...
... snowman/topological.go:600 accepting block
```
Supposing that AvalancheGo accepts block `0x123...`. The following RPC methods are called on all nodes:
1. [VM.BlockAccept](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockAccept): You must accept this block as your last final block.
- Param: The block's ID (`0x123...`)
- Return: Empty
2. [VM.BlockReject](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockReject): You must mark this block as rejected.
- Param: The block's ID (`0x321...`)
- Return: Empty
3. [VM.BlockReject](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockReject): You must mark this block as rejected.
- Param: The block's ID (`0x456...`)
- Return: Empty
### JSON-RPC
To enable your json-RPC endpoint, you must implement the [HandleSimple](https://buf.build/ava-labs/avalanche/docs/main:http#http.HTTP.HandleSimple) method of the [`Http`](https://buf.build/ava-labs/avalanche/docs/main:http) interface.
- Param: a [HandleSimpleHTTPRequest](https://buf.build/ava-labs/avalanche/docs/main:http#http.HandleSimpleHTTPRequest) containing the original request's method, url, headers, and body.
- Analyze, deserialize and handle the request. For example: if the request represents a transaction, we must deserialize it, check the signature, store it and gossip it to the other nodes using the [messenger client](#block-building-sequence)).
- Return the [HandleSimpleHTTPResponse](https://buf.build/ava-labs/avalanche/docs/main:http#http.HandleSimpleHTTPResponse) response that will be sent back to the original sender.
This server is registered with AvalancheGo during the [initialization process](#initialization-sequence) when the `VM.CreateHandlers` method is called. You must simply respond with the server's url in the `CreateHandlersResponse` result.
# Introduction (/docs/avalanche-l1s/virtual-machines-index)
---
title: Introduction
description: Learn about the execution layer of a blockchain network.
---
A Virtual Machine (VM) is a blueprint for a blockchain. Blockchains are instantiated from a VM, similar to how objects are instantiated from a class definition. VMs can define anything you want, but will generally define transactions that are executed and how blocks are created.
## Blocks and State
Virtual Machines deal with blocks and state. The functionality provided by VMs is to:
- Define the representation of a blockchain's state
- Represent the operations in that state
- Apply the operations in that state
Each block in the blockchain contains a set of state transitions. Each block is applied in order from the blockchain's initial genesis block to its last accepted block to reach the latest state of the blockchain.
## Blockchain
A blockchain relies on two major components: The **Consensus Engine** and the **VM**. The VM defines application specific behavior and how blocks are built and parsed to create the blockchain. All VMs run on top of the Avalanche Consensus Engine, which allows nodes in the network to agree on the state of the blockchain. Here's a quick example of how VMs interact with consensus:
1. A node wants to update the blockchain's state
2. The node's VM will notify the consensus engine that it wants to update the state
3. The consensus engine will request the block from the VM
4. The consensus engine will verify the returned block using the VM's implementation of `Verify()`
5. The consensus engine will get the network to reach consensus on whether to accept or reject the newly verified block. Every virtuous (well-behaved) node on the network will have the same preference for a particular block
6. Depending upon the consensus results, the engine will either accept or reject the block. What happens when a block is accepted or rejected is specific to the implementation of the VM
AvalancheGo provides the consensus engine for every blockchain on the Avalanche Network. The consensus engine relies on the VM interface to handle building, parsing, and storing blocks as well as verifying and executing on behalf of the consensus engine.
This decoupling between the application and consensus layer allows developers to build their applications quickly by implementing virtual machines, without having to worry about the consensus layer managed by Avalanche which deals with how nodes agree on whether or not to accept a block.
## Installing a VM
VMs are supplied as binaries to a node running `AvalancheGo`. These binaries must be named the VM's assigned **VMID**. A VMID is a 32-byte hash encoded in CB58 that is generated when you build your VM.
In order to install a VM, its binary must be installed in the `AvalancheGo` plugin path. See [here](/docs/nodes/configure/configs-flags#--plugin-dir-string) for more details. Multiple VMs can be installed in this location.
Each VM runs as a separate process from AvalancheGo and communicates with `AvalancheGo` using gRPC calls. This functionality is enabled by **RPCChainVM**, a special VM which wraps around other VM implementations and bridges the VM and AvalancheGo, establishing a standardized communication protocol between them.
During VM creation, handshake messages are exchanged via **RPCChainVM** between AvalancheGo and the VM installation. Ensure matching **RPCChainVM** protocol versions to avoid errors, by updating your VM or using a [different version of AvalancheGo](https://github.com/ava-labs/AvalancheGo/releases).
Note that some VMs may not support the latest protocol version.
### API Handlers
Users can interact with a blockchain and its VM through handlers exposed by the VM's API.
VMs expose two types of handlers to serve responses for incoming requests:
- **Blockchain Handlers**: Referred to as handlers, these expose APIs to interact with a blockchain instantiated by a VM. The API endpoint will be different for each chain. The endpoint for a handler is `/ext/bc/[chainID]`.
- **VM Handlers**: Referred to as static handlers, these expose APIs to interact with the VM directly. One example API would be to parse genesis data to instantiate a new blockchain. The endpoint for a static handler is `/ext/vm/[vmID]`.
For any readers familiar with object-oriented programming, static and non-static handlers on a VM are analogous to static and non-static methods on a class. Blockchain handlers can be thought of as methods on an object, whereas VM handlers can be thought of as static methods on a class.
### Instantiate a VM
The `vm.Factory` interface is implemented to create new VM instances from which a blockchain can be initialized. The factory's `New` method shown below provides `AvalancheGo` with an instance of the VM. It's defined in the [`factory.go`](https://github.com/ava-labs/timestampvm/blob/main/timestampvm/factory.go) file of the `timestampvm` repository.
```go
// Returning a new VM instance from VM's factory
func (f *Factory) New(*snow.Context) (interface{}, error) { return &vm.VM{}, nil }
```
### Initializing a VM to Create a Blockchain
Before a VM can run, AvalancheGo will initialize it by invoking its `Initialize` method. Here, the VM will bootstrap itself and sets up anything it requires before it starts running.
This might involve setting up its database, mempool, genesis state, or anything else the VM requires to run.
```go
if err := vm.Initialize(
ctx.Context,
vmDBManager,
genesisData,
chainConfig.Upgrade,
chainConfig.Config,
msgChan,
fxs,
sender,
);
```
You can refer to the [implementation](https://github.com/ava-labs/timestampvm/blob/main/timestampvm/vm.go#L75) of `vm.initialize` in the TimestampVM repository.
## Interfaces
Every VM should implement the following interfaces:
### `block.ChainVM`
To reach a consensus on linear blockchains, Avalanche uses the Snowman consensus engine. To be compatible with Snowman, a VM must implement the `block.ChainVM` interface.
For more information, see [here](https://github.com/ava-labs/avalanchego/blob/master/snow/engine/snowman/block/vm.go).
```go title="snow/engine/snowman/block/vm.go"
// ChainVM defines the required functionality of a Snowman VM.
//
// A Snowman VM is responsible for defining the representation of the state,
// the representation of operations in that state, the application of operations
// on that state, and the creation of the operations. Consensus will decide on
// if the operation is executed and the order operations are executed.
//
// For example, suppose we have a VM that tracks an increasing number that
// is agreed upon by the network.
// The state is a single number.
// The operation is setting the number to a new, larger value.
// Applying the operation will save to the database the new value.
// The VM can attempt to issue a new number, of larger value, at any time.
// Consensus will ensure the network agrees on the number at every block height.
type ChainVM interface {
common.VM
Getter
Parser
// Attempt to create a new block from data contained in the VM.
//
// If the VM doesn't want to issue a new block, an error should be
// returned.
BuildBlock() (snowman.Block, error)
// Notify the VM of the currently preferred block.
//
// This should always be a block that has no children known to consensus.
SetPreference(ids.ID) error
// LastAccepted returns the ID of the last accepted block.
//
// If no blocks have been accepted by consensus yet, it is assumed there is
// a definitionally accepted block, the Genesis block, that will be
// returned.
LastAccepted() (ids.ID, error)
}
// Getter defines the functionality for fetching a block by its ID.
type Getter interface {
// Attempt to load a block.
//
// If the block does not exist, an error should be returned.
//
GetBlock(ids.ID) (snowman.Block, error)
}
// Parser defines the functionality for fetching a block by its bytes.
type Parser interface {
// Attempt to create a block from a stream of bytes.
//
// The block should be represented by the full byte array, without extra
// bytes.
ParseBlock([]byte) (snowman.Block, error)
}
```
### `common.VM`
`common.VM` is a type that every `VM` must implement. For more information, you can see the full file [here](https://github.com/ava-labs/avalanchego/blob/master/snow/engine/common/vm.go).
```go title="snow/engine/common/vm.go"
// VM describes the interface that all consensus VMs must implement
type VM interface {
// Contains handlers for VM-to-VM specific messages
AppHandler
// Returns nil if the VM is healthy.
// Periodically called and reported via the node's Health API.
health.Checkable
// Connector represents a handler that is called on connection connect/disconnect
validators.Connector
// Initialize this VM.
// [ctx]: Metadata about this VM.
// [ctx.networkID]: The ID of the network this VM's chain is running on.
// [ctx.chainID]: The unique ID of the chain this VM is running on.
// [ctx.Log]: Used to log messages
// [ctx.NodeID]: The unique staker ID of this node.
// [ctx.Lock]: A Read/Write lock shared by this VM and the consensus
// engine that manages this VM. The write lock is held
// whenever code in the consensus engine calls the VM.
// [dbManager]: The manager of the database this VM will persist data to.
// [genesisBytes]: The byte-encoding of the genesis information of this
// VM. The VM uses it to initialize its state. For
// example, if this VM were an account-based payments
// system, `genesisBytes` would probably contain a genesis
// transaction that gives coins to some accounts, and this
// transaction would be in the genesis block.
// [toEngine]: The channel used to send messages to the consensus engine.
// [fxs]: Feature extensions that attach to this VM.
Initialize(
ctx *snow.Context,
dbManager manager.Manager,
genesisBytes []byte,
upgradeBytes []byte,
configBytes []byte,
toEngine chan<- Message,
fxs []*Fx,
appSender AppSender,
) error
// Bootstrapping is called when the node is starting to bootstrap this chain.
Bootstrapping() error
// Bootstrapped is called when the node is done bootstrapping this chain.
Bootstrapped() error
// Shutdown is called when the node is shutting down.
Shutdown() error
// Version returns the version of the VM this node is running.
Version() (string, error)
// Creates the HTTP handlers for custom VM network calls.
//
// This exposes handlers that the outside world can use to communicate with
// a static reference to the VM. Each handler has the path:
// [Address of node]/ext/VM/[VM ID]/[extension]
//
// Returns a mapping from [extension]s to HTTP handlers.
//
// Each extension can specify how locking is managed for convenience.
//
// For example, it might make sense to have an extension for creating
// genesis bytes this VM can interpret.
CreateStaticHandlers() (map[string]*HTTPHandler, error)
// Creates the HTTP handlers for custom chain network calls.
//
// This exposes handlers that the outside world can use to communicate with
// the chain. Each handler has the path:
// [Address of node]/ext/bc/[chain ID]/[extension]
//
// Returns a mapping from [extension]s to HTTP handlers.
//
// Each extension can specify how locking is managed for convenience.
//
// For example, if this VM implements an account-based payments system,
// it have an extension called `accounts`, where clients could get
// information about their accounts.
CreateHandlers() (map[string]*HTTPHandler, error)
}
```
### `snowman.Block`
The `snowman.Block` interface It define the functionality a block must implement to be a block in a linear Snowman chain. For more information, you can see the full file [here](https://github.com/ava-labs/avalanchego/blob/master/snow/consensus/snowman/block.go).
```go title="snow/consensus/snowman/block.go"
// Block is a possible decision that dictates the next canonical block.
//
// Blocks are guaranteed to be Verified, Accepted, and Rejected in topological
// order. Specifically, if Verify is called, then the parent has already been
// verified. If Accept is called, then the parent has already been accepted. If
// Reject is called, the parent has already been accepted or rejected.
//
// If the status of the block is Unknown, ID is assumed to be able to be called.
// If the status of the block is Accepted or Rejected; Parent, Verify, Accept,
// and Reject will never be called.
type Block interface {
choices.Decidable
// Parent returns the ID of this block's parent.
Parent() ids.ID
// Verify that the state transition this block would make if accepted is
// valid. If the state transition is invalid, a non-nil error should be
// returned.
//
// It is guaranteed that the Parent has been successfully verified.
Verify() error
// Bytes returns the binary representation of this block.
//
// This is used for sending blocks to peers. The bytes should be able to be
// parsed into the same block on another node.
Bytes() []byte
// Height returns the height of this block in the chain.
Height() uint64
}
```
### `choices.Decidable`
This interface is a superset of every decidable object, such as transactions, blocks, and vertices. For more information, you can see the full file [here](https://github.com/ava-labs/avalanchego/blob/master/snow/choices/decidable.go).
```go title="snow/choices/decidable.go"
// Decidable represents element that can be decided.
//
// Decidable objects are typically thought of as either transactions, blocks, or
// vertices.
type Decidable interface {
// ID returns a unique ID for this element.
//
// Typically, this is implemented by using a cryptographic hash of a
// binary representation of this element. An element should return the same
// IDs upon repeated calls.
ID() ids.ID
// Accept this element.
//
// This element will be accepted by every correct node in the network.
Accept() error
// Reject this element.
//
// This element will not be accepted by any correct node in the network.
Reject() error
// Status returns this element's current status.
//
// If Accept has been called on an element with this ID, Accepted should be
// returned. Similarly, if Reject has been called on an element with this
// ID, Rejected should be returned. If the contents of this element are
// unknown, then Unknown should be returned. Otherwise, Processing should be
// returned.
Status() Status
}
```
# WAGMI Avalanche L1 (/docs/avalanche-l1s/wagmi-avalanche-l1)
---
title: WAGMI Avalanche L1
description: Learn about the WAGMI Avalanche L1 in this detailed case study.
---
This is one of the first cases of using Avalanche L1s as a proving ground for changes in a production VM (Coreth). Many underestimate how useful the isolation of Avalanche L1s is for performing complex VM testing on a live network (without impacting the stability of the primary network).
We created a basic WAGMI Explorer [https://subnets-test.avax.network/wagmi](https://subnets-test.avax.network/wagmi) that surfaces aggregated usage statistics about the Avalanche L1.
- SubnetID: [28nrH5T2BMvNrWecFcV3mfccjs6axM1TVyqe79MCv2Mhs8kxiY](https://explorer-xp.avax-test.network/avalanche-l1/28nrH5T2BMvNrWecFcV3mfccjs6axM1TVyqe79MCv2Mhs8kxiY?tab=validators)
- ChainID: [2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt](https://testnet.avascan.info/blockchain/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt)
### Network Parameters[](#network-parameters "Direct link to heading")
- NetworkID: 11111
- ChainID: 11111
- Block Gas Limit: 20,000,000 (2.5x C-Chain)
- 10s Gas Target: 100,000,000 (~6.67x C-Chain)
- Min Fee: 1 Gwei (4% of C-Chain)
- Target Block Rate: 2s (Same as C-Chain)
The genesis file of WAGMI can be found [here](https://github.com/ava-labs/public-chain-assets/blob/1951594346dcc91682bdd8929bcf8c1bf6a04c33/chains/11111/genesis.json).
### Adding WAGMI to Core[](#adding-wagmi-to-core "Direct link to heading")
- Network Name: WAGMI
- RPC URL: [https://subnets.avax.network/wagmi/wagmi-chain-testnet/rpc]
- WS URL: wss://avalanche-l1s.avax.network/wagmi/wagmi-chain-testnet/ws
- Chain ID: 11111
- Symbol: WGM
- Explorer: [https://subnets.avax.network/wagmi/wagmi-chain-testnet/explorer]
This can be used with other wallets too, such as MetaMask.
Case Study: WAGMI Upgrades[](#case-study-wagmi-upgrades "Direct link to heading")
----------------------------------------------------------------------------------
This case study uses [WAGMI](https://subnets-test.avax.network/wagmi) Avalanche L1 upgrade to show how a network upgrade on an EVM-based (Ethereum Virtual Machine) Avalanche L1 can be done simply, and how the resulting upgrade can be used to dynamically control fee structure on the Avalanche L1.
### Introduction[](#introduction "Direct link to heading")
[Subnet-EVM](https://github.com/ava-labs/subnet-evm) aims to provide an easy to use toolbox to customize the EVM for your blockchain. It is meant to run out of the box for many Avalanche L1s without any modification. But what happens when you want to add a new feature updating the rules of your EVM?
Instead of hard coding the timing of network upgrades in client code like most EVM chains, requiring coordinated deployments of new code, [Subnet-EVM v0.2.8](https://github.com/ava-labs/subnet-evm/releases/tag/v0.2.8) introduces the long awaited feature to perform network upgrades by just using a few lines of JSON in a configuration file.
### Network Upgrades: Enable/Disable Precompiles[](#network-upgrades-enabledisable-precompiles "Direct link to heading")
Detailed description of how to do this can be found in [Customize an Avalanche L1](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#network-upgrades-enabledisable-precompiles) tutorial. Here's a summary:
1. Network Upgrade utilizes existing precompiles on the Subnet-EVM:
- ContractDeployerAllowList, for restricting smart contract deployers
- TransactionAllowList, for restricting who can submit transactions
- NativeMinter, for minting native coins
- FeeManager, for configuring dynamic fees
- RewardManager, for enabling block rewards
2. Each of these precompiles can be individually enabled or disabled at a given timestamp as a network upgrade, or any of the parameters governing its behavior changed.
3. These upgrades must be specified in a file named `upgrade.json` placed in the same directory where [`config.json`](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#avalanchego-chain-configs) resides: `{chain-config-dir}/{blockchainID}/upgrade.json`.
### Preparation[](#preparation "Direct link to heading")
To prepare for the first WAGMI network upgrade, on August 15, 2022, we had announced on [X](https://x.com/AaronBuchwald/status/1559249414102720512) and shared on other social media such as Discord.
For the second upgrade, on February 24, 2024, we had another announcement on [X](https://x.com/jceyonur/status/1760777031858745701?s=20).
### Deploying upgrade.json[](#deploying-upgradejson "Direct link to heading")
The content of the `upgrade.json` is:
```json
{
"precompileUpgrades": [
{
"feeManagerConfig": {
"adminAddresses": ["0x6f0f6DA1852857d7789f68a28bba866671f3880D"],
"blockTimestamp": 1660658400
}
},
{
"contractNativeMinterConfig": {
"blockTimestamp": 1708696800,
"adminAddresses": ["0x6f0f6DA1852857d7789f68a28bba866671f3880D"],
"managerAddresses": ["0xadFA2910DC148674910c07d18DF966A28CD21331"]
}
}
]
}
```
With the above `upgrade.json`, we intend to perform two network upgrades:
1. The first upgrade is to activate the FeeManager precompile:
- `0x6f0f6DA1852857d7789f68a28bba866671f3880D` is named as the new Admin of the FeeManager precompile.
- `1660658400` is the [Unix timestamp](https://www.unixtimestamp.com/) for Tue Aug 16 2022 14:00:00 GMT+0000 (future time when we made the announcement) when the new FeeManager change would take effect.
2. The second upgrade is to activate the NativeMinter precompile:
- `0x6f0f6DA1852857d7789f68a28bba866671f3880D` is named as the new Admin of the NativeMinter precompile.
- `0xadFA2910DC148674910c07d18DF966A28CD21331` is named as the new Manager of the NativeMinter precompile. Manager addresses are enabled after Durango upgrades which occurred on February 13, 2024.
- `1708696800` is the [Unix timestamp](https://www.unixtimestamp.com/) for Fri Feb 23 2024 14:00:00 GMT+0000 (future time when we made the announcement) when the new NativeMinter change would take effect.
Detailed explanations of feeManagerConfig can be found in [here](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#configuring-dynamic-fees), and for the contractNativeMinterConfig in [here](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#minting-native-coins).
We place the `upgrade.json` file in the chain config directory, which in our case is `~/.avalanchego/configs/chains/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt/`. After that, we restart the node so the upgrade file is loaded.
When the node restarts, AvalancheGo reads the contents of the JSON file and passes it into Subnet-EVM. We see a log of the chain configuration that includes the updated precompile upgrade. It looks like this:
```bash
INFO [02-22|18:27:06.473] <2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt Chain> github.com/ava-labs/subnet-evm/core/blockchain.go:335: Upgrade Config: {"precompileUpgrades":[{"feeManagerConfig":{"adminAddresses":["0x6f0f6da1852857d7789f68a28bba866671f3880d"],"blockTimestamp":1660658400}},{"contractNativeMinterConfig":{"adminAddresses":["0x6f0f6da1852857d7789f68a28bba866671f3880d"],"managerAddresses":["0xadfa2910dc148674910c07d18df966a28cd21331"],"blockTimestamp":1708696800}}]}
```
We note that `precompileUpgrades` correctly shows the upcoming precompile upgrades. Upgrade is locked in and ready.
### Activations[](#activations "Direct link to heading")
When the time passed 10:00 AM EDT August 16, 2022 (Unix timestamp 1660658400), the `upgrade.json` had been executed as planned and the new FeeManager admin address has been activated. From now on, we don't need to issue any new code or deploy anything on the WAGMI nodes to change the fee structure. Let's see how it works in practice!
For the second upgrade on February 23, 2024, the same process was followed. The `upgrade.json` had been executed after Durango, as planned, and the new NativeMinter admin and manager addresses have been activated.
### Using Fee Manager[](#using-fee-manager "Direct link to heading")
The owner `0x6f0f6DA1852857d7789f68a28bba866671f3880D` can now configure the fees on the Avalanche L1 as they see fit. To do that, all that's needed is access to the network, the private key for the newly set manager address and making calls on the precompiled contract.
We will use [Remix](https://remix.ethereum.org/) online Solidity IDE and the [Core Browser Extension](https://support.avax.network/en/articles/6066879-core-extension-how-do-i-add-the-core-extension). Core comes with WAGMI network built-in. MetaMask will do as well but you will need to [add WAGMI](/docs/avalanche-l1s/wagmi-avalanche-l1) yourself.
First using Core, we open the account as the owner `0x6f0f6DA1852857d7789f68a28bba866671f3880D`.
Then we connect Core to WAGMI, Switch on the `Testnet Mode` in `Advanced` page in the hamburger menu:

And then open the `Manage Networks` menu in the networks dropdown. Select WAGMI there by clicking the star icon:

We then switch to WAGMI in the networks dropdown. We are ready to move on to Remix now, so we open it in the browser. First, we check that Remix sees the extension and correctly talks to it. We select `Deploy & run transactions` icon on the left edge, and on the Environment dropdown, select `Injected Provider`. We need to approve the Remix network access in the Core browser extension. When that is done, `Custom (11111) network` is shown:

Good, we're talking to WAGMI Avalanche L1. Next we need to load the contracts into Remix. Using 'load from GitHub' option from the Remix home screen we load two contracts:
- [IAllowList.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IAllowList.sol)
- and [IFeeManager.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IFeeManager.sol).
IFeeManager is our precompile, but it references the IAllowList, so we need that one as well. We compile IFeeManager.sol and use deployed contract at the precompile address `0x0200000000000000000000000000000000000003` used on the [Avalanche L1](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/feemanager/module.go#L21).

Now we can interact with the FeeManager precompile from within Remix via Core. For example, we can use the `getFeeConfig` method to check the current fee configuration. This action can be performed by anyone as it is just a read operation.
Once we have the new desired configuration for the fees on the Avalanche L1, we can use the `setFeeConfig` to change the parameters. This action can **only** be performed by the owner `0x6f0f6DA1852857d7789f68a28bba866671f3880D` as the `adminAddress` specified in the [`upgrade.json` above](#deploying-upgradejson).

When we call that method by pressing the `transact` button, a new transaction is posted to the Avalanche L1, and we can see it on [the explorer](https://subnets-test.avax.network/wagmi/block/0xad95ccf04f6a8e018ece7912939860553363cc23151a0a31ea429ba6e60ad5a3):

Immediately after the transaction is accepted, the new fee config takes effect. We can check with the `getFeeCofig` that the values are reflected in the active fee config (again this action can be performed by anyone):

That's it, fees changed! No network upgrades, no complex and risky deployments, just making a simple contract call and the new fee configuration is in place!
### Using NativeMinter[](#using-nativeminter "Direct link to heading")
For the NativeMinter, we can use the same process to connect to the Avalanche L1 and interact with the precompile. We can load INativeMinter interface using 'load from GitHub' option from the Remix home screen with following contracts:
- [IAllowList.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IAllowList.sol)
- and [INativeMinter.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/INativeMinter.sol).
We can compile them and interact with the deployed contract at the precompile address `0x0200000000000000000000000000000000000001` used on the [Avalanche L1](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/nativeminter/module.go#L22).

The native minter precompile is used to mint native coins to specified addresses. The minted coins is added to the current supply and can be used by the recipient to pay for gas fees. For more information about the native minter precompile see [here](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#minting-native-coins).
`mintNativeCoin` method can be only called by enabled, manager and admin addresses. For this upgrade we have added both an admin and a manager address in [`upgrade.json` above](#deploying-upgradejson). The manager address was available after Durango upgrades which occurred on February 13, 2024. We will use the manager address `0xadfa2910dc148674910c07d18df966a28cd21331` to mint native coins.

When we call that method by pressing the `transact` button, a new transaction is posted to the Avalanche L1, and we can see it on [the explorer](https://subnets-test.avax.network/wagmi/tx/0xc4aaba7b5863c1b8f6664ac1d483e2d7d392ab58d1a8feb0b6c318cbae7f1e93):

As a result of this transaction, the native minter precompile minted a new native coin (1 WGM) to the recipient address `0xB78cbAa319ffBD899951AA30D4320f5818938310`. The address page on the explorer [here](https://subnets-test.avax.network/wagmi/address/0xB78cbAa319ffBD899951AA30D4320f5818938310) shows no incoming transaction; this is because the 1 WGM was directly minted by the EVM itself, without any sender.
### Conclusion[](#conclusion "Direct link to heading")
Network upgrades can be complex and perilous procedures to carry out safely. Our continuing efforts with Avalanche L1s is to make upgrades as painless and simple as possible. With the powerful combination of stateful precompiles and network upgrades via the upgrade configuration files we have managed to greatly simplify both the network upgrades and network parameter changes. This in turn enables much safer experimentation and many new use cases that were too risky and complex to carry out with high-coordination efforts required with the traditional network upgrade mechanisms.
We hope this case study will help spark ideas for new things you may try on your own. We're looking forward to seeing what you have built and how easy upgrades help you in managing your Avalanche L1s! If you have any questions or issues, feel free to contact us on our [Discord](https://chat.avalabs.org/). Or just reach out to tell us what exciting new things you have built!
# ACP-103: Dynamic Fees (/docs/acps/103-dynamic-fees)
---
title: "ACP-103: Dynamic Fees"
description: "Details for Avalanche Community Proposal 103: Dynamic Fees"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/103-dynamic-fees/README.md
---
| ACP | 103 |
| :--- | :--- |
| **Title** | Add Dynamic Fees to the P-Chain |
| **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)), Alberto Benegiamo ([@abi87](https://github.com/abi87)), Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)) |
| **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/104)) |
| **Track** | Standards |
## Abstract
Introduce a dynamic fee mechanism to the P-Chain. Preview a future transition to a multidimensional fee mechanism.
## Motivation
Blockchains are resource-constrained environments. Users are charged for the execution and inclusion of their transactions based on the blockchain's transaction fee mechanism. The mechanism should fluctuate based on the supply of and demand for said resources to serve as a deterrent against spam and denial-of-service attacks.
With a fixed fee mechanism, users are provided with simplicity and predictability but network congestion and resource constraints are not taken into account. There is no incentive for users to withhold transactions since the cost is fixed regardless of the demand. The fee does not adjust the execution and inclusion fee of transactions to the market clearing price.
The C-Chain, in [Apricot Phase 3](https://medium.com/avalancheavax/apricot-phase-three-c-chain-dynamic-fees-432d32d67b60), employs a dynamic fee mechanism to raise the price during periods of high demand and lowering the price during periods of low demand. As the price gets too expensive, network utilization will decrease, which drops the price. This ensures the execution and inclusion fee of transactions closely matches the market clearing price.
The P-Chain currently operates under a fixed fee mechanism. To more robustly handle spikes in load expected from introducing the improvements in [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md), it should be migrated to a dynamic fee mechanism.
The X-Chain also currently operates under a fixed fee mechanism. However, due to the current lower usage and lack of new feature introduction, the migration of the X-Chain to a dynamic fee mechanism is deferred to a later ACP to reduce unnecessary additional technical complexity.
## Specification
### Dimensions
There are four dimensions that will be used to approximate the computational cost of, or "gas" consumed in, a transaction:
1. Bandwidth $B$ is the amount of network bandwidth used for transaction broadcast. This is set to the size of the transaction in bytes.
2. Reads $R$ is the number of state/database reads used in transaction execution.
3. Writes $W$ is the number of state/database writes used in transaction execution.
4. Compute $C$ is the total amount of compute used to verify and execute a transaction, measured in microseconds.
The gas consumed $G$ in a transaction is:
$$G = B + 1000R + 1000W + 4C$$
A future ACP could remove the merging of these dimensions to granularly meter usage of each resource in a multidimensional scheme.
### Mechanism
This mechanism aims to maintain a target gas consumption $T$ per second and adjusts the fee based on the excess gas consumption $x$, defined as the difference between the current gas consumption and $T$.
Prior to the activation of this mechanism, $x$ is initialized:
$$x = 0$$
At the start of building/executing block $b$, $x$ is updated:
$$x = \max(x - T \cdot \Delta{t}, 0)$$
Where $\Delta{t}$ is the number of seconds between $b$'s block timestamp and $b$'s parent's block timestamp.
The gas price for block $b$ is:
$$M \cdot \exp\left(\frac{x}{K}\right)$$
Where:
- $M$ is the minimum gas price
- $\exp\left(x\right)$ is an approximation of $e^x$ following the EIP-4844 specification
```python
# Approximates factor * e ** (numerator / denominator) using Taylor expansion
def fake_exponential(factor: int, numerator: int, denominator: int) -> int:
i = 1
output = 0
numerator_accum = factor * denominator
while numerator_accum > 0:
output += numerator_accum
numerator_accum = (numerator_accum * numerator) // (denominator * i)
i += 1
return output // denominator
```
- $K$ is a constant to control the rate of change of the gas price
After processing block $b$, $x$ is updated with the total gas consumed in the block $G$:
$$x = x + G$$
Whenever $x$ increases by $K$, the gas price increases by a factor of `~2.7`. If the gas price gets too expensive, average gas consumption drops, and $x$ starts decreasing, dropping the price. The gas price constantly adjusts to make sure that, on average, the blockchain consumes $T$ gas per second.
A [token bucket](https://en.wikipedia.org/wiki/Token_bucket) is employed to meter the maximum rate of gas consumption. Define $C$ as the capacity of the bucket, $R$ as the amount of gas to add to the bucket per second, and $r$ as the amount of gas currently in the bucket.
Prior to the activation of this mechanism, $r$ is initialized:
$$r = 0$$
At the beginning of processing block $b$, $r$ is set:
$$r = \min\left(r + R \cdot \Delta{t}, C\right)$$
Where $\Delta{t}$ is the number of seconds between $b$'s block timestamp and $b$'s parent's block timestamp. The maximum gas consumed in a given $\Delta{t}$ is $r + R \cdot \Delta{t}$. The upper bound across all $\Delta{t}$ is $C + R \cdot \Delta{t}$.
After processing block $b$, the total gas consumed in $b$, or $G$, will be known. If $G \gt r$, $b$ is considered an invalid block. If $b$ is a valid block, $r$ is updated:
$$r = r - G$$
A block gas limit does not need to be set as it is implicitly derived from $r$.
The parameters at activation are:
| Parameter | P-Chain Configuration|
| - | - |
| $T$ - target gas consumed per second | 50,000 |
| $M$ - minimum gas price | 1 nAVAX |
| $K$ - gas price update constant | 2_164_043 |
| $C$ - maximum gas capacity | 1,000,000 |
| $R$ - gas capacity added per second | 100,000 |
$K$ was chosen such that at sustained maximum capacity ($R=100,000$ gas/second), the fee rate will double every ~30 seconds.
As the network gains capacity to handle additional load, this algorithm can be tuned to increase the gas consumption rate.
#### A note on $e^x$
There is a subtle reason why an exponential adjustment function was chosen: The adjustment function should be _equally_ reactive irrespective of the actual fee.
Define $b_n$ as the current block's gas fee, $b_{n+1}$ as the next block's gas fee, and $x$ as the excess gas consumption.
Let's use a linear adjustment function:
$$b_{n+1} = b_n + 10x$$
Assume $b_n = 100$ and the current block is 1 unit above target utilization, or $x = 1$. Then, $b_{n+1} = 100 + 10 \cdot 1 = 110$, an increase of `10%`. If instead $b_n = 10,000$, $b_{n+1} = 10,000 + 10 \cdot 1 = 10,010$, an increase of `0.1%`. The fee is _less_ reactive as the fee increases. This is because the rate of change _does not scale_ with $x$.
Now, let's use an exponential adjustment function:
$$b_{n+1} = b_n \cdot e^x$$
Assume $b_n = 100$ and the current block is 1 unit above target utilization, or $x = 1$. Then, $b_{n+1} = 100 \cdot e^1 \approx 271.828$, an increase of `171%`. If instead $b_n = 10,000$, $b_{n+1} = 10,000 \cdot e^1 \approx 27,182.8$, an increase of `171%` again. The fee is _equally_ reactive as the fee increases. This is because the rate of change _scales_ with $x$.
### Block Building Procedure
When a transaction is constructed on the P-Chain, the amount of $AVAX burned is given by `sum($AVAX outputs) - sum($AVAX inputs)`. The amount of gas consumed by the transaction can be deterministically calculated after construction. Dividing the amount of $AVAX burned by the amount of gas consumed yields the maximum gas price that the transaction can pay.
Instead of using a FIFO queue for the mempool (like the P-Chain does now), the mempool should use a priority queue ordered by the maximum gas price of each transaction. This ensures that higher paying transactions are included first.
## Backwards Compatibility
Modification of a fee mechanism is an execution change and requires a mandatory upgrade for activation. Implementers must take care to not alter the execution behavior prior to activation.
After this ACP is activated, any transaction issued on the P-Chain must account for the fee mechanism defined above. Users are responsible for reconstructing their transactions to include a larger fee for quicker inclusion when the fee increases.
## Reference Implementation
ACP-103 was implemented into AvalancheGo behind the `Etna` upgrade flag. The full body of work can be found tagged with the `acp103` label [here](https://github.com/ava-labs/avalanchego/pulls?q=is%3Apr+label%3Aacp103).
## Security Considerations
The current fixed fee mechanism on the X-Chain and P-Chain does not robustly handle spikes in load. Migrating the P-Chain to a dynamic fee mechanism will ensure that any additional load caused by demand for new P-Chain features (such as those introduced in [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md)) is properly priced given allotted processing capacity. The X-Chain, in comparison, currently has significantly lower usage, making it less likely for the demand for blockspace on it to exceed the current static fee rates. If necessary or desired, a future ACP can reuse the mechanism introduced here to add dynamic fee rates to the X-Chain.
## Acknowledgements
Thank you to [@aaronbuchwald](https://github.com/aaronbuchwald) and [@patrick-ogrady](https://github.com/patrick-ogrady) for providing feedback prior to publication.
Thank you to the authors of [EIP-4844](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-4844.md) for creating the fee design that inspired the above mechanism.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-108: Evm Event Importing (/docs/acps/108-evm-event-importing)
---
title: "ACP-108: Evm Event Importing"
description: "Details for Avalanche Community Proposal 108: Evm Event Importing"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/108-evm-event-importing/README.md
---
| ACP | 108 |
| :--- | :--- |
| **Title** | EVM Event Importing Standard |
| **Author(s)** | Michael Kaplan ([@mkaplan13](https://github.com/mkaplan13)) |
| **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/114)) |
| **Track** | Best Practices Track |
## Abstract
Defines a standard smart contract interface and abstract implementation for importing EVM events from any blockchain within Avalanche using [Avalanche Warp Messaging](https://docs.avax.network/build/cross-chain/awm/overview).
## Motivation
The implementation of Avalanche Warp Messaging within `coreth` and `subnet-evm` exposes a [mechanism for getting authenticated hashes of blocks](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IWarpMessenger.sol#L43) that have been accepted on blockchains within Avalanche. Proofs of acceptance of blocks, such as those introduced in [ACP-75](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/75-acceptance-proofs), can be used to prove arbitrary events and state changes that occured in those blocks. However, there is currently no clear standard for using authenticated block hashes in smart contracts within Avalanche, making it difficult to build applications that leverage this mechanism. In order to make effective use of authenticated block hashes, contracts must be provided encoded block headers that match the authenticated block hashes and also Merkle proofs that are verified against the state or receipts root contained in the block header.
With a standard interface and abstract contract implemetation that handles the authentication of block hashes and verification of Merkle proofs, smart contract developers on Avalanche will be able to much more easily create applications that leverage data from other Avalanche blockchains. These type of cross-chain application do not require any direct interaction on the source chain.
## Specification
### Event Importing Interface
We propose that smart contracts importing EVM events emitted by other blockchains within Avalanche implement the following interface.
#### Methods
Imports the EVM event uniquely identified by the source blockchain ID, block header, transaction index, and log index.
The `blockHeader` must be validated to match the authenticated block hash from the `sourceBlockchainID`. The specification for EVM block headers can be found [here](https://github.com/ava-labs/subnet-evm/blob/master/core/types/block.go#L73).
The `txIndex` identifies the key of receipts trie of the given block header that the `receiptProof` must prove inclusion of. The value obtained by verifying the `receiptProof` for that key is the encoded transaction receipt. The specification for EVM transaction receipts can be found [here](https://github.com/ava-labs/subnet-evm/blob/master/core/types/receipt.go#L62).
The `logIndex` identifies which event log from the given transaction receipt is to be imported.
Must emit an `EventImported` event upon success.
```solidity
function importEvent(
bytes32 sourceBlockchainID,
bytes calldata blockHeader,
uint256 txIndex,
bytes[] calldata receiptProof,
uint256 logIndex
) external;
```
This interface does not require that the Warp precompile is used to authenticate block hashes. Implementations could:
- Use the Warp precompile to authenticate block hashes provided directly in the transaction calling `importEvent`.
- Check previously authenticated block hashes using an external contract.
- Allows for a block hash to be authenticated once and used in arbitrarily many transactions afterwards.
- Allows for alternative authentication mechanisms to be used, such as trusted oracles.
#### Events
Must trigger when an EVM event is imported.
```solidity
event EventImported(
bytes32 indexed sourceBlockchainID,
bytes32 indexed sourceBlockHash,
address indexed loggerAddress,
uint256 txIndex,
uint256 logIndex
);
```
### Event Importing Abstract Contract
Applications importing EVM events emitted by other blockchains within Avalanche should be able to use a standard abstract implementation of the `importEvent` interface. This abstract implementation must handle:
- Authenticating block hashes from other chains.
- Verifying that the encoded `blockHeader` matches the imported block hash.
- Verifying the Merkle `receiptProof` for the given `txIndex` against the receipt root of the provided `blockHeader`.
- Decoding the event log identified by `logIndex` from the receipt obtained from verifying the `receiptProof`.
As noted above, implementations could directly use the Warp precompile's `getVerifiedWarpBlockHash` interface method for authenticating block hashes, as is done in the reference implementation [here](https://github.com/ava-labs/event-importer-poc/blob/main/contracts/src/EventImporter.sol#L51). Alternatively, implementations could use the `sourceBlockchainID` and `blockHeader` provided in the parameters to check with an external contract that the block has been accepted on the given chain. The specifics of such an external contract are outside the scope of this ACP, but for illustrative purposes, this could look along the lines of:
```solidity
bool valid = blockHashRegistry.checkAuthenticatedBlockHash(
sourceBlockchainID,
keccack256(blockHeader)
);
require(valid, "Invalid block header");
```
Inheriting contracts should only need to define the logic to be executed when an event is imported. This is done by providing an implementation of the following internal function, called by `importEvent`.
```solidity
function _onEventImport(EVMEventInfo memory eventInfo) internal virtual;
```
Where the `EVMEventInfo` struct is defined as:
```solidity
struct EVMLog {
address loggerAddress;
bytes32[] topics;
bytes data;
}
struct EVMEventInfo {
bytes32 blockchainID;
uint256 blockNumber;
uint256 txIndex;
uint256 logIndex;
EVMLog log;
}
```
The `EVMLog` struct is meant to match the `Log` type definition in the EVM [here](https://github.com/ava-labs/subnet-evm/blob/master/core/types/log.go#L39).
## Reference Implementation
See reference implementation on [Github here](https://github.com/ava-labs/event-importer-poc).
In addition to implementing the interface and abstract contract described above, the reference implementation shows how transactions can be constructed to import events using Warp block hash signatures.
## Open Questions
See [here](https://github.com/ava-labs/event-importer-poc?tab=readme-ov-file#open-questions-and-considerations).
## Security Considerations
The correctness of a contract using block hashes to prove that a specific event was emitted within that block depends on the correctness of:
1. The mechanism for authenticating that a block hash was finalized on another blockchain.
2. The Merkle proof validation library used to prove that a specific transaction receipt was included in the given block.
For considerations on using Avalanche Warp Messaging to authenticate block hashes, see [here](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/30-avalanche-warp-x-evm#security-considerations).
To improve confidence in the correctness of the Merkle proof validation used in implementations, well-audited and widely used libraries should be used.
## Acknowledgements
Using Merkle proofs to verify events/state against root hashes is not a new idea. Protocols such as [IBC](https://ibc.cosmos.network/v8/), [Rainbow Bridge](https://github.com/Near-One/rainbow-bridge), and [LayerZero](https://layerzero.network/publications/LayerZero_Whitepaper_V1.1.0.pdf), among others, have previously suggested using Merkle proofs in a similar manner.
Thanks to [@aaronbuchwald](https://github.com/aaronbuchwald) for proposing the `getVerifiedWarpBlockHash` interface be included in the AWM implemenation within Avalanche EVMs, which enables this type of use case.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-113: Provable Randomness (/docs/acps/113-provable-randomness)
---
title: "ACP-113: Provable Randomness"
description: "Details for Avalanche Community Proposal 113: Provable Randomness"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/113-provable-randomness/README.md
---
| ACP | 113 |
| :------------ | :------------------------------------------------------------------------------------ |
| **Title** | Provable Virtual Machine Randomness |
| **Author(s)** | Tsachi Herman [http://github.com/tsachiherman](http://github.com/tsachiherman) |
| **Status** | Stale ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/142)) |
| **Track** | Standards |
## Future Work
This ACP was marked as stale due to its documented security concerns.
In order to safely utilize randomness produced by this mechanism, the consumer of the randomness must:
1. Define a security threshold `x` which is the maximum number of consecutive blocks which can be proposed by a malicious entity.
2. After committing to a request for randomness, the consumer must wait for `x` blocks.
3. After waiting for `x` blocks, the consumer must verify that the randomness was not biased during the `x` blocks.
4. If the randomness was biased, it would be insufficient to request randomness again, as this would allow the malicious block producer to discard any randomness that it did not like. If using the randomness mechanism proposed in this ACP, the consumer of the randomness must be able to terminate the request for randomness in such a way that no participant would desire the outcome. Griefing attacks would likely result from such a construction.
### Alternative Mechanisms
There are alternative mechanisms that would not result in such security concerns, such as:
- Utilizing a deterministic threshold signature scheme to finalize a block in consensus would allow the threshold signature to be used during the execution of the block.
- Utilizing threshold commit-reveal schemes that guarantee that committed values will always be revealed in a timely manner.
However, these mechanisms are likely too costly to be introduced into the Avalanche Primary Network due to its validator set size.
It is left to a future ACP to specify the implementation of one of these alternative schemes for L1 networks with smaller sized validator sets.
## Abstract
Avalanche offers developers flexibility through subnets and EVM-compatible smart contracts. However, the platform's deterministic block execution limits the use of traditional random number generators within these contracts.
To address this, a mechanism is proposed to generate verifiable, non-cryptographic random number seeds on the Avalanche platform. This method ensures uniformity while allowing developers to build more versatile applications.
## Motivation
Reliable randomness is essential for building exciting applications on Avalanche. Games, participant selection, dynamic content, supply chain management, and decentralized services all rely on unpredictable outcomes to function fairly. Randomness also fuels functionalities like unique identifiers and simulations. Without a secure way to generate random numbers within smart contracts, Avalanche applications become limited.
Avalanche's traditional reliance on external oracles for randomness creates complexity and bottlenecks. These oracles inflate costs, hinder transaction speed, and are cumbersome to integrate. As Avalanche scales to more Subnets, this dependence on external systems becomes increasingly unsustainable.
A solution for verifiable random number generation within Avalanche solves these problems. It provides fair randomness functionality across the chains, at no additional cost. This paves the way for a more efficient Avalanche ecosystem.
## Specification
### Changes Summary
The existing Avalanche protocol breaks the block building into two parts : external and internal. The external block is the Snowman++ block, whereas the internal block is the actual virtual machine block.
To support randomness, a BLS based VRF implementation is used, that would be recursively signing its own signatures as its message. Since the BLS signatures are deterministic, they provide a great way to construct a reliable VRF.
For proposers that do not have a BLS key associated with their node, the hash of the signature from the previous round is used in place of their signature.
In order to bootstrap the signatures chain, a missing signature would be replaced with a byte slice that is the hash product of a verifiable and trustable seed.
The changes proposed here would affect the way a blocks are validated. Therefore, when this change gets implemented, it needs to be deployed as a mandatory upgrade.
```
+-----------------------+ +-----------------------+
| Block n | <-------- | Block n+1 |
+-----------------------+ +-----------------------+
| VRF-Sig(n) | | VRF-Sig(n+1) |
| ... | | ... |
+-----------------------+ +-----------------------+
+-----------------------+ +-----------------------+
| VM n | | VM n+1 |
+-----------------------+ +-----------------------+
| VRF-Out(n) | | VRF-Out(n+1) |
+-----------------------+ +-----------------------+
VRF-Sig(n+1) = Sign(VRF-Sig(n), Block n+1 proposer's BLS key)
VRF-Out(n) = Hash(VRF-Sig(n))
```
### Changes Details
#### Step 1. Adding BLS signature to proposed blocks
```go
type statelessUnsignedBlock struct {
…
vrfSig []byte `serialize:”true”`
}
```
#### Step 2. Populate signature
When a block proposer attempts to build a new block, it would need to use the parent block as a reference.
The `vrfSig` field within each block is going to be daisy-chained to the `vrfSig` field from it's parent block.
Populating the `vrfSig` would following this logic:
1. The current proposer has a BLS key
a. If the parent block has an empty `vrfSig` signature, the proposer would sign the bootStrappingBlockSignature with its BLS key. See the bootStrappingBlockSignature details below. This is the base case.
b. If the parent block does not have an empty `vrfSig` signature, that signature would be signed using the proposer’s BLS key.
2. The current proposer does not have a BLS key
a. If the parent block has a non-empty `vrfSig` signature, the proposer would set the proposed block `vrfSig` to the 32 byte hash result of the following preimage:
```
+-------------------------+----------+------------+
| prefix : | [8]byte | "rng-derv" |
+-------------------------+----------+------------+
| vrfSig : | [96]byte | 96 bytes |
+-------------------------+----------+------------+
```
b. If the parent block has an empty `vrfSig` signature, the proposer would leave the `vrfSig` on the new block empty.
The bootStrappingBlockSignature that would be used above is the hash of the following preimage:
```
+-----------------------+----------+------------+
| prefix : | [8]byte | "rng-root" |
+-----------------------+----------+------------+
| networkID: | uint32 | 4 bytes |
+-----------------------+----------+------------+
| chainID : | [32]byte | 32 bytes |
+-----------------------+----------+------------+
```
#### Step 3. Signature Verification
This signature verification would perform the exact opposite of what was done in step 2, and would verify the cryptographic correctness of the operation.
Validating the `vrfSig` would following this logic:
1. The proposer has a BLS key
a. If the parent block's `vrfSig` was non-empty , then the `vrfSig` in the proposed block is verified to be a valid BLS signature of the parent block's `vrfSig` value for the proposer's BLS public key.
b. If the parent block's `vrfSig` was empty, then a BLS signature verification of the proposed block `vrfSig` against the proposer’s BLS public key and bootStrappingBlockSignature would take place.
2. The proposer does not have a BLS key
a. If the parent block had a non-empty `vrfSig`, then the hash of the preimage ( as described above ) would be compared against the proposed `vrfSig`.
b. If the parent block has an empty `vrfSig` then the proposer's `vrfSig` would be validated to be empty.
#### Step 4. Extract the VRF Out and pass to block builders
Calculating the VRF Out would be done by hashing the preimage of the following struct:
```
+-----------------------+----------+------------+
| prefix : | [8]byte | "vrfout " |
+-----------------------+----------+------------+
| vrfout: | [96]byte | 96 bytes |
+-----------------------+----------+------------+
```
Before calculating the VRF Out, the method needs to explicitly check the case where the `vrfSig` is empty. In that case, the output of the VRF Out needs to be empty as well.
## Backwards Compatibility
The above design has taken backward compatibility considerations. The chain would keep working as before, and at some point, would have the newly added `vrfSig` populated.
From usage perspective, each VM would need to make its own decision on whether it should use the newly provided random seed. Initially, this random seed would be all zeros - and would get populated once the feature rolled out to a sufficient number of nodes.
Also, as mentioned in the summary, these changes would necessitate a network upgrade.
## Reference Implementation
A full reference implementation has not been provided yet. It will be provided once this ACP is considered `Implementable`.
## Security Considerations
Virtual machine random seeds, while appearing to offer a source of randomness within smart contracts, fall short when it comes to cryptographic security. Here's a breakdown of the critical issues:
- Limited Permutation Space: The number of possible random values is derived from the number of validators. While no validator, nor a validator set, would be able to manipulate the randomness into any single value, a nefarious actor(s) might be able to exclude specific numbers.
- Predictability Window: The seed value might be accessible to other parties before the smart contract can benefit from its uniqueness. This predictability window creates a vulnerability. An attacker could potentially observe the seed generation process and predict the sequence of "random" numbers it will produce, compromising the entire cryptographic foundation of your smart contract.
Despite these limitations appearing severe, attackers face significant hurdles to exploit them. First, the attacker can't control the random number, limiting the attack's effectiveness to how that number is used. Second, a substantial amount of AVAX is needed. And last, such an attack would likely decrease AVAX's value, hurting the attacker financially.
One potential attack vector involves collusion among multiple proposers to manipulate the random number selection. These attackers could strategically choose to propose or abstain from proposing blocks, effectively introducing a bias into the system. By working together, they could potentially increase their chances of generating a random number favorable to their goals.
However, the effectiveness of this attack is significantly limited for the following reasons:
- Limited options: While colluding attackers expand their potential random number choices, the overall pool remains immense (2^256 possibilities). This drastically reduces their ability to target a specific value.
- Protocol's countermeasure: The protocol automatically eliminates any bias introduced by previous proposals once an honest proposer submits their block.
- Detectability: Exploitation of this attack vector is readily identifiable. A successful attack necessitates coordinated collusion among multiple nodes to synchronize their proposer slots for a specific block height ( the proposer slot order are known in advance ). Subsequent to this alignment, a designated node constructs the block proposal. The network maintains a record of the proposer slot utilized for each block. A value of zero for the proposer slot unequivocally indicates the absence of an exploit. Increasing values correlate with a heightened risk of exploitation. It is important to note that non-zero slot numbers may also arise from transient network disturbances.
While this attack is theoretically possible, its practical impact is negligible due to the vast number of potential outcomes and the protocol's inherent safeguards.
## Open Questions
### How would the proposed changes impact the proposer selection and their inherit bias ?
The proposed modifications will not influence the selection process for block proposers.
Proposers retain the ability to determine which transactions are included in a block.
This inherent proposer bias remains unchanged and is unaffected by the proposed changes.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-118: Warp Signature Request (/docs/acps/118-warp-signature-request)
---
title: "ACP-118: Warp Signature Request"
description: "Details for Avalanche Community Proposal 118: Warp Signature Request"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/118-warp-signature-request/README.md
---
| ACP | 118 |
| :--- | :--- |
| **Title** | Warp Signature Interface Standard |
| **Author(s)** | Cam Schultz ([@cam-schultz](https://github.com/cam-schultz)) |
| **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/123)) |
| **Track** | Best Practices Track |
## Abstract
Proposes a standard [AppRequest](https://github.com/ava-labs/avalanchego/blob/master/proto/p2p/p2p.proto#L385) payload format type for requesting Warp signatures for the provided bytes, such that signatures may be requested in a VM-agnostic manner. To make this concrete, this standard type should be defined in AvalancheGo such that VMs can import it at the source code level. This will simplify signature aggregator implementations by allowing them to depend only on AvalancheGo for message construction, rather than individual VM codecs.
## Motivation
Warp message signatures consist of an aggregate BLS signature composed of the individual signatures of a subnet's validators. Individual signatures need to be retreivable by the party that wishes to construct an aggregate signature. At present, this is left to VMs to implement, as is the case with [Subnet EVM](https://github.com/ava-labs/subnet-evm/blob/v0.6.7/plugin/evm/message/signature_request.go#20) and [Coreth](https://github.com/ava-labs/coreth/blob/v0.13.6-rc.0/plugin/evm/message/signature_request.go#L20)
This creates friction in applications that are intended to operate across many VMs (or distinct implementations of the same VM). As an example, the reference Warp message relayer implementation, [awm-relayer](https://github.com/ava-labs/awm-relayer), fetches individual signatures from validators and aggregates them before sending the Warp message to its destination chain for verification. However, Subnet EVM and Coreth have distinct codecs, requiring the relayer to [switch](https://github.com/ava-labs/awm-relayer/blob/v1.4.0-rc.0/relayer/application_relayer.go#L372) according to the target codebase.
Another example is ACP-75, which aims to implement acceptance proofs using Warp. The signature aggregation mechanism is not [specified](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/75-acceptance-proofs/README.md#signature-aggregation), which is a blocker for that ACP to be marked implementable.
Standardizing the Warp Signature Request interface by defining it as a format for `AppRequest` message payloads in AvalancheGo would simplify the implementation of ACP-75, and streamline signature aggregation for out-of-protocol services such as Warp message relayers.
## Specification
We propose the following types, implemented as Protobuf types that may be decoded from the `AppRequest`/`AppResponse` `app_bytes` field. By way of example, this approach is currently used to [implement](https://github.com/ava-labs/avalanchego/blob/v1.11.10-status-removal/proto/sdk/sdk.proto#7) and [parse](https://github.com/ava-labs/avalanchego/blob/v1.11.10-status-removal/network/p2p/gossip/message.go#22) gossip `AppRequest` types.
- `SignatureRequest` includes two fields. `message` specifies the payload that the returned signature should correspond to, namely a serialized unsigned Warp message. `justification` specifies arbitrary data that the requested node may use to decide whether or not it is willing to sign `message`. `justification` may not be required by every VM implementation, but `message` should always contain the bytes to be signed. It is up to the VM to define the validity requirements for the `message` and `justification` payloads.
```protobuf
message SignatureRequest {
bytes message = 1;
bytes justification = 2;
}
```
- `SignatureResponse` is the corresponding `AppResponse` type that returns the requested signature.
```protobuf
message SignatureResponse {
bytes signature = 1;
}
```
### Handlers
For each of the above types, VMs must implement corresponding `AppRequest` and `AppResponse` handlers. The `AppRequest` handler should be [registered](https://github.com/ava-labs/avalanchego/blob/v1.11.10-status-removal/network/p2p/network.go#L173) using the canonical handler ID, defined as `2`.
## Use Cases
Generally speaking, `SignatureRequest` can be used to request a signature over a Warp message by serializing the unsigned Warp message into `message`, and populating `justification` as needed.
### Sign a known Warp Message
Subnet EVM and Coreth store messages that have been seen (i.e. on-chain message sent through the [Warp Precompile](https://github.com/ava-labs/subnet-evm/tree/v0.6.7/precompile/contracts/warp) and [off-chain](https://github.com/ava-labs/subnet-evm/blob/v0.6.7/plugin/evm/config.go#L226) Warp messages) such that a signature over that message can be provided on request. `SignatureRequest` can be used for this case by specifying the Warp message in `message`. The queried node may then look up the Warp message in its database and return the signature. In this case, `justification` is not needed.
### Attest to an on-chain event
Subnet EVM and Coreth also support attesting to block hashes via Warp, by serving signature requests made using the following `AppRequest` type:
```
type BlockSignatureRequest struct {
BlockID ids.ID
}
```
`SignatureRequest` can achieve this by specifying an unsigned Warp message with the `BlockID` as the payload, and serializing that message into `message`. `justification` may optionally be used to provide additional context, such as a the block height of the given block ID.
### Confirm that an event did not occur
With [ACP-77](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets), Subnets will have the ability to manage their own validator sets. The Warp message payload contained in a `RegisterSubnetValidatorTx` includes an `expiry`, after which the specified validation ID (i.e. a unique hash over the Subnet ID, node ID, stake weight, and expiry) becomes invalid. The Subnet needs to know that this validation ID is expired so that it can keep its locally tracked validator set in sync with the P-Chain. We also assume that the P-Chain will not persist expired or invalid validation IDs.
We can use `SignatureRequest` to construct a Warp message attesting that the validation ID expired. We do so by serializing an unsigned Warp message containing the validation ID into `message`, and providing the validation ID hash preimage in `justification` for the P-Chain to reconstruct the expired validation ID.
## Security Considerations
VMs have full latitude when implementing `SignatureRequest` handlers, and should take careful consideration of what `message` payloads their implementation should be willing to sign, given a `justification`. Some considerations include, but are not limited to:
- Input validation. Handlers should validate `message` and `justification` payloads to ensure that they decode to coherent types, and that they contain only expected data.
- Signature DoS. AvalancheGo's peer-to-peer networking stack implements message rate limiting to mitigate the risk of DoS, but VMs should also consider the cost of parsing and signing a `message` payload.
- Payload collision. `message` payloads should be implemented as distinct types that do not overlap with one another within the context of signed Warp messages from the VM. For instance, a `message` payload specifying 32-byte hash may be interpreted as a transaction hash, a block hash, or a blockchain ID.
## Backwards Compatibility
This change is backwards compatible for VMs, as nodes running older versions that do not support the new message types will simply drop incoming messages.
## Reference Implementation
A reference implementation containing the Protobuf types and the canonical handler ID can be found [here](https://github.com/ava-labs/avalanchego/pull/3218).
## Acknowledgements
Thanks to @joshua-kim, @iansuvak, @aaronbuchwald, @michaelkaplan13, and @StephenButtolph for discussion and feedback on this ACP.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-125: Basefee Reduction (/docs/acps/125-basefee-reduction)
---
title: "ACP-125: Basefee Reduction"
description: "Details for Avalanche Community Proposal 125: Basefee Reduction"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/125-basefee-reduction/README.md
---
| ACP | 125 |
| :--- | :--- |
| **Title** | Reduce C-Chain minimum base fee from 25 nAVAX to 1 nAVAX |
| **Author(s)** | Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Darioush Jalali ([@darioush](https://github.com/darioush)) |
| **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/127)) |
| **Track** | Standards |
## Abstract
Reduce the minimum base fee on the Avalanche C-Chain from 25 nAVAX to 1 nAVAX.
## Motivation
With dynamic fees, the gas price is supposed to be a result of a continuous auction such that the consumed gas per second converges to the target gas usage per second.
When dynamic fees were first introduced, safeguards were added to ensure the mechanism worked as intended, such as a relatively high minimum gas price and a maximum gas price.
The maximum gas price has since been entirely removed. The minimum gas price has been reduced significantly. However, the base fee is often observed pinned to this minimum. This shows that it is higher than what the market demands, and therefore it is artificially reducing network usage.
## Specification
The dynamic fee calculation currently must enforce a minimum base fee of 25 nAVAX.
This change proposes reducing the minimum base fee to 1 nAVAX upon the next network upgrade activation.
## Backwards Compatibility
Modifies the consensus rules for the C-Chain, therefore it requires a network upgrade.
## Reference Implementation
A draft implementation of this ACP for the coreth VM can be found [here](https://github.com/ava-labs/coreth/pull/604/files).
## Security Considerations
Lower gas costs may increase state bloat. However, we note that the dynamic fee algorithm responded appropriately during periods of high use (such as Dec. 2023), which gives reasonable confidence that enforcing a 25 nAVAX minimum fee is no longer necessary.
## Open Questions
N/A
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-13: Subnet Only Validators (/docs/acps/13-subnet-only-validators)
---
title: "ACP-13: Subnet Only Validators"
description: "Details for Avalanche Community Proposal 13: Subnet Only Validators"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/13-subnet-only-validators/README.md
---
| ACP | 13 |
| :--- | :--- |
| **Title** | Subnet-Only Validators (SOVs) |
| **Author(s)** | Patrick O'Grady ([contact@patrickogrady.xyz](mailto:contact@patrickogrady.xyz)) |
| **Status** | Stale |
| **Track** | Standards |
| **Superseded-By** | [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md) |
## Abstract
Introduce a new type of staker, Subnet-Only Validators (SOVs), that can validate an Avalanche Subnet and participate in Avalanche Warp Messaging (AWM) without syncing or becoming a Validator on the Primary Network. Require SOVs to pay a refundable fee of 500 $AVAX on the P-Chain to register as a Subnet Validator instead of staking at least 2000 $AVAX, the minimum requirement to become a Primary Network Validator. Preview a future transition to Pay-As-You-Go Subnet Validation and $AVAX-Augmented Subnet Security.
_This ACP does not modify/deprecate the existing Subnet Validation semantics for Primary Network Validators._
## Motivation
Each node operator must stake at least 2000 $AVAX ($20k at the time of writing) to first become a Primary Network Validator before they qualify to become a Subnet Validator. Most Subnets aim to launch with at least 8 Subnet Validators, which requires staking 16000 $AVAX ($160k at time of writing). All Subnet Validators, to satisfy their role as Primary Network Validators, must also [allocate 8 AWS vCPU, 16 GB RAM, and 1 TB storage](https://github.com/ava-labs/avalanchego/blob/master/README.md#installation) to sync the entire Primary Network (X-Chain, P-Chain, and C-Chain) and participate in its consensus, in addition to whatever resources are required for each Subnet they are validating.
Avalanche Warp Messaging (AWM), the native interoperability mechanism for the Avalanche Network, provides a way for Subnets to communicate with each other/C-Chain without a trusted intermediary. Any Subnet Validator must be able to register a BLS key and participate in AWM, otherwise a Subnet may not be able to generate a BLS Multi-Signature with sufficient participating stake.
Regulated entities that are prohibited from validating permissionless, smart contract-enabled blockchains (like the C-Chain) can’t launch a Subnet because they can’t opt-out of Primary Network Validation. This deployment blocker prevents a large cohort of Real World Asset (RWA) issuers from bringing unique, valuable tokens to the Avalanche Ecosystem (that could move between C-Chain <-> Subnets using AWM/Teleporter).
A widely validated Subnet that is not properly metered could destabilize the Primary Network if usage spikes unexpectedly. Underprovisioned Primary Network Validators running such a Subnet may exit with an OOM exception, see degraded disk performance, or find it difficult to allocate CPU time to P/X/C-Chain validation. The inverse also holds for Subnets with the Primary Network (where some undefined behavior could bring a Subnet offline).
Although the fee paid to the Primary Network to operate a Subnet does not go up with the amount of activity on the Subnet, the fixed, upfront cost of setting up a Subnet Validator on the Primary Network deters new projects that prefer smaller, even variable, costs until demand is observed. _Unlike L2s that pay some increasing fee (usually denominated in units per transaction byte) to an external chain for data availability and security as activity scales, Subnets provide their own security/data availability and the only cost operators must pay from processing more activity is the hardware cost of supporting additional load._
Elastic Subnets allow any community to weight Subnet Validation based on some staking token and reward Subnet Validators with high uptime with said staking token. However, there is no way for $AVAX holders on the Primary Network to augment the security of such Subnets.
## Specification
### Required Changes
1) Introduce a new type of staker, Subnet-Only Validators (SOVs), that can validate an Avalanche Subnet and participate in Avalanche Warp Messaging (AWM) without syncing or becoming a Validator on the Primary Network
2) Introduce a refundable fee (called a "lock") of 500 $AVAX that nodes must pay to become an SOV
3) Introduce a non-refundable fee of 0.1 $AVAX that SOVs must pay to become an SOV
4) Introduce a new transaction type on the P-Chain to register as an SOV (i.e. `AddSubnetOnlyValidatorTx`)
5) Add a mode to ANCs that allows SOVs to optionally disable full Primary Network verification (only need to verify P-Chain)
6) ANCs track IPs for SOVs to ensure Subnet Validators can find peers whether or not they are Primary Network Validators
7) Provide a guaranteed rate limiting allowance for SOVs like Primary Network Validators
Because SOVs do not validate the Primary Network, they will not be rewarded with $AVAX for "locking" the 500 $AVAX required to become an SOV. This enables people interested in validating Subnets to opt for a lower upfront $AVAX commitment and lower infrastructure costs instead of $AVAX rewards. Additionally, SOVs will only be required to sync the P-chain (not X/C-Chain) to track any validator set changes in their Subnet and to support Cross-Subnet communication via AWM (see “Primary Network Partial Sync” mode introduced in [Cortina 8](https://github.com/ava-labs/avalanchego/releases/tag/v1.10.8)). The lower resource requirement in this "minimal mode" will provide Subnets with greater flexibility of validation hardware requirements as operators are not required to reserve any resources for C-Chain/X-Chain operation. If an SOV wishes to sync the entire Primary Network, they still can.
### Future Work
The previously described specification is a minimal, additive change to Subnet Validation semantics that prepares the Avalanche Network for a more flexible Subnet model. It alone, however, fails to communicate this flexibility nor provides an alternative use of $AVAX that would have otherwise been used to create Subnet Validators.
Below are two high-level ideas (Pay-As-You-Go Subnet Validation Registration Fees and $AVAX-Augmented Security) that highlight how this initial change could be extended in the future. If the Avalanche Community is interested in their adoption, they should each be proposed as a unique ACP where they can be properly specified. **These ideas are only suggestions for how the Avalanche Network could be modified in the future if this ACP is adopted. Supporting this ACP does not require supporting these ideas or committing to their rollout.**
#### Pay-As-You-Go Subnet Validation Registration Fees
_Transition Subnet Validator registration to a dynamically priced, continuously charged fee (that doesn't require locking large amounts of $AVAX upfront)._
While it would be possible to just transition to a lower required "lock" amount, many think that it would be more competitive to transition to a dynamically priced, continuous payment mechanism to register as a Subnet Validator. This new mechanism would target some $Y nAVAX fee that would be paid by each Subnet Validator per Subnet per second (pulling from a "Subnet Validator's Account") instead of requiring a large upfront lockup of $AVAX.
The rate of nAVAX/second should be set by the demand for validating Subnets on Avalanche compared to some usage target per Subnet and across all Subnets. This rate should be locked for each Subnet Validation period to ensure operators are not subject to surprise costs if demand rises significantly over time. The optimization work outlined in [BLS Multi-Signature Voting](https://hackmd.io/@patrickogrady/100k-subnets#How-will-BLS-Multi-Signature-uptime-voting-work) should allow the min rate to be set as low as ~512-4096 nAVAX/second (or 1.3-10.6 $AVAX/month).
Fees paid to the Avalanche Network for PAYG could be burned, like all other P-Chain, X-Chain, and C-Chain transactions, or they could be partially rewarded to Primary Network Validators as a "boost" over the existing staking rewards. The nice byproduct of the latter approach is that it better aligns Primary Network Validators with the growth of Subnets.
#### $AVAX-Augmented Subnet Security
_Allow pledging unstaked $AVAX to Subnet Validators on Elastic Subnets that can be slashed if said Subnet Validator commits an attributable fault (i.e. proposes/signs conflicting blocks/AWM payloads). Reward locked $AVAX associated with Subnet Validators that were not slashed with Elastic Subnet staking rewards._
Currently, the only way to secure an Elastic Subnet is to stake its custom staking token (defined in the `TransformSubnetTx`). Many have requested the option to use $AVAX for this token, however, this could easily allow an adversary to take over small Elastic Subnets (where the amount of $AVAX staked may be much less than the circulating supply).
$AVAX-Augmented Subnet Security would allow anyone holding $AVAX to lock it to specific Subnet Validators and earn Elastic Subnet reward tokens for supporting honest participants. Recall, all stake management on the Avalanche Network (even for Subnets) occurs on the P-Chain. Thus, staked tokens ($AVAX and/or custom staking tokens used in Elastic Subnets) and stake weights (used for AWM verification) are secured by the full $AVAX stake of the Primary Network. $AVAX-Augmented Subnet Security, like staking, would be implemented on the P-Chain and enjoy the full security of the Primary Network. This approach means locking $AVAX occurs on the Primary Network (no need to transfer $AVAX to a Subnet, which may not be secured by meaningful value yet) and proofs of malicious behavior are processed on the Primary Network (a colluding Subnet could otherwise choose not to process a proof that would lead to their "lockers" being slashed).
_This native approach is comparable to the idea of using $ETH to secure DA on [EigenLayer](https://www.eigenlayer.xyz/) (without reusing stake) or $BTC to secure Cosmos Zones on [Babylon](https://babylonchain.io/) (but not using an external ecosystem)._
## Backwards Compatibility
* Existing Subnet Validation semantics for Primary Network Validators are not modified by this ACP. This means that All existing Subnet Validators can continue validating both the Primary Network and whatever Subnets they are validating. This change would just provide a new option for Subnet Validators that allows them to sacrifice their staking rewards for a smaller upfront $AVAX commitment and lower infrastructure costs.
* Support for this ACP would require adding a new transaction type to the P-Chain (i.e. `AddSubnetOnlyValidatorTx`). This new transaction is an execution-breaking change that would require a mandatory Avalanche Network upgrade to activate.
## Reference Implementation
A full implementation will be provided once this ACP is considered `Implementable`. However, some initial ideas are presented below.
### `AddSubnetOnlyValidatorTx`
```text
type AddSubnetOnlyValidatorTx struct {
// Metadata, inputs and outputs
BaseTx `serialize:"true"`
// Describes the validator
// The NodeID included in [Validator] must be the Ed25519 public key.
Validator `serialize:"true" json:"validator"`
// ID of the subnet this validator is validating
Subnet ids.ID `serialize:"true" json:"subnetID"`
// [Signer] is the BLS key for this validator.
// Note: We do not enforce that the BLS key is unique across all validators.
// This means that validators can share a key if they so choose.
// However, a NodeID does uniquely map to a BLS key
Signer signer.Signer `serialize:"true" json:"signer"`
// Where to send locked tokens when done validating
LockOuts []*avax.TransferableOutput `serialize:"true" json:"lock"`
// Where to send validation rewards when done validating
ValidatorRewardsOwner fx.Owner `serialize:"true" json:"validationRewardsOwner"`
// Where to send delegation rewards when done validating
DelegatorRewardsOwner fx.Owner `serialize:"true" json:"delegationRewardsOwner"`
// Fee this validator charges delegators as a percentage, times 10,000
// For example, if this validator has DelegationShares=300,000 then they
// take 30% of rewards from delegators
DelegationShares uint32 `serialize:"true" json:"shares"`
}
```
_`AddSubnetOnlyValidatorTx` is almost the same as [`AddPermissionlessValidatorTx`](https://github.com/ava-labs/avalanchego/blob/638000c42e5361e656ffbc27024026f6d8f67810/vms/platformvm/txs/add_permissionless_validator_tx.go#L33-L58), the only exception being that `StakeOuts` are now `LockOuts`._
### `GetSubnetPeers`
To support tracking SOV IPs, a new message should be added to the P2P specification that allows Subnet Validators to request the IP of all peers a node knows about on a Subnet (these Signed IPs won't be gossiped like they are for Primary Network Validators because they don't need to be known by the entire Avalanche Network):
```text
message GetSubnetPeers {
bytes subnet_id = 1;
}
```
_It would be a nice addition if a bloom filter could also be provided here so that an ANC only sends IPs of peers that the original sender does not know._
ANCs should respond to this incoming message with a [`PeerList` message](https://github.com/ava-labs/avalanchego/blob/638000c42e5361e656ffbc27024026f6d8f67810/proto/p2p/p2p.proto#L135-L148).
## Security Considerations
* Any Subnet Validator running in "Partial Sync Mode" will not be able to verify Atomic Imports on the P-Chain and will rely entirely on Primary Network consensus to only accept valid P-Chain blocks.
* High-throughput Subnets will be better isolated from the Primary Network and should improve its resilience (i.e. surges of traffic on some Subnet cannot destabilize a Primary Network Validator).
* Avalanche Network Clients (ANCs) must track IPs and provide allocated bandwidth for SOVs even though they are not Primary Network Validators.
## Open Questions
* To help orient the Avalanche Community around this wide-ranging and likely to be long-running conversation around the relationship between the Primary Network and Subnets, should we come up with a project name to describe the effort? I've been casually referring to all of these things as the _Astra Upgrade Track_ but definitely up for discussion (may be more confusing than it is worth to do this).
## Appendix
A draft of this ACP was posted on in the ["Ideas" Discussion Board](https://github.com/avalanche-foundation/ACPs/discussions/10#discussioncomment-7373486), as suggested by the [ACP README](https://github.com/avalanche-foundation/ACPs#step-1-post-your-idea-to-github-discussions). Feedback on this draft was collected and addressed on both the "Ideas" Discussion Board and on [HackMD](https://hackmd.io/@patrickogrady/100k-subnets#Feedback-to-Draft-Proposal).
## Acknowledgements
Thanks to @luigidemeo1, @stephenbuttolph, @aaronbuchwald, @dhrubabasu, and @abi87 for their feedback on these ideas.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-131: Cancun Eips (/docs/acps/131-cancun-eips)
---
title: "ACP-131: Cancun Eips"
description: "Details for Avalanche Community Proposal 131: Cancun Eips"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/131-cancun-eips/README.md
---
| ACP | 131 |
| :--- | :--- |
| **Title** | Activate Cancun EIPs on C-Chain and Subnet-EVM chains |
| **Author(s)** | Darioush Jalali ([@darioush](https://github.com/darioush)), Ceyhun Onur ([@ceyonur](https://github.com/ceyonur)) |
| **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/139)) |
| **Track** | Standards, Subnet |
## Abstract
Enable new EVM opcodes and opcode changes in accordance with the following EIPs on the Avalanche C-Chain and Subnet-EVM chains:
- [EIP-4844: BLOBHASH opcode](https://eips.ethereum.org/EIPS/eip-4844)
- [EIP-7516: BLOBBASEFEE opcode](https://eips.ethereum.org/EIPS/eip-7516)
- [EIP-1153: Transient storage](https://eips.ethereum.org/EIPS/eip-1153)
- [EIP-5656: MCOPY opcode](https://eips.ethereum.org/EIPS/eip-5656)
- [EIP-6780: SELFDESTRUCT only in same transaction](https://eips.ethereum.org/EIPS/eip-6780)
Note blob transactions from EIP-4844 are excluded and blocks containing them will still be considered invalid.
## Motivation
The listed EIPs were activated on Ethereum mainnet as part of the [Cancun upgrade](https://github.com/ethereum/execution-specs/blob/master/network-upgrades/mainnet-upgrades/cancun.md#included-eips). This proposal is to activate them on the Avalanche C-Chain in the next network upgrade, to maintain compatibility with upstream EVM tooling, infrastructure, and developer experience (e.g., Solidity compiler defaults >= [0.8.25](https://github.com/ethereum/solidity/releases/tag/v0.8.25)). Additionally, it recommends the activation of the same EIPs on Subnet-EVM chains.
## Specification & Reference Implementation
The opcodes (EVM exceution modifications) and block header modifications should be adopted as specified in the EIPs themselves. Other changes such as enabling new transaction types or mempool modifications are not in scope (specifically blob transactions from EIP-4844 are excluded and blocks containing them are considered invalid). ANCs (Avalanche Network Clients) can adopt the implementation as specified in the [coreth](https://github.com/ava-labs/coreth) repository, which was adopted from the [go-ethereum v1.13.8](https://github.com/ethereum/go-ethereum/releases/tag/v1.13.8) release in this [PR](https://github.com/ava-labs/coreth/pull/550). In particular, note the following code:
- [Activation of new opcodes](https://github.com/ava-labs/coreth/blob/7b875dc21772c1bb9e9de5bc2b31e88c53055e26/core/vm/jump_table.go#L93)
- Activation of Cancun in next Avalanche upgrade:
- [C-Chain](https://github.com/ava-labs/coreth/pull/610)
- [Subnet-EVM chains](https://github.com/ava-labs/subnet-evm/blob/fa909031ed148484c5072d949c5ed73d915ce1ed/params/config_extra.go#L186)
- `ParentBeaconRoot` is enforced to be included and the zero value [here](https://github.com/ava-labs/coreth/blob/7b875dc21772c1bb9e9de5bc2b31e88c53055e26/plugin/evm/block_verification.go#L287-L288). This field is retained for future use and compatibility with upstream tooling.
- Forbids blob transactions by enforcing `BlobGasUsed` to be 0 [here](https://github.com/ava-labs/coreth/pull/611/files#diff-532a2c6a5365d863807de5b435d8d6475552904679fd611b1b4b10d3bf4f5010R267).
_Note:_ Subnets are sovereign in regards to their validator set and state transition rules, and can choose to opt out of this proposal by making a code change in their respective Subnet-EVM client.
## Backwards Compatibility
The original EIP authors highlighted the following considerations. For full details, refer to the original EIPs:
- [EIP-4844](https://eips.ethereum.org/EIPS/eip-4844#backwards-compatibility): Blob transactions are not proposed to be enabled on Avalanche, so concerns related to mempool or transaction data availability are not applicable.
- [EIP-6780](https://eips.ethereum.org/EIPS/eip-6780#backwards-compatibility) "Contracts that depended on re-deploying contracts at the same address using CREATE2 (after a SELFDESTRUCT) will no longer function properly if the created contract does not call SELFDESTRUCT within the same transaction."
Adoption of this ACP modifies consensus rules for the C-Chain, therefore it requires a network upgrade. It is recommended that Subnet-EVM chains also adopt this ACP and follow the same upgrade time as Avalanche's next network upgrade.
## Security Considerations
Refer to the original EIPs for security considerations:
- [EIP 1153](https://eips.ethereum.org/EIPS/eip-1153#security-considerations)
- [EIP 4788](https://eips.ethereum.org/EIPS/eip-4788#security-considerations)
- [EIP 4844](https://eips.ethereum.org/EIPS/eip-4844#security-considerations)
- [EIP 5656](https://eips.ethereum.org/EIPS/eip-5656#security-considerations)
- [EIP 6780](https://eips.ethereum.org/EIPS/eip-6780#security-considerations)
- [EIP 7516](https://eips.ethereum.org/EIPS/eip-7516#security-considerations)
## Open Questions
No open questions.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-151: Use Current Block Pchain Height As Context (/docs/acps/151-use-current-block-pchain-height-as-context)
---
title: "ACP-151: Use Current Block Pchain Height As Context"
description: "Details for Avalanche Community Proposal 151: Use Current Block Pchain Height As Context"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/151-use-current-block-pchain-height-as-context/README.md
---
| ACP | 151 |
| :------------ | :----------------------------------------------------------------------------------------- |
| **Title** | Use current block P-Chain height as context for state verification |
| **Author(s)** | Ian Suvak ([@iansuvak](https://github.com/iansuvak)) |
| **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/152)) |
| **Track** | Standards |
## Abstract
Proposes that the ProposerVM passes inner VMs the P-Chain block height of the current block being built rather than the P-Chain block height of the parent block. Inner VMs use this P-Chain height for verifying aggregated signatures of Avalanche Interchain Messages (ICM). This will allow for a more reliable way to determine which validators should participate in signing the message, and remove unnecessary waiting periods.
## Motivation
Currently the ProposerVM passes the P-Chain height of the parent block to inner VMs, which use the value to verify ICM messages in the current block. Using the parent block's P-Chain height is necessary for verifying the proposer and reaching consensus on the current block, but it is not necessary for verifying ICM messages within the block.
Using the P-Chain height of the current block being built would make operations using ICM messages to modify the validator set, such as ones specified in [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md) be verifiable sooner and more reliably. Currently at least two new P-Chain blocks need to be produced after the relevant state change for it to be reflected for purposes of ICM aggregate signature verification.
## Specification
The [block context](https://github.com/ava-labs/avalanchego/blob/d2e9d12ed2a1b6581b8fd414cbfb89a6cfa64551/snow/engine/snowman/block/block_context_vm.go#L14) contains a `PChainHeight` field that is passed from the ProposerVM to the inner VMs building the block. It is later used by the inner VMs to fetch the canonical validator set for verification of ICM aggregated signatures.
The `PChainHeight` currently passed in by the ProposerVM is the P-Chain height of the parent block. The proposed change is to instead have the ProposerVM pass in the P-Chain height of the current block.
## Backwards Compatibility
This change requires an upgrade to make sure that all validators verifying the validity of the ICM messages use the same P-Chain height and therefore the same validator set. Prior to activation nodes should continue to use P-Chain height of the parent block.
## Reference Implementation
An implementation of this ACP for avalanchego can be found [here](https://github.com/ava-labs/avalanchego/pull/3459)
## Security Considerations
ProposerVM needs to use the parent block's P-Chain height to verify proposers for security reasons but we don't have such restrictions for verifying ICM message validity in the current block being built. Therefore, this should be a safe change.
## Acknowledgments
Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@michaelkaplan13](https://github.com/michaelkaplan13) for discussion and feedback on this ACP.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-176: Dynamic Evm Gas Limit And Price Discovery Updates (/docs/acps/176-dynamic-evm-gas-limit-and-price-discovery-updates)
---
title: "ACP-176: Dynamic Evm Gas Limit And Price Discovery Updates"
description: "Details for Avalanche Community Proposal 176: Dynamic Evm Gas Limit And Price Discovery Updates"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/176-dynamic-evm-gas-limit-and-price-discovery-updates/README.md
---
| ACP | 176 |
| :- | :- |
| **Title** | Dynamic EVM Gas Limits and Price Discovery Updates |
| **Author(s)** | Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)) |
| **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/178)) |
| **Track** | Standards |
## Abstract
Proposes that the C-Chain and Subnet-EVM chains adopt a dynamic fee mechanism similar to the one [introduced on the P-Chain as part of ACP-103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md), with modifications to allow for block proposers (i.e. validators) to dynamically adjust the target gas consumption per unit time.
## Motivation
Currently, the C-Chain has a static gas target of [15,000,000 gas](https://github.com/ava-labs/coreth/blob/39ec874505b42a44e452b8809a2cc6d09098e84e/params/avalanche_params.go#L32) per [10 second rolling window](https://github.com/ava-labs/coreth/blob/39ec874505b42a44e452b8809a2cc6d09098e84e/params/avalanche_params.go#L36), and uses a modified version of the [EIP-1559](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-1559.md) dynamic fee mechanism to adjust the base fee of blocks based on the gas consumed in the previous 10 second window. This has two notable drawbacks:
1. The windower mechanism used to determine the base fee of blocks can lead to outsized spikes in the gas price when there is a large block. This is because after a large block that uses all of its gas limit, blocks that follow in the same window continue to result in increased gas prices even if they are relatively small blocks that are under the target gas consumption.
2. The static gas target necessitates a required network upgrade in order to modify. This is cumbersome and makes it difficult for the network to adjust its capacity in response to performance optimizations or hardware requirement increases.
To better position Avalanche EVM chains, including the C-Chain, to be able to handle future increases in load, we propose replacing the above mechanism with one that better handles blocks that consume a large amount of gas, and that allows for validators to dynamically adjust the target rate of consumption.
## Specification
### Gas Price Determination
The mechanism to determine the base fee of a block is the same as the one used in [ACP-103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md) to determine the gas price of a block on the P-Chain. This mechanism calculates the gas price for a given block $b$ based on the following parameters:
| | |
|---|---|
| $T$ | the target gas consumed per second |
| $M$ | minimum gas price |
| $K$ | gas price update constant |
| $C$ | maximum gas capacity |
| $R$ | gas capacity added per second |
### Making $T$ Dynamic
As noted above, the gas price determination mechanism relies on a target gas consumption per second, $T$, in order to calculate the gas price for a given block. $T$ will be adjusted dynamically according to the following specification.
Let $q$ be a non-negative integer that is initialized to 0 upon activation of this mechanism. Let the target gas consumption per second be expressed as:
$$T = P \cdot e^{\frac{q}{D}}$$
where $P$ is the global minimum allowed target gas consumption rate for the network, and $D$ is a constant that helps control the rate of change of the target gas consumption.
After the execution of transactions in block $b$, the value of $q$ can be increased or decreased up to $Q$. It must be the case that $\left|\Delta q\right| \leq Q$, or block $b$ is considered invalid. The amount by which $q$ changes after executing block $b$ is specified by the block builder.
Block builders (i.e. validators), may set their desired value for $T$ (i.e. their desired gas consumption rate) in their configuration, and their desired value for $q$ can then be calculated as:
$$q_{desired} = D \cdot ln\left(\frac{T_{desired}}{P}\right)$$
Note that since $q_{desired}$ is only used locally and can be different for each node, it is safe for implementations to approximate the value of $ln\left(\frac{T_{desired}}{P}\right)$, and round the resulting value to the nearest integer.
When building a block, builders can calculate their next preferred value for $q$ based on the network's current value (`q_current`) according to:
```python
# Calculates a node's new desired value for q given for a given block
def calc_next_q(q_current: int, q_desired: int, max_change: int) -> int:
if q_desired > q_current:
return q_current + min(q_desired - q_current, max_change)
else:
return q_current - min(q_current - q_desired, max_change)
```
As $q$ is updated after the execution of transactions within the block, $T$ is also updated such that $T = P \cdot e^{\frac{q}{D}}$ at all times. As the value of $T$ adjusts, the value of $R$ (capacity added per second) is also updated such that:
$$R = 2 \cdot T$$
This ensures that the gas price can increase and decrease at the same rate.
The value of $C$ must also adjust proportionately, so we set:
$$C = 10 \cdot T$$
This means that the maximum stored gas capacity would be reached after 5 seconds where no blocks have been accepted.
In order to keep roughly constant the time it takes for the gas price to double at sustained maximum network capacity usage, the value of $K$ used in the gas price determination mechanism must be updated proportionally to $T$ such that:
$$K = 87 \cdot T$$
In order to have the gas price not be directly impacted by the change in $K$, we also update $x$ (excess gas consumption) proportionally. When updating $x$ after executing a block, instead of setting $x = x + G$ as specified in ACP-103, we set:
$$x_{n+1} = (x + G) \cdot \frac{K_{n+1}}{K_{n}}$$
Note that the value of $q$ (and thus also $T$, $R$, $C$, $K$, and $x$) are updated **after** the execution of block $b$, which means they only take effect in determining the gas price of block $b+1$. The change to each of these values in block $b$ does not effect the gas price for transactions included in block $b$ itself.
Allowing block builders to adjust the target gas consumption rate in blocks that they produce makes it such that the effective target gas consumption rate should converge over time to the point where 50% of the voting stake weight wants it increased and 50% of the voting stake weight wants it decreased. This is because the number of blocks each validator produces is proportional to their stake weight.
As noted in ACP-103, the maximum gas consumed in a given period of time $\Delta{t}$, is $r + R \cdot \Delta{t}$, where $r$ is the remaining gas capacity at the end of previous block execution. The upper bound across all $\Delta{t}$ is $C + R \cdot \Delta{t}$. Phrased differently, the maximum amount of gas that can be consumed by any given block $b$ is:
$$gasLimit_{b} = min(r + R \cdot \Delta{t}, C)$$
### Configuration Parameters
As noted above, the gas price determination mechanism depends on the values of $T$, $M$, $K$, $C$, and $R$ to be set as parameters. $T$ is adjusted dynamically from its initial value based on $D$ and $P$, and the values of $R$ and $C$ are derived from $T$.
Parameters at activation on the C-Chain are:
$P$ was chosen as a safe bound on the minimum target gas usage on the C-Chain. The current gas target of the C-Chain is $1,500,000$ per second. The target gas consumption rate will only stay at $P$ if the majority of stake weight of the network specifies $P$ as their desired gas consumption rate target.
$D$ and $Q$ were chosen to give each block builder the ability to adjust the value of $T$ by roughly $\frac{1}{1024}$ of its current value, which matches the [gas limit bound divisor that Ethereum currently uses](https://github.com/ethereum/go-ethereum/blob/52766bedb9316cd6cddacbb282809e3bdfba143e/params/protocol_params.go#L26) to limit the amount that validators can change the execution layer gas limit in a single block. $D$ and $Q$ were scaled up by a factor of $2^{15}$ to provide block builders more granularity in the adjustments to $T$ that they can make.
$M$ was chosen as the minimum possible denomination of the native EVM asset, such that the gas price will be more likely to consistently be in a range of price discovery. The price discovery mechanism has already been battle tested on the P-Chain (and prior to that on Ethereum for blob gas prices as defined by EIP-4844), giving confidence that it will correctly react to any increase in network usage in order to prevent a DOS attack.
$K$ was chosen such that at sustained maximum capacity ($T*2$ gas/second), the fee rate will double every ~60.3 seconds. For comparison, EIP-1559 can double about ~70 seconds, and the C-Chain's current implementation can double about every ~50 seconds, depending on the time between blocks.
The maximum instantaneous price multiplier is:
$$e^\frac{C}{K} = e^\frac{10 \cdot T}{87 \cdot T} = e^\frac{10}{87} \simeq 1.12$$
### Choosing $T_{desired}$
As mentioned above, this new mechanism allows for validators to specify their desired target gas consumption rate ($T_{desired}$) in their configuration, and the value that they set impacts the effective target gas consumption rate of the network over time. The higher the value of $T$, the more resources (storage, compute, etc) that are able to be used by the network. When choosing what value makes sense for them, validators should consider the resources that are required to properly support that level of gas consumption, the utility the network provides by having higher transaction per second throughput, and the stability of network should it reach that level of utilization.
While Avalanche Network Clients can set default configuration values for the desired target gas consumption rate, each validator can choose to set this value independently based on their own considerations.
## Backwards Compatibility
The changes proposed in this ACP require a required network upgrade in order to take effect. Prior to its activation, the current gas limit and price discovery mechanisms will continue to be used. Its activation should have relatively minor compatibility effects on any developer tooling. Notably, transaction formats, and thus wallets, are not impacted. After its activation, given that the value of $C$ is dynamically adjusted, the maximum possible gas consumed by an individual block, and thus maximum possible consumed by an individual transaction, will also dynamically adjust. The upper bound on the amount of gas consumed by a single transaction fluctuating means that transactions that are considered invalid at one time may be considered valid at a different point in time, and vice versa. While potentially unintuitive, as long as the minimum gas consumption rate is set sufficiently high this should not have significant practical impact, and is also currently the case on the Ethereum mainnet.
> [!NOTE]
> After the activation of this ACP, concerns were raised around the latency of inclusion for large transactions when the fee is increasing. To address these concerns, block producers SHOULD only produce blocks when there is sufficient capacity to include large transactions. Prior to this ACP, the maximum size of a transaction was $15$ million gas. Therefore, the recommended heuristic is to only produce blocks when there is at least $\min(8 \cdot T, 15 \text{ million})$ capacity. _At the time of writing, this ensures transactions with up to 12.8 million gas will be able to bid for block space._
## Reference Implementation
This ACP was implemented and merged into Coreth behind the `Fortuna` upgrade flag. The full implementation can be found in [coreth@v0.14.1-acp-176.1](https://github.com/ava-labs/coreth/releases/tag/v0.14.1-acp-176.1).
## Security Considerations
This ACP changes the mechanism for determining the gas price on Avalanche EVM chains. The gas price is meant to adapt dynamically to respond to changes in demand for using the chain. If it does not react as expected, the chain could be at risk for a DOS attack (if the usage price is too low), or over charge users during period of low activity. This price discovery mechanism has already been employed on the P-Chain, but should again be thoroughly tested for use on the C-Chain prior to activation on the Avalanche Mainnet.
Further, this ACP also introduces a mechanism for validators to change the gas limit of the C-Chain. If this limit is set too high, it is possible that validator nodes will not be able to keep up in the processing of blocks. An upper bound on the maximum possible gas limit could be considered to try to mitigate this risk, though it would then take further required network upgrades to scale the network past that limit.
## Acknowledgments
Thanks to the following non-exhaustive list of individuals for input, discussion, and feedback on this ACP.
- [Emin Gün Sirer](https://x.com/el33th4xor)
- [Luigi D'Onorio DeMeo](https://x.com/luigidemeo)
- [Darioush Jalali](https://github.com/darioush)
- [Aaron Buchwald](https://github.com/aaronbuchwald)
- [Geoff Stuart](https://github.com/geoff-vball)
- [Meag FitzGerald](https://github.com/meaghanfitzgerald)
- [Austin Larson](https://github.com/alarso16)
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-181: P Chain Epoched Views (/docs/acps/181-p-chain-epoched-views)
---
title: "ACP-181: P Chain Epoched Views"
description: "Details for Avalanche Community Proposal 181: P Chain Epoched Views"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/181-p-chain-epoched-views/README.md
---
| ACP | 181 |
| :------------ | :----------------------------------------------------------------------------------------- |
| **Title** | P-Chain Epoched Views |
| **Author(s)** | Cam Schultz [@cam-schultz](https://github.com/cam-schultz) |
| **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/211)) |
| **Track** | Standards |
## Abstract
Proposes a standard P-Chain epoching scheme such that any VM that implements it uses a P-Chain block height known prior to the generation of its next block. This would enable VMs to optimize validator set retrievals, which currently must be done during block execution. This standard does *not* introduce epochs to the P-Chain's VM directly. Instead, it provides a standard that may be implemented by layers that inject P-Chain state into VMs, such as the ProposerVM.
## Motivation
The P-Chain maintains a registry of L1 and Subnet validators (including Primary Network validators). Validators are added, removed, or their weights changed by issuing P-Chain transactions that are included in P-Chain blocks. When describing an L1 or Subnet's validator set, what is really being described are the weights, BLS keys, and Node IDs of the active validators at a particular P-Chain height. Use cases that require on-demand views of L1 or Subnet validator sets need to fetch validator sets at arbitrary P-Chain heights, while use cases that require up-to-date views need to fetch them as often as every P-Chain block.
Epochs during which the P-Chain height is fixed would widen this window to a predictable epoch duration, allowing these use cases to implement optimizations such as pre-fetching validator sets once per epoch, or allowing more efficient backwards traversal of the P-Chain to fetch historical validator sets.
## Specification
### Assumptions
In the following specification, we assume that a block $b_m$ has timestamp $t_m$ and P-Chain height $p_m$.
### Epoch Definition
An epoch is defined as a contiguous range of blocks that share the same three values:
- An Epoch Number
- An Epoch P-Chain Height
- An Epoch Start Time
Let $E_N$ denote an epoch with epoch number $N$. $E_N$'s start time is denoted as $T_{start}^N$, and its P-Chain height as $P_N$.
Let block $b_a$ be the block that activates this ACP. The first epoch ($E_0$) has $T_{start}^0 = t_{a-1}$, and $P_0 = p_{a-1}$. In other words, the first epoch start time is the timestamp of the last block prior to the activation of this ACP, and similarly, the first epoch P-Chain height is the P-Chain height of last block prior to the activation of this ACP.
### Epoch Sealing
An epoch $E_N$ is *sealed* by the first block with a timestamp greater than or equal to $T_{start}^N + D$, where $D$ is a constant defined in the network upgrade that activates this ACP. Let $B_{S_N}$ denote the block that sealed $E_N$.
The sealing block is defined to be a member of the epoch it seals. This guarantees that every epoch will contain at least one block.
### Advancing an Epoch
We advance from the current epoch $E_N$ to the next epoch $E_{N+1}$ when the next block after $B_{S_N}$ is produced. This block will be a member of $E_{N+1}$, and will have the values:
- $P_{N+1}$ equal to the P-Chain height of $B_{S_N}$
- $T_{start}^{N+1}$ equal to $B_{S_N}$'s timestamp
- The epoch number, $N+1$ increments the previous epoch's epoch number by exactly $1$
## Properties
### Epoch Duration Bounds
Since an epoch's start time is set to the [timestamp of the sealing block of the previous epoch](#advancing-an-epoch), all epochs are guaranteed to have a duration of at least $D$, as measured from the epoch's starting time to the timestamp of the epoch's sealing block. However, since a sealing block is [defined](#epoch-sealing) to be a member of the epoch it seals, there is no upper bound on an epoch's duration, since that sealing block may be produced at any point in the future beyond $T_{start}^N + D$.
### Fixing the P-Chain Height
When building a block, Avalanche blockchains use the P-Chain height [embedded in the block](#assumptions) to determine the validator set. If instead the epoch P-Chain height is used, then we can ensure that when a block is built, the validator set to be used for the next block is known. To see this, suppose block $b_m$ seals epoch $E_N$. Then the next block, $b_{m+1}$ will begin a new epoch, $E_{N+1}$ with $P_{N+1}$ equal to $b_m$'s P-Chain height, $p_m$. If instead $b_m$ does not seal $E_N$, then $b_{m+1}$ will continue to use $P_{N}$. Both candidates for $b_{m+1}$'s P-Chain height ($p_m$ and $P_N$) are known at $b_m$ build time.
## Use Cases
### ICM Verification Optimization
For a validator to verify an ICM message, the signing L1/Subnet's validator set must be retrieved during block verification by traversing backward from the current P-Chain height to the P-Chain height provided by the ProposerVM. The traversal depth is highly variable, so to account for the worst case, VM implementations charge a large amount of gas to perform this verification.
With epochs, validator set retrieval occurs at fixed P-Chain heights that increment at regular intervals, which provides opportunities to optimize this retrieval. For instance, validator retrieval may be done asynchronously from block verification as soon as an epoch has been sealed. Further, validator sets at a given height can be more effectively cached or otherwise kept in memory, because the same height will be used verify all ICM messages for the remainder of an epoch. Each of these VM optimizations allow for the potential of ICM verification costs to be safely reduced by a significant amount within VM implementations.
### Improved Relayer Reliability
Current ICM VM implementations verify ICM messages against the local P-Chain state, as determined by the P-Chain height set by the ProposerVM. Off-chain relayers perform the following steps to deliver ICM messages:
1. Fetch the sending chain's validator set at the verifying chain's current proposed height
1. Collect BLS signatures from that validator set to construct the signed ICM message
1. Submit the transaction containing the signed message to the verifying chain
If the validator set changes between steps 1 and 3, the ICM message will fail verification.
Epochs improve upon this by fixing the P-Chain height used to verify ICM messages for a duration of time that is predictable to off-chain relayers. A relayer should be able to derive the epoch boundaries based on the specification above, or they could retrieve that information via a node API. Relayers could use that information to decide the validator set to query, knowing that it will be stable for the duration of the epoch. Further, VMs could relax the verification rules to allow ICM messages to be verified against the previous epoch as a fallback, eliminating edge cases around the epoch boundary.
## EVM ICM Verification Gas Cost Updates
Since the activation of [ACP-30](https://github.com/avalanche-foundation/ACPs/tree/60cbfc32e7ee2cffed33d8daee980d7a85dded48/ACPs/30-avalanche-warp-x-evm#gas-costs), the cost to verify ICM messages in the Avalanche EVM implementations (i.e. `coreth` and `subnet-evm`) using the `WarpPrecompile` have been based on the worst-case verification flow, including the relatively expensive lookup of the source chain's validator set at an aribtrary P-Chain height used by each new block. This ACP allows for optimizing this verification, as described above.
Prior to this ACP, the gas costs of relevant `WarpPrecompile` functions were:
```
const (
GetVerifiedWarpMessageBaseCost = 2
GetBlockchainIDGasCost = 2
GasCostPerWarpSigner = 500
GasCostPerWarpMessageChunk = 3_200
GasCostPerSignatureVerification = 200_000
)
```
With optimizations implemented, based on the results of [new benchmarks](https://github.com/ava-labs/coreth/pull/1331) of the `WarpPrecompile` and roughly targeting processing 150 million gas per second, Avalanche EVM chains with this ACP activated use the following gas costs for the `WarpPrecompile`.
```
const (
GetVerifiedWarpMessageBaseCost = 750
GetBlockchainIDGasCost = 200
GasCostPerWarpSigner = 250
GasCostPerWarpMessageChunk = 512
GasCostPerSignatureVerification = 125_000
)
```
While the performance of `GetVerifiedWarpMessageBaseCost`, `GetBlockchainIDGasCost`, and `GasCostPerWarpMessageChunk` are not directly impacted by this ACP, updated benchmark numbers show the new gas costs to be better aligned with relative time that the operations take to perform.
## Backwards Compatibility
This change requires a network upgrade and is therefore not backwards compatible.
Any downstream entities that depend on a VM's view of the P-Chain will also need to account for epoched P-Chain views. For instance, ICM messages are signed by an L1's validator set at a specific P-Chain height. Currently, the constructor of the signed message can in practice use the validator set at the P-Chain tip, since all deployed Avalanche VMs are at most behind the P-Chain by a fixed number of blocks. With epoching, however, the ICM message constructor must take into account the epoch P-Chain height of the verifying chain, which may be arbitrarily far behind the P-Chain tip.
## Reference Implementation
The following pseudocode illustrates how an epoch may be calculated for a block:
```go
// Epoch Duration
const D time.Duration
type Epoch struct {
PChainHeight uint64
Number uint64
StartTime time.Time
}
type Block interface {
Timestamp() time.Time
PChainHeight() uint64
Epoch() Epoch
}
func GetPChainEpoch(parent Block) Epoch {
parentTimestamp := parent.Timestamp()
parentEpoch := parent.Epoch()
epochEndTime := parentEpoch.StartTime.Add(D)
if parentTimestamp.Before(epochEndTime) {
// If the parent was issued before the end of its epoch, then it did not
// seal the epoch.
return parentEpoch
}
// The parent sealed the epoch, so the child is the first block of the new
// epoch.
return Epoch{
PChainHeight: parent.PChainHeight(),
Number: parentEpoch.Number + 1,
StartTime: parentTimestamp,
}
}
```
- If the parent sealed its epoch, the current block [advances the epoch](#advancing-an-epoch), refreshing the epoch height, incrementing the epoch number, and setting the epoch starting time.
- Otherwise, the current block uses the current epoch height, number, and starting time, regardless of whether it seals the epoch.
A full reference implementation of this ACP for avalanchego can be found [here](https://github.com/ava-labs/avalanchego/pull/4238).
### Setting the Epoch Duration
The epoch duration $D$ is set on a network-wide level. For both Fuji (network ID 5) and Mainnet (network ID 1), $D$ will be set to 5 minutes upon activation of this ACP. Any changes to $D$ in the future would require another network upgrade.
#### Changing the Epoch Duration
Future network upgrades may change the value of $D$ to some new duration $D'$. $D'$ should not take effect until the end of the current epoch, rather than the activation time of the network upgrade that defines $D'$. This ensures an in progress epoch at the upgrade activation time cannot have a realized duration less than both $D$ and $D'$.
## Security Considerations
### Epoch P-Chain Height Skew
Because epochs may have [unbounded duration](#epoch-duration-bounds), it is possible for a block's `PChainEpochHeight` to be arbitrarily far behind the tip of the P-Chain. This does not affect the *validity* of ICM verification within a VM that implements P-Chain epoched views, since the validator set at `PChainEpochHeight` is always known. However, the following considerations should be made under this scenario:
1. As validators exit the validator set, their physical nodes may be unavailable to serve BLS signature requests, making it more difficult to construct a valid ICM message
1. A valid ICM message may represent an attestation by a stale validator set. Signatures from validators that have exited the validator set between `PChainEpochHeight` and the current P-Chain tip will not represent active stake.
Both of these scenarios may be mitigated by having shorter epoch lengths, which limit the delay in time between when the P-Chain is updated and when those updates are taken into account for ICM verification on a given L1, and by ensuring consistent block production, so that epochs always advance soon after $D$ time has passed.
### Excessive Validator Churn
If an epoched view of the P-Chain is used by the consensus engine, then validator set changes over an epoch's duration will be concentrated into a single block at the epoch's boundary. Excessive validator churn can cause consensus failures and other dangerous behavior, so it is imperative that the amount of validator weight change at the epoch boundary is limited. One strategy to accomplish this is to queue validator set changes and spread them out over multiple epochs. Another strategy is to batch updates to the same validator together such that increases and decreases to that validator's weight cancel each other out. Given the primary use case of ICM verification improvements, which occur at the VM level, mechanisms to mitigate against this are omitted from this ACP.
## Open Questions
- What should the epoch duration $D$ be set to?
- Is it safe for `PChainEpochHeight` and `PChainHeight` to differ significantly within a block, due to [unbounded epoch duration](#epoch-duration-bounds)?
## Acknowledgements
Thanks to [@iansuvak](https://github.com/iansuvak), [@geoff-vball](https://github.com/geoff-vball), [@yacovm](https://github.com/yacovm), [@michaelkaplan13](https://github.com/michaelkaplan13), [@StephenButtolph](https://github.com/StephenButtolph), and [@aaronbuchwald](https://github.com/aaronbuchwald) for discussion and feedback on this ACP.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-191: Seamless L1 Creation (/docs/acps/191-seamless-l1-creation)
---
title: "ACP-191: Seamless L1 Creation"
description: "Details for Avalanche Community Proposal 191: Seamless L1 Creation"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/191-seamless-l1-creation/README.md
---
| ACP | 191 |
| :- | :- |
| **Title** | Seamless L1 Creations (CreateL1Tx) |
| **Author(s)** | Martin Eckardt ([@martineckardt](https://github.com/martineckardt)), Aaron Buchwald ([@aaronbuchwald](https://github.com/aaronbuchwald)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)), Meaghan FitzGerald ([@meaghanfitzgerald](https://github.com/meaghanfitzgerald)) |
| **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/197))|
| **Track** | Standards |
## Abstract
This ACP introduces a new P-Chain transaction type called `CreateL1Tx` that simplifies the creation of Avalanche L1s. It consolidates three existing transaction types (`CreateSubnetTx`, `CreateChainTx`, and `ConvertSubnetToL1Tx`) into a single atomic operation. This streamlines the L1 creation process, removes the need for the intermediary Subnet creation step, and eliminates the management of temporary `SubnetAuth` credentials.
## Motivation
[ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md) introduced Avalanche L1s, providing greater sovereignty and flexibility compared to Subnets. However, creating an L1 currently requires a three-step process:
1. `CreateSubnetTx`: Create the Subnet record on the P-Chain and specify the `SubnetAuth`
2. `CreateChainTx`: Add a blockchain to the Subnet (can be called multiple times)
3. `ConvertSubnetToL1Tx`: Convert the Subnet to an L1, specifying the initial validator set and the validator manager location
This process has several drawbacks:
* It requires orchestrating three separate transactions that could be handled in one.
* The `SubnetAuth` must be managed during creation but becomes irrelevant after conversion.
* The multi-step process increases complexity and potential for errors.
* It introduces unnecessary state transitions and storage overhead on the P-Chain.
By introducing a single `CreateL1Tx` transaction, we can simplify the process, reduce overhead, and improve the developer experience for creating L1s.
## Specification
### New Transaction Type
The following new transaction type is introduced:
```go
// ChainConfig represents the configuration for a chain to be created
type ChainConfig struct {
// A human readable name for the chain; need not be unique
ChainName string `serialize:"true" json:"chainName"`
// ID of the VM running on the chain
VMID ids.ID `serialize:"true" json:"vmID"`
// IDs of the feature extensions running on the chain
FxIDs []ids.ID `serialize:"true" json:"fxIDs"`
// Byte representation of genesis state of the chain
GenesisData []byte `serialize:"true" json:"genesisData"`
}
// CreateL1Tx is an unsigned transaction to create a new L1 with one or more chains
type CreateL1Tx struct {
// Metadata, inputs and outputs
BaseTx `serialize:"true"`
// Chain configurations for the L1 (can be multiple)
Chains []ChainConfig `serialize:"true" json:"chains"`
// Chain where the L1 validator manager lives
ManagerChainID ids.ID `serialize:"true" json:"managerChainID"`
// Address of the L1 validator manager
ManagerAddress types.JSONByteSlice `serialize:"true" json:"managerAddress"`
// Initial pay-as-you-go validators for the L1
Validators []*L1Validator `serialize:"true" json:"validators"`
}
```
The `L1Validator` structure follows the same definition as in [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md#convertsubnettol1tx).
### Transaction Processing
When a `CreateL1Tx` transaction is processed, the P-Chain performs the following operations atomically:
1. Create a new L1.
2. Create chain records for each chain configuration in the `Chains` array.
3. Set up the L1 validator manager with the specified `ManagerChainID` and `ManagerAddress`.
4. Register the initial validators specified in the `Validators` array.
### IDs
* `subnetID`: The `subnetID` of the L1 is the transaction hash.
* `blockchainID`: the `blockchainID` for each blockchain is is defined as the SHA256 hash of the 37 bytes resulting from concatenating the 32 byte `subnetID` with the `0x00` byte and the 4 byte `chainIndex` (index in the `Chains` array within the transaction)
* `validationID`: The `validationID` for the initial validators added through `CreateL1Tx` is defined as the SHA256 hash of the 36 bytes resulting from concatenating the 32 byte `subnetID` with the 4 byte `validatorIndex` (index in the `Validators` array within the transaction).
Note: Even with this updated definition of the `blockchainID`s for chains created using this new flow, the `validationID`s of the L1s initial set of validators is still compatible with the existing reference validator manager contracts as defined [here](https://github.com/ava-labs/icm-contracts/blob/4a897ba913958def3f09504338a1b9cd48fe5b2d/contracts/validator-manager/ValidatorManager.sol#L247).
### Restrictions and Validation
The `CreateL1Tx` transaction has the following restrictions and validation criteria:
1. The `Chains` array must contain at least one chain configuration
2. The `ManagerChainID` must be a valid blockchain ID, but cannot be the P-Chain blockchain ID
3. Validator nodes must have unique NodeIDs within the transaction
4. Each validator must have a non-zero weight and a non-zero balance
5. The transaction inputs must provide sufficient AVAX to cover the transaction fee and all validator balances
### Warp Message
After the transaction is accepted, the P-Chain must be willing to sign a `SubnetToL1ConversionMessage` with a `conversionID` corresponding to the new L1, similar to what would happen after a `ConvertSubnetToL1Tx`. This ensures compatibility with existing systems that expect this message, such as the validator manager contracts.
## Backwards Compatibility
This ACP introduces a new transaction type and does not modify the behavior of existing transaction types. Existing Subnets and L1s created through the three-step process will continue to function as before. This change is purely additive and does not require any changes to existing L1s or Subnets.
The existing transactions `CreateSubnetTx`, `CreateChainTx` and `ConvertSubnetToL1Tx` remain unchanged for now, but may be removed in a future ACP to ensure systems have sufficient time to update to the new process.
## Reference Implementation
A reference implementation must be provided in order for this ACP to be considered implementable.
## Security Considerations
The `CreateL1Tx` transaction follows the same security model as the existing three-step process. By making the L1 creation atomic, it reduces the risk of partial state transitions that could occur if one of the transactions in the three-step process fails.
The same continuous fee mechanism introduced in ACP-77 applies to L1s created through this new transaction type, ensuring proper metering of validator resources.
The transaction verification process must ensure that all validator properties are properly validated, including unique NodeIDs, valid BLS signatures, and sufficient balances.
## Rationale and Alternatives
The primary alternative is to maintain the status quo \- requiring three separate transactions to create an L1. However, this approach has clear disadvantages in terms of complexity, transaction overhead, and user experience.
Another alternative would be to modify the existing `ConvertSubnetToL1Tx` to allow specifying chain configurations directly. However, this would complicate the conversion process for existing Subnets and would not fully address the desire to eliminate the Subnet intermediary step for new L1 creation.
The chosen approach of introducing a new transaction type provides a clean solution that addresses all identified issues while maintaining backward compatibility.
## Acknowledgements
The idea for this PR was originally formulated by Aaron Buchwald in our discussion about the creation of L1s. Special thanks to the authors of ACP-77 for their groundbreaking work on Avalanche L1s, and to the projects that have shared their experiences and challenges with the current validator manager framework.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-194: Streaming Asynchronous Execution (/docs/acps/194-streaming-asynchronous-execution)
---
title: "ACP-194: Streaming Asynchronous Execution"
description: "Details for Avalanche Community Proposal 194: Streaming Asynchronous Execution"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/194-streaming-asynchronous-execution/README.md
---
| ACP | 194 |
| :--- | :--- |
| **Title** | Streaming Asynchronous Execution |
| **Author(s)** | Arran Schlosberg ([@ARR4N](https://github.com/ARR4N)), Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)) |
| **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/196)) |
| **Track** | Standards |
## Abstract
Streaming Asynchronous Execution (SAE) decouples consensus and execution by introducing a queue upon which consensus is performed.
A concurrent execution stream is responsible for clearing the queue and reporting a delayed state root for recording by later rounds of consensus.
Validation of transactions to be pushed to the queue is lightweight but guarantees eventual execution.
## Motivation
### Performance improvements
1. Concurrent consensus and execution streams eliminate node context switching, reducing latency caused by each waiting on the other.
In particular, "VM time" (akin to CPU time) more closely aligns with wall time since it is no longer eroded by consensus.
This increases gas per wall-second even without an increase in gas per VM-second.
2. Lean, execution-only clients can rapidly execute the queue agreed upon by consensus, providing accelerated receipt issuance and state computation.
Without the need to compute state _roots_, such clients can eschew expensive Merkle data structures.
End users see expedited but identical transaction results.
3. Irregular stop-the-world events like database compaction are amortised over multiple blocks.
4. Introduces additional bursty throughput by eagerly accepting transactions, without a reduction in security guarantees.
5. Third-party accounting of non-data-dependent transactions, such as EOA-to-EOA transfers of value, can be performed prior to execution.
### Future features
Performing transaction execution after consensus sequencing allows the usage of consensus artifacts in execution. This unblocks some additional future improvements:
1. Exposing a real-time VRF during transaction execution.
2. Using an encrypted mempool to reduce front-running.
This ACP does not introduce these, but some form of asynchronous execution is required to correctly implement them.
### User stories
1. A sophisticated DeFi trader runs a highly optimised execution client, locally clearing the transaction queue well in advance of the network—setting the stage for HFT DeFi.
2. A custodial platform filters the queue for only those transactions sent to one of their EOAs, immediately crediting user balances.
## Description
In all execution models, a block is _proposed_ and then verified by validators before being _accepted_. To assess a block's validity in _synchronous_ execution, its transactions are first _executed_ and only then _accepted_ by consensus. This immediately and implicitly _settles_ all of the block's transactions by including their execution results at the time of _acceptance_.
E[Executed] --> A[Accepted/Settled]`} />
Under SAE, a block is considered valid if all of its transactions can be paid for when eventually _executed_, after which the block is _accepted_ by consensus. The act of _acceptance_ enqueues the block to be _executed_ asynchronously. In the future, some as-yet-unknown later block will reference the execution results and _settle_ all transactions from the _executed_ block.
A[Accepted]
A -->|variable delay| E[Executed]
E -->|τ seconds| S[Settled]
A -. guarantees .-> S`} />
### Block lifecycle
#### Proposing blocks
The validator selection mechanism for block production is unchanged. However, block builders are no longer expected to execute transactions during block building.
The block builder is expected to include transactions by building upon the most recently settled state and to apply worst-case bounds on the execution of the ancestor blocks prior to the most recently settled block.
The worst-case bounds enforce minimum balances of sender accounts and the maximum required base fee. The worst-case bounds are described [below](#block-validity-and-building).
Prior to adding a proposed block to consensus, all validators MUST verify that the block builder correctly enforced the worst-case bounds while building the block. This guarantees that the block can be executed successfully if it is accepted.
> [!NOTE]
> The worst-case bounds guarantee does not provide assurance about whether or not a transaction will revert nor whether its computation will run out of gas by reaching the specified limit. The verification only ensures the transaction is capable of paying for the accrued fees.
#### Accepting blocks
Once a block is marked as accepted by consensus, the block is put in a FIFO execution queue.
#### Executing blocks
Each client runs a block executor in parallel, which constantly executes the blocks from the FIFO queue.
In addition to executing the blocks, the executor provides deterministic timestamps for the beginning and end of each block's execution.
Time is measured two ways by the block executor:
1. The timestamp included in the block header.
2. The amount of gas charged during the execution of blocks.
> [!NOTE]
> Execution timestamps are more granular than block header timestamps to allow sub-second block execution times.
As soon as there is a block available in the execution queue, the block executor starts processing the block.
If the executor's current timestamp is prior to the current block's timestamp, the executor's timestamp is advanced to match the block's.
Advancing the timestamp in this scenario results in unused gas capacity, reducing the gas _excess_ from which the price is determined.
The block is then executed on top of the last executed (not settled) state.
After executing the block, the executor advances its timestamp based on the gas usage of the block, also increasing the gas _excess_ for the pricing algorithm.
The block's execution time is now timestamped and the block is available to be settled.
#### Settling blocks
Already-executed blocks are settled once a following block that includes the results of the executed block is accepted.
The results are included by setting the state root to that of the last executed block and the receipt root to that of a MPT of all receipts since last settlement, possibly from more than one block.
The following block's timestamp is used to determine which blocks to settle—blocks are settled if said timestamp is greater than or equal to the execution time of the executed block plus a constant delay.
The additional delay amortises any sporadic slowdowns the block executor may have encountered.
## Specification
### Background
ACP-103 introduced the following variables for calculating the gas price:
| | |
|---|---|
| $T$ | the target gas consumed per second |
| $M$ | minimum gas price |
| $K$ | gas price update constant |
| $R$ | gas capacity added per second |
ACP-176 provided a mechanism to make $T$ dynamic and set:
$$
\begin{align}
R &= 2 \cdot T \\
K &= 87 \cdot T
\end{align}
$$
The _excess_ actual consumption $x \ge 0$ beyond the target $T$ is tracked via numerical integration and used to calculate the gas price as:
$$M \cdot \exp\left(\frac{x}{K}\right)$$
### Gas charged
We introduce $g_L$, $g_U$, and $g_C$ as the gas _limit_, _used_, and _charged_ per transaction, respectively. We define
$$
g_C := \max\left(g_U, \frac{g_L}{\lambda}\right)
$$
where $\lambda$ enforces a lower bound on the gas charged based on the gas limit.
> [!NOTE]
> $\dfrac{g_L}{\lambda}$ is rounded up by actually calculating $\dfrac{g_L + \lambda - 1}{\lambda}$
In all previous instances where execution referenced gas used, from now on, we will reference gas charged. For example, the gas excess $x$ will be modified by $g_C$ rather than $g_U$.
### Block size
The constant time delay between block execution and settlement is defined as $\tau$ seconds.
The maximum allowed size of a block is defined as:
$$
\omega_B ~:= R \cdot \tau \cdot \lambda
$$
Any block whose total sum of gas limits for transactions exceed $\omega_B$ MUST be considered invalid.
### Queue size
The maximum allowed size of the execution queue _prior_ to adding a new block is defined as:
$$
\omega_Q ~:= 2 \cdot \omega_B
$$
Any block that attempts to be enqueued while the current size of the queue is larger than $\omega_Q$ MUST be considered invalid.
> [!NOTE]
> By restricting the size of the queue _prior_ to enqueueing the new block, $\omega_B$ is guaranteed to be the only limitation on block size.
### Block executor
During the activation of SAE, the block executor's timestamp $t_e$ is initialised to the timestamp of the last accepted block.
Prior to executing a block with timestamp $t_b$, the executor's timestamp and excess is updated:
$$
\begin{align}
\Delta{t} &~:= \max\left(0, t_b - t_e\right) \\
t_e &~:= t_e + \Delta{t} \\
x &~:= \max\left(x - T \cdot \Delta{t}, 0\right) \\
\end{align}
$$
The block is then executed with the gas price calculated from the current value of $x$.
After executing a block that charged $g_C$ gas in total, the executor's timestamp and excess is updated:
$$
\begin{align}
\Delta{t} &~:= \frac{g_C}{R} \\
t_e &~:= t_e + \Delta{t} \\
x &~:= x + \Delta{t} \cdot (R - T) \\
\end{align}
$$
> [!NOTE]
> The update rule here assumes that $t_e$ is a timestamp that tracks the passage of time both by gas and by wall-clock time. $\frac{g_C}{R}$ MUST NOT be simply rounded. Rather, the gas accumulation MUST be left as a fraction.
$t_e$ is now this block's execution timestamp.
### Handling gas target changes
When a block is produced that modifies $T$, both the consensus thread and the execution thread will update to the modified $T$ after their own handling of the block.
For example, restrictions of the queue size MUST be calculated based on the parent block's $T$.
Similarly, the time spent executing a block MUST be calculated based on the parent block's $T$.
### Block settlement
For a _proposed_ block that includes timestamp $t_b$, all ancestors whose execution timestamp $t_e$ is $t_e \leq t_b - \tau$ are considered settled.
Note that $t_e$ is not an integer as it tracks fractional seconds with gas consumption, which is not the case for $t_b$.
The _proposed_ block MUST include the `stateRoot` produced by the execution of the most recently settled block.
For any _newly_ settled blocks, the _proposed_ block MUST include all execution artifacts:
- `receiptsRoot`
- `logsBloom`
- `gasUsed`
The receipts root MUST be computed as defined in [EIP-2718](https://eips.ethereum.org/EIPS/eip-2718) except that the tree MUST be built from the concatenation of receipts from all blocks being settled.
> [!NOTE]
> If the block executor has fallen behind, the node may not be able to determine precisely which ancestors should be considered settled. If this occurs, validators MUST allow the block executor to catch up prior to deciding the block's validity.
### Block validity and building
After determining which blocks to settle, all remaining ancestors of the new block must be inspected to determine the worst-case bounds on $x$ and account balances. Account nonces are able to be known immediately.
The worst-case bound on $x$ can be calculated by following the block executor update rules using $g_L$ rather than $g_C$.
The worst-case bound on account balances can be calculated by charging the worst-case gas cost to the sender of a transaction along with deducting the value of the transaction from the sender's account balance.
The `baseFeePerGas` field MUST be populated with the gas price based on the worst-case bound on $x$ at the start of block execution.
### Configuration Parameters
As noted above, SAE depends on the values of $\tau$ and $\lambda$ to be set as parameters and the values of $\omega_B$ and $\omega_Q$ are derived from $T$.
Parameters to specify for the C-Chain are:
| Parameter | Description | C-Chain Configuration|
| - | - | - |
| $\tau$ | duration between execution and settlement | $5s$ |
| $\lambda$ | minimum conversion from gas limit to gas charged | $2$ |
## Backwards Compatibility
This ACP modifies the meaning of multiple fields in the block. A comprehensive list of changes will be produced once a reference implementation is available.
Likely fields to change include:
- `stateRoot`
- `receiptsRoot`
- `logsBloom`
- `gasUsed`
- `extraData`
## Reference Implementation
A reference implementation is still a work-in-progress. This ACP will be updated to include a reference implementation once one is available.
## Security Considerations
### Worst-case transaction validity
To avoid a DoS vulnerability on execution, we require an upper bound on transaction gas cost (i.e. amount $\times$ price) beyond the regular requirements for transaction validity (e.g. nonce, signature, etc.). We therefore introduced "worst-case cost" validity.
We can prove that if every transaction were to use its full gas limit this would result in the greatest possible:
1. Consumption of gas units (by definition of the gas limit); and
2. Gas excess $x$ (and therefore gas price) at the time of execution.
For a queue of blocks $Q = \\{i\\}_ {i \ge 0}$ the gas excess $x_j$ immediately prior to execution of block $j \in Q$ is a monotonic, non-decreasing function of the gas usage of all preceding blocks in the queue; i.e. $x_j~:=~f(\\{g_i\\}_{i 0$.
Hence any decrease of $x$ is $\ge$ predicted.
The excess, and hence gas price, for every later block $x_{i>k}$ is therefore reduced:
$$
\downarrow g_k \implies
\begin{cases}
\downarrow \Delta^+x \propto g_k \\
\uparrow \Delta^-x \propto R-g_k
\end{cases}
\implies \downarrow \Delta x_k
\implies \downarrow M \cdot \exp\left(\frac{x_{i>k}}{K}\right)
$$
Given maximal gas consumption under (1), the monotonicity of $f$ implies (2).
Since we are working with non-negative integers, it follows that multiplying a transaction's gas limit by the hypothetical gas price of (2) results in its worst-case gas cost.
Any sender able to pay for this upper bound (in addition to value transfers) is guaranteed to be able to pay for the actual execution cost.
Transaction _acceptance_ under worst-case cost validity is therefore a guarantee of _settlement_.
### Queue DoS protection
Worst-case cost validity only protects against DoS at the point of execution but leaves the queue vulnerable to high-limit, low-usage transactions.
For example, a malicious user could send a transfer-only transaction (21k gas) with a limit set to consume the block's full gas limit.
Although they would have to have sufficient funds to theoretically pay for all the reserved gas, they would never actually be charged this amount. Pushing a sufficient number of such transactions to the queue would artificially inflate the worst-case cost of other users.
Therefore, the gas charged was modified from being equal to the gas usage to the above $g_C := \max\left(g_U, \frac{g_L}{\lambda}\right)$
The gas limit is typically set higher than the predicted gas consumption to allow for a buffer should the prediction be imprecise.
This precludes setting $\lambda := 1$.
Conversely, setting $\lambda := \infty$ would allow users to attack the queue with high-limit, low-consumption transactions.
Setting $\lambda ~:= 2$ allows for a 100% buffer on gas-usage estimates without penalising the sender, while still disincentivising falsely high limits.
#### Upper bound on queue DoS
Recall $R$ (gas capacity per second) for rate and $g_C$ (gas charged) as already defined.
The actual gas excess $x_A$ has an upper bound of the worst-case excess $x_W$, both of which can be used to calculate respective base fees $f_A$ and $f_W$ (the variable element of gas prices) from the existing exponential function:
$$
f := M \cdot \exp\left( \frac{x}{K} \right).
$$
Mallory is attempting to maximize the DoS ratio
$$
D := \frac{f_W}{f_A}
$$
by maximizing $\Sigma_{\forall i} (g_L - g_U)_i$ to maximize $x_W - x_A$.
> [!TIP]
> Although $D$ shadows a variable in ACP-176, that one is very different to anything here so there won't be confusion.
Recall that the increasing excess occurs such that
$$
x := x + g \cdot \frac{(R - T)}{R}
$$
Since the largest allowed size of the queue when enqueuing a new block is $\omega_Q$, we can derive an upper bound on the difference in the changes to worst-case and actual gas excess caused by the transactions in the queue before the new block is added:
$$
\begin{align}
\Delta x_A &\ge \frac{\omega_Q}{\lambda} \cdot \frac{(R - T)}{R} \\
\Delta x_W &= \omega_Q \cdot \frac{(R - T)}{R} \\
\Delta x_W - \Delta x_A &\le \omega_Q \cdot \frac{(R - T)}{R} - \frac{\omega_Q}{\lambda} \cdot \frac{(R - T)}{R} \\
&= \omega_Q \cdot \frac{(R - T)}{R} \cdot \left(1-\frac{1}{\lambda}\right) \\
&= \omega_Q \cdot \frac{(2 \cdot T - T)}{2 \cdot T} \cdot \left(1-\frac{1}{\lambda}\right) \\
&= \omega_Q \cdot \frac{T}{2 \cdot T} \cdot \left(1-\frac{1}{\lambda}\right) \\
&= \frac{\omega_Q}{2} \cdot \left(1-\frac{1}{\lambda}\right) \\
&= \frac{2 \cdot \omega_B}{2} \cdot \left(1-\frac{1}{\lambda}\right) \\
&= \omega_B \cdot \left(1-\frac{1}{\lambda}\right) \\
&= R \cdot \tau \cdot \lambda \cdot \left(1-\frac{1}{\lambda}\right) \\
&= R \cdot \tau \cdot (\lambda-1) \\
&= 2 \cdot T \cdot \tau \cdot (\lambda-1)
\end{align}
$$
Note that we can express Mallory's DoS quotient as:
$$
\begin{align}
D &= \frac{f_W}{f_A} \\
&= \frac{ M \cdot \exp \left( \frac{x_W}{K} \right)}{ M \cdot \exp \left( \frac{x_A}{K} \right)} \\
& = \exp \left( \frac{x_W - x_A}{K} \right).
\end{align}
$$
When the queue is empty (i.e. the execution stream has caught up with accepted transactions), the worst-case fee estimate $f_W$ is known to be the actual base fee $f_A$; i.e. $Q = \emptyset \implies D=1$. The previous bound on $\Delta x_W - \Delta x_A$ also bounds Mallory's ability such that:
$$
\begin{align}
D &\le \exp \left( \frac{2 \cdot T \cdot \tau \cdot (\lambda-1)}{K} \right)\\
&= \exp \left( \frac{2 \cdot T \cdot \tau \cdot (\lambda-1)}{87 \cdot T} \right)\\
&= \exp \left( \frac{2 \cdot \tau \cdot (\lambda-1)}{87} \right)\\
\end{align}
$$
Therefore, for the values suggested by this ACP:
$$
\begin{align}
D &\le \exp \left( \frac{2 \cdot 5 \cdot (2 - 1)}{87} \right)\\
&= \exp \left( \frac{10}{87} \right)\\
&\simeq 1.12\\
\end{align}
$$
In summary, Mallory can require users to increase their gas price by at most ~12%. In practice, the gas price often fluctuates more than 12% on a regular basis. Therefore, this does not appear to be a significant attack vector.
However, any deviation that dislodges the gas price bidding mechanism from a true bidding mechanism is of note.
## Appendix
### JSON RPC methods
Although asynchronous execution decouples the transactions and receipts recorded by a specific block, APIs MUST NOT alter their behavior to mirror this.
In particular, the API method `eth_getBlockReceipts` MUST return the receipts corresponding to the block's transactions, not the receipts settled in the block.
#### Named blocks
The Ethereum Mainnet APIs allow for retrieving blocks by named parameters that the API server resolves based on their consensus mechanism.
Other than the _earliest_ (genesis) named block, which MUST be interpreted in the same manner, all other named blocks are mapped to SAE in terms of the _execution_ status of blocks and MUST be interpreted as follows:
* _pending_: the most recently _accepted_ block;
* _latest_: the block that was most recently _executed_;
* _safe_ and _finalized_: the block that was most recently _settled_.
> [!NOTE]
> The finality guarantees of Snowman consensus remove any distinction between _safe_ and _finalized_.
> Furthermore, the _latest_ block is not at risk of re-org, only of a negligible risk of data corruption local to the API node.
### Observations around transaction prioritisation
As EOA-to-EOA transfers of value are entirely guaranteed upon _acceptance_, block builders MAY choose to prioritise other transactions for earlier execution.
A reliable marker of such transactions is a gas limit of 21,000 as this is an indication from the sender that they do not intend to execute bytecode.
However, this could delay the ability to issue transactions that depend on these EOA-to-EOA transfers.
Block builders are free to make their own decisions around which transactions to include.
## Acknowledgments
Thank you to the following non-exhaustive list of individuals for input, discussion, and feedback on this ACP.
* [Aaron Buchwald](https://github.com/aaronbuchwald)
* [Angharad Thomas](https://x.com/divergenceharri)
* [Martin Eckardt](https://github.com/martineckardt)
* [Meaghan FitzGerald](https://github.com/meaghanfitzgerald)
* [Michael Kaplan](https://github.com/michaelkaplan13)
* [Yacov Manevich](https://github.com/yacovm)
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-20: Ed25519 P2p (/docs/acps/20-ed25519-p2p)
---
title: "ACP-20: Ed25519 P2p"
description: "Details for Avalanche Community Proposal 20: Ed25519 P2p"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/20-ed25519-p2p/README.md
---
| ACP | 20 |
| :--- | :--- |
| **Title** | Ed25519 p2p |
| **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) |
| **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/21))|
| **Track** | Standards |
## Abstract
Support Ed25519 TLS certificates for p2p communications on the Avalanche network. Permit usage of Ed25519 public keys for Avalanche Network Client (ANC) NodeIDs. Support Ed25519 signatures in the ProposerVM.
## Motivation
Avalanche Network Clients (ANCs) rely on TLS handshakes to facilitate p2p communications. AvalancheGo (and by extension, the Avalanche Network) only supports TLS certificates that use RSA or ECDSA as the signing algorithm and explicitly prohibits any other signing algorithms.
If a TLS certificate is not present, AvalancheGo will generate and persist to disk a 4096 bit RSA private key on start-up. This key is subsequently used to generate the TLS certificate which is also persisted to disk. Finally, the TLS certificate is hashed to generate a 20 byte NodeID. Authenticated p2p messaging was required when the network started and it was sufficient to simply use a hash of the TLS certificate. With the introduction of Snowman++, validators were then required to produce shareable message signatures. The Snowman++ block headers (specified [here](https://github.com/ava-labs/avalanchego/blob/v1.10.15/vms/proposervm/README.md#snowman-block-extension)) were then required to include the full TLS `Certificate` along with the `Signature`.
However, TLS certificates support Ed25519 as their signing algorithm. Ed25519 are IETF recommendations ([RFC8032](https://datatracker.ietf.org/doc/html/rfc8032)) with some very nice properties, a large one being their size:
- 32 byte public key
- 64 byte private key
- 64 byte signature
Because of the small size of the public key, it can be used for the NodeID directly with a marginal hit to size (an additional 12 bytes). Additionally, the brittle reliance on static TLS certificates can be removed. Using the Ed25519 private key, a TLS certificate can be generated in-memory on node startup and used for p2p communications. This reduces the maintenance burden on node operators as they will only need to backup the Ed25519 private key instead of the TLS certificate and the RSA private key.
Ed25519 has wide adoption, including in the crypto industry. A non-exhaustive list of things that use Ed25519 can be found [here](https://ianix.com/pub/ed25519-deployment.html). More information about the Ed25519 protocol itself can be found [here](https://ed25519.cr.yp.to).
## Specification
### Required Changes
1. Support registration of 32-byte NodeIDs on the P-chain
2. Generate an Ed25519 key by default (`staker.key`) on node startup
3. Use the Ed25519 key to generate a TLS certificate on node startup
4. Add support for Ed25519 keys + signatures to the proposervm
5. Remove the TLS certificate embedding in proposervm blocks when an Ed25519 NodeID is the proposer
6. Add support for Ed25519 in `PeerList` messages
Changes to the p2p layer will be minimal as TLS handshakes are used to do p2p communication. Ed25519 will need to be added as a supported algorithm.
The P-chain will also need to be modified to support registration of 32-byte NodeIDs. During serialization, the length of the NodeID is not serialized and was assumed to always be 20 bytes. Implementers of this ACP must take care to continue parsing old transactions correctly.
This ACP could be implemented by adding a new tx type that requires Ed25519 NodeIDs only. If the implementer chooses to do this, a separate follow-up ACP must be submitted detailing the format of that transaction.
### Future Work
In the future, usage of non-Ed25519 TLS certificates should be prohibited to remove any dependency on them. This will further secure the Avalanche network by reducing complexity. The path to doing so is not outlined in this ACP.
## Backwards Compatibility
An implementation of this proposal should not introduce any backwards compatibility issues. NodeIDs that are 20 bytes should continue to be treated as hashes of TLS certificates. NodeIDs of 32 bytes (size of Ed25519 public key) should be supported following implementation of this proposal.
## Reference Implementation
TLS certificate generation using an Ed25519 private key is standard. The golang standard library has a reference [implementation](https://github.com/golang/go/blob/go1.20.10/src/crypto/tls/generate_cert.go).
Parsing TLS certificates and extracting the public key is also standard. AvalancheGo already contains [code](https://github.com/ava-labs/avalanchego/blob/638000c42e5361e656ffbc27024026f6d8f67810/staking/verify.go#L55-L65) to verify the public key from a TLS certificate.
## Security Considerations
### Validation Criteria
Although Ed25519 is standardized in [RFC8032](https://datatracker.ietf.org/doc/html/rfc8032), it does not define strict validation criteria. This has led to inconsistencies in the validation criteria across implementations of the signature scheme. This is unacceptable for any protocol that requires participants to reach consensus on signature validity. Henry de Valance highlights the complexity of this issue [here](https://hdevalence.ca/blog/2020-10-04-its-25519am).
From [Chalkias et al. 2020](https://eprint.iacr.org/2020/1244.pdf):
* The RFC 8032 and the NIST FIPS186-5 draft both require to reject non-canonically encoded points, but not all of the implementations follow those guidelines.
* The RFC 8032 allows optionality between using a permissive verification equation and a more strict verification equation. Different implementations use different equations meaning validation results can vary even across implementations that follow RFC 8032.
Zcash adopted [ZIP-215](https://zips.z.cash/zip-0215) (proposed by Henry de Valance) to explicitly define the Ed25519 validation criteria. Implementers of this ACP _*must*_ use the ZIP-215 validation criteria.
The [`ed25519consensus`](https://github.com/hdevalence/ed25519consensus) golang library is a minimal fork of golang's `crypto/ed25519` package with support for ZIP-215 verification. It is maintained by [Filippo Valsorda](https://github.com/FiloSottile) who also maintains many golang stdlib cryptography packages. It is strongly recommended to use this library for golang implementations.
## Open Questions
_Can this Ed25519 key be used in alternative communication protocols?_
Yes. Ed25519 can be used for alternative communication protocols like [QUIC](https://datatracker.ietf.org/group/quic/about) or [NOISE](http://www.noiseprotocol.org/noise.html). This ACP removes the reliance on TLS certificates and associates a Ed25519 public key with NodeIDs. This allows for experimentation with different communication protocols that may be better suited for a high throughput blockchain like Avalanche.
_Can this Ed25519 key be used for Verifiable Random Functions?_
Yes. VRFs, as specified in [RFC9381](https://datatracker.ietf.org/doc/html/rfc9381), can be constructed using elliptic curves that are secure in the cryptographic random oracle model. Ed25519 test vectors are provided in the RFC for implementers of an Elliptic Curve VRF (ECVRF). This allows for Avalanche validators to generate a VRF per block using their associated Ed25519 keys, including for Subnets.
## Acknowledgements
Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@patrick-ogrady](https://github.com/patrick-ogrady) for their feedback on these ideas.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-204: Precompile Secp256r1 (/docs/acps/204-precompile-secp256r1)
---
title: "ACP-204: Precompile Secp256r1"
description: "Details for Avalanche Community Proposal 204: Precompile Secp256r1"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/204-precompile-secp256r1/README.md
---
# ACP-204: Precompile for secp256r1 Curve Support
| ACP | 204 |
| :--- | :--- |
| **Title** | Precompile for secp256r1 Curve Support |
| **Author(s)** | [Santiago Cammi](https://github.com/scammi), [Arran Schlosberg](https://github.com/ARR4N) |
| **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/212)) |
| **Track** | Standards |
## Abstract
This proposal introduces a precompiled contract that performs signature verifications for the secp256r1 elliptic curve on Avalanche's C-Chain. The precompile will be implemented at address `0x0000000000000000000000000000000000000100` and will enable native verification of P-256 signatures, significantly improving gas efficiency for biometric authentication systems, WebAuthn, and modern device-based signing mechanisms.
## Motivation
The secp256r1 (P-256) elliptic curve is the standard cryptographic curve used by modern device security systems, including Apple's Secure Enclave, Android Keystore, WebAuthn, and Passkeys. However, Avalanche currently only supports secp256k1 natively, forcing developers to use expensive Solidity-based verification that costs [200k-330k gas per signature verification](https://hackmd.io/@1ofB8klpQky-YoR5pmPXFQ/SJ0nuzD1T#Smart-Contract-Based-Verifiers).
This ACP proposes implementing EIP-7951's secp256r1 precompiled contract to unlock significant ecosystem benefits:
### Enterprise & Institutional Adoption
- Reduced onboarding friction: Enterprises can leverage existing biometric authentication infrastructure instead of managing seed phrases or hardware wallets
- Regulatory compliance: Institutions can utilize their approved device security standards and identity management systems
- Cost optimization: ~50x gas reduction (from 200k-330k to 6,900 gas) makes enterprise-scale applications economically viable
The 100x gas cost reduction makes these use cases economically viable while maintaining the security properties institutions and users expect from their existing devices.
Adding the precompiled contract at the same address as used in [RIP-7212](https://github.com/ethereum/RIPs/blob/master/RIPS/rip-7212.md) provides consistency across ecosystems, and allows for any libraries that have been developed to interact with the precompile to be used unmodified across ecosystems.
## Specification
This ACP implements [EIP-7951](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-7951.md) for secp256r1 signature verification on Avalanche. The specification follows EIP-7951 exactly, with the precompiled contract deployed at address `0x0000000000000000000000000000000000000100`.
### Core Functionality
- Input: 160 bytes (message hash + signature components r,s + public key coordinates x,y)
- Output: success: 32 bytes `0x...01`; failure: no data returned
- Gas Cost: 6,900 gas (based on EIP-7951 benchmarking)
- Validation: Full compliance with NIST FIPS 186-3 specification
### Activation
This precompile may be activated as part of Avalanche's next network upgrade. Individual Avalanche L1s and subnets could adopt this enhancement independently through their respective client software updates.
For complete technical specifications, validation requirements, and implementation details, refer to [EIP-7951](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-7951.md).
## Backwards Compatibility
This ACP introduces a new precompiled contract and does not modify existing functionality. No backwards compatibility issues are expected since:
1. The precompile uses a previously unused address
2. No existing opcodes or consensus rules are modified
3. The change is additive and opt-in for applications
Adoption requires a coordinated network upgrade for the C-Chain. Other EVM L1s can adopt this enhancement independently by upgrading their client software.
## Security Considerations
### Cryptographic Security
- The secp256r1 curve is standardized by NIST and widely vetted
- Security properties are comparable to secp256k1 (used by ECRECOVER)
- Implementation follows NIST FIPS 186-3 specification exactly
### Implementation Security
- Signature verification (vs public-key recovery) approach maximizes compatibility with existing P-256 ecosystem
- No malleability check included to match NIST specification, but wrapper libraries may choose to add this
- Input validation prevents invalid curve points and out-of-range signature components
### Network Security
- Gas cost prevents potential DoS attacks through expensive computation
- No consensus-level security implications beyond standard precompile considerations
## Reference Implementation
The implementation builds upon existing work:
1. EIP-7951 Reference: The [Go-Ethereum implementation]https://github.com/ethereum/go-ethereum/pull/31991) of EIP-7951 provides the foundation
2. Coreth Implementation: Integration with Avalanche's C-Chain (Avalanche's fork of go-ethereum)
3. Cryptographic Library: Implementation utilizes Go's standard library `crypto/ecdsa` and `crypto/elliptic` packages, which implement NIST P-256 per FIPS 186-3 ([Go documentation](https://pkg.go.dev/crypto/elliptic#P256))
The implementation follows established patterns for precompile integration, adding the contract to the precompile registry and implementing the verification logic using established cryptographic libraries.
This ACP was implemented and merged into Coreth and Subnet-EVM behind the `Granite` upgrade flag. The full implementation can be found in [coreth@v0.15.4-rc.4](https://github.com/ava-labs/coreth/releases/tag/v0.15.4-rc.4), [subnet-evm@v0.8.0-fuji-rc.2](https://github.com/ava-labs/subnet-evm/releases/tag/v0.8.0-fuji-rc.2) and [libevm@v1.13.14-0.3.0.release](https://github.com/ava-labs/libevm/releases/tag/v1.13.14-0.3.0.release).
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-209: Eip7702 Style Account Abstraction (/docs/acps/209-eip7702-style-account-abstraction)
---
title: "ACP-209: Eip7702 Style Account Abstraction"
description: "Details for Avalanche Community Proposal 209: Eip7702 Style Account Abstraction"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/209-eip7702-style-account-abstraction/README.md
---
| ACP | 209 |
| :--- | :--- |
| **Title** | EIP-7702-style Set Code for EOAs |
| **Author(s)** | Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Arran Schlosberg ([@ARR4N](https://github.com/ARR4N)), Aaron Buchwald ([@aaronbuchwald](https://github.com/aaronbuchwald)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)) |
| **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/216)) |
| **Track** | Standards |
## Abstract
[EIP-7702](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md) was activated on the Ethereum mainnet in May 2025 as part of the Pectra upgrade, and introduced a new "set code transaction" type that allows Externally Owned Accounts (EOAs) to set the code in their account. This enabled several UX improvements, including batching multiple operations into a single atomic transaction, sponsoring transactions on behalf of another account, and privilege de-escalation for EOAs.
This ACP proposes adding a similar transaction type and functionality to Avalanche EVM implementations in order to have them support the same style of UX available on Ethereum. Modifications to the handling of account nonce and balances are required in order for it to be safe when used in conjunction with the streaming asynchronous execution (SAE) mechanism proposed in [ACP-194](https://github.com/avalanche-foundation/ACPs/tree/4a9408346ee408d0ab81050f42b9ac5ccae328bb/ACPs/194-streaming-asynchronous-execution).
## Motivation
The motivation for this ACP is the same as the motivation described in [EIP-7702](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md#motivation). However, EIP-7702 as implemented for Ethereum breaks invariants required for EVM chains that use the ACP-194 SAE mechanism.
There has been strong community feedback in support of ACP-194 for its potential to:
- Allow for increasing the target gas rate of Avalanche EVM chains, including the C-Chain
- Enable the use of an encrypted mempool to prevent front-running
- Enable the use of real time VRF during transaction execution
Given the strong support for ACP-194, bringing EIP-7702-style functionality to Avalanche EVMs requires modifications to preserve its necessary invariants, described below.
### Invariants needed for ACP-194
There are [two invariants explicitly broken by EIP-7702](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md#backwards-compatibility) that are required for SAE. They are:
1. An account balance can only decrease as a result of a transaction originating from that account.
1. An EOA nonce may not increase after transaction execution has begun.
These invariants are required for SAE in order to be able to statically analyze (i.e. determine without executing the transaction) that a transaction:
- Has the proper nonce
- Will have sufficient balance to pay for its worst case transaction fee plus the balance it sends
As described in the ACP-194, this lightweight analysis of transactions in blocks allows blocks to be accepted by consensus with the guarantee that they can be executed successfully. Only after block acceptance are the transactions within the block then put into a queue to be executed asynchronously. If the execution of transactions in the queue can decrease an EOA's account balance or change an EOA's current nonce, then block verification is unable to ensure that transactions in the block will be valid when executed. If transactions accepted into blocks can be invalidated prior to their execution, this poses DOS vulnerabilities because the invalidated transactions use up space in the pending execution queue according to their gas limits, but they do not pay any fees.
Notably, EIP-7702's violation of these invariants already presents challenges for mempool verification on Ethereum. As [noted in the security considerations section](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md#transaction-propagation), EIP-7702 makes it "possible to cause transactions from other accounts to become stale" and this "poses some challenges for transaction propagation" because nodes now cannot "statically determine the validity of transactions for that account". In synchronous execution environments such as Ethereum, these issues only pose potential DOS risks to the public transaction mempool. Under an asynchronous execution scheme, the issues pose DOS risks to the chain itself since the invalidated transactions can be included in blocks prior to their execution.
## Specification
The same [set code transaction as specified in EIP-7702](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md?ref=blockhead.co#set-code-transaction) will be added to Avalanche EVM implementations. The behavior of the transaction is the same as specified in EIP-7702. However, in order to keep the guarantee of transaction validity upon inclusion in an accepted block, two modifications are made to the transaction verification and execution rules.
1. Delegated accounts must maintain a "reserved balance" to ensure they can always pay for the transaction fees and transferred balance of transactions sent from the account. The reserved balances are managed via a new `ReservedBalanceManager` precompile, as specified below.
1. The handling of account nonces during execution is separated from the verification of nonces during block verification, as specified below.
### Reserved balances
To ensure that all transactions can cover their worst case transaction fees and transferred balances upon inclusion in an accepted block, a "reserved balance" mechanism is introduced for accounts. Reserved balances are required for delegated accounts to guarantee that subsequent transactions they send after setting code for their account can still cover their fees and transfer amounts, even if transactions from other accounts reduce the account's balance prior to their execution.
To allow for managing reserved balances, a new `ReservedBalanceManager` stateful precompile will be added at address `0x0200000000000000000000000000000000000006`. The `ReservedBalanceManager` precompile will have the following interface:
```solidity
interface IReservedBalanceManager {
/// @dev Emitted whenever an account's reserved balance is modified.
event ReservedBalanceUpdated(address indexed account, uint256 newBalance);
/// @dev Called to deposit the native token balance provided into the account's
/// reserved balance.
function depositReservedBalance(address account) external payable;
/// @dev Returns the current reserved balance for the given account.
function getReservedBalance(address account) external view returns (uint256 balance);
}
```
The precompile will maintain a mapping of accounts to their current reserved balances. The precompile itself intentionally only allows for _increasing_ an account's reserved balance. Reducing an account's reserved balance is only ever done by the EVM when a transaction is sent from the account, as specified below.
During transaction verification, the following rules are applied:
- If the sender EOA account has not set code via an EIP-7702 transaction, no reserved balance is required.
- The transaction is confirmed to be able to pay for its worst case transaction fee and transferred balance by looking at the sender account's regular balance and accounting for prior transactions it has sent that are still in the pending execution queue, as specified in ACP-194.
- Otherwise, if the sender EOA account has previously been delegated via an EIP-7702 transaction (even if that transaction is still in the pending execution queue), then the account's current "[settled](https://github.com/avalanche-foundation/ACPs/tree/4a9408346ee408d0ab81050f42b9ac5ccae328bb/ACPs/194-streaming-asynchronous-execution#settling-blocks)" reserved balance must be sufficient to cover the sum of the worst case transaction fees and balances sent for all of the transactions in the pending execution queue after the set code transaction.
During transaction execution, the following rules are applied:
- When initially deducting balance from the sender EOA account for the maximum transaction fee and balance sent with the transaction, the account's regular balance is used first. The account's reserved balance is only reduced if the regular balance is insufficient.
- In the execution of code as part of a transaction, only regular account balances are available. The only possible modification to reserved balances during code execution is increases via calls to the `ReservedBalanceManager` precompile `depositReservedBalance` function.
- If there is a gas refund at the end of the transaction execution, the balance is first credited to the sender account's reserved balance, up to a maximum of the account's reserved balance prior to the transaction. Any remaining refund is credited to the account's regular balance.
### Handling of nonces
To account for EOA account nonces being incremented during contract execution and potentially invalidating transactions from that EOA that have already been accepted, we separate the rules for how nonces are verified during block verification and how they are handled during execution.
During block verification, all transactions must be verified to have a correct nonce value based on the latest "settled" state root, as defined in ACP-194, and the number of transactions from the sender account in the pending execution queue. Specifically, the required nonce is derived from the settled state root and incremented by one for each of the sender’s transactions already accepted into the pending execution queue or current block.
During execution, the nonce used must be one greater than the latest nonce used by the account, accounting for both all transactions from the account and all contracts created by the account. This means that the actual nonce used by a transaction may differ from the nonce assigned in the raw transaction itself and used in verification.
Separating the nonce values used for block verification and execution ensures that transactions accepted in blocks cannot be invalidated by the execution of transactions before them in the pending execution queue. It still provides the same level of replay protection to transactions, as a transaction with a given nonce from an EOA can be accepted at most once. However, this separation has a subtle potential impact on contract creation. Previously, the resulting address of a contract could be deterministically derived from a contract creation transaction based on its sender address and the nonce set in the transaction. Now, since the nonce used in execution is separate from that set in the transaction, this is no longer guaranteed.
## Backwards Compatibility
The introduction of EIP-7702 transactions will require a network upgrade to be scheduled.
Upon activation, a few invariants will be broken:
- (From EIP-7702) `tx.origin == msg.sender` can only be true in the topmost frame of execution.
- Once an account has been delegated, it can invoke multiple calls per transaction.
- (From EIP-7702) An EOA nonce may not increase after transaction execution has begun.
- Once an account has been delegated, the account may call a create operation during execution, causing the nonce to increase.
- The contract address of a contract deployed by an EOA (via transaction with an empty "to" address) can be derived from the sender address and the transaction's nonce.
- If earlier transactions cause the nonce to increase before execution, the actual nonce used in a contract creation transaction may differ from the one in the transaction payload, altering the resulting contract address.
- Note that this can only occur for accounts that have been delegated, and whose delegated code involves contract creation.
Additionally, at all points after the acceptance of a set code transaction, an EOA must have sufficient reserved balance to cover the sum of the worst case transactions fees and balances sent for all transactions in the pending execution queue after the set code transaction. Notably, this means that:
- If a delegated account has zero reserved balance at any point, it will be unable to send any further transactions until a different account provides it with reserved balance via the `ReservedBalanceManager` precompile.
- In order to initially "self-fund" its own reserved balance, an account must deposit reserved balance via the `ReservedBalanceManager` precompile prior to sending a set code transaction.
- In order to transfer its full (regular + reserved) account balance, a delegated account must first deposit all of its regular balance into reserved balance.
In order to support wallets as seamlessly as possible, the `eth_getBalance` RPC implementations should be updated to return the sum of an accounts regular and reserved balances. Additionally, clients should provide a new `eth_getReservedBalance` RPC method to allow for querying the reserved balance of a given account.
## Reference Implementation
A reference implementation is not yet available and must be provided for this ACP to be considered implementable.
## Security Considerations
All of the [security considerations from the EIP-7702 specification](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md?ref=blockhead.co#security-considerations) apply here as well, except for the considerations regarding "sponsored transaction relayers" and "transaction propagation". Those two considerations do not apply here, as they are accounted for by the modifications made to introduce reserved balances and separate the handling of nonces in execution from verification.
Additionally, given that an account's reserved balance may need be updated in state when a transfer is sent from the account it must be confirmed that 21,000 gas is still a sufficiently high cost for the potential more expensive operation. Charging more gas for basic transfer transactions in this case could otherwise be an option, but would likely cause further backwards compatibility issues for smart contracts and off-chain services.
## Open Questions
1. Are the implementation and UX complexities regarding the `ReservedBalanceManager` precompile worth the UX improvements introduced by the new set code transaction type?
- Except for having a contract spend an account's native token balance, most, if not all, of the UX improvements associated with the new transaction type could theoretically be implemented at the contract layer rather than the protocol layer. However, not all contracts provide support for account abstraction functionality via standards such as [ERC-2771](https://eips.ethereum.org/EIPS/eip-2771).
2. Are the implementation and UX complexities regarding the `ReservedBalanceManager` precompile worth giving delegate contracts the ability to spend native token balances?
- An alternative may be to disallow delegate contracts from spending native token balances at all, and revert if they attempt to. They could use "wrapped native token" ERC20 implementations (i.e. WAVAX) to achieve the same effect. However, this may be equally or more complex at the implementation level, and would cause incompatibilies in delegate contract implementations for Ethereum.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-224: Dynamic Gas Limit In Subnet Evm (/docs/acps/224-dynamic-gas-limit-in-subnet-evm)
---
title: "ACP-224: Dynamic Gas Limit In Subnet Evm"
description: "Details for Avalanche Community Proposal 224: Dynamic Gas Limit In Subnet Evm"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/224-dynamic-gas-limit-in-subnet-evm/README.md
---
| ACP | 224 |
| :--- | :--- |
| **Title** | Introduce ACP-176-Based Dynamic Gas Limits and Fee Manager Precompile in Subnet-EVM |
| **Author(s)** | Ceyhun Onur ([@ceyonur](https://github.com/ceyonur)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)) |
| **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/230)) |
| **Track** | Standards |
## Abstract
Proposes implementing [ACP-176](https://github.com/avalanche-foundation/ACPs/blob/aa3bea24431b2fdf1c79f35a3fd7cc57eeb33108/ACPs/176-dynamic-evm-gas-limit-and-price-discovery-updates/README.md) in Subnet-EVM, along with the addition of a new optional `ACP224FeeManagerPrecompile` that can be used to configure fee parameters on-chain dynamically after activation, in the same way that the existing `FeeManagerPrecompile` can be used today prior to ACP-176.
## Motivation
ACP-176 updated the EVM dynamic fee mechanism to more accurately achieve the target gas consumption on-chain. It also added a mechanism for the target gas consumption rate to be dynamically updated. Until now, ACP-176 was only added to Coreth (C-Chain), primarily because most L1s prefer to control their fees and gas targets through the `FeeManagerPrecompile` and `FeeConfig` in genesis chain configuration, and the existing `FeeManagerPrecompile` is not compatible with the ACP-176 fee mechanism.
[ACP-194](https://github.com/avalanche-foundation/ACPs/blob/aa3bea24431b2fdf1c79f35a3fd7cc57eeb33108/ACPs/194-streaming-asynchronous-execution/README.md) (SAE) depends on having a gas target and capacity mechanism aligned with ACP-176. Specifically, there must be a known gas capacity added per second, and maximum gas capacity. The existing windower fee mechanism employed by Subnet-EVM does not provide these properties because it does not have a fixed capacity rate, making it difficult to calculate worst-case bounds for gas prices. As such, adding ACP-176 into Subnet-EVM is a functional requirement for L1s to be able to use SAE in the future. Adding ACP-176 fee dynamics to Subnet-EVM also has the added benefit of aligning with Coreth such that only a single mechanism needs to be maintained on a go-forwards basis.
While both ACP-176 and ACP-194 will be required upgrades for L1s, this ACP aims to provide similar controls for chains with a new precompile. A new dynamic fee configuration and fee manager precompile that maps well into the ACP-176 mechanism will be added, optionally allowing admins to adjust fee parameters dynamically.
## Specification
### ACP-176 Parameters
This ACP uses the same parameters as in the [ACP-176 specification](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/176-dynamic-evm-gas-limit-and-price-discovery-updates/README.md#configuration-parameters), and allows their values to be configured on a chain-by-chain basis. The parameters and their current values used by the C-Chain are as follows:
| Parameter | Description | C-Chain Configuration |
| :--- | :--- | :--- |
| $T$ | target gas consumed per second | dynamic |
| $R$ | gas capacity added per second | 2*T |
| $C$ | maximum gas capacity | 10*T |
| $P$ | minimum target gas consumption per second | 1,000,000 |
| $D$ | target gas consumption rate update constant | 2^25 |
| $Q$ | target gas consumption rate update factor change limit | 2^15 |
| $M$ | minimum gas price | 1x10^-18 AVAX |
| $K$ | initial gas price update factor | 87*T |
### Prior Subnet-EVM Fee Configuration Parameters
Prior to this ACP, the Subnet-EVM fee configuration and fee manager precompile used the following parameters to control the fee mechanism:
**GasLimit**:
Sets the max amount of gas consumed per block.
**TargetBlockRate**:
Sets the target rate of block production in seconds used for fee adjustments. If the actual block rate is faster than this target, block gas cost will be increased, and vice versa.
**MinBaseFee**:
The minimum base fee sets a lower bound on the EIP-1559 base fee of a block. Since the block's base fee sets the minimum gas price for any transaction included in that block, this effectively sets a minimum gas price for any transaction.
**TargetGas**:
Specifies the targeted amount of gas (including block gas cost) to consume within a rolling 10s window. When the dynamic fee algorithm observes that network activity is above/below the `TargetGas`, it increases/decreases the base fee proportionally to how far above/below the target actual network activity is.
**BaseFeeChangeDenominator**:
Divides the difference between actual and target utilization to determine how much to increase/decrease the base fee. A larger denominator indicates a slower changing, stickier base fee, while a lower denominator allows the base fee to adjust more quickly.
**MinBlockGasCost**:
Sets the minimum amount of gas to charge for the production of a block.
**MaxBlockGasCost**:
Sets the maximum amount of gas to charge for the production of a block.
**BlockGasCostStep**:
Determines how much to increase/decrease the block gas cost depending on the amount of time elapsed since the previous block. If the block is produced at the target rate, the block gas cost will stay the same as the block gas cost for the parent block. If it is produced faster/slower, the block gas cost will be increased/decreased by the step value for each second faster/slower than the target block rate accordingly.
Note: if the `BlockGasCostStep` is set to a very large number, it effectively requires block production to go no faster than the `TargetBlockRate`.
Ex: if a block is produced two seconds faster than the target block rate, the block gas cost will increase by `2 * BlockGasCostStep`.
### ACP-176 Parameters in Subnet-EVM
ACP-176 will make `GasLimit` and `BaseFeeChangeDenominator` configurations obsolete in Subnet-EVM.
`TargetBlockRate`, `MinBlockGasCost`, `MaxBlockGasCost`, and `BlockGasCostStep` will be also removed by [ACP-226](https://github.com/avalanche-foundation/ACPs/tree/ce51dfab/ACPs/226-dynamic-minimum-block-times).
`MinGasPrice` is equivalent to `M` in ACP-176 and will be used to set the minimum gas price for ACP-176. This is similar to `MinBaseFee` in old Subnet-EVM fee configuration, and roughly gives the same effect. Currently the default value is `25 * 10^-18` (25 nAVAX/Gwei). This default will be changed to the minimum possible denomination of the native EVM asset (1 Wei), which is aligned with the C-Chain.
`TargetGas` is equivalent to `T` (target gas consumed per second) in ACP-176 and will be used to set the target gas consumed per second for ACP-176.
`MaxCapacityFactor` is equivalent to the factor in `C` in ACP-176 and controls the maximum gas capacity (i.e. block gas limit). This determines the `C` as `C = MaxCapacityFactor * T`. The default value will be 10, which is aligned with the C-Chain.
`TimeToDouble` will be used to control the speed of the fee adjustment (`K`). This determines the `K` as `K = (RMult * TimeToDouble) / ln(2)`, where `RMult` is the factor in `R` which is defined as 2. The default value for `TimeToDouble` will be 60 (seconds), making `K=~87*T`, which is aligned with the C-Chain.
As a result parameters will be set as follows:
| Parameter | Description | Default Value | Is Configurable |
| :--- | :--- | :--- | :--- |
| $T$ | target gas consumed per second | 1,000,000 | :white_check_mark: |
| $R$ | gas capacity added per second | 2*T | :x:
| $C$ | maximum gas capacity | 10*T | :white_check_mark: Through `MaxCapacityFactor` (default 10)
| $P$ | minimum target gas consumption per second | 1,000,000 | :x:
| $D$ | target gas consumption rate update constant | 2^25 | :x:
| $Q$ | target gas consumption rate update factor change limit | 2^15 | :x:
| $M$ | minimum gas price | 1 Wei | :white_check_mark:
| $K$ | gas price update constant | ~87*T | :white_check_mark: Through `TimeToDouble` (default 60s)
The gas capacity added per second (`R`) always being equal to `2*T` keeps it such that the gas price is capable of increases and decrease at the same rate. The values of `Q` and `D` affect the magnitude of change to `T` that each block can have, and the granularity at which the target gas consumption rate can be updated. The proposed values match the C-Chain, allowing each block to modify the current gas target by roughly $\frac{1}{1024}$ of its current value. This has provided sufficient responsiveness and granularity as is, removing the need to make `D` and `Q` dynamic or configurable. Similarly, 1,000,000 gas/second should be a low enough minimum target gas consumption for any EVM L1. The target gas for a given L1 will be able to be increased from this value dynamically and has no maximum.
### Genesis Configuration
There will be a new genesis chain configuration to set the parameters for the chain without requiring the ACP224FeeManager precompile to be activated. This will be similar to the existing fee configuration parameters in chain configuration. If there is no genesis configuration for the new fee parameters the default values for the C-Chain will be used. This will look like the following:
```json
{
...
"acp224Timestamp": uint64
"acp224FeeConfig": {
"minGasPrice": uint64
"maxCapacityFactor": uint64
"timeToDouble": uint64
}
}
```
### Dynamic Gas Target Via Validator Preference
For L1s that want their gas target to be dynamically adjusted based on the preferences of their validator sets, the same mechanism introduced on the C-Chain in ACP-176 will be employed. Validators will be able to set their `gas-target` preference in their node's configuration, and block builders can then adjust the target excess in blocks that they propose based on their preference.
### Dynamic Gas Target & Fee Configuration Via `ACP224FeeManagerPrecompile`
For L1s that want an "admin" account to be able to dynamically configuration their gas target and other fee parameters, a new optional `ACP224FeeManagerPrecompile` will be introduced and can be activated. The precompile will offer similar controls as the existing `FeeManagerPrecompile` implemented in Subnet-EVM [here](https://github.com/ava-labs/subnet-evm/tree/53f5305/precompile/contracts/feemanager). The solidity interface will be as follows:
```solidity
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.24;
import "./IAllowList.sol";
/// @title ACP-224 Fee Manager Interface
/// @notice Interface for managing dynamic gas limit and fee parameters
/// @dev Inherits from IAllowList for access control
interface IACP224FeeManager is IAllowList {
/// @notice Configuration parameters for the dynamic fee mechanism
struct FeeConfig {
uint256 targetGas; // Target gas consumption per second
uint256 minGasPrice; // Minimum gas price in wei
uint256 maxCapacityFactor; // Maximum capacity factor (C = factor * T)
uint256 timeToDouble; // Time in seconds for gas price to double at max capacity
}
/// @notice Emitted when fee configuration is updated
/// @param sender Address that triggered the update
/// @param oldFeeConfig Previous configuration
/// @param newFeeConfig New configuration
event FeeConfigUpdated(address indexed sender, FeeConfig oldFeeConfig, FeeConfig newFeeConfig);
/// @notice Set the fee configuration
/// @param config New fee configuration parameters
function setFeeConfig(FeeConfig calldata config) external;
/// @notice Get the current fee configuration
/// @return config Current fee configuration
function getFeeConfig() external view returns (FeeConfig memory config);
/// @notice Get the block number when fee config was last changed
/// @return blockNumber Block number of last configuration change
function getFeeConfigLastChangedAt() external view returns (uint256 blockNumber);
}
```
For chains with the precompile activated, `setFeeConfig` can be used to dynamically change each of the values in the fee configurations. Importantly, any updates made via calls to `setFeeConfig` in a transaction will take effect only as of _settlement_ of the transaction, not as of _acceptance_ or _execution_ (for transaction life cycles/status, refer to ACP-194 [here](https://github.com/avalanche-foundation/ACPs/tree/61d2a2a/ACPs/194-streaming-asynchronous-execution#description)). This ensures that all nodes apply the same worst-case bounds validation on transactions being accepted into the queue, since the worst-case bounds are affected by changes to the fee configuration.
In addition to storing the latest fee configuration to be returned by `getFeeConfig`, the precompile will also maintain state storing the latest values of $q$ and $K$. These values can be derived from the `targetGas` and `timeToDouble` values given to the precompile, respectively. The value of $q$ can be deterministically calculated using the same method as Coreth currently employs to calculate a node's desired target excess [here](https://github.com/ava-labs/coreth/blob/b4c8300490afb7f234df704fdcc446f227e4ec2f/plugin/evm/upgrade/acp176/acp176.go#L170). Similarly, the value of $K$ could be computed directly according to:
$$ K = \frac{targetGas \cdot timeToDouble}{ln(2)} $$
However, floating point math may introduce inaccuracies. Instead, a similar approach will be employed using binary search to determine the closest integer solution for $K$.
Similar to the [desired target excess calculation in Coreth](https://github.com/ava-labs/coreth/blob/0255516f25964cf4a15668946f28b12935a50e0c/plugin/evm/upgrade/acp176/acp176.go#L170), which takes a node's desired gas target and calculates its desired target excess value, the `ACP224FeeManagerPrecompile` will use binary search to determine the resulting dynamic target excess value given the `targetGas` value passed to `setFeeConfig`. All blocks accepted after the settlement of such a call must have the correct target excess value as derived from the binary search result.
Block building logic can follow the below diagram for determining the target excess of blocks.
B{Is ACP224FeeManager precompile active?}
B -- Yes --> C[Use targetExcess from precompile storage at latest settled root]
B -- No --> D{Is gas-target set in node chain config file?}
D -- Yes --> E[Calculate targetExcess from configured preference and allowed update bounds]
D -- No --> F{Does parent block have ACP176 fields?}
F -- Yes --> G[Use parent block ACP176 gas target]
F -- No --> H[Use MinTargetPerSecond]`} />
#### Adjustment to ACP-176 calculations for price discovery
ACP-176 defines the gas price for a block as:
$$gas\_price = M \cdot e^{\frac{x}{K}}$$
Now, whenever $M$ (`minGasPrice`) or $K$ (derived from `timeToDouble`) are changed via the `ACP224FeeManagerPrecompile`, $x$ must also be updated.
Specifically, when $M$ is updated from $M_0$ to $M_1$, $x$ must also be updated from $x_0$ (the current excess) to $x_1$. $x_1$ theoretically could be calculated directly as:
$$x_1 = ln(\frac{M_0}{M_1}) \cdot K + x_0$$
However, this would introduce floating point inaccuracies. Instead $x_1$ can be approximated using binary search to find the minimum non-negative integer such that the resulting gas price calculated using $M_1$ is greater than or equal to the current gas price prior to the change in $M$. In effect, this means that both reducing the minimum gas price and increasing the minimum gas price to a value less than the current gas price have no immediate effect on the current gas price. However, increasing the minimum gas price to value greater than the current gas price will cause the gas price to immediately step up to the new minimum value.
Similarly, when $K$ is updated from $K_0$ to $K_1$, $x$ must also be updated from $x_0$ (the current excess) to $x_1$, where $x_1$ is calculated as:
$$x_1 = x_0 \cdot \frac{K_1}{K_0}$$
This makes it such that the current gas price stays the same when $K$ is changed. Changes to $K$ only impact how quickly or slowly the gas price can change going forward based on usage.
## Backwards Compatibility
ACP-224 will require a network update in order to activate the new fee mechanism. Another activation will also be required to activate the new fee manager precompile. The activation of precompile should never occur before the activation of ACP-224 (the fee mechanism) since the precompile depends on ACP-224’s fee update logic to function correctly.
Activation of ACP-224 mechanism will deactivate the prior fee mechanism and the prior fee manager precompile. This ensures that there is no ambiguity or overlap between legacy and new pricing logic. In order to provide a configuration for existing networks, a network upgrade override for both activation time and ACP-176 configuration parameters will be introduced.
These upgrades will be optional at the moment. However, with introduction of ACP-194 (SAE), it will be required to activate this ACP; otherwise the network will not be able to use ACP-194.
## Reference Implementation
A reference implementation is not yet available and must be provided for this ACP to be considered implementable.
## Security Considerations
Generally, this has the same security considerations as ACP-176. However, due to the dynamic nature of parameters exposed in the `ACP224FeeManagerPrecompile` there is an additional risk of misconfiguration. Misconfiguration of parameters could leave the network vulnerable to a DoS attack or result in higher transaction fees than necessary.
## Open Questions
* Should activation of the `ACP224FeeManager` precompile disable the old precompile itself or should we require it to be manually disabled as a separate upgrade?
* Should we use `targetGas` in genesis/chain config as an optional field signaling whether the chain config should have a precedence over the validator preferences?
* Similarly above, should we have a toggle in `ACP224FeeManager` precompile to give control to validators for `targetGas`?
## Acknowledgements
* [Stephen Buttolph](https://github.com/StephenButtolph)
* [Arran Schlosberg](https://github.com/ARR4N)
* [Austin Larson](https://github.com/alarso16)
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-226: Dynamic Minimum Block Times (/docs/acps/226-dynamic-minimum-block-times)
---
title: "ACP-226: Dynamic Minimum Block Times"
description: "Details for Avalanche Community Proposal 226: Dynamic Minimum Block Times"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/226-dynamic-minimum-block-times/README.md
---
| ACP | 226 |
| :- | :- |
| **Title** | Dynamic Minimum Block Times |
| **Author(s)** | Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)) |
| **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/228)) |
| **Track** | Standards |
## Abstract
Proposes replacing the current block production rate limiting mechanism on Avalanche EVM chains with a new mechanism where validators collectively and dynamically determine the minimum time between blocks.
## Motivation
Currently, Avalanche EVM chains employ a mechanism to limit the rate of block production by increasing the "block gas cost" that must be burned if blocks are produced more frequently than the target block rate specified for the chain. The block gas cost is paid by summing the "priority fee" amounts that all transactions included in the block collectively burn. This mechanism has a few notable suboptimal aspects:
1. There is no explicit minimum block delay time. Validators are capable of producing blocks as frequently as they would like by paying the additional fee, and too rapid block production could cause network stability issues.
1. The target block rate can only be changed in a required network upgrade, which makes updates difficult to coordinate and operationalize.
1. The target block rate can only be specified with 1-second granularity, which does not allow for configuring sub-second block times as performance improvements are made to make them feasible.
With the prospect of ACP-194 removing block execution from consensus and allowing for increases to the gas target through the dynamic ACP-176 mechanism, Avalanche EVM chains would be better suited by having a dynamic minimum block delay time denominated in milliseconds. This allows networks to ensure that blocks are never produced more frequently than the minimum block delay, and allows validators to dynamically influence the minimum block delay value by setting their preference.
## Specification
### Block Header Changes
Upon activation of this ACP, the `blockGasCost` field in block headers will be required to be set to 0. This means that no validation of the cumulative priority fee amounts of transactions within the block exceeding the block gas cost is required. Additionally, two new fields are added to EVM block headers: `timestampMilliseconds` and `minimumBlockDelayExcess`.
#### `timestampMilliseconds`
The canonical serialization and interpretation of EVM blocks already contains a block timestamp specified in seconds. Altering this would require deep changes to the EVM codebase, as well as cause breaking changes to tooling such as indexers and block explorers. Instead, a new field is added representing the unix timestamp in milliseconds. Header verification should verify the `block.timestamp` (in seconds) is aligned with the `block.timeMilliseconds`, more precisely: `block.timestampMilliseconds / 1000 == block.timestamp`.
Existing tools that do not need millisecond granularity do not need to parse the new field, which limits the amount of breaking changes.
The `timestampMilliseconds` field is represented in block headers as a `uint64`.
#### `minimumBlockDelayExcess`
The new `minimumBlockDelayExcess` field in the block header is used to derive the minimum number of milliseconds that must pass before the next block is allowed to be accepted. Specifically, if block $B$ has a `minimumBlockDelayExcess` of $q$, then the effective timestamp of block $B+1$ in milliseconds must be at least $M * e^{\frac{q}{D}}$ greater than the effective timestamp of block $B$ in milliseconds. $M$, $q$, and $D$ are defined below in the mechanism specification.
The `minimumBlockDelayExcess` field is represented in block headers as a `uint64`.
The value of `minimumBlockDelayExcess` can be updated in each block, similar to the gas target excess field introduced in ACP-176. The mechanism is specified below.
### Dynamic `minimumBlockDelay` mechanism
The `minimumBlockDelay` can be defined as:
$$ m = M * e^{\frac{q}{D}} $$
Where:
- $M$ is the global minimum `minimumBlockDelay` value in milliseconds
- $q$ is a non-negative integer that is initialized upon the activation of this mechanism, referred to as the `minimumBlockDelayExcess`
- $D$ is a constant that helps control the rate of change of `minimumBlockDelay`
After the execution of transactions in block $b$, the value of $q$ can be increased or decreased by up to $Q$. It must be the case that $\left|\Delta q\right| \leq Q$, or block $b$ is considered invalid. The amount by which $q$ changes after executing block $b$ is specified by the block builder.
Block builders (i.e., validators) may set their desired value for $M$ (i.e., their desired `minimumBlockDelay`) in their configuration, and their desired value for $q$ can then be calculated as:
$$q_{desired} = D \cdot ln\left(\frac{M_{desired}}{M}\right)$$
Note that since $q_{desired}$ is only used locally and can be different for each node, it is safe for implementations to approximate the value of $ln\left(\frac{M_{desired}}{M}\right)$ and round the resulting value to the nearest integer. Alternatively, client implementations can choose to use binary search to find the closest integer solution, as `coreth` [does to calculate a node's desired target excess](https://github.com/ava-labs/coreth/blob/ebaa8e028a3a8747d11e6822088b4af7863451d8/plugin/evm/upgrade/acp176/acp176.go#L170).
When building a block, builders can calculate their next preferred value for $q$ based on the network's current value (`q_current`) according to:
```python
# Calculates a node's new desired value for q for a given block
def calc_next_q(q_current: int, q_desired: int, max_change: int) -> int:
if q_desired > q_current:
return q_current + min(q_desired - q_current, max_change)
else:
return q_current - min(q_current - q_desired, max_change)
```
As $q$ is updated after the execution of transactions within the block, $m$ is also updated such that $m = M \cdot e^{\frac{q}{D}}$ at all times. As noted above, the change to $m$ only takes effect for subsequent block production, and cannot change the time at which block $b$ can be produced itself.
### Gas Accounting Updates
Currently, the amount of gas capacity available is only incremented on a per second basis, as defined by ACP-176. With this ACP, it is expected for chains to be able to have sub-second block times. However, in the case when a chain's gas capacity is fully consumed (i.e. during period of heavy transaction load), blocks would not be able to produced at sub-second intervals because at least one second would need to elapse for new gas capacity to be added. To correct this, upon activation of this ACP, gas capacity is added on a per millisecond basis.
The ACP-176 mechanism for determining the target gas consumption per second remains unchanged, but its result is now used to derive the target gas consumption per millisecond by dividing by 1000, and gas capacity is added at that rate as each block advances time by some number of milliseconds.
### Activation Parameters for the C-Chain
Parameters at activation on the C-Chain are:
$M$ was chosen as a lower bound for `minimumBlockDelay` values to allow high-performance Avalanche L1s to be able to realize maximum performance and minimal transaction latency.
Based on the 1 millisecond value for $M$, $q$ was chosen such that the effective `minimumBlockDelay` value at time of activation is as close as possible to the current target block rate of the C-Chain, which is 2 seconds.
$D$ and $Q$ were chosen such that it takes approximately 3,600 consecutive blocks of the maximum allowed change in $q$ for the effective `minimumBlockDelay` value to either halve or double.
### ProposerVM `MinBlkDelay`
The ProposerVM currently offers a static, configurable `MinBlkDelay` seconds for consecutive blocks. With this ACP enforcing a dynamic minimum block delay time, any EVM instance adopting this ACP that also leverages the ProposerVM should ensure that the ProposerVM `MinBlkDelay` is set to 0.
### Note on Block Building
While there is no longer a requirement for blocks to burn a minimum block gas cost after the activation of this ACP, block builders should still take priority fees into account when building blocks to allow for transaction prioritization and to maximize the amount of native token (AVAX) burned in the block.
From a user (transaction issuer) perspective, this means that a non-zero priority fee would only ever need to be set to ensure inclusion during periods of maximum gas utilization.
## Backwards Compatibility
While this proposal requires a network upgrade and updates the EVM block header format, it does so in a way that tries to maintain as much backwards compatibility as possible. Specifically, applications that currently parse and use the existing timestamp field that is denominated in seconds can continue to do so. The `timestampMilliseconds` header value only needs to be used in cases where more granular timestamps are required.
## Reference Implementation
This ACP was implemented and merged into Coreth and Subnet-EVM behind the `Granite` upgrade flag. The full implementation can be found in [coreth@v0.15.4-rc.4](https://github.com/ava-labs/coreth/releases/tag/v0.15.4-rc.4) and [subnet-evm@v0.8.0-fuji-rc.0](https://github.com/ava-labs/subnet-evm/releases/tag/v0.8.0-fuji-rc.0).
## Security Considerations
Too rapid block production may cause availability issues if validators of the given blockchain are not able to keep up with blocks being proposed to consensus. This new mechanism allows validators to help influence the maximum frequency at which blocks are allowed to be produced, but potential misconfiguration or overly aggressive settings may cause problems for some validators.
The mechanism for the minimum block delay time to adapt based on validator preference has already been used previously to allow for dynamic gas targets based on validator preference on the C-Chain, providing more confidence that it is suitable for controlling this network parameter as well. However, because each block is capable of changing the value of the minimum block delay by a certain amount, the lower the minimum block delay is, the more blocks that can be produced in a given time, and the faster the minimum block delay value will be able to change. This creates a dynamic where the mechanism for controlling `minimumBlockDelay` is more reactive at lower values, and less reactive at higher values. The global minimum `minimumBlockDelay` ($M$) provides a lower bound of how quickly blocks can ever be produced, but it is left to validators to ensure that the effective value does not exceed their collective preference.
## Acknowledgments
Thanks to [Luigi D'Onorio DeMeo](https://x.com/luigidemeo) for continually bringing up the idea of reducing block times to provide better UX for users of Avalanche blockchains.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-23: P Chain Native Transfers (/docs/acps/23-p-chain-native-transfers)
---
title: "ACP-23: P Chain Native Transfers"
description: "Details for Avalanche Community Proposal 23: P Chain Native Transfers"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/23-p-chain-native-transfers/README.md
---
| ACP | 23 |
| :--- | :--- |
| **Title** | P-Chain Native Transfers |
| **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) |
| **Status** | Activated |
| **Track** | Standards |
## Abstract
Support native transfers on P-chain. This enables users to transfer P-chain assets without leaving the P-chain or using a transaction type that's not meant for native transfers.
## Motivation
Currently, the P-chain has no simple transfer transaction type. The X-chain supports this functionality through a `BaseTx`. Although the P-chain contains transaction types that extend `BaseTx`, the `BaseTx` transaction type itself is not a valid transaction. This leads to abnormal implementations of P-chain native transfers like in the AvalancheGo wallet which abuses [`CreateSubnetTx`](https://github.com/ava-labs/avalanchego/blob/v1.10.15/wallet/chain/p/builder.go#L54-L63) to replicate the functionality contained in `BaseTx`.
With the growing number of subnets slated for launch on the Avalanche network, simple transfers will be demanded more by users. While there are work-arounds as mentioned before, the network should support it natively to provide a cheaper option for both validators and end-users.
## Specification
To support `BaseTx`, Avalanche Network Clients (like AvalancheGo) must register `BaseTx` with the type ID `0x22` in codec version `0x00`.
For the specification of the transaction itself, see [here](https://github.com/ava-labs/avalanchego/blob/v1.10.15/vms/platformvm/txs/base_tx.go#L29). Note that most other P-chain transactions extend this type, the only change in this ACP is to register it as a valid transaction itself.
## Backwards Compatibility
Adding a new transaction type is an execution change and requires a mandatory upgrade for activation. Implementors must take care to reject this transaction prior to activation. This ACP only details the specification of the added `BaseTx` transaction type.
## Reference Implementation
An implementation of `BaseTx` support was created [here](https://github.com/ava-labs/avalanchego/pull/2232) and subsequently merged into AvalancheGo. Since the "D" Upgrade is not activated, this transaction will be rejected by AvalancheGo.
If modifications are made to the specification of the transaction as part of the ACP process, the code must be updated prior to activation.
## Security Considerations
The P-chain has fixed fees which does not place any limits on chain throughput. A potentially popular transaction type like `BaseTx` may cause periods of high usage. The reference implementation in AvalancheGo sets the transaction fee to 0.001 AVAX as a deterrent (equivalent to `ImportTx` and `ExportTx`). This should be sufficient for the time being but a dynamic fee mechanism will need to be added to the P-chain in the future to mitigate this security concern. This is not addressed in this ACP as it requires a larger change to the fee dynamics on the P-chain as a whole.
## Open Questions
No open questions.
## Acknowledgements
Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@abi87](https://github.com/abi87) for their feedback on the reference implementation.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-236: Continuous Staking (/docs/acps/236-continuous-staking)
---
title: "ACP-236: Continuous Staking"
description: "Details for Avalanche Community Proposal 236: Continuous Staking"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/236-continuous-staking/README.md
---
| ACP | 236 |
|:--------------|:------------------------------------------------------------|
| **Title** | Continuous Staking |
| **Author(s)** | Razvan Angheluta ([@rrazvan1](https://github.com/rrazvan1)) |
| **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/244)) |
| **Track** | Standards |
## Abstract
This proposal introduces continuous staking for validators on the Avalanche P-Chain. Validators can stake their tokens continuously, allowing their stake to compound over time, accruing rewards once per specified cycle.
Note that this mechanism applies only to primary network validation. It does not apply to L1 validators or to legacy subnet validators.
## Motivation
The current staking system on the Avalanche P-Chain restricts flexibility for stakers by requiring them to specify an explicit end time for their stake and by enforcing minimum and maximum staking durations, limiting their ability to respond to changing market conditions or liquidity needs. Managing a large number of nodes is also challenging, as re-staking at the end of each period is labor-intensive, time-consuming, and poses security risks due to the required transaction signing. Additionally, tokens can remain idle at the end of a staking period until stakers initiate the necessary transactions to stake them again.
## Specification
Continuous staking introduces a mechanism that allows validators to remain staked indefinitely, without having to manually submit new staking transactions at the end of each period.
Instead of committing to a fixed endtime upfront, validators specify a cycle duration (period) and an `AutoRenewRewardsShares` value when they submit an `AddContinuousValidatorTx`. At the end of each cycle, the validator is automatically restaked for a new cycle of the same duration, unless the validator submits a `SetAutoRenewPolicyTx` with `AutoRenewRewardsShares` set to the sentinel value `MaxUint64`. If a validator submits such a `SetAutoRenewPolicyTx` during a cycle, the validator will continue validating until the end of the current cycle, at which point the validator exits and the funds are unlocked. Both `AddContinuousValidatorTx` and `SetAutoRenewPolicyTx` include the `AutoRenewRewardsShares` field, which controls the automatic restaking or withdrawal behavior of the rewards at the end of each cycle. The minimum and maximum cycle lengths follow the same protocol parameters as before (`MinStakeDuration` and `MaxStakeDuration`).
Note: On mainnet, the current configuration is: `MinStakeDuration = 14 days` and `MaxStakeDuration = 365 days`.
Clarification: In the rewards formula, `StakingPeriod` is the cycle’s duration, not the total accumulated time across cycles. Each cycle is treated separately when computing rewards.
Delegator interaction remains unchanged, and the same constraints apply: a delegation period must fit entirely within the validator’s cycle. Delegators cannot delegate across multiple cycles, since there is no guarantee that a validator will continue validating after the current cycle. Essentially, it is not possible to delegate continuously.
Rewards are accrued once per cycle and are managed according to the `AutoRenewRewardsShares` value: the specified portion is restaked and the remainder withdrawn. If the updated stake weight (previous stake + staking rewards + delegatee rewards) exceeds `MaxStakeLimit`, only the excess above `MaxStakeLimit` is withdrawn and distributed to `ValidatorRewardsOwner` and `DelegatorRewardsOwner`.
Because of the way `RewardValidatorTx` is structured, multiple instances cannot be issued without resulting in identical transaction IDs. To resolve this, a new transaction type has been introduced for both rewarding and stopping continuous validators: `RewardContinuousValidatorTx`. Along with the validator’s creation transaction ID, it also includes a timestamp.
Continuous validators follow the existing uptime requirements. The main difference is that uptime is measured separately for each cycle. At the end of every cycle, the validator’s uptime during that specific period is evaluated to determine eligibility for rewards. When a new cycle begins, uptime tracking resets and starts again for the next period.
Note: Submitting an `AddContinuousValidatorTx` immediately followed by a `SetAutoRenewPolicyTx` (with `AutoRenewRewardsShares = MaxUint32`) replicates the behavior of the current staking system.
### Auto-Renew Policy
The `PolicyOwner` field defines who is authorized to modify the validator's auto-renew policy. Only those specified as the `PolicyOwner` can update the auto-renew policy or signal the validator to exit at the end of a cycle.
To support flexible reward withdrawal while keeping UX simple, continuous validators include an auto-renew policy field at creation called `AutoRenewRewardsShares`. This value specifies, in millionths (percentage * 10_000), what portion of earned rewards should be automatically restaked at the end of each cycle. The remaining portion of the rewards will be withdrawn.
Using a sentinel value of `MaxUint64` signals that the validator should exit at the end of the current cycle.
For example, a value of 300,000, restakes 30% of the rewards and withdraws 70%.
### New P-Chain Transaction Types
The following new transaction types will be introduced to the P-Chain to support this functionality:
#### AddContinuousValidatorTx
```go
type AddContinuousValidatorTx struct {
// Metadata, inputs and outputs
BaseTx `serialize:"true"`
// Node ID of the validator
ValidatorNodeID ids.NodeID `serialize:"true" json:"nodeID"`
// Period (in seconds).
Period uint64 `serialize:"true" json:"period"`
// [Signer] is the BLS key for this validator.
Signer signer.Signer `serialize:"true" json:"signer"`
// Where to send staked tokens when done validating
StakeOuts []*avax.TransferableOutput `serialize:"true" json:"stake"`
// Where to send validation rewards when done validating
ValidatorRewardsOwner fx.Owner `serialize:"true" json:"validationRewardsOwner"`
// Where to send delegation rewards when done validating
DelegatorRewardsOwner fx.Owner `serialize:"true" json:"delegationRewardsOwner"`
// Who is authorized to modify the auto renew rewards shares
PolicyOwner fx.Owner `serialize:"true" json:"policyOwner"`
// Fee this validator charges delegators as a percentage, times 10,000
// For example, if this validator has DelegationShares=300,000 then they
// take 30% of rewards from delegators
DelegationShares uint32 `serialize:"true" json:"shares"`
// Weight of this validator used when sampling
Wght uint64 `serialize:"true" json:"weight"`
// Auto-renew policy for rewards, expressed in percentage, times 10,000.
// Range [0..1_000_000] means the percentage of cycle rewards to auto-restake:
// 0 = restake principal only; withdraw 100% of rewards
// 300_000 = restake 30% of rewards; withdraw 70%
// 1_000_000 = restake 100% of rewards; withdraw 0%
// Sentinel value MaxUint64 indicates "stop at the end of current cycle".
AutoRenewRewardsShares uint32 `serialize:"true" json:"autoRenewRewardsShares"`
}
```
#### SetAutoRenewPolicyTx
```go
type SetAutoRenewPolicyTx struct {
// Metadata, inputs and outputs
BaseTx `serialize:"true"`
// ID of the tx that created the continuous validator.
TxID ids.ID `serialize:"true" json:"txID"`
// Authorizes this validator to be updated.
Auth verify.Verifiable `serialize:"true" json:"auth"`
// Auto-renew policy for rewards, expressed in percentage, times 10,000.
// Range [0..1_000_000] means the percentage of cycle rewards to auto-restake:
// 0 = restake principal only; withdraw 100% of rewards
// 300_000 = restake 30% of rewards; withdraw 70%
// 1_000_000 = restake 100% of rewards; withdraw 0%
// Sentinel value MaxUint64 indicates "stop at the end of current cycle".
AutoRenewRewardsShares uint32 `serialize:"true" json:"autoRenewRewardsShares"`
}
```
#### RewardContinuousValidatorTx
```go
type RewardContinuousValidatorTx struct {
// ID of the tx that created the validator being removed/rewarded
TxID ids.ID `serialize:"true" json:"txID"`
// End time of the validation cycle.
Timestamp uint64 `serialize:"true" json:"timestamp"`
unsignedBytes []byte // Unsigned byte representation of this data
}
```
## Backwards Compatibility
This change requires a network upgrade to make sure that all validators are able to verify and execute the new introduced transactions.
## Considerations
Continuous staking makes it easier for users to keep their funds staked longer than with fixed-period staking, since it involves fewer transactions, lower friction, and reduced risks. Greater staking participation leads to stronger overall network security.
Validators benefit by not having to manually restart at the end of each cycle, which reduces transaction volume and the risk of network congestion.
However, the uptime risk per cycle slightly increases depending on cycle length and validator performance. For example, missing five days in a one-year cycle will still yield validation rewards, whereas missing five days in a two-week cycle may affect rewards.
## Flow of a Continuous Validator
B[Validator active]
B -->|Optional during cycle| C[Issue SetAutoRenewPolicyTx to update AutoRenewRewardsShares or request stop]
B --> D[Cycle endtime reached]
D --> E[Block builder issues RewardContinuousValidatorTx]
E --> F[Compute cycle rewards]
F --> G{Stop requested?}
G -->|Yes| H[Withdraw rewards and unlock principal]
H --> I[Validator exits]
G -->|No| J[Apply auto-renew policy and split rewards into restake and withdrawal]
J --> K{New stake exceeds MaxStakeLimit?}
K -->|Yes| L[Withdraw excess above MaxStakeLimit]
K -->|No| N[Start new cycle]
L --> N[Start new cycle]
N --> B`} />
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-24: Shanghai Eips (/docs/acps/24-shanghai-eips)
---
title: "ACP-24: Shanghai Eips"
description: "Details for Avalanche Community Proposal 24: Shanghai Eips"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/24-shanghai-eips/README.md
---
| ACP | 24 |
| :--- | :--- |
| **Title** | Activate Shanghai EIPs on C-Chain |
| **Author(s)** | Darioush Jalali ([@darioush](https://github.com/darioush)) |
| **Status** | Activated |
| **Track** | Standards |
## Abstract
This ACP proposes the adoption of the following EIPs on the Avalanche C-Chain network:
- [EIP-3651: Warm COINBASE](https://eips.ethereum.org/EIPS/eip-3651)
- [EIP-3855: PUSH0 instruction](https://eips.ethereum.org/EIPS/eip-3855)
- [EIP-3860: Limit and meter initcode](https://eips.ethereum.org/EIPS/eip-3860)
- [EIP-6049: Deprecate SELFDESTRUCT](https://eips.ethereum.org/EIPS/eip-6049)
## Motivation
The listed EIPs were activated on Ethereum mainnet as part of the [Shanghai upgrade](https://github.com/ethereum/execution-specs/blob/master/network-upgrades/mainnet-upgrades/shanghai.md#included-eips). This ACP proposes their activation on the Avalanche C-Chain in the next network upgrade. This maintains compatibility with upstream EVM tooling, infrastructure, and developer experience (e.g., Solidity compiler >= [0.8.20](https://github.com/ethereum/solidity/releases/tag/v0.8.20)).
## Specification & Reference Implementation
This ACP proposes the EIPs be adopted as specified in the EIPs themselves. ANCs (Avalanche Network Clients) can adopt the implementation as specified in the [coreth](https://github.com/ava-labs/coreth) repository, which was adopted from the [go-ethereum v1.12.0](https://github.com/ethereum/go-ethereum/releases/tag/v1.12.0) release in this [PR](https://github.com/ava-labs/coreth/pull/277). In particular, note the following code:
- [Activation of new opcode and dynamic gas calculations](https://github.com/ava-labs/coreth/blob/bf2051729c7aa0c4ed8848ad3a78e241a791b968/core/vm/jump_table.go#L92)
- [EIP-3860 intrinsic gas calculations](https://github.com/ava-labs/coreth/blob/bf2051729c7aa0c4ed8848ad3a78e241a791b968/core/state_transition.go#L112-L113)
- [EIP-3651 warm coinbase](https://github.com/ava-labs/coreth/blob/bf2051729c7aa0c4ed8848ad3a78e241a791b968/core/state/statedb.go#L1197-L1199)
- Note EIP-6049 marks SELFDESTRUCT as deprecated, but does not remove it. The implementation in coreth is unchanged.
## Backwards Compatibility
The following backward compatibility considerations were highlighted by the original EIP authors:
- [EIP-3855](https://eips.ethereum.org/EIPS/eip-3855#backwards-compatibility): "... introduces a new opcode which did not exist previously. Already deployed contracts using this opcode could change their behaviour after this EIP".
- [EIP-3860](https://eips.ethereum.org/EIPS/eip-3860#backwards-compatibility) "Already deployed contracts should not be effected, but certain transactions (with initcode beyond the proposed limit) would still be includable in a block, but result in an exceptional abort."
Adoption of this ACP modifies consensus rules for the C-Chain, therefore it requires a network upgrade.
## Security Considerations
Refer to the original EIPs for security considerations:
- [EIP 3855](https://eips.ethereum.org/EIPS/eip-3855#security-considerations)
- [EIP 3860](https://eips.ethereum.org/EIPS/eip-3860#security-considerations)
## Open Questions
No open questions.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-247: Delegation Multiplier Increase Maximum Validator Weight Reduction (/docs/acps/247-delegation-multiplier-increase-maximum-validator-weight-reduction)
---
title: "ACP-247: Delegation Multiplier Increase Maximum Validator Weight Reduction"
description: "Details for Avalanche Community Proposal 247: Delegation Multiplier Increase Maximum Validator Weight Reduction"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/247-delegation-multiplier-increase-maximum-validator-weight-reduction/README.md
---
| ACP | 247 |
| :--- | :--- |
| **Title** | Delegation Multiplier Increase & Maximum Validator Weight Reduction |
| **Authors** | Giacomo Barbieri ([@ijaack94](https://x.com/ijaack94)), BENQI ([@benqifinance](https://x.com/benqifinance)) |
| **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/248)) |
| **Track** | Standards |
## Abstract
This Avalanche Community Proposal advocates for two targeted adjustments to Primary Network validator staking parameters: (1) reducing the maximum validator weight from 3,000,000 AVAX to **1,000,000 AVAX** to prevent excessive stake concentration; and (2) increasing the delegation multiplier from 5x to **24x** to enable validators to efficiently serve larger delegated bases within the new weight constraint. These changes maintain the 2,000 AVAX minimum validator stake and focus on improving capital efficiency for existing, well-capitalized validators rather than broadening participation.
## Motivation
### Current Capital Efficiency Problem
The Avalanche Primary Network currently limits validators to a **4x delegation multiplier**, creating suboptimal infrastructure utilization. A validator with 2,000 AVAX self-stake can accept only 8,000 AVAX in delegations (4x multiplier), yielding a total weight of 10,000 AVAX.
**Economic Reality at Current 4x Multiplier** (at $20 AVAX, 8.25% APY, 5% delegation fee):
| Metric | Value |
|--------|-------|
| Self-stake | 2,000 AVAX |
| Max delegations | 8,000 AVAX |
| Total weight | 10,000 AVAX |
| Monthly rewards | $1,375 |
| Validator self-share (20% of weight) | $275 |
| Delegation fee income (5%) | $55 |
| **Total validator monthly income** | **$330** |
| **Monthly operational costs** | **$150** |
| **Net monthly profit** | **$180** |
This marginal profitability (~55% margin) creates structural problems:
- Many validators operate below capacity (not 8,000 AVAX fully delegated)
- Some validators forced to run multiple nodes to achieve sufficient scale
- Infrastructure investment is heavily underutilized
- Validator economics are fragile, attracting only well-funded entities
- Sensitive to delegation fee pressure (any reduction below 5% hurts profitability)
### Real Network Evidence: Validator Underutilization
Real validator distribution data (as of October 28, 2025) provides empirical evidence of the problem:
| Metric | Count | Percentage |
|--------|-------|-----------|
| **Total validators** | 854 | 100% |
| **Validators with ZERO delegations** | 451 | **52.8%** |
| **Validators with <1k AVAX delegated** | 501 | **58.7%** |
| **Validators with 100+ delegations** | 105 | 12.3% |
| **Validators with 1-5 delegations** | 138 | 16.2% |
**Critical Finding**: Over half of all validators have zero delegations despite having the technical capacity for up to 8,000 AVAX under current 4x multiplier. This reveals:
1. **Validators don't put much effort into collecting delegations** because they can't really make a business out of it
2. **Delegation is highly concentrated** among only ~100 top-performing validators
3. **Current system severely underutilizes validator infrastructure** across the network
4. **Small validators (2k-5k AVAX self-stake)** cannot compete for delegations
**Validator Self-Stake Distribution**:
- 447 validators (52.3%) have only 2k-5k AVAX self-stake
- Most of these are probably unprofitable or barely breaking even
- They cannot attract delegations at current economics
- Our profitability calculations ($180/month) match their behavior
### Maximum Validator Weight Centralization Risk
The current 3,000,000 AVAX maximum weight limit allows individual validators to accumulate excessive stake (0.42% of 720M AVAX total supply).
**Proposed 1,000,000 AVAX cap would reduce this to 0.14% per validator**, promoting more distribution in both self- and delegated stake.
### Proposed Solution
Implement two complementary changes:
1. **Reduce maximum validator weight to 1,000,000 AVAX** - Prevents dangerous concentration
2. **Increase delegation multiplier to 24x** - Increases the maximum _potential_ rewards that validators could receive from delegations, not changing any of the underlying incentives of delegation if not flipping the perception of maximum rewards for validators on Avalanche.
**Resulting Economics at 24x Multiplier** (at $20 AVAX, 2,000 AVAX self-stake, 8.25% APY, 5% delegation fee):
| Metric | Current (4x) | Proposed (24x) | Change |
|--------|-------------|---|---|
| Max delegations | 8,000 AVAX | 48,000 AVAX | +500% |
| Total weight | 10,000 AVAX | 50,000 AVAX | +400% |
| Monthly rewards total | $1,375 | $6,875 | +400% |
| Validator income | $330 | $605 | +83% |
| Net monthly profit | $180 | $455 | +153% |
| Profit margin | 55% | 75% | +20 pp |
This transformation:
- **Makes validators economically viable** at 50%+ delegation capacity
- **Eliminates need for multi-node operations** for profitability
- **Unlocks dormant validator capacity** (current 52.8% with zero delegations)
- **Enables sustainable single-node operations** at scale
## Specification
### Technical Changes
#### Change 1: Maximum Validator Weight Reduction
**Current Parameter**:
```
MaxValidatorStake = 3,000,000 AVAX
```
**Proposed Parameter**:
```
MaxValidatorStake = 1,000,000 AVAX
```
**Implementation Details**:
- Affects calculation of maximum validator weight (stake + delegations)
- Existing validators exceeding 1,000,000 AVAX weight are **not immediately affected**
- New delegations to validators at or above 1,000,000 AVAX total weight are **rejected by consensus**
- Validators already exceeding 1,000,000 AVAX continue earning rewards until staking period ends
- Upon period end, rewards paid and stake returned; new staking cannot exceed 1,000,000 AVAX
**Rationale**: Prevents single validators from accumulating excessive network influence while allowing existing large positions to mature naturally.
#### Change 2: Delegation Multiplier Increase
**Current Parameter**:
```
DelegationMultiplier = 4
```
**Proposed Parameter**:
```
DelegationMultiplier = 24
```
**Calculation Formula**:
```
MaxDelegatorStake(validator) = Min(ValidatorStake * 24, MaxValidatorWeight - ValidatorStake)
Example for 2,000 AVAX validator:
MaxDelegatorStake = Min(2,000 * 24, 1,000,000 - 2,000)
MaxDelegatorStake = Min(48,000, 998,000)
MaxDelegatorStake = 48,000 AVAX
```
**Implementation Details**:
- Applies uniformly to all validators
- Only validators with 40,000+ AVAX self-stake cannot utilize full 24x due to 1M weight cap
- All 2,000 AVAX validators can deploy full 24x multiplier
- Non-breaking for existing delegation relationships
#### Unchanged Parameters
The following parameters remain **UNCHANGED**:
| Parameter | Value | Notes |
|-----------|-------|-------|
| Minimum validator stake | 2,000 AVAX | No reduction |
| Minimum delegator stake | 25 AVAX | Unchanged |
| Minimum staking duration | 2 weeks | Unchanged |
| Maximum staking duration | 1 year | Unchanged |
| Uptime requirement | 80% | Unchanged |
| Slashing penalty | None | Unchanged |
| Reward formula | Same | APY calculations unchanged |
## Economic Impact Analysis
### Validator Profitability Scenarios
All scenarios calculated at:
- **AVAX Price**: $20 USD
- **Annual APY**: 8.25% (average, varies by network conditions)
- **Delegation Fee**: 5% (fee validator charges on delegator rewards)
- **Monthly operational costs**: $150 (cloud hosting, bandwidth, monitoring)
#### Scenario 1: Solo Validator (No Delegation)
| Metric | Current (4x) | Proposed (24x) |
|--------|-------------|---|
| Self-stake | 2,000 AVAX | 2,000 AVAX |
| Delegations | 0 | 0 |
| Total weight | 2,000 AVAX | 2,000 AVAX |
| Monthly rewards | $275 | $275 |
| Monthly costs | $150 | $150 |
| **Net profit** | **$125** | **$125** |
**Conclusion**: Solo operation equally profitable in both cases; validators must attract delegations for profitability.
#### Scenario 2: 50% Delegation Capacity
| Metric | Current (4x) | Proposed (24x) |
|--------|-------------|---|
| Self-stake | 2,000 AVAX | 2,000 AVAX |
| Delegations | 4,000 AVAX | 24,000 AVAX |
| Total weight | 6,000 AVAX | 26,000 AVAX |
| Monthly rewards | $825 | $3,575 |
| Validator income | $302.50 | $440 |
| Monthly costs | $150 | $150 |
| **Net profit** | **$152.50** | **$290** |
**Conclusion**: 24x multiplier increases profitability by **90.2%** at 50% delegation capacity. Validators reach break-even and profitability much more easily.
**Real Network Impact**: Current data shows 52.8% of validators (451) have ZERO delegations. At 50% capacity with 24x, these validators become economically viable, incentivizing them to accept delegations.
#### Scenario 3: Full Delegation Capacity (100%)
| Metric | Current (4x) | Proposed (24x) |
|--------|-------------|---|
| Self-stake | 2,000 AVAX | 2,000 AVAX |
| Delegations | 8,000 AVAX | 48,000 AVAX |
| Total weight | 10,000 AVAX | 50,000 AVAX |
| Monthly rewards | $1,375 | $6,875 |
| Validator self-share | $275 | $275 |
| Delegation fee income (5%) | $55 | $330 |
| Total validator income | $330 | $605 |
| Monthly costs | $150 | $150 |
| **Net profit** | **$180** | **$455** |
**Conclusion**: 24x multiplier increases profitability by **+152.8%** at full delegation. Transforms validators from barely-profitable to highly profitable operations.
### Sensitivity Analysis: Impact of Different Delegation Fees
**With 50% delegation capacity filled:**
| Delegation Fee | Current (4x) | Proposed (24x) | Multiplier Advantage |
|---|---|---|---|
| 2% (minimum) | $89.38 | $185 | 2.07x |
| 3% | $96.88 | $245 | 2.53x |
| 5% (assumed) | **$152.50** | **$290** | 1.90x |
| 7% | $208.13 | $335 | 1.61x |
| 10% (high) | $271.88 | $425 | 1.56x |
**Key insight**: 24x multiplier provides 1.5-2.5x better economics across all fee rates. Current model is highly sensitive to fee compression; 24x multiplier provides a financial buffer.
### Fee Market Implications
**Current 4x Model**:
- Validators barely profitable even at 5% fees
- Significant pressure to accept low fees to attract delegations
- Unsustainable economics push toward multi-node operations
- 52.8% of validators choose NOT to accept delegations (uneconomical)
**Proposed 24x Model**:
- Validators achieve healthy profits at standard 5% fees
- Can sustain competitive fee discovery without margin pressure
- Enables single-node operations at scale
- Market-based fee competition works as intended
- Expected outcome: More validators accept delegations, earning fees
## Network Impact Analysis
### P-Chain Load Considerations
The 24x multiplier change has **minimal impact** on P-Chain resources:
| Resource | Current State | Projected (24x) | Change |
|----------|---|---|---|
| Validator registry size | ~854 validators | ~854 validators | No change |
| Delegation transactions | Existing pattern | More delegations expected | Variable |
| BLS signature aggregation | Baseline | Baseline | Minimal |
| Storage requirements | Baseline | Baseline | Negligible |
**Why minimal impact?**
- Validator count unchanged (no new validators)
- Each validator has same duty requirements
- Delegations already tracked; multiplier doesn't add overhead
- Maximum weight cap prevents runaway growth
### Consensus Security
**Sybil Resistance**: Unchanged
- 2,000 AVAX minimum stake maintained
- Economic cost to create malicious validator unchanged
**Centralization Risk**: **Improved**
- 1M AVAX maximum weight reduces concentration
- Individual validators limited to 0.14% of maximum supply (vs 0.42% current)
- Prevents dangerous mega-validators
## Consequences Analysis
### Positive Consequences
**1. Validator Capital Efficiency Improves** (Very High probability, High severity)
- Single validators serve 6x larger delegated bases (8K -> 48K AVAX)
- Infrastructure investment better utilized
- Eliminates need for multiple-node operations
**2. Validator Profitability Increases Substantially** (Very High probability, High severity)
- Fully delegated validators earn 152.8% more ($180 -> $455/month)
- At 50% delegation: +90.2% improvement
- Makes validator operations genuinely profitable
- Attracts professional infrastructure operators
**3. Unlocks Dormant Validator Capacity** (Very High probability, High severity)
- 52.8% of validators (451) currently have zero delegations
- Improved economics incentivize these validators to accept delegations
- Converts uneconomical validators into active, capital-efficient operations
- Significantly increases network capital deployment
**4. Fee Market Stabilizes** (High probability, Medium severity)
- Validators can maintain 5%+ fees without margin pressure
- Sustainable economics support long-term operations
- Delegators benefit from stable, profitable validators
- Competitive fee discovery enabled
**5. Prevents Dangerous Centralization** (Very High probability, High severity)
- 1M AVAX cap prevents mega-validators
- Individual validator influence limited to 0.14% (vs 0.42% current)
- Maintains security through diversification
- Real data confirms no validators exceed 2.5% currently
**6. Minimal Network Disruption** (Very High probability, Medium severity)
- No new validator cohort entering (no min stake change)
- Validator count unchanged (~854)
- P-Chain load impact minimal
- Easy implementation (2 parameters only)
### Negative Consequences
**1. Delegation Concentration Risk Increases** (High probability, Medium severity)
- Larger multiplier enables validators to accumulate more delegations
- Top performers may attract disproportionate share
- Network vulnerable to large validator failures
**Mitigation**: 1M AVAX weight cap prevents validators from becoming too large. Current 2.5% max means risk is contained.
**2. Geographic Diversity Unchanged** (High probability, Low severity)
- Entry barrier remains $40,000 (unchanged)
- Validator count unlikely to increase (~854 baseline)
- Cloud provider concentration persists
**Mitigation**: This proposal optimizes efficiency only; separate initiatives address diversity.
**3. Fee Market Competition May Decrease** (Medium probability, Low severity)
- Fewer new validators entering (no min stake reduction)
- Existing validators less pressured on fees
- Delegators have same validator options
**Mitigation**: 24x efficiency enables competitive fee discovery without external pressure.
**4. Network Accessibility Unchanged** (Very High probability, Low severity)
- $40,000 entry barrier maintained
- Small token holders cannot become validators
- No improvement for less wealthy participants
**Mitigation**: This proposal optimizes efficiency, not accessibility. Different ACPs can address participation barriers.
## Backwards Compatibility
### Breaking Changes: None
This proposal maintains full backwards compatibility:
1. **Existing Validators**: All continue operating normally
2. **Existing Delegations**: No modifications required
3. **Reward Calculations**: Formula unchanged
4. **Staking Durations**: All parameters unchanged
5. **Uptime Requirements**: 80% threshold unchanged
### Transition Mechanism
**Phase 1 - Activation**:
- New parameters take effect at specified block height
- Existing validators with weight > 1M AVAX continue operating
- New delegations to validators > 1M AVAX weight are rejected
**Phase 2 - Maturation**:
- Existing large validators' delegations mature naturally
- Upon maturation, new stakes must comply with 1M AVAX cap
- Validators rebalance to optimize under new parameters
**Phase 3 - Equilibrium**:
- Network reaches new steady state
- Validators optimize delegation capacity within constraints
- Fee market establishes new equilibrium
## Open Questions
**Core Question**: "Should Avalanche prioritize validator capital efficiency through multiplier increase and weight cap reduction?"
**Supporting Questions**:
1. Is 24x multiplier appropriate?
2. Is 1M AVAX the right weight cap?
3. Should minimum stake remain at 2,000 AVAX?
- YES: Maintain current barrier (approved)
- NO: Lower it (pursue separate ACP)
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-25: Vm Application Errors (/docs/acps/25-vm-application-errors)
---
title: "ACP-25: Vm Application Errors"
description: "Details for Avalanche Community Proposal 25: Vm Application Errors"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/25-vm-application-errors/README.md
---
| ACP | 25 |
| :--- | :--- |
| **Title** | Virtual Machine Application Errors |
| **Author(s)** | Joshua Kim ([@joshua-kim](https://github.com/joshua-kim)) |
| **Status** | Activated |
| **Track** | Standards |
## Abstract
Support a way for a Virtual Machine (VM) to signal application-defined error conditions to another VM.
## Motivation
VMs are able to build their own peer-to-peer application protocols using the `AppRequest`, `AppResponse`, and `AppGossip` primitives.
`AppRequest` is a message type that requires a corresponding `AppResponse` to indicate a successful response. In the unhappy path where an `AppRequest` is unable to be served, there currently is no native way for a peer to signal an error condition. VMs currently resort to timeouts in failure cases, where a client making a request will fallback to marking its request as failed after some timeout period has expired.
Having a native application error type would offer a more powerful abstraction where Avalanche nodes would be able to score peers based on perceived errors. This is not currently possible because Avalanche networking isn't aware of the specific implementation details of the messages being delivered to VMs. A native application error type would also guarantee that all clients can potentially expect an `AppError` message to unblock an unsuccessful `AppRequest` and only rely on a timeout when absolutely necessary, significantly decreasing the latency for a client to unblock its request in the unhappy path.
## Specification
### Message
This modifies the p2p specification by introducing a new [protobuf](https://protobuf.dev/) message type:
```
message AppError {
bytes chain_id = 1;
uint32 request_id = 2;
uint32 error_code = 3;
string error_message = 4;
}
```
1. `chain_id`: Reserves field 1. Senders **must** use the same chain id of from the original `AppRequest` this `AppError` message is being sent in response to.
2. `request_id`: Reserves field 2. Senders **must** use the same request id from the original `AppRequest` this `AppError` message is being sent in response to.
3. `error_code`: Reserves field 3. Application defined error code. Implementations _should_ use the same error codes for the same conditions to allow clients to error match. Negative error codes are reserved for protocol defined errors. VMs may reserve any error code greater than zero.
4. `error_message`: Reserves field 4. Application defined human-readable error message that _should not_ be used for error matching. For error matching, use `error_code`.
### Reserved Errors
The following error codes are currently reserved by the Avalanche protocol:
| Error Code | Description |
| ---------- | --------------- |
| 0 | undefined |
| -1 | network timeout |
### Handling
Clients **must** respond to an inbound `AppRequest` message with either a corresponding `AppResponse` to indicate a successful response, or an `AppError` to indicate an error condition by the requested `deadline` in the original `AppRequest`.
## Backwards Compatibility
This new message type requires a network activation to require either an `AppResponse` or an `AppError` as a required response to an `AppRequest`.
## Reference Implementation
- Message definition: https://github.com/ava-labs/avalanchego/pull/2111
- Handling: https://github.com/ava-labs/avalanchego/pull/2248
## Security Considerations
Optional section that discusses the security implications/considerations relevant to the proposed change.
Clients should be aware that peers can arbitrarily send `AppError` messages to invoke error handling logic in a VM.
## Open Questions
Optional section that lists any concerns that should be resolved prior to implementation.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-30: Avalanche Warp X Evm (/docs/acps/30-avalanche-warp-x-evm)
---
title: "ACP-30: Avalanche Warp X Evm"
description: "Details for Avalanche Community Proposal 30: Avalanche Warp X Evm"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/30-avalanche-warp-x-evm/README.md
---
| ACP | 30 |
| :--- | :--- |
| **Title** | Integrate Avalanche Warp Messaging into the EVM |
| **Author(s)** | Aaron Buchwald ([aaron.buchwald56@gmail.com](mailto:aaron.buchwald56@gmail.com)) |
| **Status** | Activated |
| **Track** | Standards |
## Abstract
Integrate Avalanche Warp Messaging into the C-Chain and Subnet-EVM in order to bring Cross-Subnet Communication to the EVM on Avalanche.
## Motivation
Avalanche Subnets enable the creation of independent blockchains within the Avalanche Network. Each Avalanche Subnet registers its validator set on the Avalanche P-Chain, which serves as an effective "membership chain" for the entire Avalanche Ecosystem.
By providing read access to the validator set of every Subnet on the Avalanche Network, any Subnet can look up the validator set of any other Subnet within the Avalanche Ecosystem to verify an Avalanche Warp Message, which replaces the need for point-to-point exchange of validator set info between Subnets. This enables a light weight protocol that allows seamless, on-demand communication between Subnets.
For more information on the Avalanche Warp Messaging message and payload formats see here:
- [AWM Message Format](https://github.com/ava-labs/avalanchego/tree/v1.10.15/vms/platformvm/warp/README.md)
- [Payload Format](https://github.com/ava-labs/avalanchego/tree/v1.10.15/vms/platformvm/warp/payload/README.md)
This ACP proposes to activate Avalanche Warp Messaging on the C-Chain and offer compatible support in Subnet-EVM to provide the first standard implementation of AWM in production on the Avalanche Network.
## Specification
The specification will be broken down into the Solidity interface of the Warp Precompile, a Golang example implementation, the predicate verification, and the proposed gas costs for the Warp Precompile.
The Warp Precompile address is `0x0200000000000000000000000000000000000005`.
### Precompile Solidity Interface
```solidity
// (c) 2022-2023, Ava Labs, Inc. All rights reserved.
// See the file LICENSE for licensing terms.
// SPDX-License-Identifier: MIT
pragma solidity ^0.8.0;
struct WarpMessage {
bytes32 sourceChainID;
address originSenderAddress;
bytes payload;
}
struct WarpBlockHash {
bytes32 sourceChainID;
bytes32 blockHash;
}
interface IWarpMessenger {
event SendWarpMessage(address indexed sender, bytes32 indexed messageID, bytes message);
// sendWarpMessage emits a request for the subnet to send a warp message from [msg.sender]
// with the specified parameters.
// This emits a SendWarpMessage log from the precompile. When the corresponding block is accepted
// the Accept hook of the Warp precompile is invoked with all accepted logs emitted by the Warp
// precompile.
// Each validator then adds the UnsignedWarpMessage encoded in the log to the set of messages
// it is willing to sign for an off-chain relayer to aggregate Warp signatures.
function sendWarpMessage(bytes calldata payload) external returns (bytes32 messageID);
// getVerifiedWarpMessage parses the pre-verified warp message in the
// predicate storage slots as a WarpMessage and returns it to the caller.
// If the message exists and passes verification, returns the verified message
// and true.
// Otherwise, returns false and the empty value for the message.
function getVerifiedWarpMessage(uint32 index) external view returns (WarpMessage calldata message, bool valid);
// getVerifiedWarpBlockHash parses the pre-verified WarpBlockHash message in the
// predicate storage slots as a WarpBlockHash message and returns it to the caller.
// If the message exists and passes verification, returns the verified message
// and true.
// Otherwise, returns false and the empty value for the message.
function getVerifiedWarpBlockHash(
uint32 index
) external view returns (WarpBlockHash calldata warpBlockHash, bool valid);
// getBlockchainID returns the snow.Context BlockchainID of this chain.
// This blockchainID is the hash of the transaction that created this blockchain on the P-Chain
// and is not related to the Ethereum ChainID.
function getBlockchainID() external view returns (bytes32 blockchainID);
}
```
### Warp Predicates and Pre-Verification
Signed Avalanche Warp Messages are encoded in the [EIP-2930 Access List](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-2930.md) of a transaction, so that they can be pre-verified before executing the transactions in the block.
The access list can specify any number of access tuples: a pair of an address and an array of storage slots in EIP-2930. Warp Predicate verification borrows this functionality to encode signed warp messages according to the serialization format defined [here](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/predicate/Predicate.md).
Each Warp specific access tuple included in the access list specifies the Warp Precompile address as the address. The first tuple that specifies the Warp Precompile address is considered to be at index. Each subsequent access tuple that specifies the Warp Precompile address increases the Warp Message index by 1. Access tuples that specify any other address are not included in calculating the index for a specific warp message.
Avalanche Warp Messages are pre-verified (prior to block execution), and outputs a bitset for each transaction where a 1 indicates an Avalanche Warp Message that failed verification at that index. Throughout the EVM execution, the Warp Precompile checks the status of the resulting bit set to determine whether pre-verified messages are considered valid. This has the additional benefit of encoding the Warp pre-verification results in the block, so that verifying a historical block can use the encoded results instead of needing to access potentially old P-Chain state. The result bitset is encoded in the block according to the predicate result specification [here](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/predicate/Results.md).
Each Warp Message in the access list is charged gas to pay for verifying the Warp Message (gas costs are covered below) and is verified with the following steps (see [here](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/config.go#L218) for reference implementation):
1. Unpack the predicate bytes
2. Parse the signed Avalanche Warp Message
3. Verify the signature according to the AWM spec in AvalancheGo [here](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/config.go#L218) (the quorum numerator/denominator for the C-Chain is 67/100 and is configurable in Subnet-EVM)
### Precompile Implementation
All types, events, and function arguments/outputs are encoded using the ABI package according to the official [Solidity ABI Specification](https://docs.soliditylang.org/en/latest/abi-spec.html).
When the precompile is invoked with a given `calldata` argument, the first four bytes (`calldata[0:4]`) are read as the [function selector](https://docs.soliditylang.org/en/latest/abi-spec.html#function-selector). If the function selector matches the function selector of one of the functions defined by the Solidity interface, the contract invokes the corresponding execution function with the remaining calldata ie. `calldata[4:]`.
For the full specification of the execution functions defined in the Solidity interface, see the reference implementation here:
- [sendWarpMessage](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/contract.go#L226)
- [getVerifiedWarpMessage](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/contract.go#L187)
- [getVerifiedWarpBlockHash](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/contract.go#L145)
- [getBlockchainID](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/contract.go#L96)
### Gas Costs
The Warp Precompile charges gas during the verification of included Avalanche Warp Messages, which is included in the intrinsic gas cost of the transaction, and during the execution of the precompile.
#### Verification Gas Costs
Pre-verification charges the following costs for each Avalanche Warp Message:
- GasCostPerSignatureVerification: 20000
- GasCostPerWarpMessageBytes: 100
- GasCostPerWarpSigner: 500
These numbers were determined experimentally using the benchmarks available [here](https://github.com/ava-labs/subnet-evm/blob/master/x/warp/predicate_test.go#L687) to target approximately the same mgas/s as existing precompile benchmarks in the EVM, which ranges between 50-200 mgas/s.
In addition to the benchmarks, the following assumptions and goals were taken into account:
- BLS Public Key Aggregation is extremely fast, resulting in charging more for the base cost of a single BLS Multi-Signature Verification than for adding an additional public key
- The cost per byte included in the transaction should be strictly higher for including Avalanche Warp Messages than via transaction calldata, so that the Warp Precompile does not change the worst case maximum block size
#### Execution Gas Costs
The execution gas costs were determined by summing the cost of the EVM operations that are performed throughout the execution of the precompile with special consideration for added functionality that does not have an existing corollary within the EVM.
##### sendWarpMessage
`sendWarpMessage` charges a base cost of 41,500 gas + 8 gas / payload byte
This is comprised of charging for the following components:
- 375 gas / log operation
- 3 topics * 375 gas / topic
- 20k gas to produce and serve a BLS Signature
- 20k gas to store the Unsigned Warp Message
- 8 gas / payload byte
This charges 20k gas for storing an Unsigned Warp Message although the message is stored in an independent key-value database instead of the active state. This makes it less expensive to store, so 20k gas is a conservative estimate.
Additionally, the cost of serving valid signatures is significantly cheaper than serving state sync and bootstrapping requests, so the cost to validators of serving signatures over time is not considered a significant concern.
`sendWarpMessage` also charges for the log operation it includes commensurate with the gas cost of a standard log operation in the EVM.
A single `SendWarpMessage` log is charged:
- 375 gas base cost
- 375 gas per topic (`eventID`, `sender`, `messageID`)
- 8 byte per / payload byte encoded in the `message` field
Topics are indexed fields encoded as 32 byte values to support querying based on given specified topic values.
##### getBlockchainID
`getBlockchainID` charges 2 gas to serve an already in-memory 32 byte valu commensurate with existing in-memory operations.
##### getVerifiedWarpBlockHash / getVerifiedWarpMessage
`GetVerifiedWarpMessageBaseCost` charges 2 gas for serving a Warp Message (either payload type). Warp message are already in-memory, so it charges 2 gas for access.
`GasCostPerWarpMessageBytes` charges 100 gas per byte of the Avalanche Warp Message that is unpacked into a Solidity struct.
## Backwards Compatibility
Existing EVM opcodes and precompiles are not modified by activating Avalanche Warp Messaging in the EVM. This is an additive change to activate a Warp Precompile on the Avalanche C-Chain and can be scheduled for activation in any VM running on Avalanche Subnets that are capable of sending / verifying the specified payload types.
## Reference Implementation
A full reference implementation can be found in Subnet-EVM v0.5.9 [here](https://github.com/ava-labs/subnet-evm/tree/v0.5.9/x/warp).
## Security Considerations
Verifying an Avalanche Warp Message requires reading the source subnet's validator set at the P-Chain height specified in the [Snowman++ Block Extension](https://github.com/ava-labs/avalanchego/blob/v1.10.15/vms/proposervm/README.md#snowman-block-extension). The Avalanche PlatformVM provides the current state of the Avalanche P-Chain and maintains reverse diff-layers in order to compute Subnets' validator sets at historical points in time.
As a result, verifying a historical Avalanche Warp Message that references an old P-Chain height requires applying diff-layers from the current state back to the referenced P-Chain height. As Subnets and the P-Chain continue to produce and accept new blocks, verifying the Warp Messages in historical blocks becomes increasingly expensive.
To efficiently handle historical blocks containing Avalanche Warp Messages, the EVM uses the result bitset encoded in the block to determine the validity of Avalanche Warp Messages without requiring a historical P-Chain state lookup. This is considered secure because the network already verified the Avalanche Warp Messages when they were originally verified and accepted.
## Open Questions
_How should validator set lookups in Warp Message verification be effectively charged for gas?_
The verification cost of performing a validator set lookup on the P-Chain is currently excluded from the implementation. The cost of this lookup is variable depending on how old the referenced P-Chain height is from the perspective of each validator.
[Ongoing work](https://github.com/ava-labs/avalanchego/pull/1611) can parallelize P-Chain validator set lookups and message verification to reduce the impact on block verification latency to be negligible and reduce costs to reflect the additional bandwidth of encoding Avalanche Warp Messages in the transaction.
## Acknowledgements
Avalanche Warp Messaging and this effort to integrate it into the EVM has been a monumental effort. Thanks to all of the contributors who contributed their ideas, feedback, and development to this effort.
@stephenbuttolph
@patrick-ogrady
@michaelkaplan13
@minghinmatthewlam
@cam-schultz
@xanderdunn
@darioush
@ceyonur
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-31: Enable Subnet Ownership Transfer (/docs/acps/31-enable-subnet-ownership-transfer)
---
title: "ACP-31: Enable Subnet Ownership Transfer"
description: "Details for Avalanche Community Proposal 31: Enable Subnet Ownership Transfer"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/31-enable-subnet-ownership-transfer/README.md
---
| ACP | 31 |
| :--- | :--- |
| **Title** | Enable Subnet Ownership Transfer |
| **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) |
| **Status** | Activated |
| **Track** | Standards |
## Abstract
Allow the current owner of a Subnet to transfer ownership to a new owner.
## Motivation
Once a Subnet is created on the P-chain through a [CreateSubnetTx](https://github.com/ava-labs/avalanchego/blob/v1.10.15/vms/platformvm/txs/create_subnet_tx.go#L14-L19), the `Owner` of the subnet is currently immutable. Subnet operators may want to transition ownership of the Subnet to a new owner for a number of reasons, not least of all being rotating their control key(s) periodically.
## Specification
Implement a new transaction type (`TransferSubnetOwnershipTx`) that:
1. Takes in a `Subnet`
2. Verifies that the `SubnetAuth` has the right to remove the node from the subnet by verifying it against the `Owner` field in the `CreateSubnetTx` that created the `Subnet`.
3. Takes in a new `Owner` and assigning it as the new owner of `Subnet`
This transaction type should have the following format (code below is presented in Golang):
```go
type TransferSubnetOwnershipTx struct {
// Metadata, inputs and outputs
BaseTx `serialize:"true"`
// ID of the subnet this tx is modifying
Subnet ids.ID `serialize:"true" json:"subnetID"`
// Proves that the issuer has the right to remove the node from the subnet.
SubnetAuth verify.Verifiable `serialize:"true" json:"subnetAuthorization"`
// Who is now authorized to manage this subnet
Owner fx.Owner `serialize:"true" json:"newOwner"`
}
```
This transaction type should have type ID `0x21` in codec version `0x00`.
This transaction type should have a fee of `0.001 AVAX`, equivalent to adding a subnet validator/delegator.
## Backwards Compatibility
Adding a new transaction type is an execution change and requires a mandatory upgrade for activation. Implementors must take care to reject this transaction prior to activation. This ACP only details the specification of the `TransferSubnetOwnershipTx` type.
## Reference Implementation
An implementation of `TransferSubnetOwnershipTx` was created [here](https://github.com/ava-labs/avalanchego/pull/2178) and subsequently merged into AvalancheGo. Since the "D" Upgrade is not activated, this transaction will be rejected by AvalancheGo.
If modifications are made to the specification of the transaction as part of the ACP process, the code must be updated prior to activation.
## Security Considerations
No security considerations.
## Open Questions
No open questions.
## Acknowledgements
Thank you [@friskyfoxdk](https://github.com/friskyfoxdk) for filing an [issue](https://github.com/ava-labs/avalanchego/issues/1946) requesting this feature. Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@abi87](https://github.com/abi87) for their feedback on the reference implementation.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-41: Remove Pending Stakers (/docs/acps/41-remove-pending-stakers)
---
title: "ACP-41: Remove Pending Stakers"
description: "Details for Avalanche Community Proposal 41: Remove Pending Stakers"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/41-remove-pending-stakers/README.md
---
| ACP | 41 |
| :--- | :--- |
| **Title** | Remove Pending Stakers |
| **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) |
| **Status** | Activated |
| **Track** | Standards |
## Abstract
Remove user-specified `StartTime` for stakers. Start the staking period for a staker as soon as their staking transaction is accepted. This greatly reduces the computational load on the P-chain, increasing the efficiency of all Avalanche Network validators.
## Motivation
Stakers currently set a `StartTime` for their staking period. This means that Avalanche Network Clients, like AvalancheGo, need to maintain a pending set of all stakers that have not yet started. This places a nontrivial amount of work on the P-chain:
- When a new delegator transaction is verified, the pending set needs to be checked to ensure that the validator they are delegating to will not exceed `MaxValidatorStake` while they are active
- When a new staker transaction is accepted, it gets added to the pending set
- When time is advanced on the P-chain, any stakers in the pending set whose `StartTime <= CurrentTime` need to be moved to the current set
By immediately starting every staker on acceptance, the validators do not have to do the above work when validating the P-chain. `MaxValidatorStake` will become an `O(1)` operation as only the current stake of the validator needs to be checked. The pending set can be fully removed.
## Specification
1. When adding a new staker, the current on-chain time should be used for the staker's start time.
2. When determining when to remove the staker from the staker set, the `EndTime` specified in the transaction should continue to be used. Staking transactions should now be rejected if it does not satisfy `MinStakeDuration <= EndTime - CurrentTime <= MaxStakeDuration`. `StartTime` will no longer be validated.
## Backwards Compatibility
Modifying the state transition of a transaction type is an execution change and requires a mandatory upgrade for activation. Implementors must take care to not alter the execution behavior prior to activation. This ACP only details the new state transition.
Current wallet implementations will continue to work as-is post-activation of this ACP since no transaction formats are modified or added. Wallet implementations may run into issues with their txs being rejected as a result of this ACP if `EndTime >= CurrentChainTime + MaxStakeDuration`. `CurrentChainTime` is guaranteed to be >= the latest block timestamp on the P-chain.
## Reference Implementation
A reference implementation has not been created for this ACP since it deals with state management. Each ANC will need to adjust their execution step to follow the Specification detailed above. For AvalancheGo, this work is tracked in this PR: https://github.com/ava-labs/avalanchego/pull/2175
If modifications are made to the specification of the new execution behavior as part of the ACP process, the code must be updated prior to activation.
## Security Considerations
No security considerations.
## Open Questions
_How will stakers stake for `MaxStakeDuration` if they cannot determine their `StartTime`?_
As mentioned above, the beginning of your staking period is the block acceptance timestamp. Unless you can accurately predict the block timestamp, you will *not* be able to fully stake for `MaxStakeDuration`. This is an explicit trade-off to guarantee that stakers will receive their original stake + any staking rewards at `EndTime`.
Delegators can maximize their staking period by setting the same `EndTime` as the Validator they are delegating to.
## Acknowledgements
Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@abi87](https://github.com/abi87) for their feedback on these ideas.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-62: Disable Addvalidatortx And Adddelegatortx (/docs/acps/62-disable-addvalidatortx-and-adddelegatortx)
---
title: "ACP-62: Disable Addvalidatortx And Adddelegatortx"
description: "Details for Avalanche Community Proposal 62: Disable Addvalidatortx And Adddelegatortx"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/62-disable-addvalidatortx-and-adddelegatortx/README.md
---
| ACP | 62 |
| :--- | :--- |
| **Title** | Disable `AddValidatorTx` and `AddDelegatorTx` |
| **Author(s)** | Jacob Everly ([@JacobEv3rly](https://twitter.com/JacobEv3rly)), Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) |
| **Status** | Activated |
| **Track** | Standards |
## Abstract
Disable `AddValidatorTx` and `AddDelegatorTx` to push all new stakers to use `AddPermissionlessValidatorTx` and `AddPermissionlessDelegatorTx`. `AddPermissionlessValidatorTx` requires validators to register a BLS key. Wide adoption of registered BLS keys accelerates the timeline for future P-Chain upgrades. Additionally, this reduces the number of ways to participate in Primary Network validation from two to one.
## Motivation
`AddPermissionlessValidatorTx` and `AddPermissionlessDelegatorTx` were activated on the Avalanche Network in October 2022 with Banff (v1.9.0). This unlocked the ability for Subnet creators to activate Proof-of-Stake validation using their own token on their own Subnet. See more details about Banff [here](https://medium.com/avalancheavax/banff-elastic-subnets-44042f41e34c).
These new transaction types can also be used to register a Primary Network validator, leaving two redundant transactions: `AddValidatorTx` and `AddDelegatorTx`.
[`AddPermissionlessDelegatorTx`](https://github.com/ava-labs/avalanchego/blob/v1.10.18/vms/platformvm/txs/add_permissionless_delegator_tx.go#L25-L37) contains the same fields as [`AddDelegatorTx`](https://github.com/ava-labs/avalanchego/blob/v1.10.18/vms/platformvm/txs/add_delegator_tx.go#L29-L39) with an additional `Subnet` field.
[`AddPermissionlessValidatorTx`](https://github.com/ava-labs/avalanchego/blob/v1.10.18/vms/platformvm/txs/add_permissionless_validator_tx.go#L35-L59) contains the same fields as [`AddValidatorTx`](https://github.com/ava-labs/avalanchego/blob/v1.10.18/vms/platformvm/txs/add_validator_tx.go#L29-L42) with additional `Subnet` and `Signer` fields. `RewardsOwner` was also split into `ValidationRewardsOwner` and `DelegationRewardsOwner` letting validators divert rewards they receive from delegators into a separate rewards owner.
By disabling support of `AddValidatorTx`, all new validators on the Primary Network must use `AddPermissionlessValidatorTx` and register a BLS key with their NodeID. As more validators attach BLS keys to their nodes, future upgrades using these BLS keys can be activated through the ACP process. BLS keys can be used to efficiently sign a common message via [Public Key Aggregation](https://crypto.stanford.edu/~dabo/pubs/papers/BLSmultisig.html). Applications of this include, but are not limited to:
- **Arbitrary Subnet Rewards**: The P-Chain currently restricts Elastic Subnets to follow the reward curve defined in a `TransformSubnetTx`. With sufficient BLS key adoption, Elastic Subnets can define their own reward curve and reward conditions. The P-Chain can be modified to take in a message indicating if a Subnet validator should be rewarded with how many tokens signed with a BLS Multi-Signature.
- **Subnet Attestations**: Elastic Subnets can attest to the state of their Subnet with a BLS Multi-Signature. This can enable clients to fetch the current state of the Subnet without syncing the entire Subnet. `StateSync` enables clients to download chain state from peers up to a recent block near tip. However, it is up to the client to query these peers and resolve any potential conflicts in the responses. With Subnet Attestations, clients can query an API node to prove information about a Subnet without querying the Subnet's validators. This can especially be useful for [Subnet-Only Validators](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/62-disable-addvalidatortx-and-adddelegatortx/13-subnet-only-validators.md) to prove information about the C-Chain.
To accelerate future BLS-powered advancements in the Avalanche Network, this ACP aims to disable `AddValidatorTx` and `AddDelegatorTx` in Durango.
## Specification
`AddValidatorTx` and `AddDelegatorTx` should be marked as dropped when added to the mempool after activation. Any blocks including these transactions should be considered invalid.
## Backwards Compatibility
Disabling a transaction type is an execution change and requires a mandatory upgrade for activation. Implementers must take care to not alter the execution behavior prior to activation.
After this ACP is activated, any new issuance of `AddValidatorTx` or `AddDelegatorTx` will be considered invalid and dropped by the network. Any consumers of these transactions must transition to using `AddPermissionlessValidatorTx` and `AddPermissionlessDelegatorTx` to participate in Primary Network validation. The [Avalanche Ledger App](https://github.com/LedgerHQ/app-avalanche) supports both of these transaction types.
Note that `AddSubnetValidatorTx` and `RemoveSubnetValidatorTx` are unchanged by this ACP.
## Reference Implementation
An implementation disabling `AddValidatorTx` and `AddDelegatorTx` was created [here](https://github.com/ava-labs/avalanchego/pull/2662). Until activation, these transactions will continue to be accepted by AvalancheGo.
If modifications are made to the specification as part of the ACP process, the code must be updated prior to activation.
## Security Considerations
No security considerations.
## Open Questions
## Acknowledgements
Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@patrick-ogrady](https://github.com/patrick-ogrady) for their feedback on these ideas.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-75: Acceptance Proofs (/docs/acps/75-acceptance-proofs)
---
title: "ACP-75: Acceptance Proofs"
description: "Details for Avalanche Community Proposal 75: Acceptance Proofs"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/75-acceptance-proofs/README.md
---
| ACP | 75 |
| :--- | :--- |
| **Title** | Acceptance Proofs |
| **Author(s)** | Joshua Kim |
| **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/82)) |
| **Track** | Standards |
## Abstract
Introduces support for a proof of a block’s acceptance in consensus.
## Motivation
Subnets are able to prove arbitrary events using warp messaging, but native support for proving block acceptance at the protocol layer enables more utility. Acceptance proofs are introduced to prove that a block has been accepted by a subnet. One example use case for acceptance proofs is to provide stronger fault isolation guarantees from the primary network to subnets.
Subnets use the [ProposerVM](https://github.com/ava-labs/avalanchego/blob/416fbdf1f783c40f21e7009a9f06d192e69ba9b5/vms/proposervm/README.md) to implement soft leader election for block proposal. The ProposerVM determines the block producer schedule from a randomly shuffled validator set at a specified P-Chain block height. Validators are therefore required to have the P-Chain block referenced in a block's header to verify the block producer against the expected block producer schedule. If a block's header specifies a P-Chain height that has not been accepted yet, the block is treated as invalid. If a block referencing an unknown P-Chain height was produced virtuously, it is expected that the validator will eventually discover the block as its P-Chain height advances and accept the block.
If many validators disagree about the current tip of the P-Chain, it can lead to a liveness concern on the subnet where block production entirely stalls. In practice, this almost never occurs because nodes produce blocks with a lagging P-Chain height because it’s likely that most nodes will have accepted a sufficiently stale block. This however, relies on an assumption that validators are constantly making progress in consensus on the P-Chain to prevent the subnet from stalling. This leaves an open concern where the P-Chain stalling on a node would prevent it from verifying any blocks, leading to a subnet unable to produce blocks if many validators stalled at different P-Chain heights.
---
Figure 1: A Validator that has synced P-Chain blocks `A` and `B` fails verification of a block proposed at block `C`.
---
We introduce "acceptance proofs", so that a peer can verify any block accepted by consensus. In the aforementioned use-case, if a P-Chain block is unknown by a peer, it can request the block and proof at the provided height from a peer. If a block's proof is valid, the block can be executed to advance the local P-Chain and verify the proposed subnet block. Peers can request blocks from any peer without requiring consensus locally or communication with a validator. This has the added benefit of reducing the number of required connections and p2p message load served by P-Chain validators.
---
Figure 2: A Validator is verifying a subnet’s block `Z` which references an unknown P-Chain block `C` in its block header
Figure 3: A Validator requests the blocks and proofs for `B` and `C` from a peer
Figure 4: The Validator accepts the P-Chain blocks and is now able to verify `Z`
---
## Specification
Note: The following is pseudocode.
### P2P
#### Aggregation
```diff
+ message GetAcceptanceSignatureRequest {
+ bytes chain_id = 1;
+ uint32 request_id = 2;
+ bytes block_id = 3;
+ }
```
The `GetAcceptanceSignatureRequest` message is sent to a peer to request their signature for a given block id.
```diff
+ message GetAcceptanceSignatureResponse {
+ bytes chain_id = 1;
+ uint32 request_id = 2;
+ bytes bls_signature = 3;
+ }
```
`GetAcceptanceSignatureResponse` is sent to a peer as a response for `GetAcceptanceSignatureRequest`. `bls_signature` is the peer’s signature using their registered primary network BLS staking key over the requested `block_id`. An empty `bls_signature` field indicates that the block was not accepted yet.
## Security Considerations
Nodes that bootstrap using state sync may not have the entire history of the
P-Chain and therefore will not be able to provide the entire history for a block
that is referenced in a block that they propose. This would be needed to unblock a node that is attempting to fast-forward their P-Chain, as they require the entire ancestry between their current accepted tip and the block they are attempting to forward to. It is assumed that nodes will have some minimum amount of recent state so that the requester can eventually be unblocked by retrying, as only one node with the requested ancestry is required to unblock the requester.
An alternative is to make a churn assumption and validate the proposed block's proof with a stale validator set to avoid complexity, but this introduces more security concerns.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-77: Reinventing Subnets (/docs/acps/77-reinventing-subnets)
---
title: "ACP-77: Reinventing Subnets"
description: "Details for Avalanche Community Proposal 77: Reinventing Subnets"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/77-reinventing-subnets/README.md
---
| ACP | 77 |
| :------------ | :---------------------------------------------------------------------------------------- |
| **Title** | Reinventing Subnets |
| **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) |
| **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/78)) |
| **Track** | Standards |
| **Replaces** | [ACP-13](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/13-subnet-only-validators/README.md) |
## Abstract
Overhaul Subnet creation and management to unlock increased flexibility for Subnet creators by:
- Separating Subnet validators from Primary Network validators (Primary Network Partial Sync, Removal of 2000 $AVAX requirement)
- Moving ownership of Subnet validator set management from P-Chain to Subnets (ERC-20/ERC-721/Arbitrary Staking, Staking Reward Management)
- Introducing a continuous P-Chain fee mechanism for Subnet validators (Continuous Subnet Staking)
This ACP supersedes [ACP-13](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/13-subnet-only-validators/README.md) and borrows some of its language.
## Motivation
Each node operator must stake at least 2000 $AVAX ($70k at time of writing) to first become a Primary Network validator before they qualify to become a Subnet validator. Most Subnets aim to launch with at least 8 Subnet validators, which requires staking 16000 $AVAX ($560k at time of writing). All Subnet validators, to satisfy their role as Primary Network validators, must also [allocate 8 AWS vCPU, 16 GB RAM, and 1 TB storage](https://github.com/ava-labs/avalanchego/blob/master/README.md#installation) to sync the entire Primary Network (X-Chain, P-Chain, and C-Chain) and participate in its consensus, in addition to whatever resources are required for each Subnet they are validating.
Regulated entities that are prohibited from validating permissionless, smart contract-enabled blockchains (like the C-Chain) cannot launch a Subnet because they cannot opt-out of Primary Network Validation. This deployment blocker prevents a large cohort of Real World Asset (RWA) issuers from bringing unique, valuable tokens to the Avalanche Ecosystem (that could move between C-Chain <-> Subnets using Avalanche Warp Messaging/Teleporter).
A widely validated Subnet that is not properly metered could destabilize the Primary Network if usage spikes unexpectedly. Underprovisioned Primary Network validators running such a Subnet may exit with an OOM exception, see degraded disk performance, or find it difficult to allocate CPU time to P/X/C-Chain validation. The inverse also holds for Subnets with the Primary Network (where some undefined behavior could bring a Subnet offline).
Although the fee paid to the Primary Network to operate a Subnet does not go up with the amount of activity on the Subnet, the fixed, upfront cost of setting up a Subnet validator on the Primary Network deters new projects that prefer smaller, even variable, costs until demand is observed. _Unlike L2s that pay some increasing fee (usually denominated in units per transaction byte) to an external chain for data availability and security as activity scales, Subnets provide their own security/data availability and the only cost operators must pay from processing more activity is the hardware cost of supporting additional load._
Elastic Subnets, introduced in [Banff](https://medium.com/avalancheavax/banff-elastic-subnets-44042f41e34c), enabled Subnet creators to activate Proof-of-Stake validation and uptime-based rewards using their own token. However, this token is required to be an ANT (created on the X-Chain) and locked on the P-Chain. All staking rewards were distributed on the P-Chain with the reward curve being defined in the `TransformSubnetTx` and, once set, was unable to be modified.
With no Elastic Subnets live on Mainnet, it is clear that Permissionless Subnets as they stand today could be more desirable. There are many successful Permissioned Subnets in production but many Subnet creators have raised the above as points of concern. In summary, the Avalanche community could benefit from a more flexible and affordable mechanism to launch Permissionless Subnets.
### A Note on Nomenclature
Avalanche Subnets are subnetworks validated by a subset of the Primary Network validator set. The new network creation flow outlined in this ACP does not require any intersection between the new network's validator set and the Primary Network's validator set. Moreover, the new networks have greater functionality and sovereignty than Subnets. To distinguish between these two kinds of networks, the community has been referring to these new networks as _Avalanche Layer 1s_, or L1s for short.
All networks created through the old network creation flow will continue to be referred to as Avalanche Subnets.
## Specification
At a high-level, L1s can manage their validator sets externally to the P-Chain by setting the blockchain ID and address of their _validator manager_. The P-Chain will consume Warp messages that modify the L1's validator set. To confirm modification of the L1's validator set, the P-Chain will also produce Warp messages. L1 validators are not required to validate the Primary Network, and do not have the same 2000 $AVAX stake requirement that Subnet validators have. To maintain an active L1 validator, a continuous fee denominated in $AVAX is assessed. L1 validators are only required to sync the P-Chain (not X/C-Chain) in order to track validator set changes and support cross-L1 communication.
### P-Chain Warp Message Payloads
To enable management of an L1's validator set externally to the P-Chain, Warp message verification will be added to the [`PlatformVM`](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm). For a Warp message to be considered valid by the P-Chain, at least 67% of the `sourceChainID`'s weight must have participated in the aggregate BLS signature. This is equivalent to the threshold set for the C-Chain. A future ACP may be proposed to support modification of this threshold on a per-L1 basis.
The following Warp message payloads are introduced on the P-Chain:
- `SubnetToL1ConversionMessage`
- `RegisterL1ValidatorMessage`
- `L1ValidatorRegistrationMessage`
- `L1ValidatorWeightMessage`
The method of requesting signatures for these messages is left unspecified. A viable option for supporting this functionality is laid out in [ACP-118](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/118-warp-signature-request/README.md) with the `SignatureRequest` message.
All node IDs contained within the message specifications are represented as variable length arrays such that they can support new node IDs types should the P-Chain add support for them in the future.
The serialization of each of these messages is as follows.
#### `SubnetToL1ConversionMessage`
The P-Chain can produce a `SubnetToL1ConversionMessage` for consumers (i.e. validator managers) to be aware of the initial validator set.
The following serialization is defined as the `ValidatorData`:
| Field | Type | Size |
| -------------: | ---------: | -----------------------: |
| `nodeID` | `[]byte` | 4 + len(`nodeID`) bytes |
| `blsPublicKey` | `[48]byte` | 48 bytes |
| `weight` | `uint64` | 8 bytes |
| | | 60 + len(`nodeID`) bytes |
The following serialization is defined as the `ConversionData`:
| Field | Type | Size |
| ---------------: | ----------------: | ---------------------------------------------------------: |
| `codecID` | `uint16` | 2 bytes |
| `subnetID` | `[32]byte` | 32 bytes |
| `managerChainID` | `[32]byte` | 32 bytes |
| `managerAddress` | `[]byte` | 4 + len(`managerAddress`) bytes |
| `validators` | `[]ValidatorData` | 4 + sum(`validatorLengths`) bytes |
| | | 74 + len(`managerAddress`) + sum(`validatorLengths`) bytes |
- `codecID` is the codec version used to serialize the payload, and is hardcoded to `0x0000`
- `sum(validatorLengths)` is the sum of the lengths of `ValidatorData` serializations included in `validators`.
- `subnetID` identifies the Subnet that is being converted to an L1 (described further below).
- `managerChainID` and `managerAddress` identify the validator manager for the newly created L1. This is the (blockchain ID, address) tuple allowed to send Warp messages to modify the L1's validator set.
- `validators` are the initial continuous-fee-paying validators for the given L1.
The `SubnetToL1ConversionMessage` is specified as an `AddressedCall` with `sourceChainID` set to the P-Chain ID, the `sourceAddress` set to an empty byte array, and a payload of:
| Field | Type | Size |
| -------------: | ---------: | -------: |
| `codecID` | `uint16` | 2 bytes |
| `typeID` | `uint32` | 4 bytes |
| `conversionID` | `[32]byte` | 32 bytes |
| | | 38 bytes |
- `codecID` is the codec version used to serialize the payload, and is hardcoded to `0x0000`
- `typeID` is the payload type identifier and is `0x00000000` for this message
- `conversionID` is the SHA256 hash of the `ConversionData` from a given `ConvertSubnetToL1Tx`
#### `RegisterL1ValidatorMessage`
The P-Chain can consume a `RegisterL1ValidatorMessage` from validator managers through a `RegisterL1ValidatorTx` to register an addition to the L1's validator set.
The following is the serialization of a `PChainOwner`:
| Field | Type | Size |
| ----------: | -----------: | -------------------------------: |
| `threshold` | `uint32` | 4 bytes |
| `addresses` | `[][20]byte` | 4 + len(`addresses`) \\* 20 bytes |
| | | 8 + len(`addresses`) \\* 20 bytes |
- `threshold` is the number of `addresses` that must provide a signature for the `PChainOwner` to authorize an action.
- Validation criteria:
- If `threshold` is `0`, `addresses` must be empty
- `threshold` <= len(`addresses`)
- Entries of `addresses` must be unique and sorted in ascending order
The `RegisterL1ValidatorMessage` is specified as an `AddressedCall` with a payload of:
| Field | Type | Size |
| ----------------------: | ------------: | ------------------------------------------------------------------------: |
| `codecID` | `uint16` | 2 bytes |
| `typeID` | `uint32` | 4 bytes |
| `subnetID` | `[32]byte` | 32 bytes |
| `nodeID` | `[]byte` | 4 + len(`nodeID`) bytes |
| `blsPublicKey` | `[48]byte` | 48 bytes |
| `expiry` | `uint64` | 8 bytes |
| `remainingBalanceOwner` | `PChainOwner` | 8 + len(`addresses`) \\* 20 bytes |
| `disableOwner` | `PChainOwner` | 8 + len(`addresses`) \\* 20 bytes |
| `weight` | `uint64` | 8 bytes |
| | | 122 + len(`nodeID`) + (len(`addresses1`) + len(`addresses2`)) \\* 20 bytes |
- `codecID` is the codec version used to serialize the payload, and is hardcoded to `0x0000`
- `typeID` is the payload type identifier and is `0x00000001` for this payload
- `subnetID`, `nodeID`, `weight`, and `blsPublicKey` are for the validator being added
- `expiry` is the time at which this message becomes invalid. As of a P-Chain timestamp `>= expiry`, this Avalanche Warp Message can no longer be used to add the `nodeID` to the validator set of `subnetID`
- `remainingBalanceOwner` is the P-Chain owner where leftover $AVAX from the validator's Balance will be issued to when this validator it is removed from the validator set.
- `disableOwner` is the only P-Chain owner allowed to disable the validator using `DisableL1ValidatorTx`, specified below.
#### `L1ValidatorRegistrationMessage`
The P-Chain can produce an `L1ValidatorRegistrationMessage` for consumers to verify that a validation period has either begun or has been invalidated.
The `L1ValidatorRegistrationMessage` is specified as an `AddressedCall` with `sourceChainID` set to the P-Chain ID, the `sourceAddress` set to an empty byte array, and a payload of:
| Field | Type | Size |
| -------------: | ---------: | -------: |
| `codecID` | `uint16` | 2 bytes |
| `typeID` | `uint32` | 4 bytes |
| `validationID` | `[32]byte` | 32 bytes |
| `registered` | `bool` | 1 byte |
| | | 39 bytes |
- `codecID` is the codec version used to serialize the payload, and is hardcoded to `0x0000`
- `typeID` is the payload type identifier and is `0x00000002` for this message
- `validationID` identifies the validator for the message
- `registered` is a boolean representing the status of the `validationID`. If true, the `validationID` corresponds to a validator in the current validator set. If false, the `validationID` does not correspond to a validator in the current validator set, and never will in the future.
#### `L1ValidatorWeightMessage`
The P-Chain can consume an `L1ValidatorWeightMessage` through a `SetL1ValidatorWeightTx` to update the weight of an existing validator. The P-Chain can also produce an `L1ValidatorWeightMessage` for consumers to verify that the validator weight update has been effectuated.
The `L1ValidatorWeightMessage` is specified as an `AddressedCall` with the following payload. When sent from the P-Chain, the `sourceChainID` is set to the P-Chain ID, and the `sourceAddress` is set to an empty byte array.
| Field | Type | Size |
| -------------: | ---------: | -------: |
| `codecID` | `uint16` | 2 bytes |
| `typeID` | `uint32` | 4 bytes |
| `validationID` | `[32]byte` | 32 bytes |
| `nonce` | `uint64` | 8 bytes |
| `weight` | `uint64` | 8 bytes |
| | | 54 bytes |
- `codecID` is the codec version used to serialize the payload, and is hardcoded to `0x0000`
- `typeID` is the payload type identifier and is `0x00000003` for this message
- `validationID` identifies the validator for the message
- `nonce` is a strictly increasing number that denotes the latest validator weight update and provides replay protection for this transaction
- `weight` is the new `weight` of the validator
### New P-Chain Transaction Types
Both before and after this ACP, to create a Subnet, a `CreateSubnetTx` must be issued on the P-Chain. This transaction includes an `Owner` field which defines the key that today can be used to authorize any validator set additions (`AddSubnetValidatorTx`) or removals (`RemoveSubnetValidatorTx`).
To be considered a permissionless network, or Avalanche Layer 1:
- This `Owner` key must no longer have the ability to modify the validator set.
- New transaction types must support modification of the validator set via Warp messages.
The following new transaction types are introduced on the P-Chain to support this functionality:
- `ConvertSubnetToL1Tx`
- `RegisterL1ValidatorTx`
- `SetL1ValidatorWeightTx`
- `DisableL1ValidatorTx`
- `IncreaseL1ValidatorBalanceTx`
#### `ConvertSubnetToL1Tx`
To convert a Subnet into an L1, a `ConvertSubnetToL1Tx` must be issued to set the `(chainID, address)` pair that will manage the L1's validator set. The `Owner` key defined in `CreateSubnetTx` must provide a signature to authorize this conversion.
The `ConvertSubnetToL1Tx` specification is:
```go
type PChainOwner struct {
// The threshold number of `Addresses` that must provide a signature in order for
// the `PChainOwner` to be considered valid.
Threshold uint32 `json:"threshold"`
// The 20-byte addresses that are allowed to sign to authenticate a `PChainOwner`.
// Note: It is required for:
// - len(Addresses) == 0 if `Threshold` is 0.
// - len(Addresses) >= `Threshold`
// - The values in Addresses to be sorted in ascending order.
Addresses []ids.ShortID `json:"addresses"`
}
type L1Validator struct {
// NodeID of this validator
NodeID []byte `json:"nodeID"`
// Weight of this validator used when sampling
Weight uint64 `json:"weight"`
// Initial balance for this validator
Balance uint64 `json:"balance"`
// [Signer] is the BLS public key and proof-of-possession for this validator.
// Note: We do not enforce that the BLS key is unique across all validators.
// This means that validators can share a key if they so choose.
// However, a NodeID + L1 does uniquely map to a BLS key
Signer signer.ProofOfPossession `json:"signer"`
// Leftover $AVAX from the [Balance] will be issued to this
// owner once it is removed from the validator set.
RemainingBalanceOwner PChainOwner `json:"remainingBalanceOwner"`
// The only owner allowed to disable this validator on the P-Chain.
DisableOwner PChainOwner `json:"disableOwner"`
}
type ConvertSubnetToL1Tx struct {
// Metadata, inputs and outputs
BaseTx
// ID of the Subnet to transform
// Restrictions:
// - Must not be the Primary Network ID
Subnet ids.ID `json:"subnetID"`
// BlockchainID where the validator manager lives
ChainID ids.ID `json:"chainID"`
// Address of the validator manager
Address []byte `json:"address"`
// Initial continuous-fee-paying validators for the L1
Validators []L1Validator `json:"validators"`
// Authorizes this conversion
SubnetAuth verify.Verifiable `json:"subnetAuthorization"`
}
```
After this transaction is accepted, `CreateChainTx` and `AddSubnetValidatorTx` are disabled on the Subnet. The only action that the `Owner` key is able to take is removing Subnet validators with `RemoveSubnetValidatorTx` that had been added using `AddSubnetValidatorTx`. Unless removed by the `Owner` key, any Subnet validators added previously with an `AddSubnetValidatorTx` will continue to validate the Subnet until their [`End`](https://github.com/ava-labs/avalanchego/blob/a1721541754f8ee23502b456af86fea8c766352a/vms/platformvm/txs/validator.go#L27) time is reached. Once all Subnet validators added with `AddSubnetValidatorTx` are no longer in the validator set, the `Owner` key is powerless. `RegisterL1ValidatorTx` and `SetL1ValidatorWeightTx` must be used to manage the L1's validator set.
The `validationID` for validators added through `ConvertSubnetToL1Tx` is defined as the SHA256 hash of the 36 bytes resulting from concatenating the 32 byte `subnetID` with the 4 byte `validatorIndex` (index in the `Validators` array within the transaction).
Once this transaction is accepted, the P-Chain must be willing sign a `SubnetToL1ConversionMessage` with a `conversionID` corresponding to `ConversionData` populated with the values from this transaction.
#### `RegisterL1ValidatorTx`
After a `ConvertSubnetToL1Tx` has been accepted, new validators can only be added by using a `RegisterL1ValidatorTx`. The specification of this transaction is:
```go
type RegisterL1ValidatorTx struct {
// Metadata, inputs and outputs
BaseTx
// Balance <= sum($AVAX inputs) - sum($AVAX outputs) - TxFee.
Balance uint64 `json:"balance"`
// [Signer] is a BLS signature proving ownership of the BLS public key specified
// below in `Message` for this validator.
// Note: We do not enforce that the BLS key is unique across all validators.
// This means that validators can share a key if they so choose.
// However, a NodeID + L1 does uniquely map to a BLS key
Signer [96]byte `json:"signer"`
// A RegisterL1ValidatorMessage payload
Message warp.Message `json:"message"`
}
```
The `validationID` of validators added via `RegisterL1ValidatorTx` is defined as the SHA256 hash of the `Payload` of the `AddressedCall` in `Message`.
When a `RegisterL1ValidatorTx` is accepted on the P-Chain, the validator is added to the L1's validator set. A `minNonce` field corresponding to the `validationID` will be stored on addition to the validator set (initially set to `0`). This field will be used when validating the `SetL1ValidatorWeightTx` defined below.
This `validationID` will be used for replay protection. Used `validationID`s will be stored on the P-Chain. If a `RegisterL1ValidatorTx`'s `validationID` has already been used, the transaction will be considered invalid. To prevent storing an unbounded number of `validationID`s, the `expiry` of the `RegisterL1ValidatorMessage` is required to be no more than 24 hours in the future of the time the transaction is issued on the P-Chain. Any `validationIDs` corresponding to an expired timestamp can be flushed from the P-Chain's state.
L1s are responsible for defining the procedure on how to retrieve the above information from prospective validators.
An EVM-compatible L1 may choose to implement this step like so:
- Use the number of tokens the user has staked into a smart contract on the L1 to determine the weight of their validator
- Require the user to submit an on-chain transaction with their validator information
- Generate the Warp message
For a `RegisterL1ValidatorTx` to be valid, `Signer` must be a valid proof-of-possession of the `blsPublicKey` defined in the `RegisterL1ValidatorMessage` contained in the transaction.
After a `RegisterL1ValidatorTx` is accepted, the P-Chain must be willing to sign an `L1ValidatorRegistrationMessage` for the given `validationID` with `registered` set to `true`. This remains the case until the time at which the validator is removed from the validator set using a `SetL1ValidatorWeightTx`, as described below.
When it is known that a given `validationID` _is not and never will be_ registered, the P-Chain must be willing to sign an `L1ValidatorRegistrationMessage` for the `validationID` with `registered` set to `false`. This could be the case if the `expiry` time of the message has passed prior to the message being delivered in a `RegisterL1ValidatorTx`, or if the validator was successfully registered and then later removed. This enables the P-Chain to prove to validator managers that a validator has been removed or never added. The P-Chain must refuse to sign any `L1ValidatorRegistrationMessage` where the `validationID` does not correspond to an active validator and the `expiry` is in the future.
#### `SetL1ValidatorWeightTx`
`SetL1ValidatorWeightTx` is used to modify the voting weight of a validator. The specification of this transaction is:
```go
type SetL1ValidatorWeightTx struct {
// Metadata, inputs and outputs
BaseTx
// An L1ValidatorWeightMessage payload
Message warp.Message `json:"message"`
}
```
Applications of this transaction could include:
- Increase the voting weight of a validator if a delegation is made on the L1
- Increase the voting weight of a validator if the stake amount is increased (by staking rewards for example)
- Decrease the voting weight of a misbehaving validator
- Remove an inactive validator
The validation criteria for `L1ValidatorWeightMessage` is:
- `nonce >= minNonce`. Note that `nonce` is not required to be incremented by `1` with each successive validator weight update.
- When `minNonce == MaxUint64`, `nonce` must be `MaxUint64` and `weight` must be `0`. This prevents L1s from being unable to remove `nodeID` in a subsequent transaction.
- If `weight == 0`, the validator being removed must not be the last one in the set. If all validators are removed, there are no valid Warp messages that can be produced to register new validators through `RegisterL1ValidatorMessage`. With no validators, block production will halt and the L1 is unrecoverable. This validation criteria serves as a guardrail against this situation. A future ACP can remove this guardrail as users get more familiar with the new L1 mechanics and tooling matures to fork an L1.
When `weight != 0`, the weight of the validator is updated to `weight` and `minNonce` is updated to `nonce + 1`.
When `weight == 0`, the validator is removed from the validator set. All state related to the validator, including the `minNonce` and `validationID`, are reaped from the P-Chain state. Tracking these post-removal is not required since `validationID` can never be re-initialized due to the replay protection provided by `expiry` in `RegisterL1ValidatorTx`. Any unspent $AVAX in the validator's `Balance` will be issued in a single UTXO to the `RemainingBalanceOwner` for this validator. Recall that `RemainingBalanceOwner` is specified when the validator is first added to the L1's validator set (in either `ConvertSubnetToL1Tx` or `RegisterL1ValidatorTx`).
Note: There is no explicit `EndTime` for L1 validators added in a `ConvertSubnetToL1Tx` or `RegisterL1ValidatorTx`. The only time when L1 validators are removed from the L1's validator set is through this transaction when `weight == 0`.
#### `DisableL1ValidatorTx`
L1 validators can use `DisableL1ValidatorTx` to mark their validator as inactive. The specification of this transaction is:
```go
type DisableL1ValidatorTx struct {
// Metadata, inputs and outputs
BaseTx
// ID corresponding to the validator
ValidationID ids.ID `json:"validationID"`
// Authorizes this validator to be disabled
DisableAuth verify.Verifiable `json:"disableAuthorization"`
}
```
The `DisableOwner` specified for this validator must sign the transaction. Any unspent $AVAX in the validator's `Balance` will be issued in a single UTXO to the `RemainingBalanceOwner` for this validator. Recall that both `DisableOwner` and `RemainingBalanceOwner` are specified when the validator is first added to the L1's validator set (in either `ConvertSubnetToL1Tx` or `RegisterL1ValidatorTx`).
For full removal from an L1's validator set, a `SetL1ValidatorWeightTx` must be issued with weight `0`. To do so, a Warp message is required from the L1's validator manager. However, to support the ability to claim the unspent `Balance` for a validator without authorization is critical for failed L1s.
Note that this does not modify an L1's total staking weight. This transaction marks the validator as inactive, but does not remove it from the L1's validator set. Inactive validators can re-activate at any time by increasing their balance with an `IncreaseL1ValidatorBalanceTx`.
L1 creators should be aware that there is no notion of `MinStakeDuration` that is enforced by the P-Chain. It is expected that L1s who choose to enforce a `MinStakeDuration` will lock the validator's Stake for the L1's desired `MinStakeDuration`.
#### `IncreaseL1ValidatorBalanceTx`
L1 validators are required to maintain a non-zero balance used to pay the continuous fee on the P-Chain in order to be considered active. The `IncreaseL1ValidatorBalanceTx` can be used by anybody to add additional $AVAX to the `Balance` to a validator. The specification of this transaction is:
```go
type IncreaseL1ValidatorBalanceTx struct {
// Metadata, inputs and outputs
BaseTx
// ID corresponding to the validator
ValidationID ids.ID `json:"validationID"`
// Balance <= sum($AVAX inputs) - sum($AVAX outputs) - TxFee
Balance uint64 `json:"balance"`
}
```
If the validator corresponding to `ValidationID` is currently inactive (`Balance` was exhausted or `DisableL1ValidatorTx` was issued), this transaction will move them back to the active validator set.
Note: The $AVAX added to `Balance` can be claimed at any time by the validator using `DisableL1ValidatorTx`.
### Bootstrapping L1 Nodes
Bootstrapping a node/validator is the process of securely recreating the latest state of the blockchain locally. At the end of this process, the local state of a node/validator must be in sync with the local state of other virtuous nodes/validators. The node/validator can then verify new incoming transactions and reach consensus with other nodes/validators.
To bootstrap a node/validator, a few critical questions must be answered: How does one discover peers in the network? How does one determine that a discovered peer is honestly participating in the network?
For standalone networks like the Avalanche Primary Network, this is done by connecting to a hardcoded [set](https://github.com/ava-labs/avalanchego/blob/master/genesis/bootstrappers.json) of trusted bootstrappers to then discover new peers. Ethereum calls their set [bootnodes](https://ethereum.org/developers/docs/nodes-and-clients/bootnodes).
Since L1 validators are not required to be Primary Network validators, a list of validator IPs to connect to (the functional bootstrappers of the L1) cannot be provided by simply connecting to the Primary Network validators. However, the Primary Network can enable nodes tracking an L1 to seamlessly connect to the validators by tracking and gossiping L1 validator IPs. L1s will not need to operate and maintain a set of bootstrappers and can rely on the Primary Network for peer discovery.
### Sidebar: L1 Sovereignty
After this ACP is activated, the P-Chain will no longer support staking of any assets other than $AVAX for the Primary Network. The P-Chain will not support the distribution of staking rewards for L1s. All staking-related operations for L1 validation must be managed by the L1's validator manager. The P-Chain simply requires a continuous fee per validator. If an L1 would like to manage their validator's balances on the P-Chain, it can cover the cost for all L1 validators by posting the $AVAX balance on the P-Chain. L1s can implement any mechanism they want to pay the continuous fee charged by the P-Chain for its participants.
The L1 has full ownership over its validator set, not the P-Chain. There are no restrictions on what requirements an L1 can have for validators to join. Any stake that is required to join the L1's validator set is not locked on the P-Chain. If a validator is removed from the L1's validator set via a `SetL1ValidatorWeightTx` with weight `0`, the stake will continue to be locked outside of the P-Chain. How each L1 handles stake associated with the validator is entirely left up to the L1 and can be treated independently to what happens on the P-Chain.
The relationship between the P-Chain and L1s provides a dynamic where L1s can use the P-Chain as an impartial judge to modify parameters (in addition to its existing role of helping to validate incoming Avalanche Warp Messages). If a validator is misbehaving, the L1 validators can collectively generate a BLS multisig to reduce the voting weight of a misbehaving validator. This operation is fully secured by the Avalanche Primary Network (225M $AVAX or $8.325B at the time of writing).
Follow-up ACPs could extend the P-Chain <-> L1 relationship to include parametrization of the 67% threshold to enable L1s to choose a different threshold based on their security model (e.g. a simple majority of 51%).
### Continuous Fee Mechanism
Every additional validator on the P-Chain adds persistent load to the Avalanche Network. When a validator transaction is issued on the P-Chain, it is charged for the computational cost of the transaction itself but is not charged for the cost of an active validator over the time they are validating on the network (which may be indefinitely). This is a common problem in blockchains, spawning many state rent proposals in the broader blockchain space to address it. The following fee mechanism takes advantage of the fact that each L1 validator uses the same amount of computation and charges each L1 validator the dynamic base fee for every discrete unit of time it is active.
To charge each L1 validator, the notion of a `Balance` is introduced. The `Balance` of a validator will be continuously charged during the time they are active to cover the cost of storing the associated validator properties (BLS key, weight, nonce) in memory and to track IPs (in addition to other services provided by the Primary Network). This `Balance` is initialized with the `RegisterL1ValidatorTx` that added them to the active validator set. `Balance` can be increased at any time using the `IncreaseL1ValidatorBalanceTx`. When this `Balance` reaches `0`, the validator will be considered "inactive" and will no longer participate in validating the L1. Inactive validators can be moved back to the active validator set at any time using the same `IncreaseL1ValidatorBalanceTx`. Once a validator is considered inactive, the P-Chain will remove these properties from memory and only retain them on disk. All messages from that validator will be considered invalid until it is revived using the `IncreaseL1ValidatorBalanceTx`. L1s can reduce the amount of inactive weight by removing inactive validators with the `SetL1ValidatorWeightTx` (`Weight` = 0).
Since each L1 validator is charged the same amount at each point in time, tracking the fees for the entire validator set is straight-forward. The accumulated dynamic base fee for the entire network is tracked in a single uint. This accumulated value should be equal to the fee charged if a validator was active from the time the accumulator was instantiated. The validator set is maintained in a priority queue. A pseudocode implementation of the continuous fee mechanism is provided below.
```python
# Pseudocode
class ValidatorQueue:
def __init__(self, fee_getter):
self.acc = 0
self.queue = PriorityQueue()
self.fee_getter = fee_getter
# At each time period, increment the accumulator and
# pop all validators from the top of the queue that
# ran out of funds.
# Note: The amount of work done in a single block
# should be bounded to prevent a large number of
# validator operations from happening at the same
# time.
def time_elapse(self, t):
self.acc = self.acc + self.fee_getter(t)
while True:
vdr = self.queue.peek()
if vdr.balance < self.acc:
self.queue.pop()
continue
return
# Validator was added
def validator_enter(self, vdr):
vdr.balance = vdr.balance + self.acc
self.queue.add(vdr)
# Validator was removed
def validator_remove(self, vdrNodeID):
vdr = find_and_remove(self.queue, vdrNodeID)
vdr.balance = vdr.balance - self.acc
vdr.refund() # Refund [vdr.balance] to [RemainingBalanceOwner]
self.queue.remove()
# Validator's balance was topped up
def validator_increase(self, vdrNodeID, balance):
vdr = find_and_remove(self.queue, vdrNodeID)
vdr.balance = vdr.balance + balance
self.queue.add(vdr)
```
#### Fee Algorithm
[ACP-103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md) proposes a dynamic fee mechanism for transactions on the P-Chain. This mechanism is repurposed with minor modifications for the active L1 validator continuous fee.
At activation, the number of excess active L1 validators $x$ is set to `0`.
The fee rate per second for an active L1 validator is:
$$M \cdot \exp\left(\frac{x}{K}\right)$$
Where:
- $M$ is the minimum price for an active L1 validator
- $\exp\left(x\right)$ is an approximation of $e^x$ following the EIP-4844 specification
```python
# Approximates factor * e ** (numerator / denominator) using Taylor expansion
def fake_exponential(factor: int, numerator: int, denominator: int) -> int:
i = 1
output = 0
numerator_accum = factor * denominator
while numerator_accum > 0:
output += numerator_accum
numerator_accum = (numerator_accum * numerator) // (denominator * i)
i += 1
return output // denominator
```
- $K$ is a constant to control the rate of change for the L1 validator price
After every second, $x$ will be updated:
$$x = \max(x + (V - T), 0)$$
Where:
- $V$ is the number of active L1 validators
- $T$ is the target number of active L1 validators
Whenever $x$ increases by $K$, the price per active L1 validator increases by a factor of `~2.7`. If the price per active L1 validator gets too expensive, some active L1 validators will exit the active validator set, decreasing $x$, dropping the price. The price per active L1 validator constantly adjusts to make sure that, on average, the P-Chain has no more than $T$ active L1 validators.
#### Block Processing
Before processing the transactions inside a block, all validators that no longer have a sufficient (non-zero) balance are deactivated.
After processing the transactions inside a block, all validators that do not have a sufficient balance for the next second are deactivated.
##### Block Timestamp Validity Change
To ensure that validators are charged accurately, blocks are only considered valid if advancing the chain times would not cause a validator to have a negative balance.
This upholds the expectation that the number of L1 validators remains constant between blocks.
The block building protocol is modified to account for this change by first checking if the wall clock time removes any validator due to a lack of funds. If the wall clock time does not remove any L1 validators, the wall clock time is used to build the block. If it does, the time at which the first validator gets removed is used.
##### Fee Calculation
The total validator fee assessed in $\Delta t$ is:
```python
# Calculate the fee to charge over Δt
def cost_over_time(V:int, T:int, x:int, Δt: int) -> int:
cost = 0
for _ in range(Δt):
x = max(x + V - T, 0)
cost += fake_exponential(M, x, K)
return cost
```
#### Parameters
The parameters at activation are:
| Parameter | Definition | Value |
| --------- | ------------------------------------------- | ------------- |
| $T$ | target number of validators | 10_000 |
| $C$ | capacity number of validators | 20_000 |
| $M$ | minimum fee rate | 512 nAVAX/s |
| $K$ | constant to control the rate of fee changes | 1_246_488_515 |
An $M$ of 512 nAVAX/s equates to ~1.33 AVAX/month to run an L1 validator, so long as the total number of continuous-fee-paying L1 validators stays at or below $T$.
$K$ was chosen to set the maximum fee doubling rate to ~24 hours. This is in the extreme case that the network has $C$ validators for prolonged periods of time; if the network has $T$+1 validators for example, the fee rate would double every ~27 years.
A future ACP can adjust the parameters to increase $T$, reduce $M$, and/or modify $K$.
#### User Experience
L1 validators are continuously charged a fee, albeit a small one. This poses a challenge for L1 validators: How do they maintain the balance over time?
Node clients should expose an API to track how much balance is remaining in the validator's account. This will provide a way for L1 validators to track how quickly it is going down and top-up when needed. A nice byproduct of the above design is the balance in the validator's account is claimable. This means users can top-up as much $AVAX as they want and rest-assured knowing they can always retrieve it if there is an excessive amount.
The expectation is that most users will not interact with node clients or track when or how much they need to top-up their validator account. Wallet providers will abstract away most of this process. For users who desire more convenience, L1-as-a-Service providers will abstract away all of this process.
## Backwards Compatibility
This new design for Subnets proposes a large rework to all L1-related mechanics. Rollout should be done on a going-forward basis to not cause any service disruption for live Subnets. All current Subnet validators will be able to continue validating both the Primary Network and whatever Subnets they are validating.
Any state execution changes must be coordinated through a mandatory upgrade. Implementors must take care to continue to verify the existing ruleset until the upgrade is activated. After activation, nodes should verify the new ruleset. Implementors must take care to only verify the presence of 2000 $AVAX prior to activation.
### Deactivated Transactions
- P-Chain
- `TransformSubnetTx`
After this ACP is activated, Elastic Subnets will be disabled. `TransformSubnetTx` will not be accepted post-activation. As there are no Mainnet Elastic Subnets, there should be no production impact with this deactivation.
### New Transactions
- P-Chain
- `ConvertSubnetToL1Tx`
- `RegisterL1ValidatorTx`
- `SetL1ValidatorWeightTx`
- `DisableL1ValidatorTx`
- `IncreaseL1ValidatorBalanceTx`
## Reference Implementation
ACP-77 was implemented and will be merged into AvalancheGo behind the `Etna` upgrade flag. The full body of work can be found tagged with the `acp77` label [here](https://github.com/ava-labs/avalanchego/issues?q=sort%3Aupdated-desc+label%3Aacp77).
Since Etna is not yet activated, all new transactions introduced in ACP-77 will be rejected by AvalancheGo. If any modifications are made to ACP-77 as part of the ACP process, the implementation must be updated prior to activation.
## Security Considerations
This ACP introduces Avalanche Layer 1s, a new network type that costs significantly less than Avalanche Subnets. This can lead to a large increase in the number of networks and, by extension, the number of validators. Each additional validator adds consistent RAM usage to the P-Chain. However, this should be appropriately metered by the continuous fee mechanism outlined above.
With the sovereignty L1s have from the P-Chain, L1 staking tokens are not locked on the P-Chain. This poses a security consideration for L1 validators: Malicious chains can choose to remove validators at will and take any funds that the validator has locked on the L1. The P-Chain only provides the guarantee that L1 validators can retrieve the remaining $AVAX Balance for their validator via a `DisableL1ValidatorTx`. Any assets on the L1 is entirely under the purview of the L1. The onus is on L1 validators to vet the L1's security for any assets transferred onto the L1.
With a long window of expiry (24 hours) for the Warp message in `RegisterL1ValidatorTx`, spam of validator registration could lead to high memory pressure on the P-Chain. A future ACP can reduce the window of expiry if 24 hours proves to be a problem.
NodeIDs can be added to an L1's validator set involuntarily. However, it is important to note that any stake/rewards are _not_ at risk. For a node operator who was added to a validator set involuntarily, they would only need to generate a new NodeID via key rotation as there is no lock-up of any stake to create a NodeID. This is an explicit tradeoff for easier on-boarding of NodeIDs. This mirrors the Primary Network validators guarantee of no stake/rewards at risk.
The continuous fee mechanism outlined above does not apply to inactive L1 validators since they are not stored in memory. However, inactive L1 validators are persisted on disk which can lead to persistent P-Chain state growth. A future ACP can introduce a mechanism to decrease the rate of P-Chain state growth or provide a state expiry path to reduce the amount of P-Chain state.
## Acknowledgements
Special thanks to [@StephenButtolph](https://github.com/StephenButtolph), [@aaronbuchwald](https://github.com/aaronbuchwald), and [@patrick-ogrady](https://github.com/patrick-ogrady) for their feedback on these ideas. Thank you to the broader Ava Labs Platform Engineering Group for their feedback on this ACP prior to publication.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-83: Dynamic Multidimensional Fees (/docs/acps/83-dynamic-multidimensional-fees)
---
title: "ACP-83: Dynamic Multidimensional Fees"
description: "Details for Avalanche Community Proposal 83: Dynamic Multidimensional Fees"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/83-dynamic-multidimensional-fees/README.md
---
| ACP | 83 |
| :--- | :--- |
| **Title** | Dynamic multidimensional fees for P-chain and X-chain |
| **Author(s)** | Alberto Benegiamo ([@abi87](https://github.com/abi87)) |
| **Status** | Stale |
| **Track** | Standards |
| **Superseded-By** | [ACP-103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md) |
## Abstract
Introduce a dynamic and multidimensional fees scheme for the P-chain and X-chain.
Dynamic fees helps to preserve the stability of the chain as it provides a feedback mechanism that increases the cost of resources when the network operates above its target utilization.
Multidimensional fees ensures that high demand for orthogonal resources does not drive up the price of underutilized resources. For example, networks provide and consume orthogonal resources including, but not limited to, bandwidth, chain state, read/write throughput, and CPU. By independently metering each resource, they can be granularly priced and stay closer to optimal resource utilization.
## Motivation
The P-Chain and X-Chain currently have fixed fees and in some cases those fees are fixed to zero.
This makes transaction issuance predictable, but does not provide feedback mechanism to preserve chain stability under high load. In contrast, the C-Chain, which has the highest and most regular load among the chains on the Primary Network, already supports dynamic fees. This ACP proposes to introduce a similar dynamic fee mechanism for the P-Chain and X-Chain to further improve the Primary Network's stability and resilience under load.
However, unlike the C-Chain, we propose a multidimensional fee scheme with an exponential update rule for each fee dimension. The [HyperSDK](https://github.com/ava-labs/hypersdk) already utilizes a multidimensional fee scheme with optional priority fees and its efficiency is backed by [academic research](https://arxiv.org/abs/2208.07919).
Finally, we split the fee into two parts: a `base fee` and a `priority fee`. The `base fee` is calculated by the network each block to accurately price each resource at a given point in time. Whatever amount greater than the base fee is burnt is treated as the `priority fee` to prioritize faster transaction inclusion.
## Specification
We introduce the multidimensional scheme first and then how to apply the dynamic fee update rule for each fee dimension. Finally we list the new block verification rules, valid once the new fee scheme activates.
### Multidimensional scheme components
We define four fee dimensions, `Bandwidth`, `Reads`, `Writes`, `Compute`, to describe transactions complexity. In more details:
- `Bandwidth` measures the transaction size in bytes, as encoded by the AvalancheGo codec. Byte length is a proxy for the network resources needed to disseminate the transaction.
- `Reads` measures the number of DB reads needed to verify the transactions. DB reads include UTXOs reads and any other state quantity relevant for the specific transaction.
- `Writes` measures the number of DB writes following the transaction verification. DB writes include UTXOs generated as outputs of the transactions and any other state quantity relevant for the specific transaction.
- `Compute` measures the number of signatures to be verified, including UTXOs ones and those related to authorization of specific operations.
For each fee dimension $i$, we define:
- *fee rate* $r_i$ as the price, denominated in AVAX, to be paid for a transaction with complexity $u_i$ along the fee dimension $i$.
- *base fee* as the minimal fee needed to accept a transaction. Base fee is given be the formula
$$base \ fee = \sum_{i=0}^3 r_i \times u_i$$
- *priority fee* as an optional fee paid on top of the base fee to speed up the transaction inclusion in a block.
### Dynamic scheme components
Fee rates are updated in time, to allow a fee increase when network is getting congested. Each new block is a potential source of congestion, as its transactions carry complexity that each validator must process to verify and eventually accept the block. The more complexity carries a block, and the more rapidly blocks are produced, the higher the congestion.
We seek a scheme that rapidly increases the fees when blocks complexity goes above a defined threshold and that equally rapidly decreases the fees once complexity goes down (because blocks carry less/simpler transactions, or because they are produced more slowly). We define the desired threshold as a *target complexity rate* $T$: we would want to process every second a block whose complexity is $T$. Any complexity more than that causes some congestion that we want to penalize via fees.
In order to update fees rates we track, per each block and each fee dimension, a parameter called cumulative excess complexity. Fee rates applied to a block will be defined in terms of cumulative excess complexity as we show in the following.
Suppose that a block $B_t$ is the current chain tip. $B_t$ has the following features:
- $t$ is its timestamp.
- $\Delta C_t$ is the cumulative excess complexity along fee dimension $i$.
Say a new block $B_{t + \Delta T}$ is built on top of $B$, with the following features:
- $t + \Delta T$ is its timestamp
- $C_{t + \Delta T}$ is its complexity along fee dimension $i$.
Then the fee rate $r_{t + \Delta T}$ applied for the block $B_{t + \Delta T}$ along dimension $i$ will be:
$$ r_{t + \Delta T} = r^{min} \times e^{\frac{max(0, \Delta C_t - T \times \Delta T)}{Denom}} $$
where
- $r^{min}$ is the minimal fee rate along fee dimension $i$
- $T$ is the target complexity rate along fee dimension $i$
- $Denom$ is a normalization constant for the fee dimension $i$
Moreover, once the block $B_{t + \Delta T}$ is accepted, the cumulative excess complexity is updated as follows:
$$\Delta C_{t + \Delta T} = max\large(0, \Delta C_{t} - T \times \Delta T\large) + C_{t + \Delta T}$$
The fee rate update formula guarantees that fee rates increase if incoming blocks are complex (large $C_{t + \Delta T}$) and if blocks are emitted rapidly (small $\Delta T$). Symmetrically, fee rates decrease to the minimum if incoming blocks are less complex and if blocks are produced less frequently.
The update formula has a few paramenters to be tuned, independently, for each fee dimension. We defer discussion about tuning to the [implementation section](#tuning-the-update-formula).
## Block verification rules
Upon activation of the dynamic multidimensional fees scheme we modify block processing as follows:
- **Bound block complexity**. For each fee dimension $i$, we define a *maximal block complexity* $Max$. A block is only valid if the block complexity $C$ is less than the maximum block complexity: $C \leq Max$.
- **Verify transaction fee**. When verifying each transaction in a block, we confirm that it can cover its own base fee. Note that both base fee and optional priority fees are burned.
## User Experience
### How will the wallets estimate the fees?
AvalancheGo nodes will provide new APIs exposing the current and expected fee rates, as they are likely to change block by block. Wallets can then use the fees rates to select UTXOs to pay the transaction fees. Moreover, the AvalancheGo implementation proposed above offers a `fees.Calculator` struct that can be reused by wallets and downstream projects to evaluate calculate fees.
### How will wallets be able to re-issue Txs at a higher fee?
Wallets should be able to simply re-issue the transaction since current AvalancheGo implementation drops mempool transactions whose fee rate is lower than current one. More specifically, a transaction may be valid the moment it enters the mempool and it won’t be re-verified as long as it stays in there. However, as soon as the transaction is selected to be included in the next block, it is re-verified against the latest preferred tip. If fees are not enough by this time, the transaction is dropped and the wallet can simply re-issue it at a higher fee, or wait for the fee rate to go down. Note that priority fees offer some buffer space against an increase in the fee rate. A transaction paying just the base fee will be evicted from the mempool in the face of a fee rate increase, while a transaction paying some extra priority fee may have enough buffer room to stay valid after some amount of fee increase.
### How does priority fees guarantee a faster block inclusion?
AvalancheGo mempool will be restructured to order transactions by priority fees. Transactions paying priority fees will be selected for block inclusion first, without violating any spend dependency.
## Backwards Compatibility
Modifying the fee scheme for P-Chain and X-Chain requires a mandatory upgrade for activation. Moreover, wallets must be modified to properly handle the new fee scheme once activated.
## Reference Implementation
The implementation is split across multiple PRs:
- P-Chain work is tracked in this issue: [https://github.com/ava-labs/avalanchego/issues/2707](https://github.com/ava-labs/avalanchego/issues/2707)
- X-Chain work is tracked in this issue: [https://github.com/ava-labs/avalanchego/issues/2708](https://github.com/ava-labs/avalanchego/issues/2708)
A very important implementation step is tuning the update formula parameters for each chain and each fee dimension. We show here the principles we followed for tuning and a simulation based on historical data.
### Tuning the update formula
The basic idea is to measure the complexity of blocks already accepted and derive the parameters from it. You can find the historical data in [this repo](https://github.com/abi87/complexities).
To simplify the exposition I am purposefully ignoring chain specifics (like P-chain proposal blocks). We can account for chain specifics while processing the historical data. Here are the principles:
- **Target block complexity rate $T$**: calculate the distribution of block complexity and pick a high enough quantile.
- **Max block complexity $Max$**: this is probably the trickiest parameter to set.
Historically we had [pretty big transactions](https://subnets.avax.network/p-chain/tx/27pjHPRCvd3zaoQUYMesqtkVfZ188uP93zetNSqk3kSH1WjED1) (more than $1.000$ referenced utxos). Setting a max block complexity so high that these big transactions are allowed is akin to setting no complexity cap.
On the other side, we still want to allow, even encourage, UTXO consolidation, so we may want to allow transactions [like this](https://subnets.avax.network/p-chain/tx/2LxyHzbi2AGJ4GAcHXth6pj5DwVLWeVmog2SAfh4WrqSBdENhV).
A principled way to set max block complexity may be the following:
- calculate the target block complexity rate (see previous point)
- calculate the median time elapsed among consecutive blocks
- The product of these two quantities should gives us something like a target block complexity.
- Set the max block complexity to say $\times 50$ the target value.
- **Normalization coefficient $Denom$**: I suggest we size it as follows:
- Find the largest historical peak, i.e. the sequence of consecutive blocks which contained the most complexity in the shortest period of time
- Tune $Denom$ so that it would cause a $\times 10000$ increase in the fee rate for such a peak. This increase would push fees from the milliAVAX we normally pay under stable network condition up to tens of AVAX.
- **Minimal fee rates $r^{min}$**: we could size them so that transactions fees do not change very much with respect to the currently fixed values.
We simulate below how the update formula would behave on an peak period from Avalanche mainnet.
/>
/>
Figure 1 shows a peak period, starting with block [wqKJcvEv86TBpmJY2pAY7X65hzqJr3VnHriGh4oiAktWx5qT1](https://subnets.avax.network/p-chain/block/wqKJcvEv86TBpmJY2pAY7X65hzqJr3VnHriGh4oiAktWx5qT1) and going for roughly 30 blocks. We only show `Bandwidth` for clarity, but other fees dimensions have similar behaviour.
The network load is much larger than target and sustained.
Figure 2 show the fee dynamic in response to the peak: fees scale up from a few milliAVAX up to around 25 AVAX. Moreover as soon as the peak is over, and complexity goes back to the target value, fees are reduced very rapidly.
## Security Considerations
The new fee scheme is expected to help network stability as it offers economic incentives to users to hold transactions issuance in times of high load. While fees are expected to remain generally low when the system is not loaded, a sudden load increase, with fuller blocks, would push the dynamic fees algo to increase fee rates. The increase is expected to continue until the load is reduced. Load reduction happens by both dropping unconfirmed transactions whose fee-rate is not sufficient anymore and by pushing users that optimize their transactions costs to delay transaction issuance until the fee rate goes down to an acceptable level.
Note finally that the exponential fee update mechanism detailed above is [proven](https://ethresear.ch/t/multidimensional-eip-1559/11651) to be robust against strategic behaviors of users delaying transactions issuance and then suddenly push a bulk of transactions once the fee rate is low enough.
## Acknowledgements
Thanks to @StephenButtolph @patrick-ogrady and @dhrubabasu for their feedback on these ideas.
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-84: Table Preamble (/docs/acps/84-table-preamble)
---
title: "ACP-84: Table Preamble"
description: "Details for Avalanche Community Proposal 84: Table Preamble"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/84-table-preamble/README.md
---
| ACP | 84 |
| :--- | :--- |
| **Title** | Table Preamble for ACPs |
| **Author(s)** | Gauthier Leonard ([@Nuttymoon](https://github.com/Nuttymoon)) |
| **Status** | Activated |
| **Track** | Meta |
## Abstract
The current ACP template features a plain-text code block containing "RFC 822 style headers" as `Preamble` (see [What belongs in a successful ACP?](https://github.com/avalanche-foundation/ACPs?tab=readme-ov-file#what-belongs-in-a-successful-acp)). This header includes multiple links to discussions, authors, and other ACPs.
This ACP proposes to replace the `Preamble` code block with a Markdown table format (similar to what is used in [Ethereum EIPs](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-1.md)).
## Motivation
The current ACPs `Preamble` is (i) not very readable and (ii) not user-friendly as links are not clickable. The proposed table format aims to fix these issues.
## Specification
The following Markdown table format is proposed:
| ACP | PR Number |
| :----------------------------- | :-------------------------------------------------------------------------------------------------------------------------------------------------- |
| **Title** | ACP title |
| **Author(s)** | A list of the author's name(s) and optionally contact info: FirstName LastName ([@GitHubUsername](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md) or [email@address.com](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md)) |
| **Status** | Proposed, Implementable, Activated, Stale ([Discussion](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md)) |
| **Track** | Standards, Best Practices, Meta, Subnet |
| **Replaces (\\*optional)** | [ACP-XX](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md) |
| **Superseded-By (\\*optional)** | [ACP-XX](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md) |
It features all the existing fields of the current ACP template, and would replace the current `Preamble` code block in [ACPs/TEMPLATE.md](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/TEMPLATE.md).
## Backwards Compatibility
Existing ACPs could be updated to use the new table format, but it is not mandatory.
## Reference Implementation
For this ACP, the table would look like this:
| ACP | 84 |
| :------------ | :----------------------------------------------------------------------------------- |
| **Title** | Table Preamble for ACPs |
| **Author(s)** | Gauthier Leonard ([@Nuttymoon](https://github.com/Nuttymoon)) |
| **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/86)) |
| **Track** | Meta |
## Security Considerations
NA
## Open Questions
NA
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# ACP-99: Validatorsetmanager Contract (/docs/acps/99-validatorsetmanager-contract)
---
title: "ACP-99: Validatorsetmanager Contract"
description: "Details for Avalanche Community Proposal 99: Validatorsetmanager Contract"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/99-validatorsetmanager-contract/README.md
---
| ACP | 99 |
| :----------- | :-------------------------------------------------------------------------------------------------------------------------- |
| Title | Validator Manager Solidity Standard |
| Author(s) | Gauthier Leonard ([@Nuttymoon](https://github.com/Nuttymoon)), Cam Schultz ([@cam-schultz](https://github.com/cam-schultz)) |
| Status | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/165)) |
| Track | Best Practices |
| Dependencies | [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md) |
## Abstract
Define a standard Validator Manager Solidity smart contract to be deployed on any Avalanche EVM chain.
This ACP relies on concepts introduced in [ACP-77 (Reinventing Subnets)](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets). It depends on it to be marked as `Implementable`.
## Motivation
[ACP-77 (Reinventing Subnets)](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets) opens the door to managing an L1 validator set (stored on the P-Chain) from any chain on the Avalanche Network. The P-Chain allows a Subnet to specify a "validator manager" if it is converted to an L1 using `ConvertSubnetToL1Tx`. This `(blockchainID, address)` pair is responsible for sending ICM messages contained within `RegisterL1ValidatorTx` and `SetL1ValidatorWeightTx` on the P-Chain. This enables an on-chain program to add, modify the weight of, and remove validators.
On each validator set change, the P-Chain is willing to sign an `AddressedCall` to notify any on-chain program tracking the validator set. On-chain programs must be able to interpret this message, so they can trigger the appropriate action. The 2 kinds of `AddressedCall`s [defined in ACP-77](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#p-chain-warp-message-payloads) are `L1ValidatorRegistrationMessage` and `L1ValidatorWeightMessage`.
Given these assumptions and the fact that most of the active blockchains on Avalanche Mainnet are EVM-based, we propose `ACP99Manager` as the standard Solidity contract specification that can:
1. Hold relevant information about the current L1 validator set
2. Send validator set updates to the P-Chain by generating `AdressedCall`s defined in ACP-77
3. Correctly update the validator set by interpreting notification messages received from the P-Chain
4. Be easily integrated into validator manager implementations that utilize various security models (e.g. Proof-of-Stake).
Having an audited and open-source reference implementation freely available will contribute to lowering the cost of launching L1s on Avalanche.
Once deployed, the `ACP99Manager` implementation contract can be used as the `Address` in the [`ConvertSubnetToL1Tx`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#convertsubnettol1tx).
## Specification
> **Note:**: The naming convention followed for the interfaces and contracts are inspired from the way [OpenZeppelin Contracts](https://docs.openzeppelin.com/contracts/5.x/) are named after ERC standards, using `ACP` instead of `ERC`.
### Type Definitions
The following type definitions are used in the function signatures described in [Contract Specification](#contract-specification)
```solidity
/**
* @notice Description of the conversion data used to convert
* a subnet to an L1 on the P-Chain.
* This data is the pre-image of a hash that is authenticated by the P-Chain
* and verified by the Validator Manager.
*/
struct ConversionData {
bytes32 subnetID;
bytes32 validatorManagerBlockchainID;
address validatorManagerAddress;
InitialValidator[] initialValidators;
}
/// @notice Specifies an initial validator, used in the conversion data.
struct InitialValidator {
bytes nodeID;
bytes blsPublicKey;
uint64 weight;
}
/// @notice L1 validator status.
enum ValidatorStatus {
Unknown,
PendingAdded,
Active,
PendingRemoved,
Completed,
Invalidated
}
/**
* @notice Specifies the owner of a validator's remaining balance or disable owner on the P-Chain.
* P-Chain addresses are also 20-bytes, so we use the address type to represent them.
*/
struct PChainOwner {
uint32 threshold;
address[] addresses;
}
/**
* @notice Contains the active state of a Validator.
* @param status The validator status.
* @param nodeID The NodeID of the validator.
* @param startingWeight The weight of the validator at the time of registration.
* @param sentNonce The current weight update nonce sent by the manager.
* @param receivedNonce The highest nonce received from the P-Chain.
* @param weight The current weight of the validator.
* @param startTime The start time of the validator.
* @param endTime The end time of the validator.
*/
struct Validator {
ValidatorStatus status;
bytes nodeID;
uint64 startingWeight;
uint64 sentNonce;
uint64 receivedNonce;
uint64 weight;
uint64 startTime;
uint64 endTime;
}
```
#### About `Validator`s
A `Validator` represents the continuous time frame during which a node is part of the validator set.
Each `Validator` is identified by its `validationID`. If a validator was added as part of the initial set of continuous dynamic fee paying validators, its `validationID` is the SHA256 hash of the 36 bytes resulting from concatenating the 32 byte `ConvertSubnetToL1Tx` transaction ID and the 4 byte index of the initial validator within the transaction. If a validator was added to the L1's validator set post-conversion, its `validationID` is the SHA256 of the payload of the `AddressedCall` in the `RegisterL1ValidatorTx` used to add it, as defined in ACP-77.
### Contract Specification
The standard `ACP99Manager` functionality is defined by a set of events, public methods, and private methods that must be included by a compliant implementation.
For a full implementation, please see the [Reference Implementation](#reference-implementation)
#### Events
```solidity
/**
* @notice Emitted when an initial validator is registered.
* @notice The field index is the index of the initial validator in the conversion data.
* This is used along with the subnetID as the ACP-118 justification in
* signature requests to P-Chain validators over a L1ValidatorRegistrationMessage
* when removing the validator
*/
event RegisteredInitialValidator(
bytes32 indexed validationID,
bytes20 indexed nodeID,
bytes32 indexed subnetID,
uint64 weight,
uint32 index
);
/// @notice Emitted when a validator registration to the L1 is initiated.
event InitiatedValidatorRegistration(
bytes32 indexed validationID,
bytes20 indexed nodeID,
bytes32 registrationMessageID,
uint64 registrationExpiry,
uint64 weight
);
/// @notice Emitted when a validator registration to the L1 is completed.
event CompletedValidatorRegistration(bytes32 indexed validationID, uint64 weight);
/// @notice Emitted when removal of an L1 validator is initiated.
event InitiatedValidatorRemoval(
bytes32 indexed validationID,
bytes32 validatorWeightMessageID,
uint64 weight,
uint64 endTime
);
/// @notice Emitted when removal of an L1 validator is completed.
event CompletedValidatorRemoval(bytes32 indexed validationID);
/// @notice Emitted when a validator weight update is initiated.
event InitiatedValidatorWeightUpdate(
bytes32 indexed validationID, uint64 nonce, bytes32 weightUpdateMessageID, uint64 weight
);
/// @notice Emitted when a validator weight update is completed.
event CompletedValidatorWeightUpdate(bytes32 indexed validationID, uint64 nonce, uint64 weight);
```
#### Public Methods
```solidity
/// @notice Returns the SubnetID of the L1 tied to this manager
function subnetID() public view returns (bytes32 id);
/// @notice Returns the validator details for a given validation ID.
function getValidator(bytes32 validationID)
public
view
returns (Validator memory validator);
/// @notice Returns the total weight of the current L1 validator set.
function l1TotalWeight() public view returns (uint64 weight);
/**
* @notice Verifies and sets the initial validator set for the chain by consuming a
* SubnetToL1ConversionMessage from the P-Chain.
*
* Emits a {RegisteredInitialValidator} event for each initial validator in {conversionData}.
*
* @param conversionData The Subnet conversion message data used to recompute and verify against the ConversionID.
* @param messsageIndex The index that contains the SubnetToL1ConversionMessage ICM message containing the
* ConversionID to be verified against the provided {conversionData}.
*/
function initializeValidatorSet(
ConversionData calldata conversionData,
uint32 messsageIndex
) public;
/**
* @notice Completes the validator registration process by returning an acknowledgement of the registration of a
* validationID from the P-Chain. The validator should not be considered active until this method is successfully called.
*
* Emits a {CompletedValidatorRegistration} event on success.
*
* @param messageIndex The index of the L1ValidatorRegistrationMessage to be received providing the acknowledgement.
* @return validationID The ID of the registered validator.
*/
function completeValidatorRegistration(uint32 messageIndex)
public
returns (bytes32 validationID);
/**
* @notice Completes validator removal by consuming an RegisterL1ValidatorMessage from the P-Chain acknowledging
* that the validator has been removed.
*
* Emits a {CompletedValidatorRemoval} on success.
*
* @param messageIndex The index of the RegisterL1ValidatorMessage.
*/
function completeValidatorRemoval(uint32 messageIndex)
public
returns (bytes32 validationID);
/**
* @notice Completes the validator weight update process by consuming an L1ValidatorWeightMessage from the P-Chain
* acknowledging the weight update. The validator weight change should not have any effect until this method is successfully called.
*
* Emits a {CompletedValidatorWeightUpdate} event on success.
*
* @param messageIndex The index of the L1ValidatorWeightMessage message to be received providing the acknowledgement.
* @return validationID The ID of the validator, retreived from the L1ValidatorWeightMessage.
* @return nonce The nonce of the validator, retreived from the L1ValidatorWeightMessage.
*/
function completeValidatorWeightUpdate(uint32 messageIndex)
public
returns (bytes32 validationID, uint64 nonce);
```
>Note: While `getValidator` provides a way to fetch a `Validator` based on its `validationID`, no method that returns all active validators is specified. This is because a `mapping` is a reasonable way to store active validators internally, and Solidity `mapping`s are not iterable. This can be worked around by storing additional indexing metadata in the contract, but not all applications may wish to incur that added complexity.
#### Private Methods
The following methods are specified as `internal` to account for different semantics of initiating validator set changes, such as checking uptime attested to via ICM message, or transferring funds to be locked as stake. Rather than broaden the definitions of these functions to cover all use cases, we leave it to the implementer to define a suitable external interface and call the appropriate `ACP99Manager` function internally.
```solidity
/**
* @notice Initiates validator registration by issuing a RegisterL1ValidatorMessage. The validator should
* not be considered active until completeValidatorRegistration is called.
*
* Emits an {InitiatedValidatorRegistration} event on success.
*
* @param nodeID The ID of the node to add to the L1.
* @param blsPublicKey The BLS public key of the validator.
* @param remainingBalanceOwner The remaining balance owner of the validator.
* @param disableOwner The disable owner of the validator.
* @param weight The weight of the node on the L1.
* @return validationID The ID of the registered validator.
*/
function _initiateValidatorRegistration(
bytes memory nodeID,
bytes memory blsPublicKey,
PChainOwner memory remainingBalanceOwner,
PChainOwner memory disableOwner,
uint64 weight
) internal returns (bytes32 validationID);
/**
* @notice Initiates validator removal by issuing a L1ValidatorWeightMessage with the weight set to zero.
* The validator should be considered inactive as soon as this function is called.
*
* Emits an {InitiatedValidatorRemoval} on success.
*
* @param validationID The ID of the validator to remove.
*/
function _initiateValidatorRemoval(bytes32 validationID) internal;
/**
* @notice Initiates a validator weight update by issuing an L1ValidatorWeightMessage with a nonzero weight.
* The validator weight change should not have any effect until completeValidatorWeightUpdate is successfully called.
*
* Emits an {InitiatedValidatorWeightUpdate} event on success.
*
* @param validationID The ID of the validator to modify.
* @param weight The new weight of the validator.
* @return nonce The validator nonce associated with the weight change.
* @return messageID The ID of the L1ValidatorWeightMessage used to update the validator's weight.
*/
function _initiateValidatorWeightUpdate(
bytes32 validationID,
uint64 weight
) internal returns (uint64 nonce, bytes32 messageID);
```
##### About `DisableL1ValidatorTx`
In addition to calling `_initiateValidatorRemoval`, a validator may be disabled by issuing a `DisableL1ValidatorTx` on the P-Chain. This transaction allows the `DisableOwner` of a validator to disable it directly from the P-Chain to claim the unspent `Balance` linked to the validator of a failed L1. Therefore it is not meant to be called in the `Manager` contract.
## Backwards Compatibility
`ACP99Manager` is a reference specification. As such, it doesn't have any impact on the current behavior of the Avalanche protocol.
## Reference Implementation
A reference implementation will be provided in Ava Labs' [ICM Contracts](https://github.com/ava-labs/icm-contracts/tree/main/contracts/validator-manager) repository. This reference implementation will need to be updated to conform to `ACP99Manager` before this ACP may be marked `Implementable`.
### Example Integrations
`ACP99Manager` is designed to be easily incorporated into any architecture. Two example integrations are included in this ACP, each of which uses a different architecture.
#### Multi-contract Design
The multi-contract design consists of a contract that implements `ACP99Manager`, and separate "security module" contracts that implement security models, such as PoS or PoA. Each `ACP99Manager` implementation contract is associated with one or more "security modules" that are the only contracts allowed to call the `ACP99Manager` functions that initiate validator set changes (`initiateValidatorRegistration`, and `initiateValidatorWeightUpdate`). Every time a validator is added/removed or a weight change is initiated, the `ACP99Manager` implementation will, in turn, call the corresponding function of the "security module" (`handleValidatorRegistration` or `handleValidatorWeightChange`). We recommend that the "security modules" reference an immutable `ACP99Manager` contract address for security reasons.
It is up to the "security module" to decide what action to take when a validator is added/removed or a weight change is confirmed by the P-Chain. Such actions could be starting the withdrawal period and allocating rewards in a PoS L1.
|Own| SecurityModule
Safe -.->|Own| Manager
SecurityModule <-.->|Reference| Manager
Safe -->|addValidator| SecurityModule
SecurityModule -->|initiateValidatorRegistration| Manager
Manager -->|sendWarpMessage| P
P -->|completeValidatorRegistration| Manager
Manager -->|handleValidatorRegistration| SecurityModule`} />
"Security modules" could implement PoS, Liquid PoS, etc. The specification of such smart contracts is out of the scope of this ACP.
A work in progress implementation is available in the [Suzaku Contracts Library](https://github.com/suzaku-network/suzaku-contracts-library/blob/main/README.md#acp99-contracts-library) repository. It will be updated until this ACP is considered `Implementable` based on the outcome of the discussion.
Ava Labs' V2 Validator Manager also implements this architecture for a Proof-of-Stake security module, and is available in their [ICM Contracts Repository](https://github.com/ava-labs/icm-contracts/tree/validator-manager-v2.0.0/contracts/validator-manager/StakingManager.sol).
#### Single-contract Design
The single-contract design consists of a class hierarchy with the base class implementing `ACP99Manager`. The `PoAValidatorManager` child class in the below diagram may be swapped out for another class implementing a different security model, such as PoS.
> ACP99Manager
class ValidatorManager {
completeValidatorRegistration
}
<> ValidatorManager
class PoAValidatorManager {
initiateValidatorRegistration
initiateEndValidation
completeEndValidation
}
ACP99Manager <|--ValidatorManager
ValidatorManager <|-- PoAValidatorManager`} />
No reference implementation is provided for this architecture in particular, but Ava Labs' V1 [Validator Manager](https://github.com/ava-labs/icm-contracts/tree/validator-manager-v1.0.0/contracts/validator-manager) implements much of the functional behavior described by the specification. It predates the specification, however, so there are some deviations. It should at most be treated as a model of an approximate implementation of this standard.
## Security Considerations
The audit process of `ACP99Manager` and reference implementations is of the utmost importance for the future of the Avalanche ecosystem as most L1s would rely upon it to secure their L1.
## Open Questions
### Is there an interest to keep historical information about the validator set on the manager chain?
It is left to the implementor to decide if `getValidator` should return information about historical validators. Information about past validator performance may not be relevant for all applications (e.g. PoA has no need to know about past validator's uptimes). This information will still be available in archive nodes and offchain tools (e.g. explorers), but it is not enforced at the contract level.
### Should `ACP99Manager` include a churn control mechanism?
The Ava Labs [implementation](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/ValidatorManager.sol) of the `ValidatorManager` contract includes a churn control mechanism that prevents too much weight from being added or removed from the validator set in a short amount of time. Excessive churn can cause consensus failures, so it may be appropriate to require that churn tracking is implemented in some capacity.
## Acknowledgments
Special thanks to [@leopaul36](https://github.com/leopaul36), [@aaronbuchwald](https://github.com/aaronbuchwald), [@dhrubabasu](https://github.com/dhrubabasu), [@minghinmatthewlam](https://github.com/minghinmatthewlam) and [@michaelkaplan13](https://github.com/michaelkaplan13) for their reviews of previous versions of this ACP!
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
# Avalanche Community Proposals (ACPs) (/docs/acps)
---
title: "Avalanche Community Proposals (ACPs)"
description: "Official framework for proposing improvements and gathering consensus around changes to the Avalanche Network"
edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/README.md
---
>
## What is an Avalanche Community Proposal (ACP)?
An Avalanche Community Proposal is a concise document that introduces a change or best practice for adoption on the [Avalanche Network](https://www.avax.com). ACPs should provide clear technical specifications of any proposals and a compelling rationale for their adoption.
ACPs are an open framework for proposing improvements and gathering consensus around changes to the Avalanche Network. ACPs can be proposed by anyone and will be merged into this repository as long as they are well-formatted and coherent. Once an overwhelming majority of the Avalanche Network/Community have [signaled their support for an ACP](https://docs.avax.network/nodes/configure/avalanchego-config-flags#avalanche-community-proposals), it may be scheduled for activation on the Avalanche Network by Avalanche Network Clients (ANCs). It is ultimately up to members of the Avalanche Network/Community to adopt ACPs they support by running a compatible ANC, such as [AvalancheGo](https://github.com/ava-labs/avalanchego).
## ACP Tracks
There are three kinds of ACP:
* A `Standards Track` ACP describes a change to the design or function of the Avalanche Network, such as a change to the P2P networking protocol, P-Chain design, Subnet architecture, or any change/addition that affects the interoperability of Avalanche Network Clients (ANCs).
* A `Best Practices Track` ACP describes a design pattern or common interface that should be used across the Avalanche Network to make it easier to integrate with Avalanche or for Subnets to interoperate with each other. This would include things like proposing a smart contract interface, not proposing a change to how smart contracts are executed.
* A `Meta Track` ACP describes a change to the ACP process or suggests a new way for the Avalanche Community to collaborate.
* A `Subnet Track` ACP describes a change to a particular Subnet. This would include things like configuration changes or coordinated Subnet upgrades.
## ACP Statuses
There are four statuses of an ACP:
* A `Proposed` ACP has been merged into the main branch of the ACP repository. It is actively being discussed by the Avalanche Community and may be modified based on feedback.
* An `Implementable` ACP is considered "ready for implementation" by the author(s) and will no longer change meaningfully from its current form (which would require a new ACP).
* An `Activated` ACP has been activated on the Avalanche Network via a coordinated upgrade by the Avalanche Community. Once an ACP is `Activated`, it is locked.
* A `Stale` ACP has been abandoned by its author(s) because it is not supported by the Avalanche Community or has been replaced with another ACP.
## ACP Workflow
### Step 0: Think of a Novel Improvement to Avalanche
The ACP process begins with a new idea for Avalanche. Each potential ACP must have an author(s): someone who writes the ACP using the style and format described below, shepherds the associated GitHub Discussion, and attempts to build consensus around the idea. Note that ideas and any resulting ACP is public. Authors should not post any ideas or anything in an ACP that the Author wants to keep confidential or to keep ownership rights in (such as intellectual property rights).
### Step 1: Post Your Idea to [GitHub Discussions](https://github.com/avalanche-foundation/ACPs/discussions/categories/ideas)
The author(s) should first attempt to ascertain whether there is support for their idea by posting in the "Ideas" category of GitHub Discussions. Vetting an idea publicly before going as far as writing an ACP is meant to save both the potential author(s) and the wider Avalanche Community time. Asking the Avalanche Community first if an idea is original helps prevent too much time being spent on something that is guaranteed to be rejected based on prior discussions (searching the Internet does not always do the trick). It also helps to make sure the idea is applicable to the entire community and not just the author(s). Small enhancements or patches often don't need standardization between multiple projects; these don't need an ACP and should be injected into the relevant development workflow with a patch submission to the applicable ANC issue tracker.
### Step 2: Propose an ACP via [Pull Request](https://github.com/avalanche-foundation/ACPs/pulls)
Once the author(s) feels confident that an idea has a decent chance of acceptance, an ACP should be drafted and submitted as a pull request (PR). This draft must be written in ACP style as described below. It is highly recommended that a single ACP contain a single key proposal or new idea. The more focused the ACP, the more successful it tends to be. If in doubt, split your ACP into several well-focused ones. The PR number of the ACP will become its assigned number.
### Step 3: Build Consensus on [GitHub Discussions](https://github.com/avalanche-foundation/ACPs/discussions/categories/discussion) and Provide an Implementation (if Applicable)
ACPs will be merged by ACP maintainers if the proposal is generally well-formatted and coherent. ACP editors will attempt to merge anything worthy of discussion, regardless of feasibility or complexity, that is not a duplicate or incomplete. After an ACP is merged, an official GitHub Discussion will be opened for the ACP and linked to the proposal for community discussion. It is recommended for author(s) or supportive Avalanche Community members to post an accompanying non-technical overview of their ACP for general consumption in this GitHub Discussion. The ACP should be reviewed and broadly supported before a reference implementation is started, again to avoid wasting the author(s) and the Avalanche Community's time, unless a reference implementation will aid people in studying the ACP.
### Step 4: Mark ACP as `Implementable` via [Pull Request](https://github.com/avalanche-foundation/ACPs/pulls)
Once an ACP is considered complete by the author(s), it should be marked as `Implementable`. At this point, all open questions should be addressed and an associated reference implementation should be provided (if applicable). As mentioned earlier, the Avalanche Foundation meets periodically to recommend the ratification of specific ACPs but it is ultimately up to members of the Avalanche Network/Community to adopt ACPs they support by running a compatible Avalanche Network Client (ANC), such as [AvalancheGo](https://github.com/ava-labs/avalanchego).
### [Optional] Step 5: Mark ACP as `Stale` via [Pull Request](https://github.com/avalanche-foundation/ACPs/pulls)
An ACP can be superseded by a different ACP, rendering the original obsolete. If this occurs, the original ACP will be marked as `Stale`. ACPs may also be marked as `Stale` if the author(s) abandon work on it for a prolonged period of time (12+ months). ACPs may be reopened and moved back to `Proposed` if the author(s) restart work.
### Maintenance
ACP maintainers will only merge PRs updating an ACP if it is created or approved by at least one of the author(s). ACP maintainers are not responsible for ensuring ACP author(s) approve the PR. ACP author(s) are expected to review PRs that target their unlocked ACP (`Proposed` or `Implementable`). Any PRs opened against a locked ACP (`Activated` or `Stale`) will not be merged by ACP maintainers.
## What belongs in a successful ACP?
Each ACP must have the following parts:
* `Preamble`: Markdown table containing metadata about the ACP, including the ACP number, a short descriptive title, the author(s), and optionally the contact info for each author, etc.
* `Abstract`: Concise (~200 word) description of the ACP
* `Motivation`: Rationale for adopting the ACP and the specific issue/challenge/opportunity it addresses
* `Specification`: Complete description of the semantics of any change should allow any ANC/Avalanche Community member to implement the ACP
* `Security Considerations`: Security implications of the proposed ACP
Each ACP can have the following parts:
* `Open Questions`: Questions that should be resolved before implementation
Each `Standards Track` ACP must have the following parts:
* `Backwards Compatibility`: List of backwards incompatible changes required to implement the ACP and their impact on the Avalanche Community
* `Reference Implementation`: Code, documentation, and telemetry (from a local network) of the ACP change
Each `Best Practices Track` ACP can have the following parts:
* `Backwards Compatibility`: List of backwards incompatible changes required to implement the ACP and their impact on the Avalanche Community
* `Reference Implementation`: Code, documentation, and telemetry (from a local network) of the ACP change
### ACP Formats and Templates
Each ACP is allocated a unique subdirectory in the `ACPs` directory. The name of this subdirectory must be of the form `N-T` where `N` is the ACP number and `T` is the ACP title with any spaces replaced by hyphens. ACPs must be written in [markdown](https://daringfireball.net/projects/markdown/syntax) format and stored at `ACPs/N-T/README.md`. Please see the [ACP template](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/TEMPLATE.md) for an example of the correct layout.
### Auxiliary Files
ACPs may include auxiliary files such as diagrams or code snippets. Such files should be stored in the ACP's subdirectory (`ACPs/N-T/*`). There is no required naming convention for auxiliary files.
### Waived Copyright
ACP authors must waive any copyright claims before an ACP will be merged into the repository. This can be done by including the following text in an ACP:
```text
## Copyright
Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/).
```
## Proposals
_You can view the status of each ACP on the [ACP Tracker](https://github.com/orgs/avalanche-foundation/projects/1/views/1)._
| Number | Title | Author(s) | Type |
|:-------|:------|:-------|:-----|
|[13](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/13-subnet-only-validators/README.md)|Subnet-Only Validators (SOVs)|Patrick O'Grady (contact@patrickogrady.xyz)|Standards|
|[20](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/20-ed25519-p2p/README.md)|Ed25519 p2p|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards|
|[23](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/23-p-chain-native-transfers/README.md)|P-Chain Native Transfers|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards|
|[24](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/24-shanghai-eips/README.md)|Activate Shanghai EIPs on C-Chain|Darioush Jalali ([@darioush](https://github.com/darioush))|Standards|
|[25](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/25-vm-application-errors/README.md)|Virtual Machine Application Errors|Joshua Kim ([@joshua-kim](https://github.com/joshua-kim))|Standards|
|[30](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/30-avalanche-warp-x-evm/README.md)|Integrate Avalanche Warp Messaging into the EVM|Aaron Buchwald (aaron.buchwald56@gmail.com)|Standards|
|[31](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/31-enable-subnet-ownership-transfer/README.md)|Enable Subnet Ownership Transfer|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards|
|[41](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/41-remove-pending-stakers/README.md)|Remove Pending Stakers|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards|
|[62](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/62-disable-addvalidatortx-and-adddelegatortx/README.md)|Disable `AddValidatorTx` and `AddDelegatorTx`|Jacob Everly (https://twitter.com/JacobEv3rly), Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards|
|[75](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/75-acceptance-proofs/README.md)|Acceptance Proofs|Joshua Kim ([@joshua-kim](https://github.com/joshua-kim))|Standards|
|[77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md)|Reinventing Subnets|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards|
|[83](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/83-dynamic-multidimensional-fees/README.md)|Dynamic Multidimensional Fees for P-Chain and X-Chain|Alberto Benegiamo ([@abi87](https://github.com/abi87))|Standards|
|[84](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md)|Table Preamble for ACPs|Gauthier Leonard ([@Nuttymoon](https://github.com/Nuttymoon))|Meta|
|[99](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/99-validatorsetmanager-contract/README.md)|Validator Manager Solidity Standard|Gauthier Leonard ([@Nuttymoon](https://github.com/Nuttymoon)), Cam Schultz ([@cam-schultz](https://github.com/cam-schultz))|Best Practices|
|[103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md)|Add Dynamic Fees to the X-Chain and P-Chain|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)), Alberto Benegiamo ([@abi87](https://github.com/abi87)), Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph))|Standards|
|[108](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/108-evm-event-importing/README.md)|EVM Event Importing|Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13))|Best Practices|
|[113](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/113-provable-randomness/README.md)|Provable Virtual Machine Randomness|Tsachi Herman ([@tsachiherman](https://github.com/tsachiherman))|Standards|
|[118](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/118-warp-signature-request/README.md)|Standardized P2P Warp Signature Request Interface|Cam Schultz ([@cam-schultz](https://github.com/cam-schultz))|Best Practices|
|[125](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/125-basefee-reduction/README.md)|Reduce C-Chain minimum base fee from 25 nAVAX to 1 nAVAX|Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Darioush Jalali ([@darioush](https://github.com/darioush))|Standards|
|[131](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/131-cancun-eips/README.md)|Activate Cancun EIPs on C-Chain and Subnet-EVM chains|Darioush Jalali ([@darioush](https://github.com/darioush)), Ceyhun Onur ([@ceyonur](https://github.com/ceyonur))|Standards|
|[151](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/151-use-current-block-pchain-height-as-context/README.md)|Use current block P-Chain height as context for state verification|Ian Suvak ([@iansuvak](https://github.com/iansuvak))|Standards|
|[176](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/176-dynamic-evm-gas-limit-and-price-discovery-updates/README.md)|Dynamic EVM Gas Limits and Price Discovery Updates|Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13))|Standards|
|[181](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/181-p-chain-epoched-views/README.md)|P-Chain Epoched Views|Cam Schultz ([@cam-schultz](https://github.com/cam-schultz))|Standards|
|[191](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/191-seamless-l1-creation/README.md)|Seamless L1 Creations (CreateL1Tx)|Martin Eckardt ([@martineckardt](https://github.com/martineckardt)), Aaron Buchwald ([aaronbuchwald](https://github.com/aaronbuchwald)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)), Meag FitzGerald ([@meaghanfitzgerald](https://github.com/meaghanfitzgerald))|Standards|
|[194](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/194-streaming-asynchronous-execution/README.md)|Streaming Asynchronous Execution|Arran Schlosberg ([@ARR4N](https://github.com/ARR4N)), Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph))|Standards|
|[204](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/204-precompile-secp256r1/README.md)|Precompile for secp256r1 Curve Support|Santiago Cammi ([@scammi](https://github.com/scammi)), Arran Schlosberg ([@ARR4N](https://github.com/ARR4N))|Standards|
|[209](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/209-eip7702-style-account-abstraction/README.md)|EIP-7702-style Set Code for EOAs|Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Arran Schlosberg ([@ARR4N](https://github.com/ARR4N)), Aaron Buchwald ([aaronbuchwald](https://github.com/aaronbuchwald)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13))|Standards|
|[224](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/224-dynamic-gas-limit-in-subnet-evm/README.md)|Introduce ACP-176-Based Dynamic Gas Limits and Fee Manager Precompile in Subnet-EVM|Ceyhun Onur ([@ceyonur](https://github.com/ceyonur), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13))|Standards|
|[226](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/226-dynamic-minimum-block-times/README.md)|Dynamic Minimum Block Times|Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13))|Standards|
|[236](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/236-continuous-staking/README.md)|Continuous Staking |Razvan Angheluta ([@rrazvan1](https://github.com/rrazvan1))|Standards|
|[247](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/247-delegation-multiplier-increase-maximum-validator-weight-reduction/README.md)|Delegation Multiplier Increase & Maximum Validator Weight Reduction|Giacomo Barbieri ([@ijaack94](https://x.com/ijaack94)), BENQI ([@benqifinance](https://x.com/benqifinance))|Standards|
## Contributing
Before contributing to ACPs, please read the [ACP Terms of Contribution](https://github.com/avalanche-foundation/ACPs/blob/main/CONTRIBUTING.md).
# Introduction (/docs/nodes)
---
title: Introduction
description: A brief introduction to the concepts of nodes and validators within the Avalanche ecosystem.
---
AvalancheGo nodes relay transactions/blocks, expose APIs, and (when staked) participate in consensus on the Primary Network and any Avalanche L1s they validate.
## Node Roles
| Role | Purpose | Consensus Participation |
|------|---------|-------------------------|
| **Validator** | Stakes on the P-Chain, validates the Primary Network and any Subnets/L1s it joins | Yes (polled for Snowman/Snowman++) |
| **Non-validating** | Tracks chains, serves APIs, used for infra and indexing | No (not polled) |
All nodes: connect via P2P with staking certs, track P/C/X, bootstrap or state-sync chains, and serve APIs if enabled.
## Data Retention Modes
| Mode | Description | When to use |
|------|-------------|------------|
| **Archive** | Keep full history | Auditing, full re-exec |
| **Pruned** | Drop old data after sync | Save disk on long-running nodes |
| **State sync** | Sync from state summaries instead of full replay | Fast catch-up for new nodes |
Choose per-chain via chain configs.
## Validator Requirements
| Network | Requirements |
|---------|--------------|
| **Primary Network** | Stake **2,000 AVAX** on the P-Chain; validation period **14–365 days**; meet uptime to earn rewards; must validate P-Chain, C-Chain, X-Chain |
| **Avalanche L1s** | Validators pay **1.33 AVAX/month** (burned) to the P-Chain for validation slots; each L1 sets its own validation/staking rules beyond that. |
Avalanche L1s are blockchains that run on a Subnet. When you validate a Subnet, you validate all Avalanche L1s on that Subnet.
### Validator Responsibilities
- **Validate & build blocks**: Participate in Snowman++ consensus (all Primary Network chains and most L1s).
- **Maintain APIs**: Serve RPCs for wallets/apps if enabled.
- **Stay healthy**: Meet uptime and networking requirements to remain in good standing and earn rewards.
# AvalancheGo Releases (/docs/nodes/releases)
---
title: AvalancheGo Releases
description: Track AvalancheGo releases, network upgrades, and version compatibility for your node.
---
This page is automatically generated from the [AvalancheGo GitHub releases](https://github.com/ava-labs/avalanchego/releases).
## Current Recommended Version
| Network | Version | Release Name | Type |
|---------|---------|--------------|------|
| **Mainnet** | v1.14.0 | Granite - Improving ICM and Dynamic Block Times | Stable |
| **Fuji Testnet** | v1.14.0 | Granite - Improving ICM and Dynamic Block Times | Stable |
**Always run the latest stable release** unless you're specifically testing pre-release versions on Fuji.
## Using the Installer Script
The [AvalancheGo installer script](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go) supports installing specific versions.
### List Available Versions
```bash
./avalanchego-installer.sh --list
```
### Install a Specific Version
```bash
./avalanchego-installer.sh --version v1.14.0
```
### Upgrade Existing Installation
Simply run the installer script again to upgrade to the latest version:
```bash
./avalanchego-installer.sh
```
## Recent Releases
### v1.14.0 - Granite - Improving ICM and Dynamic Block Times
**Released:** November 5, 2025 | [View on GitHub](https://github.com/ava-labs/avalanchego/releases/tag/v1.14.0)
This release schedules the activation of the following Avalanche Community Proposals (ACPs):
- [ACP-181](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/181-p-chain-epoched-views/README.md) P-Chain Epoched Views
- [ACP-204](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/20...
**ACPs Included:** ACP-181, ACP-204, ACP-226, ACP-176
| Platform | File | Size |
|----------|------|------|
| Linux (AMD64) | [avalanchego-linux-amd64-v1.14.0.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.14.0/avalanchego-linux-amd64-v1.14.0.tar.gz) | 41.5 MB |
| Linux (ARM64) | [avalanchego-linux-arm64-v1.14.0.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.14.0/avalanchego-linux-arm64-v1.14.0.tar.gz) | 39.0 MB |
| macOS | [avalanchego-macos-v1.14.0.zip](https://github.com/ava-labs/avalanchego/releases/download/v1.14.0/avalanchego-macos-v1.14.0.zip) | 41.4 MB |
### v1.14.0-fuji - Granite - Improving ICM and Dynamic Block Times - Fuji Pre-Release (Pre-release)
**Released:** October 21, 2025 | [View on GitHub](https://github.com/ava-labs/avalanchego/releases/tag/v1.14.0-fuji)
**ACPs Included:** ACP-181, ACP-204, ACP-226, ACP-176
| Platform | File | Size |
|----------|------|------|
| Linux (AMD64) | [avalanchego-linux-amd64-v1.14.0-fuji.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.14.0-fuji/avalanchego-linux-amd64-v1.14.0-fuji.tar.gz) | 41.6 MB |
| Linux (ARM64) | [avalanchego-linux-arm64-v1.14.0-fuji.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.14.0-fuji/avalanchego-linux-arm64-v1.14.0-fuji.tar.gz) | 39.1 MB |
| macOS | [avalanchego-macos-v1.14.0-fuji.zip](https://github.com/ava-labs/avalanchego/releases/download/v1.14.0-fuji/avalanchego-macos-v1.14.0-fuji.zip) | 41.4 MB |
### v1.13.5 - Fortuna.5 - Mempool Rate Limiting Improvements
**Released:** August 29, 2025 | [View on GitHub](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.5)
This version is backwards compatible to [v1.13.0](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.0). It is optional, but encouraged.
The plugin version is unchanged at `43` and is compatible with version `v1.13.4`.
| Platform | File | Size |
|----------|------|------|
| Linux (AMD64) | [avalanchego-linux-amd64-v1.13.5.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.5/avalanchego-linux-amd64-v1.13.5.tar.gz) | 40.2 MB |
| Linux (ARM64) | [avalanchego-linux-arm64-v1.13.5.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.5/avalanchego-linux-arm64-v1.13.5.tar.gz) | 37.9 MB |
| macOS | [avalanchego-macos-v1.13.5.zip](https://github.com/ava-labs/avalanchego/releases/download/v1.13.5/avalanchego-macos-v1.13.5.zip) | 40.0 MB |
### v1.13.4 - Fortuna.4 - Cubist Signer Integration
**Released:** August 1, 2025 | [View on GitHub](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.4)
This version is backwards compatible to [v1.13.0](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.0). It is optional, but encouraged.
The plugin version is updated to `43` all plugins must update to be compatible.
| Platform | File | Size |
|----------|------|------|
| Linux (AMD64) | [avalanchego-linux-amd64-v1.13.4.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.4/avalanchego-linux-amd64-v1.13.4.tar.gz) | 40.3 MB |
| Linux (ARM64) | [avalanchego-linux-arm64-v1.13.4.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.4/avalanchego-linux-arm64-v1.13.4.tar.gz) | 38.0 MB |
| macOS | [avalanchego-macos-v1.13.4.zip](https://github.com/ava-labs/avalanchego/releases/download/v1.13.4/avalanchego-macos-v1.13.4.zip) | 40.1 MB |
### v1.13.3 - Fortuna.3 - ToEngine Channel Removal
**Released:** July 22, 2025 | [View on GitHub](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.3)
This version is backwards compatible to [v1.13.0](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.0). It is optional, but encouraged.
The plugin version is updated to `42` all plugins must update to be compatible.
**This release removes the support for running on Windows. Any users ...
| Platform | File | Size |
|----------|------|------|
| Linux (AMD64) | [avalanchego-linux-amd64-v1.13.3.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.3/avalanchego-linux-amd64-v1.13.3.tar.gz) | 39.2 MB |
| Linux (ARM64) | [avalanchego-linux-arm64-v1.13.3.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.3/avalanchego-linux-arm64-v1.13.3.tar.gz) | 36.9 MB |
| macOS | [avalanchego-macos-v1.13.3.zip](https://github.com/ava-labs/avalanchego/releases/download/v1.13.3/avalanchego-macos-v1.13.3.zip) | 38.9 MB |
### v1.13.2 - Fortuna.2 - VM HTTP2 Support
**Released:** June 24, 2025 | [View on GitHub](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.2)
This version is backwards compatible to [v1.13.0](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.0). It is optional, but encouraged.
The plugin version is updated to `41` all plugins must update to be compatible.
| Platform | File | Size |
|----------|------|------|
| Linux (AMD64) | [avalanchego-linux-amd64-v1.13.2.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.2/avalanchego-linux-amd64-v1.13.2.tar.gz) | 36.2 MB |
| Linux (ARM64) | [avalanchego-linux-arm64-v1.13.2.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.2/avalanchego-linux-arm64-v1.13.2.tar.gz) | 34.0 MB |
| macOS | [avalanchego-macos-v1.13.2.zip](https://github.com/ava-labs/avalanchego/releases/download/v1.13.2/avalanchego-macos-v1.13.2.zip) | 36.7 MB |
### v1.13.1 - Fortuna.1 - LibEVM Migration
**Released:** June 4, 2025 | [View on GitHub](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.1)
This version is backwards compatible to [v1.13.0](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.0). It is optional, but encouraged.
The plugin version is updated to `40` all plugins must update to be compatible.
**ACPs Included:** ACP-77
| Platform | File | Size |
|----------|------|------|
| Linux (AMD64) | [avalanchego-linux-amd64-v1.13.1.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.1/avalanchego-linux-amd64-v1.13.1.tar.gz) | 36.1 MB |
| Linux (ARM64) | [avalanchego-linux-arm64-v1.13.1.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.1/avalanchego-linux-arm64-v1.13.1.tar.gz) | 33.9 MB |
| macOS | [avalanchego-macos-v1.13.1.zip](https://github.com/ava-labs/avalanchego/releases/download/v1.13.1/avalanchego-macos-v1.13.1.zip) | 36.7 MB |
### v1.13.0 - Fortuna - C-Chain Fee Overhaul
**Released:** March 24, 2025 | [View on GitHub](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.0)
This upgrade consists of the following Avalanche Community Proposal (ACP):
- [ACP-176](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/176-dynamic-evm-gas-limit-and-price-discovery-updates/README.md) Dynamic EVM Gas Limits and Price Discovery Updates
The ACP in this upgrade goes into...
**ACPs Included:** ACP-176, ACP-118
| Platform | File | Size |
|----------|------|------|
| Linux (AMD64) | [avalanchego-linux-amd64-v1.13.0.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.0/avalanchego-linux-amd64-v1.13.0.tar.gz) | 35.5 MB |
| Linux (ARM64) | [avalanchego-linux-arm64-v1.13.0.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.0/avalanchego-linux-arm64-v1.13.0.tar.gz) | 33.4 MB |
| macOS | [avalanchego-macos-v1.13.0.zip](https://github.com/ava-labs/avalanchego/releases/download/v1.13.0/avalanchego-macos-v1.13.0.zip) | 36.0 MB |
### v1.13.0-fuji - Fortuna - C-Chain Fee Overhaul - Fuji Pre-Release (Pre-release)
**Released:** March 6, 2025 | [View on GitHub](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.0-fuji)
**ACPs Included:** ACP-176
| Platform | File | Size |
|----------|------|------|
| Linux (AMD64) | [avalanchego-linux-amd64-v1.13.0-fuji.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.0-fuji/avalanchego-linux-amd64-v1.13.0-fuji.tar.gz) | 35.5 MB |
| Linux (ARM64) | [avalanchego-linux-arm64-v1.13.0-fuji.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.13.0-fuji/avalanchego-linux-arm64-v1.13.0-fuji.tar.gz) | 33.3 MB |
| macOS | [avalanchego-macos-v1.13.0-fuji.zip](https://github.com/ava-labs/avalanchego/releases/download/v1.13.0-fuji/avalanchego-macos-v1.13.0-fuji.zip) | 36.0 MB |
### v1.12.2 - Etna.2 - Keystore Removal
**Released:** January 28, 2025 | [View on GitHub](https://github.com/ava-labs/avalanchego/releases/tag/v1.12.2)
This version is backwards compatible to [v1.12.0](https://github.com/ava-labs/avalanchego/releases/tag/v1.12.0). It is optional, but encouraged.
The plugin version is updated to `39` all plugins must update to be compatible.
**This release removes the support for the long deprecated Keystore A...
| Platform | File | Size |
|----------|------|------|
| Linux (AMD64) | [avalanchego-linux-amd64-v1.12.2.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.12.2/avalanchego-linux-amd64-v1.12.2.tar.gz) | 35.3 MB |
| Linux (ARM64) | [avalanchego-linux-arm64-v1.12.2.tar.gz](https://github.com/ava-labs/avalanchego/releases/download/v1.12.2/avalanchego-linux-arm64-v1.12.2.tar.gz) | 33.1 MB |
| macOS | [avalanchego-macos-v1.12.2.zip](https://github.com/ava-labs/avalanchego/releases/download/v1.12.2/avalanchego-macos-v1.12.2.zip) | 35.7 MB |
## All Releases
For a complete list of all AvalancheGo releases with full changelogs, visit the official [GitHub Releases page](https://github.com/ava-labs/avalanchego/releases).
## Staying Updated
### Avalanche Notify Service
Subscribe to the [Avalanche Notify service](/docs/nodes/maintain/enroll-in-avalanche-notify) to receive email notifications about new releases.
### GitHub Notifications
1. Go to the [AvalancheGo repository](https://github.com/ava-labs/avalanchego)
2. Click **Watch** → **Custom** → Check **Releases** → **Apply**
## Related Resources
- [Upgrade Your Node](/docs/nodes/maintain/upgrade) - Step-by-step upgrade instructions
- [Installing AvalancheGo](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go) - Initial installation guide
- [Backup and Restore](/docs/nodes/maintain/backup-restore) - Backup your node before upgrading
# System Requirements (/docs/nodes/system-requirements)
---
title: System Requirements
description: Hardware, storage, and networking requirements for running Avalanche nodes on the Primary Network and Avalanche L1s.
---
## Primary Network Validators
Running a Primary Network validator requires careful consideration of your stake weight. Validators with higher stake receive more traffic and must process more data, requiring better hardware.
### Storage Requirements
You **must** use a local NVMe SSD attached directly to your hardware with **minimum 3000 IOPS**. Cloud block storage (AWS EBS, GCP Persistent Disk, Azure Managed Disks) introduces latency that causes poor performance, missed blocks, and potential benching. If running in the cloud, use instance types with local NVMe storage (e.g., AWS i3/i4i instances, GCP N2 with local SSD).
New validators should use **state sync** to bootstrap. While full sync from genesis is still possible, state sync is significantly faster—downloading only the active state (~500 GB) rather than replaying all historical blocks.
| Storage Type | Initial Size | Description |
|--------------|--------------|-------------|
| Active State | ~500 GB | Current state required to validate. Downloaded via state sync. |
| Full Archive | ~12.5 TB | Complete historical state. Only needed for archive nodes or block explorers. |
Even with state sync, your node's storage usage will grow over time as new blocks are added and old state accumulates. A node starting at 500 GB can grow to 1 TB+ over months of operation. Plan for this growth when provisioning storage, or schedule periodic maintenance using [state management strategies](/docs/nodes/maintain/chain-state-management).
### Hardware Requirements
Resource requirements scale with your stake weight. Higher stake means more validator duties and network traffic.
| Component | Low Stake Validators | High Stake Validators |
|-----------|---------------------|----------------------|
| **Use Case** | Validators with modest stake delegations who want reliable operation without over-provisioning | Validators with significant stake who handle proportionally more network traffic and validation duties |
| **CPU** | 4 cores / 8 threads (e.g., AMD Ryzen 5, Intel i5) | 8+ cores / 16 threads (e.g., AMD Ryzen 7/9, Intel i7/i9) |
| **RAM** | 16 GB | 32 GB |
| **Storage** | 1 TB NVMe SSD (local, not network-attached) | 2 TB NVMe SSD (local, not network-attached) |
| **Network** | 100 Mbps symmetric, stable connection | 1 Gbps symmetric, low-latency connection |
| **OS** | Ubuntu 22.04 LTS or macOS ≥ 12 | Ubuntu 22.04 LTS or macOS ≥ 12 |
If you're unsure which tier applies to you: start with low-stake specs and monitor performance. If you see high CPU usage, memory pressure, or network saturation, upgrade accordingly.
---
## Avalanche L1 Validators
L1 validators run your own blockchain with custom parameters. Hardware requirements depend on your chain's transaction throughput and state size.
| Component | Low Throughput | Medium Throughput | High Throughput |
|-----------|----------------|-------------------|-----------------|
| **Use Case** | Testnets, development chains, or production L1s with minimal traffic (< 10 TPS) | Production L1s with moderate activity (10–100 TPS), gaming chains, or DeFi applications | High-performance L1s with heavy transaction volume (100+ TPS), large state, or complex smart contracts |
| **CPU** | 2 cores | 4 cores | 8+ cores |
| **RAM** | 4 GB | 8 GB | 16 GB+ |
| **Storage** | 100 GB (SSD optional) | 500 GB SSD | 1 TB+ NVMe SSD |
| **Network** | 25 Mbps | 100 Mbps | 1 Gbps |
| **OS** | Ubuntu 22.04 LTS or macOS ≥ 12 | Ubuntu 22.04 LTS or macOS ≥ 12 | Ubuntu 22.04 LTS or macOS ≥ 12 |
L1 validators sync the P-Chain to track validator sets and cross-chain messages. This adds minimal overhead to the requirements above.
---
## Networking
AvalancheGo requires inbound connections on port `9651`. Before installation, ensure your networking environment is properly configured.
### IPv4 and IPv6 Support
AvalancheGo supports both IPv4 and IPv6:
- **IPv4**: Fully supported and most common
- **IPv6**: Fully supported - your node can operate exclusively on IPv6 or dual-stack
- **Dual-stack**: You can run both IPv4 and IPv6 simultaneously
If using IPv6, ensure your firewall and network configuration properly allow inbound IPv6 connections on port `9651`.
### Cloud Providers
Cloud instances have static IPs by default. Ensure your security group or firewall allows:
- **Inbound**: TCP port 9651 (IPv4 and/or IPv6)
- **Outbound**: All traffic
### Home Connections
Residential connections typically have dynamic IPs. You'll need to:
1. Configure port forwarding for port `9651` on your router
2. Consider a dynamic DNS service if your IP changes frequently
A fully connected Avalanche node maintains thousands of live TCP connections. Under-powered home routers may struggle with this load, causing lag on other devices or node synchronization issues.
---
## Monitoring Thresholds
Set up monitoring and alerts to catch resource issues before they impact your validator:
| Resource | Warning Threshold | Critical Threshold | Action Required |
|----------|------------------|-------------------|-----------------|
| **Disk Usage** | 80% | 90% | Run [offline pruning](/docs/nodes/maintain/reduce-disk-usage) or [state sync](/docs/nodes/maintain/chain-state-management) |
| **CPU Usage** | 70% sustained | 90% sustained | Upgrade to higher-tier instance or optimize workload |
| **Memory Usage** | 80% | 90% | Upgrade RAM or investigate memory leaks |
| **Network Bandwidth** | 80% of capacity | 95% of capacity | Upgrade network tier or reduce other network traffic |
| **Disk IOPS** | 80% of available | 95% of available | Upgrade to higher IOPS storage |
**Disk usage** is the most common issue for validators. Consider setting up automated alerts at 80% to give yourself time to plan maintenance before your node runs out of space.
---
## Next Steps
- Learn about [Active State vs Archive State](/docs/nodes/maintain/chain-state-management) to understand storage requirements
- Set up [node monitoring](/docs/nodes/maintain/monitoring) to track resource usage and configure alerts
# Snowman Consensus (/docs/primary-network/avalanche-consensus)
---
title: Snowman Consensus
description: Learn about the Snowman Consensus protocol.
---
Consensus is the task of getting a group of computers (a.k.a. nodes) to come to an agreement on a decision. In blockchain, this means that all the participants in a network have to agree on the changes made to the shared ledger.
This agreement is reached through a specific process, a consensus protocol, that ensures that everyone sees the same information and that the information is accurate and trustworthy.
## Snowman Consensus
Snowman Consensus is a consensus protocol that is scalable, robust, and decentralized. It combines features of both classical and Nakamoto consensus mechanisms to achieve high throughput, fast finality, and energy efficiency. For the whitepaper, see [here](https://www.avalabs.org/whitepapers).
Key Features Include:
- Speed: Snowman Consensus provides sub-second, immutable finality, ensuring that transactions are quickly confirmed and irreversible.
- Scalability: Snowman Consensus enables high network throughput while ensuring low latency.
- Energy Efficiency: Unlike other popular consensus protocols, participation in Snowman Consensus is neither computationally intensive nor expensive.
- Adaptive Security: Snowman Consensus is designed to resist various attacks, including sybil attacks, distributed denial-of-service (DDoS) attacks, and collusion attacks. Its probabilistic nature ensures that the consensus outcome converges to the desired state, even when the network is under attack.
## Conceptual Overview
Consensus protocols in the Avalanche family operate through repeated sub-sampled voting. When a node is determining whether a [transaction](http://support.avalabs.org/en/articles/4587384-what-is-a-transaction) should be accepted, it asks a small, random subset of [validator nodes](http://support.avalabs.org/en/articles/4064704-what-is-a-blockchain-validator) for their preference. Each queried validator replies with the transaction that it prefers, or thinks should be accepted.
Consensus will never include a transaction that is determined to be **invalid**. For example, if you were to submit a transaction to send 100 AVAX to a friend, but your wallet only has 2 AVAX, this transaction is considered **invalid** and will not participate in consensus.
If a sufficient majority of the validators sampled reply with the same preferred transaction, this becomes the preferred choice of the validator that inquired.
In the future, this node will reply with the transaction preferred by the majority.
The node repeats this sampling process until the validators queried reply with the same answer for a sufficient number of consecutive rounds.
- The number of validators required to be considered a "sufficient majority" is referred to as "α" (_alpha_).
- The number of consecutive rounds required to reach consensus, a.k.a. the "Confidence Threshold," is referred to as "β" (_beta_).
- Both α and β are configurable.
When a transaction has no conflicts, finalization happens very quickly. When conflicts exist, honest validators quickly cluster around conflicting transactions, entering a positive feedback loop until all correct validators prefer that transaction. This leads to the acceptance of non-conflicting transactions and the rejection of conflicting transactions.

Snowman Consensus guarantees that if any honest validator accepts a transaction, all honest validators will come to the same conclusion.
For a great visualization, check out [this demo](https://tedyin.com/archive/snow-bft-demo/#/snow).
## Deep Dive Into Snowman Consensus
### Intuition
First, let's develop some intuition about the protocol. Imagine a room full of people trying to agree on what to get for lunch. Suppose it's a binary choice between pizza and barbecue. Some people might initially prefer pizza while others initially prefer barbecue. Ultimately, though, everyone's goal is to achieve **consensus**.
Everyone asks a random subset of the people in the room what their lunch preference is. If more than half say pizza, the person thinks, "OK, looks like things are leaning toward pizza. I prefer pizza now." That is, they adopt the _preference_ of the majority. Similarly, if a majority say barbecue, the person adopts barbecue as their preference.
Everyone repeats this process. Each round, more and more people have the same preference. This is because the more people that prefer an option, the more likely someone is to receive a majority reply and adopt that option as their preference. After enough rounds, they reach consensus and decide on one option, which everyone prefers.
### Snowball
The intuition above outlines the Snowball Algorithm, which is a building block of Snowman Consensus. Let's review the Snowball algorithm.
#### Parameters
- _n_: number of participants
- _k_ (sample size): between 1 and _n_
- α (quorum size): between 1 and _k_
- β (decision threshold): >= 1
#### Algorithm
```
preference := pizza
consecutiveSuccesses := 0
while not decided:
ask k random people their preference
if >= α give the same response:
preference := response with >= α
if preference == old preference:
consecutiveSuccesses++
else:
consecutiveSuccesses = 1
else:
consecutiveSuccesses = 0
if consecutiveSuccesses > β:
decide(preference)
```
#### Algorithm Explained
Everyone has an initial preference for pizza or barbecue. Until someone has _decided_, they query _k_ people (the sample size) and ask them what they prefer. If α or more people give the same response, that response is adopted as the new preference. α is called the _quorum size_. If the new preference is the same as the old preference, the `consecutiveSuccesses` counter is incremented. If the new preference is different then the old preference, the `consecutiveSuccesses` counter is set to `1`. If no response gets a quorum (an α majority of the same response) then the `consecutiveSuccesses` counter is set to `0`.
Everyone repeats this until they get a quorum for the same response β times in a row. If one person decides pizza, then every other person following the protocol will eventually also decide on pizza.
Random changes in preference, caused by random sampling, cause a network preference for one choice, which begets more network preference for that choice until it becomes irreversible and then the nodes can decide.
In our example, there is a binary choice between pizza or barbecue, but Snowball can be adapted to achieve consensus on decisions with many possible choices.
The liveness and safety thresholds are parameterizable. As the quorum size, α, increases, the safety threshold increases, and the liveness threshold decreases. This means the network can tolerate more byzantine (deliberately incorrect, malicious) nodes and remain safe, meaning all nodes will eventually agree whether something is accepted or rejected. The liveness threshold is the number of malicious participants that can be tolerated before the protocol is unable to make progress.
These values, which are constants, are quite small on the Avalanche Network. The sample size, _k_, is `20`. So when a node asks a group of nodes their opinion, it only queries `20` nodes out of the whole network. The quorum size, α, is `14`. So if `14` or more nodes give the same response, that response is adopted as the querying node's preference. The decision threshold, β, is `20`. A node decides on choice after receiving `20` consecutive quorum (α majority) responses.
Snowball is very scalable as the number of nodes on the network, _n_, increases. Regardless of the number of participants in the network, the number of consensus messages sent remains the same because in a given query, a node only queries `20` nodes, even if there are thousands of nodes in the network.
Everything discussed to this point is how Avalanche is described in [the Avalanche white-paper](https://assets-global.website-files.com/5d80307810123f5ffbb34d6e/6009805681b416f34dcae012_Avalanche%20Consensus%20Whitepaper.pdf). The implementation of the Snowman Consensus protocol by Ava Labs (namely in AvalancheGo) has some optimizations for latency and throughput.
### Blocks
A block is a fundamental component that forms the structure of a blockchain. It serves as a container or data structure that holds a collection of transactions or other relevant information. Each block is cryptographically linked to the previous block, creating a chain of blocks, hence the term "blockchain."
In addition to storing a reference of its parent, a block contains a set of transactions. These transactions can represent various types of information, such as financial transactions, smart contract operations, or data storage requests.
If a node receives a vote for a block, it also counts as a vote for all of the block's ancestors (its parent, the parents' parent, etc.).
### Finality
Snowman Consensus is probabilistically safe up to a safety threshold. That is, the probability that a correct node accepts a transaction that another correct node rejects can be made arbitrarily low by adjusting system parameters. In Nakamoto consensus protocol (as used in Bitcoin and Ethereum, for example), a block may be included in the chain but then be removed and not end up in the canonical chain. This means waiting an hour for transaction settlement. In Avalanche, acceptance/rejection are **final and irreversible** and only take a few seconds.
### Optimizations
It's not safe for nodes to just ask, "Do you prefer this block?" when they query validators. In Ava Labs' implementation, during a query a node asks, "Given that this block exists, which block do you prefer?" Instead of getting back a binary yes/no, the node receives the other node's preferred block.
Nodes don't only query upon hearing of a new block; they repeatedly query other nodes until there are no blocks processing.
Nodes may not need to wait until they get all _k_ query responses before registering the outcome of a poll. If a block has already received _alpha_ votes, then there's no need to wait for the rest of the responses.
### Validators
If it were free to become a validator on the Avalanche network, that would be problematic because a malicious actor could start many, many nodes which would get queried very frequently. The malicious actor could make the node act badly and cause a safety or liveness failure. The validators, the nodes which are queried as part of consensus, have influence over the network. They have to pay for that influence with real-world value in order to prevent this kind of ballot stuffing. This idea of using real-world value to buy influence over the network is called Proof of Stake.
To become a validator, a node must **bond** (stake) something valuable (**AVAX**). The more AVAX a node bonds, the more often that node is queried by other nodes. When a node samples the network it's not uniformly random. Rather, it's weighted by stake amount. Nodes are incentivized to be validators because they get a reward if, while they validate, they're sufficiently correct and responsive.
Avalanche doesn't have slashing. If a node doesn't behave well while validating, such as giving incorrect responses or perhaps not responding at all, its stake is still returned in whole, but with no reward. As long as a sufficient portion of the bonded AVAX is held by correct nodes, then the network is safe, and is live for virtuous transactions.
### Big Ideas
Two big ideas in Avalanche are **subsampling** and **transitive voting**.
Subsampling has low message overhead. It doesn't matter if there are twenty validators or two thousand validators; the number of consensus messages a node sends during a query remains constant.
Transitive voting, where a vote for a block is a vote for all its ancestors, helps with transaction throughput. Each vote is actually many votes in one.
### Loose Ends
Transactions are created by users which call an API on an [AvalancheGo](https://github.com/ava-labs/avalanchego) full node or create them using a library such as [AvalancheJS](https://github.com/ava-labs/avalanchejs).
### Other Observations
Conflicting transactions are not guaranteed to be live. That's not really a problem because if you want your transaction to be live then you should not issue a conflicting transaction.
Snowman is the name of Ava Labs' implementation of the Snowman Consensus protocol for linear chains.
If there are no undecided transactions, the Snowman Consensus protocol _quiesces_. That is, it does nothing if there is no work to be done. This makes Avalanche more sustainable than Proof-of-work where nodes need to constantly do work.
Avalanche has no leader. Any node can propose a transaction and any node that has staked AVAX can vote on every transaction, which makes the network more robust and decentralized.
## Why Do We Care?
Avalanche is a general consensus engine. It doesn't matter what type of application is put on top of it. The protocol allows the decoupling of the application layer from the consensus layer. If you're building a dapp on Avalanche then you just need to define a few things, like how conflicts are defined and what is in a transaction. You don't need to worry about how nodes come to an agreement. The consensus protocol is a black box that put something into it and it comes back as accepted or rejected.
Avalanche can be used for all kinds of applications, not just P2P payment networks. Avalanche's Primary Network has an instance of the Ethereum Virtual Machine, which is backward compatible with existing Ethereum Dapps and dev tooling. The Ethereum consensus protocol has been replaced with Snowman Consensus to enable lower block latency and higher throughput.
Avalanche is very performant. It can process thousands of transactions per second with one to two second acceptance latency.
## Summary
Snowman Consensus is a radical breakthrough in distributed systems. It represents as large a leap forward as the classical and Nakamoto consensus protocols that came before it. Now that you have a better understanding of how it works, check out other documentations for building game-changing Dapps and financial instruments on Avalanche.
# AVAX Token (/docs/primary-network/avax-token)
---
title: AVAX Token
description: Learn about the native token of Avalanche Primary Network.
---
AVAX is the native utility token of Avalanche. It's a hard-capped, scarce asset that is used to pay for fees, secure the platform through staking, and provide a basic unit of account between the multiple Avalanche L1s created on Avalanche.
`1 nAVAX` is equal to `0.000000001 AVAX`. Use the [AVAX Unit Converter](/console/primary-network/unit-converter) to convert between different AVAX denominations.
## Utility
AVAX is a capped-supply (up to 720M) resource in the Avalanche ecosystem that's used to power the
network. AVAX is used to secure the ecosystem through staking and for day-to-day operations like
issuing transactions.
AVAX represents the weight that each node has in network decisions. No single actor owns
the Avalanche Network, so each validator in the network is given a proportional weight in the
network's decisions corresponding to the proportion of total stake that they own through proof
of stake (PoS).
Any entity trying to execute a transaction on Avalanche Primary Network pays a corresponding fee (commonly known as
"gas") to run it on the network. The fees used to execute a transaction on Avalanche is burned,
or permanently removed from circulating supply.
## Tokenomics
A fixed amount of 360M AVAX was minted at genesis, but a small amount of AVAX is constantly minted
as a reward to validators. The protocol rewards validators for good behavior by minting them AVAX
rewards at the end of their staking period. The minting process offsets the AVAX burned by
transactions fees. While AVAX is still far away from its supply cap, it will almost always remain an
inflationary asset.
Avalanche does not take away any portion of a validator's already staked tokens (commonly known as
"slashing") for negligent/malicious staking periods, however this behavior is disincentivized as
validators who attempt to do harm to the network would expend their node's computing resources
for no reward.
AVAX is minted according to the following formula, where $R_j$ is the total number of tokens at
year $j$, with $R_1 = 360M$, and $R_l$ representing the last year that the values of
$\gamma,\lambda \in \R$ were changed; $c_j$ is the yet un-minted supply of coins to reach $720M$ at
year $j$ such that $c_j \leq 360M$; $u$ represents a staker, with $u.s_{amount}$ representing the
total amount of stake that $u$ possesses, and $u.s_{time}$ the length of staking for $u$.
AVAX is minted according to the following formula, where $R_j$ is the total number of tokens at:
$$
R_j = R_l + \sum_{\forall u} \rho(u.s_{amount}, u.s_{time}) \times \frac{c_j}{L} \times \left( \sum_{i=0}^{j}\frac{1}{\left(\gamma + \frac{1}{1 + i^\lambda}\right)^i} \right)
$$
where,
$$
L = \left(\sum_{i=0}^{\infty} \frac{1}{\left(\gamma + \frac{1}{1 + i^\lambda} \right)^i} \right)
$$
At genesis, $c_1 = 360M$. The values of $\gamma$ and $\lambda$ are governable, and if changed,
the function is recomputed with the new value of $c_*$. We have that $\sum_{*}\rho(*) \le 1$.
$\rho(*)$ is a linear function that can be computed as follows ($u.s_{time}$ is measured in weeks,
and $u.s_{amount}$ is measured in AVAX tokens):
$$
\rho(u.s_{amount}, u.s_{time}) = (0.002 \times u.s_{time} + 0.896) \times \frac{u.s_{amount}}{R_j}
$$
If the entire supply of tokens at year $j$ is staked for the maximum amount of staking time (one
year, or 52 weeks), then $\sum_{\forall u}\rho(u.s_{amount}, u.s_{time}) = 1$. If, instead,
every token is staked continuously for the minimal stake duration of two weeks, then
$\sum_{\forall u}\rho(u.s_{amount}, u.s_{time}) = 0.9$. Therefore, staking for the maximum
amount of time incurs an additional 11.11% of tokens minted, incentivizing stakers to stake
for longer periods.
Due to the capped-supply, the above function guarantees that
AVAX will never exceed a total of $720M$ tokens, or $\lim_{j \to \infty} R(j) = 720M$.
# Coreth Architecture (/docs/primary-network/coreth-architecture)
---
title: Coreth Architecture
description: How the C-Chain EVM (Coreth) runs inside AvalancheGo, including consensus, execution, and cross-chain transfers.
---
Coreth is the EVM implementation that powers the C-Chain. It is shipped with AvalancheGo under [`graft/coreth`](https://github.com/ava-labs/avalanchego/tree/master/graft/coreth) and wrapped by Snowman++ ([`vms/proposervm`](https://github.com/ava-labs/avalanchego/tree/master/vms/proposervm)) for block production.
At a glance:
- Snowman++ engine calls into Coreth’s block builder and execution pipeline.
- Coreth executes EVM bytecode, maintains state (trie over Pebble/LevelDB), and exposes JSON-RPC/WS.
- Atomic import/export uses shared UTXO memory and writes to the node database.
## Consensus & Block Production
- Runs **Snowman++** via the ProposerVM wrapper; a stake-weighted proposer list gates each 5s window before falling back to anyone building.
- Blocks are built by Coreth's block builder ([`graft/coreth/plugin/evm/block_builder.go`](https://github.com/ava-labs/avalanchego/blob/master/graft/coreth/plugin/evm/block_builder.go)), which applies EIP-1559 base fee rules and proposer-specific metadata.
- Chain ID: Mainnet `43114`, Fuji `43113`. JSON-RPC is exposed at `/ext/bc/C/rpc` with optional WebSocket at `/ext/bc/C/ws`.
## Execution Pipeline
- **Execution**: Standard go-ethereum VM with Avalanche-specific patches (fee handling, atomic tx support, bootstrapping/state sync) in [`graft/coreth`](https://github.com/ava-labs/avalanchego/tree/master/graft/coreth).
- **State**: Uses PebbleDB/LevelDB via AvalancheGo's database interface; state pruning and state-sync are configurable.
- **APIs**: Supports `eth`, `net`, `web3`, `debug` (optional), `txpool` (optional) namespaces. Enable/disable via chain config.
## Cross-Chain (Atomic) Transfers
- Coreth supports **atomic import/export** to the X-Chain and P-Chain using shared UTXO memory ([`graft/coreth/plugin/evm/atomic`](https://github.com/ava-labs/avalanchego/tree/master/graft/coreth/plugin/evm/atomic)).
- Exports lock AVAX into an atomic UTXO set; imports consume those UTXOs to credit balance on the destination chain.
- Wallet helpers and SDKs build these atomic txs against the C-Chain RPC; on-chain they show up as `ImportTx`/`ExportTx` wrapping atomic inputs/outputs.
## Configuration
Chain-specific config lives at:
```json title="~/.avalanchego/configs/chains/C/config.json"
{
"eth-apis": ["eth", "net", "web3", "eth-filter"],
"pruning-enabled": true,
"state-sync-enabled": true
}
```
Key knobs:
- `eth-apis`: List of RPC namespaces to serve.
- `pruning-enabled`: Enable state trie pruning.
- `state-sync-enabled`: Allow state sync bootstrap instead of full replay.
- P-chain fee recipient and other advanced options are also supported; see [`graft/coreth/plugin/evm/config.go`](https://github.com/ava-labs/avalanchego/blob/master/graft/coreth/plugin/evm/config.go).
## Developer Tips
- Use **chain configs** to toggle RPC namespaces instead of patching code.
- When running local devnets, use `--chain-config-content` to pass base64 configs inline.
- For cross-chain AVAX moves, call the P-Chain/X-Chain import/export endpoints; Coreth handles the atomic mempool internally.
# Exchange Integration (/docs/primary-network/exchange-integration)
---
title: Exchange Integration
description: Learn how to integrate your exchange with the EVM-Compatible Avalanche C-Chain.
---
## Overview
The objective of this document is to provide a brief overview of how to
integrate with the EVM-Compatible Avalanche C-Chain.
For teams that already
support ETH, supporting the C-Chain is as straightforward as spinning up an
Avalanche node (which has the [same API](https://ethereum.org/en/developers/docs/apis/json-rpc/) as
[`go-ethereum`](https://geth.ethereum.org/docs/rpc/server)) and populating
Avalanche's ChainID (43114) when constructing transactions.
Additionally, Ava Labs maintains an implementation of the [Rosetta
API](https://docs.cdp.coinbase.com/mesh/docs/welcome) for the C-Chain called
[avalanche-rosetta](https://github.com/ava-labs/avalanche-rosetta). You can
learn more about this standardized integration path on the attached Rosetta API
website.
## Integration Using EVM Endpoints
### Running an Avalanche Node
If you want to build your node form source or include it in a docker image,
reference the [AvalancheGo GitHub
repository](https://github.com/ava-labs/avalanchego). To quickly get up and
running, you can use the [node installation script](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go) that automates installing
and updating AvalancheGo node as a `systemd` service on Linux, using prebuilt
binaries.
### Configuring an Avalanche Node
All configuration options and their default values are described [here](/docs/nodes/configure/configs-flags).
You can supply configuration options on the command line, or use a config file,
which can be easier to work with when supplying many options. You can specify
the config file location with `—config-file=config.json`, where `config.json` is
a JSON file whose keys and values are option names and values.
Individual chains, including the C-Chain, have their own configuration options
which are separate from the node-level options. These can also be specified in a
config file. For more details, see
[here](/docs/nodes/chain-configs/primary-network/c-chain).
The C-Chain config file should be at
`$HOME/.avalanchego/configs/chains/C/config.json`. You can also tell AvalancheGo
to look somewhere else for the C-Chain config file with option
`--chain-config-dir`. An example C-Chain config file:
If you need Ethereum's [Archive
Node](https://ethereum.org/en/developers/docs/nodes-and-clients/#archive-node)
functionality, you need to disable C-Chain pruning, which has been enabled by
default since AvalancheGo v1.4.10. To disable pruning, include
`"pruning-enabled": false` in the C-Chain config file as shown below.
```json
{
"snowman-api-enabled": false,
"coreth-admin-api-enabled": false,
"local-txs-enabled": true,
"pruning-enabled": false,
"eth-apis": [
"internal-eth",
"internal-blockchain",
"internal-transaction",
"internal-tx-pool",
"internal-account",
"internal-personal",
"debug-tracer",
"web3",
"eth",
"eth-filter",
"admin",
"net"
]
}
```
### Interacting with the C-Chain
Interacting with the C-Chain is identical to interacting with
[`go-ethereum`](https://geth.ethereum.org/). You can find the reference material
for C-Chain API [here](/docs/rpcs/c-chain).
Please note that `personal_` namespace is turned off by default. To turn it on,
you need to pass the appropriate command line switch to your node, like in the
above config example.
## Integration Using Rosetta
[Rosetta](https://docs.cdp.coinbase.com/mesh/docs/welcome) is an open-source specification and set
of tools that makes integrating with different blockchain networks easier by
presenting the same set of APIs for every network. The Rosetta API is made up of
2 core components, the [Data
API](https://docs.cdp.coinbase.com/mesh/docs/api-data) and the
[Construction
API](https://docs.cdp.coinbase.com/mesh/docs/api-construction).
Together, these APIs allow for anyone to read and write to blockchains in a
standard format over a standard communication protocol. The specifications for
these APIs can be found in the
[rosetta-specifications](https://github.com/coinbase/rosetta-specifications)
repository.
You can find the Rosetta server implementation for Avalanche C-Chain
[here](https://github.com/ava-labs/avalanche-rosetta), all you need to do is
install and run the server with proper configuration. It comes with a `Dockerfile`
that packages both the server and the Avalanche client. Detailed instructions
can be found in the linked repository.
## Constructing Transactions
Avalanche C-Chain transactions are identical to standard EVM transactions with 2 exceptions:
- They must be signed with Avalanche's ChainID (43114).
- The detailed dynamic gas fee can be found [here](/docs/rpcs/other/guides/txn-fees#c-chain-fees).
For development purposes, Avalanche supports all the popular tooling for
Ethereum, so developers familiar with Ethereum and Solidity can feel right at
home. Popular development environments include:
- [Remix IDE](https://remix.ethereum.org/)
- [thirdweb](https://thirdweb.com/)
- [Hardhat](https://hardhat.org/)
## Ingesting On-Chain Data
You can use any standard way of ingesting on-chain data you use for Ethereum network.
### Determining Finality
Avalanche consensus provides fast and irreversible finality with 1-2 seconds. To
query the most up-to-date finalized block, query any value (that is block, balance,
state, etc) with the `latest` parameter. If you query above the last finalized
block (that is eth_blockNumber returns 10 and you query 11), an error will be
thrown indicating that unfinalized data cannot be queried (as of
`avalanchego@v1.3.2`).
### (Optional) Custom Golang SDK
If you plan on extracting data from the C-Chain into your own systems using
Golang, we recommend using our custom
[`ethclient`](https://github.com/ava-labs/avalanchego/tree/master/graft/coreth/ethclient). The
standard `go-ethereum` Ethereum client does not compute block hashes correctly
(when you call `block.Hash()`) because it doesn't take into account the added
[ExtDataHash](https://github.com/ava-labs/avalanchego/blob/master/graft/coreth/core/types/block.go#L98)
header field in Avalanche C-Chain blocks, which is used move AVAX between chains
(X-Chain and P-Chain). You can read more about our multi-chain abstraction
[here](/docs/primary-network) (out of scope for a
normal C-Chain integration).
If you plan on reading JSON responses directly or use web3.js (doesn't recompute
hash received over the wire) to extract on-chain transaction data/logs/receipts,
you shouldn't have any issues!
## Support
If you have any problems or questions, reach out either directly to our
developers, or on our public [Discord](https://chat.avalabs.org/) server.
# Primary Network (/docs/primary-network)
---
title: Primary Network
description: Learn about the Avalanche Primary Network and its three blockchains.
---
import { Network, Layers, Terminal, ArrowRight, Database, Package } from 'lucide-react';
Avalanche is a heterogeneous network of blockchains. As opposed to homogeneous networks, where all applications reside in the same chain, heterogeneous networks allow separate chains to be created for different applications.

The Primary Network is a special [Avalanche L1](/docs/avalanche-l1s) that runs three blockchains:
- The Contract Chain [(C-Chain)](/docs/primary-network#c-chain-contract-chain)
- The Platform Chain [(P-Chain)](/docs/primary-network#p-chain-platform-chain)
- The Exchange Chain [(X-Chain)](/docs/primary-network#x-chain-exchange-chain)
Avalanche Mainnet is comprised of the Primary Network and all deployed Avalanche L1s.
A node can become a validator for the Primary Network by staking at least **2,000 AVAX**.
### C-Chain (Contract Chain)
The **C-Chain** is an implementation of the Ethereum Virtual Machine (EVM). The [C-Chain's API](/docs/rpcs/c-chain) supports Geth's API and supports the deployment and execution of smart contracts written in Solidity.
The C-Chain is an instance of the [Coreth](https://github.com/ava-labs/avalanchego/tree/master/graft/coreth) Virtual Machine.
| Property | Mainnet | Fuji Testnet |
|----------|---------|--------------|
| **Network Name** | Avalanche C-Chain | Avalanche Fuji C-Chain |
| **Chain ID** | 43114 (0xA86A) | 43113 (0xA869) |
| **Currency** | AVAX | AVAX |
| **RPC URL** | https://api.avax.network/ext/bc/C/rpc | https://api.avax-test.network/ext/bc/C/rpc |
| **Explorer** | https://subnets.avax.network/c-chain | https://subnets-test.avax.network/c-chain |
| **Faucet** | - | [Get Test AVAX](/console/primary-network/faucet) |
| **Add to Wallet** | | |
### P-Chain (Platform Chain)
The **P-Chain** is responsible for all validator and Avalanche L1-level operations. The [P-Chain API](/docs/rpcs/p-chain) supports the creation of new blockchains and Avalanche L1s, the addition of validators to Avalanche L1s, staking operations, and other platform-level operations.
The P-Chain is an instance of the [Platform Virtual Machine](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm).
| Property | Mainnet | Fuji Testnet |
|----------|---------|--------------|
| **RPC URL** | https://api.avax.network/ext/bc/P | https://api.avax-test.network/ext/bc/P |
| **Currency** | AVAX | AVAX |
| **Explorer** | https://subnets.avax.network/p-chain | https://subnets-test.avax.network/p-chain |
### X-Chain (Exchange Chain)
The **X-Chain** is responsible for operations on digital smart assets known as **Avalanche Native Tokens**. A smart asset is a representation of a real-world resource (for example, equity, or a bond) with sets of rules that govern its behavior, like "can't be traded until tomorrow." The [X-Chain API](/docs/rpcs/x-chain) supports the creation and trade of Avalanche Native Tokens.
One asset traded on the X-Chain is AVAX. When you issue a transaction to a blockchain on Avalanche, you pay a fee denominated in AVAX.
The X-Chain is an instance of the Avalanche Virtual Machine (AVM).
| Property | Mainnet | Fuji Testnet |
|----------|---------|--------------|
| **RPC URL** | https://api.avax.network/ext/bc/X | https://api.avax-test.network/ext/bc/X |
| **Currency** | AVAX | AVAX |
| **Explorer** | https://subnets.avax.network/x-chain | https://subnets-test.avax.network/x-chain |
## Explore More
# PlatformVM Architecture (/docs/primary-network/platformvm-architecture)
---
title: PlatformVM Architecture
description: How the P-Chain manages validators, staking, and Avalanche L1 creation inside AvalancheGo.
---
PlatformVM (P-Chain) runs on Snowman++ and controls validators, staking rewards, subnet membership, and chain creation. Source lives in [`vms/platformvm`](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm) and its block/tx types in [`vms/platformvm/txs`](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm/txs).
At a glance:
- Snowman++ engine drives PlatformVM block production; mempool feeds Standard/Proposal/Atomic blocks.
- Validator registry, subnet membership, warp signing, and atomic UTXOs are persisted in the node database.
- P-Chain APIs expose validator state, subnet/chain creation, staking ops, and block fetch.
## Responsibilities
- **Validator registry & staking**: Tracks Primary Network validators and delegators, uptime, staking rewards, and validator fees.
- **Subnet/L1 orchestration**: Creates Subnets and chains (`CreateSubnetTx`, `CreateChainTx`), maintains Subnet validator sets (including permissionless add/remove).
- **Warp messaging**: Signs warp messages for cross-chain communication on Avalanche L1s.
- **Atomic transfers**: Handles import/export of AVAX to/from other chains via shared memory.
## Consensus & Blocks
- Uses **Snowman++** via the ProposerVM (single proposer windows with fallback).
- Blocks are built by [`vms/platformvm/block/builder`](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm/block/builder); block types include **Standard**, **Proposal** (with **Commit/Abort** options), and **Atomic** blocks.
- State sync is supported for faster bootstrap; bootstrapping peers can be overridden via `CustomBeacons` in the P-Chain `ChainParameters`.
## Key Transaction Types
| Transaction | Purpose |
|-------------|---------|
| `AddValidatorTx`, `AddDelegatorTx` | Join the Primary Network validator set / delegate stake |
| `AddSubnetValidatorTx` | Add a validator to a Subnet (validator must also be on Primary) |
| `AddPermissionlessValidatorTx` / `AddPermissionlessDelegatorTx` | Permissionless validation on Subnets that allow it |
| `CreateSubnetTx` | Create a new Subnet and owner controls |
| `CreateChainTx` | Launch a new blockchain (VM + genesis) on a Subnet |
| `ImportTx` / `ExportTx` | Move AVAX to/from other chains via atomic UTXOs |
| `RewardValidatorTx` | Mint rewards after successful staking periods |
| `TransformSubnetTx` | Legacy subnet transform (disabled post-Etna) |
## P-Chain APIs
- Exposed at `/ext/bc/P` with namespaces such as `platform.getBlock`, `platform.getCurrentValidators`, `platform.issueTx`, `platform.getSubnets`, `platform.getBlockchains`.
- Health and metrics are surfaced via the node-level `/ext/health` and `/ext/metrics`.
## Configuration
Default chain config location:
```json title="~/.avalanchego/configs/chains/P/config.json"
{
"state-sync-enabled": true,
"pruning-enabled": true
}
```
- Subnet and chain aliases can be set in `~/.avalanchego/configs/chains/aliases.json`.
- Upgrade rules and Subnet parameters are read from the chain config and network upgrade settings (`upgrade/`).
## Developer Tips
- When testing new Subnets/VMs, pass `CreateChainTx` genesis bytes and VM IDs via `platform.issueTx`.
- For permissionless Subnets, ensure the Subnet’s config enables the relevant validator/delegator transactions before issuing them.
- Use `platform.getBlock` to inspect Proposal/Commit/Abort flow if debugging staking or subnet updates.
# Virtual Machines (/docs/primary-network/virtual-machines)
---
title: Virtual Machines
description: Learn about blockchain VMs and how you can build a custom VM-enabled blockchain in Avalanche.
---
A **Virtual Machine** (VM) is the blueprint for a blockchain, meaning it defines a blockchain's complete application logic by specifying the blockchain's state, state transitions, transaction rules, and API interface.
Developers can use the same VM to create multiple blockchains, each of which follows identical rules but is independent of all others.
All Avalanche validators of the **Avalanche Primary Network** are required to run three VMs:
- **Coreth**: Defines the Contract Chain (C-Chain); supports smart contract functionality and is EVM-compatible.
- **Platform VM**: Defines the Platform Chain (P-Chain); supports operations on staking and Avalanche L1s.
- **Avalanche VM**: Defines the Exchange Chain (X-Chain); supports operations on Avalanche Native Tokens.
All three can easily be run on any computer with [AvalancheGo](/docs/nodes).
## Custom VMs on Avalanche
Developers with advanced use-cases for utilizing distributed ledger technology are often forced to build everything from scratch - networking, consensus, and core infrastructure - before even starting on the actual application.
Avalanche eliminates this complexity by:
- Providing VMs as simple blueprints for defining blockchain behavior
- Supporting development in any programming language with familiar tools
- Handling all low-level infrastructure automatically
This lets developers focus purely on building their dApps, ecosystems, and communities, rather than wrestling with blockchain fundamentals.
### How Custom VMs Work
Customized VMs can communicate with Avalanche over a language agnostic request-response protocol known as [RPC](https://en.wikipedia.org/wiki/Remote_procedure_call). This allows the VM framework to open a world of endless possibilities, as developers can implement their dApps using the languages, frameworks, and libraries of their choice.
Validators can install additional VMs on their node to validate additional [Avalanche L1s](/docs/avalanche-l1s) in the Avalanche ecosystem. In exchange, validators receive staking rewards in the form of a reward token determined by the Avalanche L1s.
## Building a Custom VM
You can start building your first custom virtual machine in two ways:
1. Use the ready-to-deploy Subnet-EVM for Solidity-based development
2. Create a custom VM in Golang, Rust, or your preferred language
The choice depends on your needs. Subnet-EVM provides a quick start with Ethereum compatibility, while custom VMs offer maximum flexibility.
### Golang Examples
See here for a tutorial on [How to Build a Simple Golang VM](/docs/avalanche-l1s/golang-vms/simple-golang-vm).
### Rust Examples
See here for a tutorial on [How to Build a Simple Rust VM](/docs/avalanche-l1s/rust-vms/setting-up-environment).
# Introduction (/docs/cross-chain)
---
title: Introduction
description: Learn about different interoperability protocols in the Avalanche ecosystem.
---
# RPC APIs (/docs/rpcs)
---
title: RPC APIs
description: AvalancheGo RPC API References for interacting with Avalanche nodes
---
# RPC APIs
This section contains comprehensive documentation for all RPC (Remote Procedure Call) APIs available in the Avalanche ecosystem.
## Chain-Specific APIs
### C-Chain (Contract Chain)
The C-Chain is an instance of the Ethereum Virtual Machine (EVM). Documentation for C-Chain RPC methods and transaction formats.
### P-Chain (Platform Chain)
The P-Chain manages validators, staking, and subnets. Documentation for P-Chain RPC methods and transaction formats.
### X-Chain (Exchange Chain)
The X-Chain is responsible for asset creation and trading. Documentation for X-Chain RPC methods and transaction formats.
### Subnet-EVM
The Subnet-EVM is an instance of the EVM for Subnet / Layer 1 chains. Documentation for Subnet-EVM RPC methods and transaction formats.
## Other APIs
Additional RPC APIs for node administration, health monitoring, indexing, metrics, and more.
# CLI Commands (/docs/tooling/cli-commands)
---
title: "CLI Commands"
description: "Complete list of Avalanche CLI commands and their usage."
edit_url: https://github.com/ava-labs/avalanche-cli/edit/main/cmd/commands.md
---
## avalanche blockchain
The blockchain command suite provides a collection of tools for developing
and deploying Blockchains.
To get started, use the blockchain create command wizard to walk through the
configuration of your very first Blockchain. Then, go ahead and deploy it
with the blockchain deploy command. You can use the rest of the commands to
manage your Blockchain configurations and live deployments.
**Usage:**
```bash
avalanche blockchain [subcommand] [flags]
```
**Subcommands:**
- [`addValidator`](#avalanche-blockchain-addvalidator): The blockchain addValidator command adds a node as a validator to
an L1 of the user provided deployed network. If the network is proof of
authority, the owner of the validator manager contract must sign the
transaction. If the network is proof of stake, the node must stake the L1's
staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain.
This command currently only works on Blockchains deployed to either the Fuji
Testnet or Mainnet.
- [`changeOwner`](#avalanche-blockchain-changeowner): The blockchain changeOwner changes the owner of the deployed Blockchain.
- [`changeWeight`](#avalanche-blockchain-changeweight): The blockchain changeWeight command changes the weight of a L1 Validator.
The L1 has to be a Proof of Authority L1.
- [`configure`](#avalanche-blockchain-configure): AvalancheGo nodes support several different configuration files.
Each network (a Subnet or an L1) has their own config which applies to all blockchains/VMs in the network (see https://build.avax.network/docs/nodes/configure/avalanche-l1-configs)
Each blockchain within the network can have its own chain config (see https://build.avax.network/docs/nodes/chain-configs/c-chain https://github.com/ava-labs/subnet-evm/blob/master/plugin/evm/config/config.go for subnet-evm options).
A chain can also have special requirements for the AvalancheGo node configuration itself (see https://build.avax.network/docs/nodes/configure/configs-flags).
This command allows you to set all those files.
- [`create`](#avalanche-blockchain-create): The blockchain create command builds a new genesis file to configure your Blockchain.
By default, the command runs an interactive wizard. It walks you through
all the steps you need to create your first Blockchain.
The tool supports deploying Subnet-EVM, and custom VMs. You
can create a custom, user-generated genesis with a custom VM by providing
the path to your genesis and VM binaries with the --genesis and --vm flags.
By default, running the command with a blockchainName that already exists
causes the command to fail. If you'd like to overwrite an existing
configuration, pass the -f flag.
- [`delete`](#avalanche-blockchain-delete): The blockchain delete command deletes an existing blockchain configuration.
- [`deploy`](#avalanche-blockchain-deploy): The blockchain deploy command deploys your Blockchain configuration locally, to Fuji Testnet, or to Mainnet.
At the end of the call, the command prints the RPC URL you can use to interact with the Subnet.
Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent
attempts to deploy the same Blockchain to the same network (local, Fuji, Mainnet) aren't
allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call
avalanche network clean to reset all deployed chain state. Subsequent local deploys
redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks,
so you can take your locally tested Blockchain and deploy it on Fuji or Mainnet.
- [`describe`](#avalanche-blockchain-describe): The blockchain describe command prints the details of a Blockchain configuration to the console.
By default, the command prints a summary of the configuration. By providing the --genesis
flag, the command instead prints out the raw genesis file.
- [`export`](#avalanche-blockchain-export): The blockchain export command write the details of an existing Blockchain deploy to a file.
The command prompts for an output path. You can also provide one with
the --output flag.
- [`import`](#avalanche-blockchain-import): Import blockchain configurations into avalanche-cli.
This command suite supports importing from a file created on another computer,
or importing from blockchains running public networks
(e.g. created manually or with the deprecated subnet-cli)
- [`join`](#avalanche-blockchain-join): The blockchain join command configures your validator node to begin validating a new Blockchain.
To complete this process, you must have access to the machine running your validator. If the
CLI is running on the same machine as your validator, it can generate or update your node's
config file automatically. Alternatively, the command can print the necessary instructions
to update your node manually. To complete the validation process, the Blockchain's admins must add
the NodeID of your validator to the Blockchain's allow list by calling addValidator with your
NodeID.
After you update your validator's config, you need to restart your validator manually. If
you provide the --avalanchego-config flag, this command attempts to edit the config file
at that path.
This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet.
- [`list`](#avalanche-blockchain-list): The blockchain list command prints the names of all created Blockchain configurations. Without any flags,
it prints some general, static information about the Blockchain. With the --deployed flag, the command
shows additional information including the VMID, BlockchainID and SubnetID.
- [`publish`](#avalanche-blockchain-publish): The blockchain publish command publishes the Blockchain's VM to a repository.
- [`removeValidator`](#avalanche-blockchain-removevalidator): The blockchain removeValidator command stops a whitelisted blockchain network validator from
validating your deployed Blockchain.
To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass
these prompts by providing the values with flags.
- [`stats`](#avalanche-blockchain-stats): The blockchain stats command prints validator statistics for the given Blockchain.
- [`upgrade`](#avalanche-blockchain-upgrade): The blockchain upgrade command suite provides a collection of tools for
updating your developmental and deployed Blockchains.
- [`validators`](#avalanche-blockchain-validators): The blockchain validators command lists the validators of a blockchain and provides
several statistics about them.
- [`vmid`](#avalanche-blockchain-vmid): The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain.
**Flags:**
```bash
-h, --help help for blockchain
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### addValidator
The blockchain addValidator command adds a node as a validator to
an L1 of the user provided deployed network. If the network is proof of
authority, the owner of the validator manager contract must sign the
transaction. If the network is proof of stake, the node must stake the L1's
staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain.
This command currently only works on Blockchains deployed to either the Fuji
Testnet or Mainnet.
**Usage:**
```bash
avalanche blockchain addValidator [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true)
--aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation
--aggregator-log-level string log level to use with signature aggregator (default "Debug")
--aggregator-log-to-stdout use stdout for signature aggregator logs
--balance float set the AVAX balance of the validator that will be used for continuous fee on P-Chain
--blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's registration (blockchain gas token)
--blockchain-key string CLI stored key to use to pay fees for completing the validator's registration (blockchain gas token)
--blockchain-private-key string private key to use to pay fees for completing the validator's registration (blockchain gas token)
--bls-proof-of-possession string set the BLS proof of possession of the validator to add
--bls-public-key string set the BLS public key of the validator to add
--cluster string operate on the given cluster
--create-local-validator create additional local validator and add it to existing running local node
--default-duration (for Subnets, not L1s) set duration so as to validate until primary validator ends its period
--default-start-time (for Subnets, not L1s) use default start time for subnet validator (5 minutes later for fuji & mainnet, 30 seconds later for devnet)
--default-validator-params (for Subnets, not L1s) use default weight/start/duration params for subnet validator
--delegation-fee uint16 (PoS only) delegation fee (in bips) (default 100)
--devnet operate on a devnet network
--disable-owner string P-Chain address that will able to disable the validator with a P-Chain transaction
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet only]
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for addValidator
-k, --key string select the key to use [fuji/devnet only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-endpoint string gather node id/bls from publicly available avalanchego apis on the given endpoint
--node-id string node-id of the validator to add
--output-tx-path string (for Subnets, not L1s) file path of the add validator tx
--partial-sync set primary network partial sync for new validators (default true)
--remaining-balance-owner string P-Chain address that will receive any leftover AVAX from the validator when it is removed from Subnet
--rpc string connect to validator manager at the given rpc endpoint
--stake-amount uint (PoS only) amount of tokens to stake
--staking-period duration how long this validator will be staking
--start-time string (for Subnets, not L1s) UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format
--subnet-auth-keys strings (for Subnets, not L1s) control keys that will be used to authenticate add validator tx
-t, --testnet fuji operate on testnet (alias to fuji)
--wait-for-tx-acceptance (for Subnets, not L1s) just issue the add validator tx, without waiting for its acceptance (default true)
--weight uint set the staking weight of the validator to add (default 20)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### changeOwner
The blockchain changeOwner changes the owner of the deployed Blockchain.
**Usage:**
```bash
avalanche blockchain changeOwner [subcommand] [flags]
```
**Flags:**
```bash
--auth-keys strings control keys that will be used to authenticate transfer blockchain ownership tx
--cluster string operate on the given cluster
--control-keys strings addresses that may make blockchain changes
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet]
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for changeOwner
-k, --key string select the key to use [fuji/devnet]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--output-tx-path string file path of the transfer blockchain ownership tx
-s, --same-control-key use the fee-paying key as control key
-t, --testnet fuji operate on testnet (alias to fuji)
--threshold uint32 required number of control key signatures to make blockchain changes
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### changeWeight
The blockchain changeWeight command changes the weight of a L1 Validator.
The L1 has to be a Proof of Authority L1.
**Usage:**
```bash
avalanche blockchain changeWeight [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet only]
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for changeWeight
-k, --key string select the key to use [fuji/devnet only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-endpoint string gather node id/bls from publicly available avalanchego apis on the given endpoint
--node-id string node-id of the validator
-t, --testnet fuji operate on testnet (alias to fuji)
--weight uint set the new staking weight of the validator
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### configure
AvalancheGo nodes support several different configuration files.
Each network (a Subnet or an L1) has their own config which applies to all blockchains/VMs in the network (see https://build.avax.network/docs/nodes/configure/avalanche-l1-configs)
Each blockchain within the network can have its own chain config (see https://build.avax.network/docs/nodes/chain-configs/c-chain https://github.com/ava-labs/subnet-evm/blob/master/plugin/evm/config/config.go for subnet-evm options).
A chain can also have special requirements for the AvalancheGo node configuration itself (see https://build.avax.network/docs/nodes/configure/configs-flags).
This command allows you to set all those files.
**Usage:**
```bash
avalanche blockchain configure [subcommand] [flags]
```
**Flags:**
```bash
--chain-config string path to the chain configuration
-h, --help help for configure
--node-config string path to avalanchego node configuration
--per-node-chain-config string path to per node chain configuration for local network
--subnet-config string path to the subnet configuration
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### create
The blockchain create command builds a new genesis file to configure your Blockchain.
By default, the command runs an interactive wizard. It walks you through
all the steps you need to create your first Blockchain.
The tool supports deploying Subnet-EVM, and custom VMs. You
can create a custom, user-generated genesis with a custom VM by providing
the path to your genesis and VM binaries with the --genesis and --vm flags.
By default, running the command with a blockchainName that already exists
causes the command to fail. If you'd like to overwrite an existing
configuration, pass the -f flag.
**Usage:**
```bash
avalanche blockchain create [subcommand] [flags]
```
**Flags:**
```bash
--custom use a custom VM template
--custom-vm-branch string custom vm branch or commit
--custom-vm-build-script string custom vm build-script
--custom-vm-path string file path of custom vm to use
--custom-vm-repo-url string custom vm repository url
--debug enable blockchain debugging (default true)
--evm use the Subnet-EVM as the base template
--evm-chain-id uint chain ID to use with Subnet-EVM
--evm-defaults deprecation notice: use '--production-defaults'
--evm-token string token symbol to use with Subnet-EVM
--external-gas-token use a gas token from another blockchain
-f, --force overwrite the existing configuration if one exists
--from-github-repo generate custom VM binary from github repository
--genesis string file path of genesis to use
-h, --help help for create
--icm interoperate with other blockchains using ICM
--icm-registry-at-genesis setup ICM registry smart contract on genesis [experimental]
--latest use latest Subnet-EVM released version, takes precedence over --vm-version
--pre-release use latest Subnet-EVM pre-released version, takes precedence over --vm-version
--production-defaults use default production settings for your blockchain
--proof-of-authority use proof of authority(PoA) for validator management
--proof-of-stake use proof of stake(PoS) for validator management
--proxy-contract-owner string EVM address that controls ProxyAdmin for TransparentProxy of ValidatorManager contract
--reward-basis-points uint (PoS only) reward basis points for PoS Reward Calculator (default 100)
--sovereign set to false if creating non-sovereign blockchain (default true)
--teleporter interoperate with other blockchains using ICM
--test-defaults use default test settings for your blockchain
--validator-manager-owner string EVM address that controls Validator Manager Owner
--vm string file path of custom vm to use. alias to custom-vm-path
--vm-version string version of Subnet-EVM template to use
--warp generate a vm with warp support (needed for ICM) (default true)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### delete
The blockchain delete command deletes an existing blockchain configuration.
**Usage:**
```bash
avalanche blockchain delete [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for delete
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### deploy
The blockchain deploy command deploys your Blockchain configuration to Local Network, to Fuji Testnet, DevNet or to Mainnet.
At the end of the call, the command prints the RPC URL you can use to interact with the L1 / Subnet.
When deploying an L1, Avalanche-CLI lets you use your local machine as a bootstrap validator, so you don't need to run separate Avalanche nodes.
This is controlled by the --use-local-machine flag (enabled by default on Local Network).
If --use-local-machine is set to true:
- Avalanche-CLI will call CreateSubnetTx, CreateChainTx, ConvertSubnetToL1Tx, followed by syncing the local machine bootstrap validator to the L1 and initialize
Validator Manager Contract on the L1
If using your own Avalanche Nodes as bootstrap validators:
- Avalanche-CLI will call CreateSubnetTx, CreateChainTx, ConvertSubnetToL1Tx
- You will have to sync your bootstrap validators to the L1
- Next, Initialize Validator Manager contract on the L1 using avalanche contract initValidatorManager [L1_Name]
Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent
attempts to deploy the same Blockchain to the same network (Local Network, Fuji, Mainnet) aren't
allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call
avalanche network clean to reset all deployed chain state. Subsequent local deploys
redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks,
so you can take your locally tested Blockchain and deploy it on Fuji or Mainnet.
**Usage:**
```bash
avalanche blockchain deploy [subcommand] [flags]
```
**Flags:**
```bash
--convert-only avoid node track, restart and poa manager setup
-e, --ewoq use ewoq key [local/devnet deploy only]
-h, --help help for deploy
-k, --key string select the key to use [fuji/devnet deploy only]
-g, --ledger use ledger instead of key
--ledger-addrs strings use the given ledger addresses
--mainnet-chain-id uint32 use different ChainID for mainnet deployment
--output-tx-path string file path of the blockchain creation tx (for multi-sig signing)
-u, --subnet-id string do not create a subnet, deploy the blockchain into the given subnet id
--subnet-only command stops after CreateSubnetTx and returns SubnetID
Network Flags (Select One):
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--fuji operate on fuji (alias to `testnet`)
--local operate on a local network
--mainnet operate on mainnet
--testnet operate on testnet (alias to `fuji`)
Bootstrap Validators Flags:
--balance float64 set the AVAX balance of each bootstrap validator that will be used for continuous fee on P-Chain (setting balance=1 equals to 1 AVAX for each bootstrap validator)
--bootstrap-endpoints stringSlice take validator node info from the given endpoints
--bootstrap-filepath string JSON file path that provides details about bootstrap validators
--change-owner-address string address that will receive change if node is no longer L1 validator
--generate-node-id set to true to generate Node IDs for bootstrap validators when none are set up. Use these Node IDs to set up your Avalanche Nodes.
--num-bootstrap-validators int number of bootstrap validators to set up in sovereign L1 validator)
Local Machine Flags (Use Local Machine as Bootstrap Validator):
--avalanchego-path string use this avalanchego binary path
--avalanchego-version string use this version of avalanchego (ex: v1.17.12)
--http-port uintSlice http port for node(s)
--partial-sync set primary network partial sync for new validators
--staking-cert-key-path stringSlice path to provided staking cert key for node(s)
--staking-port uintSlice staking port for node(s)
--staking-signer-key-path stringSlice path to provided staking signer key for node(s)
--staking-tls-key-path stringSlice path to provided staking TLS key for node(s)
--use-local-machine use local machine as a blockchain validator
Local Network Flags:
--avalanchego-path string use this avalanchego binary path
--avalanchego-version string use this version of avalanchego (ex: v1.17.12)
--num-nodes uint32 number of nodes to be created on local network deploy
Non Subnet-Only-Validators (Non-SOV) Flags:
--auth-keys stringSlice control keys that will be used to authenticate chain creation
--control-keys stringSlice addresses that may make blockchain changes
--same-control-key use the fee-paying key as control key
--threshold uint32 required number of control key signatures to make blockchain changes
ICM Flags:
--cchain-funding-key string key to be used to fund relayer account on cchain
--cchain-icm-key string key to be used to pay for ICM deploys on C-Chain
--icm-key string key to be used to pay for ICM deploys
--icm-version string ICM version to deploy
--relay-cchain relay C-Chain as source and destination
--relayer-allow-private-ips allow relayer to connec to private ips
--relayer-amount float64 automatically fund relayer fee payments with the given amount
--relayer-key string key to be used by default both for rewards and to pay fees
--relayer-log-level string log level to be used for relayer logs
--relayer-path string relayer binary to use
--relayer-version string relayer version to deploy
--skip-icm-deploy Skip automatic ICM deploy
--skip-relayer skip relayer deploy
--teleporter-messenger-contract-address-path string path to an ICM Messenger contract address file
--teleporter-messenger-deployer-address-path string path to an ICM Messenger deployer address file
--teleporter-messenger-deployer-tx-path string path to an ICM Messenger deployer tx file
--teleporter-registry-bytecode-path string path to an ICM Registry bytecode file
Proof Of Stake Flags:
--pos-maximum-stake-amount uint64 maximum stake amount
--pos-maximum-stake-multiplier uint8 maximum stake multiplier
--pos-minimum-delegation-fee uint16 minimum delegation fee
--pos-minimum-stake-amount uint64 minimum stake amount
--pos-minimum-stake-duration uint64 minimum stake duration (in seconds)
--pos-weight-to-value-factor uint64 weight to value factor
Signature Aggregator Flags:
--aggregator-log-level string log level to use with signature aggregator
--aggregator-log-to-stdout use stdout for signature aggregator logs
```
### describe
The blockchain describe command prints the details of a Blockchain configuration to the console.
By default, the command prints a summary of the configuration. By providing the --genesis
flag, the command instead prints out the raw genesis file.
**Usage:**
```bash
avalanche blockchain describe [subcommand] [flags]
```
**Flags:**
```bash
-g, --genesis Print the genesis to the console directly instead of the summary
-h, --help help for describe
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### export
The blockchain export command write the details of an existing Blockchain deploy to a file.
The command prompts for an output path. You can also provide one with
the --output flag.
**Usage:**
```bash
avalanche blockchain export [subcommand] [flags]
```
**Flags:**
```bash
--custom-vm-branch string custom vm branch
--custom-vm-build-script string custom vm build-script
--custom-vm-repo-url string custom vm repository url
-h, --help help for export
-o, --output string write the export data to the provided file path
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### import
Import blockchain configurations into avalanche-cli.
This command suite supports importing from a file created on another computer,
or importing from blockchains running public networks
(e.g. created manually or with the deprecated subnet-cli)
**Usage:**
```bash
avalanche blockchain import [subcommand] [flags]
```
**Subcommands:**
- [`file`](#avalanche-blockchain-import-file): The blockchain import command will import a blockchain configuration from a file or a git repository.
To import from a file, you can optionally provide the path as a command-line argument.
Alternatively, running the command without any arguments triggers an interactive wizard.
To import from a repository, go through the wizard. By default, an imported Blockchain doesn't
overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
- [`public`](#avalanche-blockchain-import-public): The blockchain import public command imports a Blockchain configuration from a running network.
By default, an imported Blockchain
doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
**Flags:**
```bash
-h, --help help for import
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### import file
The blockchain import command will import a blockchain configuration from a file or a git repository.
To import from a file, you can optionally provide the path as a command-line argument.
Alternatively, running the command without any arguments triggers an interactive wizard.
To import from a repository, go through the wizard. By default, an imported Blockchain doesn't
overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
**Usage:**
```bash
avalanche blockchain import file [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string the blockchain configuration to import from the provided repo
--branch string the repo branch to use if downloading a new repo
-f, --force overwrite the existing configuration if one exists
-h, --help help for file
--repo string the repo to import (ex: ava-labs/avalanche-plugins-core) or url to download the repo from
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### import public
The blockchain import public command imports a Blockchain configuration from a running network.
By default, an imported Blockchain
doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
**Usage:**
```bash
avalanche blockchain import public [subcommand] [flags]
```
**Flags:**
```bash
--blockchain-id string the blockchain ID
--cluster string operate on the given cluster
--custom use a custom VM template
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--evm import a subnet-evm
--force overwrite the existing configuration if one exists
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for public
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-url string [optional] URL of an already running validator
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### join
The blockchain join command configures your validator node to begin validating a new Blockchain.
To complete this process, you must have access to the machine running your validator. If the
CLI is running on the same machine as your validator, it can generate or update your node's
config file automatically. Alternatively, the command can print the necessary instructions
to update your node manually. To complete the validation process, the Blockchain's admins must add
the NodeID of your validator to the Blockchain's allow list by calling addValidator with your
NodeID.
After you update your validator's config, you need to restart your validator manually. If
you provide the --avalanchego-config flag, this command attempts to edit the config file
at that path.
This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet.
**Usage:**
```bash
avalanche blockchain join [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-config string file path of the avalanchego config file
--cluster string operate on the given cluster
--data-dir string path of avalanchego's data dir directory
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force-write if true, skip to prompt to overwrite the config file
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for join
-k, --key string select the key to use [fuji only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-id string set the NodeID of the validator to check
--plugin-dir string file path of avalanchego's plugin directory
--print if true, print the manual config without prompting
--stake-amount uint amount of tokens to stake on validator
--staking-period duration how long validator validates for after start time
--start-time string start time that validator starts validating
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### list
The blockchain list command prints the names of all created Blockchain configurations. Without any flags,
it prints some general, static information about the Blockchain. With the --deployed flag, the command
shows additional information including the VMID, BlockchainID and SubnetID.
**Usage:**
```bash
avalanche blockchain list [subcommand] [flags]
```
**Flags:**
```bash
--deployed show additional deploy information
-h, --help help for list
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### publish
The blockchain publish command publishes the Blockchain's VM to a repository.
**Usage:**
```bash
avalanche blockchain publish [subcommand] [flags]
```
**Flags:**
```bash
--alias string We publish to a remote repo, but identify the repo locally under a user-provided alias (e.g. myrepo).
--force If true, ignores if the blockchain has been published in the past, and attempts a forced publish.
-h, --help help for publish
--no-repo-path string Do not let the tool manage file publishing, but have it only generate the files and put them in the location given by this flag.
--repo-url string The URL of the repo where we are publishing
--subnet-file-path string Path to the Blockchain description file. If not given, a prompting sequence will be initiated.
--vm-file-path string Path to the VM description file. If not given, a prompting sequence will be initiated.
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### removeValidator
The blockchain removeValidator command stops a whitelisted blockchain network validator from
validating your deployed Blockchain.
To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass
these prompts by providing the values with flags.
**Usage:**
```bash
avalanche blockchain removeValidator [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true)
--aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation
--aggregator-log-level string log level to use with signature aggregator (default "Debug")
--aggregator-log-to-stdout use stdout for signature aggregator logs
--auth-keys strings (for non-SOV blockchain only) control keys that will be used to authenticate the removeValidator tx
--blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's removal (blockchain gas token)
--blockchain-key string CLI stored key to use to pay fees for completing the validator's removal (blockchain gas token)
--blockchain-private-key string private key to use to pay fees for completing the validator's removal (blockchain gas token)
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force force validator removal even if it's not getting rewarded
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for removeValidator
-k, --key string select the key to use [fuji deploy only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-endpoint string remove validator that responds to the given endpoint
--node-id string node-id of the validator
--output-tx-path string (for non-SOV blockchain only) file path of the removeValidator tx
--rpc string connect to validator manager at the given rpc endpoint
-t, --testnet fuji operate on testnet (alias to fuji)
--uptime uint validator's uptime in seconds. If not provided, it will be automatically calculated
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### stats
The blockchain stats command prints validator statistics for the given Blockchain.
**Usage:**
```bash
avalanche blockchain stats [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for stats
-l, --local operate on a local network
-m, --mainnet operate on mainnet
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### upgrade
The blockchain upgrade command suite provides a collection of tools for
updating your developmental and deployed Blockchains.
**Usage:**
```bash
avalanche blockchain upgrade [subcommand] [flags]
```
**Subcommands:**
- [`apply`](#avalanche-blockchain-upgrade-apply): Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade.
For public networks (Fuji Testnet or Mainnet), to complete this process,
you must have access to the machine running your validator.
If the CLI is running on the same machine as your validator, it can manipulate your node's
configuration automatically. Alternatively, the command can print the necessary instructions
to upgrade your node manually.
After you update your validator's configuration, you need to restart your validator manually.
If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path.
Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation.
- [`export`](#avalanche-blockchain-upgrade-export): Export the upgrade bytes file to a location of choice on disk
- [`generate`](#avalanche-blockchain-upgrade-generate): The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It
guides the user through the process using an interactive wizard.
- [`import`](#avalanche-blockchain-upgrade-import): Import the upgrade bytes file into the local environment
- [`print`](#avalanche-blockchain-upgrade-print): Print the upgrade.json file content
- [`vm`](#avalanche-blockchain-upgrade-vm): The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command
can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet.
The command walks the user through an interactive wizard. The user can skip the wizard by providing
command line flags.
**Flags:**
```bash
-h, --help help for upgrade
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade apply
Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade.
For public networks (Fuji Testnet or Mainnet), to complete this process,
you must have access to the machine running your validator.
If the CLI is running on the same machine as your validator, it can manipulate your node's
configuration automatically. Alternatively, the command can print the necessary instructions
to upgrade your node manually.
After you update your validator's configuration, you need to restart your validator manually.
If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path.
Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation.
**Usage:**
```bash
avalanche blockchain upgrade apply [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-chain-config-dir string avalanchego's chain config file directory (default "/home/runner/.avalanchego/chains")
--config create upgrade config for future subnet deployments (same as generate)
--force If true, don't prompt for confirmation of timestamps in the past
--fuji fuji apply upgrade existing fuji deployment (alias for `testnet`)
-h, --help help for apply
--local local apply upgrade existing local deployment
--mainnet mainnet apply upgrade existing mainnet deployment
--print if true, print the manual config without prompting (for public networks only)
--testnet testnet apply upgrade existing testnet deployment (alias for `fuji`)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade export
Export the upgrade bytes file to a location of choice on disk
**Usage:**
```bash
avalanche blockchain upgrade export [subcommand] [flags]
```
**Flags:**
```bash
--force If true, overwrite a possibly existing file without prompting
-h, --help help for export
--upgrade-filepath string Export upgrade bytes file to location of choice on disk
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade generate
The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It
guides the user through the process using an interactive wizard.
**Usage:**
```bash
avalanche blockchain upgrade generate [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for generate
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade import
Import the upgrade bytes file into the local environment
**Usage:**
```bash
avalanche blockchain upgrade import [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for import
--upgrade-filepath string Import upgrade bytes file into local environment
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade print
Print the upgrade.json file content
**Usage:**
```bash
avalanche blockchain upgrade print [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for print
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade vm
The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command
can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet.
The command walks the user through an interactive wizard. The user can skip the wizard by providing
command line flags.
**Usage:**
```bash
avalanche blockchain upgrade vm [subcommand] [flags]
```
**Flags:**
```bash
--binary string Upgrade to custom binary
--config upgrade config for future subnet deployments
--fuji fuji upgrade existing fuji deployment (alias for `testnet`)
-h, --help help for vm
--latest upgrade to latest version
--local local upgrade existing local deployment
--mainnet mainnet upgrade existing mainnet deployment
--plugin-dir string plugin directory to automatically upgrade VM
--print print instructions for upgrading
--testnet testnet upgrade existing testnet deployment (alias for `fuji`)
--version string Upgrade to custom version
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### validators
The blockchain validators command lists the validators of a blockchain and provides
several statistics about them.
**Usage:**
```bash
avalanche blockchain validators [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for validators
-l, --local operate on a local network
-m, --mainnet operate on mainnet
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### vmid
The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain.
**Usage:**
```bash
avalanche blockchain vmid [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for vmid
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche config
Customize configuration for Avalanche-CLI
**Usage:**
```bash
avalanche config [subcommand] [flags]
```
**Subcommands:**
- [`authorize-cloud-access`](#avalanche-config-authorize-cloud-access): set preferences to authorize access to cloud resources
- [`metrics`](#avalanche-config-metrics): set user metrics collection preferences
- [`migrate`](#avalanche-config-migrate): migrate command migrates old ~/.avalanche-cli.json and ~/.avalanche-cli/config to /.avalanche-cli/config.json..
- [`snapshotsAutoSave`](#avalanche-config-snapshotsautosave): set user preference between auto saving local network snapshots or not
- [`update`](#avalanche-config-update): set user preference between update check or not
**Flags:**
```bash
-h, --help help for config
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### authorize-cloud-access
set preferences to authorize access to cloud resources
**Usage:**
```bash
avalanche config authorize-cloud-access [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for authorize-cloud-access
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### metrics
set user metrics collection preferences
**Usage:**
```bash
avalanche config metrics [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for metrics
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### migrate
migrate command migrates old ~/.avalanche-cli.json and ~/.avalanche-cli/config to /.avalanche-cli/config.json..
**Usage:**
```bash
avalanche config migrate [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for migrate
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### snapshotsAutoSave
set user preference between auto saving local network snapshots or not
**Usage:**
```bash
avalanche config snapshotsAutoSave [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for snapshotsAutoSave
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### update
set user preference between update check or not
**Usage:**
```bash
avalanche config update [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for update
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche contract
The contract command suite provides a collection of tools for deploying
and interacting with smart contracts.
**Usage:**
```bash
avalanche contract [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-contract-deploy): The contract command suite provides a collection of tools for deploying
smart contracts.
- [`initValidatorManager`](#avalanche-contract-initvalidatormanager): Initializes Proof of Authority(PoA) or Proof of Stake(PoS)Validator Manager contract on a Blockchain and sets up initial validator set on the Blockchain. For more info on Validator Manager, please head to https://github.com/ava-labs/icm-contracts/tree/main/contracts/validator-manager
**Flags:**
```bash
-h, --help help for contract
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### deploy
The contract command suite provides a collection of tools for deploying
smart contracts.
**Usage:**
```bash
avalanche contract deploy [subcommand] [flags]
```
**Subcommands:**
- [`erc20`](#avalanche-contract-deploy-erc20): Deploy an ERC20 token into a given Network and Blockchain
**Flags:**
```bash
-h, --help help for deploy
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### deploy erc20
Deploy an ERC20 token into a given Network and Blockchain
**Usage:**
```bash
avalanche contract deploy erc20 [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string deploy the ERC20 contract into the given CLI blockchain
--blockchain-id string deploy the ERC20 contract into the given blockchain ID/Alias
--c-chain deploy the ERC20 contract into C-Chain
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--funded string set the funded address
--genesis-key use genesis allocated key as contract deployer
-h, --help help for erc20
--key string CLI stored key to use as contract deployer
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--private-key string private key to use as contract deployer
--rpc string deploy the contract into the given rpc endpoint
--supply uint set the token supply
--symbol string set the token symbol
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### initValidatorManager
Initializes Proof of Authority(PoA) or Proof of Stake(PoS)Validator Manager contract on a Blockchain and sets up initial validator set on the Blockchain. For more info on Validator Manager, please head to https://github.com/ava-labs/icm-contracts/tree/main/contracts/validator-manager
**Usage:**
```bash
avalanche contract initValidatorManager [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true)
--aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation
--aggregator-log-level string log level to use with signature aggregator (default "Debug")
--aggregator-log-to-stdout dump signature aggregator logs to stdout
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key as contract deployer
-h, --help help for initValidatorManager
--key string CLI stored key to use as contract deployer
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--pos-maximum-stake-amount uint (PoS only) maximum stake amount (default 1000)
--pos-maximum-stake-multiplier uint8 (PoS only )maximum stake multiplier (default 1)
--pos-minimum-delegation-fee uint16 (PoS only) minimum delegation fee (default 1)
--pos-minimum-stake-amount uint (PoS only) minimum stake amount (default 1)
--pos-minimum-stake-duration uint (PoS only) minimum stake duration (in seconds) (default 100)
--pos-reward-calculator-address string (PoS only) initialize the ValidatorManager with reward calculator address
--pos-weight-to-value-factor uint (PoS only) weight to value factor (default 1)
--private-key string private key to use as contract deployer
--rpc string deploy the contract into the given rpc endpoint
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche help
Help provides help for any command in the application.
Simply type avalanche help [path to command] for full details.
**Usage:**
```bash
avalanche help [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for help
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche icm
The messenger command suite provides a collection of tools for interacting
with ICM messenger contracts.
**Usage:**
```bash
avalanche icm [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-icm-deploy): Deploys ICM Messenger and Registry into a given L1.
- [`sendMsg`](#avalanche-icm-sendmsg): Sends and wait reception for a ICM msg between two blockchains.
**Flags:**
```bash
-h, --help help for icm
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### deploy
Deploys ICM Messenger and Registry into a given L1.
For Local Networks, it also deploys into C-Chain.
**Usage:**
```bash
avalanche icm deploy [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string deploy ICM into the given CLI blockchain
--blockchain-id string deploy ICM into the given blockchain ID/Alias
--c-chain deploy ICM into C-Chain
--cchain-key string key to be used to pay fees to deploy ICM to C-Chain
--cluster string operate on the given cluster
--deploy-messenger deploy ICM Messenger (default true)
--deploy-registry deploy ICM Registry (default true)
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force-registry-deploy deploy ICM Registry even if Messenger has already been deployed
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key to fund ICM deploy
-h, --help help for deploy
--include-cchain deploy ICM also to C-Chain
--key string CLI stored key to use to fund ICM deploy
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--messenger-contract-address-path string path to a messenger contract address file
--messenger-deployer-address-path string path to a messenger deployer address file
--messenger-deployer-tx-path string path to a messenger deployer tx file
--private-key string private key to use to fund ICM deploy
--registry-bytecode-path string path to a registry bytecode file
--rpc-url string use the given RPC URL to connect to the subnet
-t, --testnet fuji operate on testnet (alias to fuji)
--version string version to deploy (default "latest")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### sendMsg
Sends and wait reception for a ICM msg between two blockchains.
**Usage:**
```bash
avalanche icm sendMsg [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--dest-rpc string use the given destination blockchain rpc endpoint
--destination-address string deliver the message to the given contract destination address
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key as message originator and to pay source blockchain fees
-h, --help help for sendMsg
--hex-encoded given message is hex encoded
--key string CLI stored key to use as message originator and to pay source blockchain fees
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--private-key string private key to use as message originator and to pay source blockchain fees
--source-rpc string use the given source blockchain rpc endpoint
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche ictt
The ictt command suite provides tools to deploy and manage Interchain Token Transferrers.
**Usage:**
```bash
avalanche ictt [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-ictt-deploy): Deploys a Token Transferrer into a given Network and Subnets
**Flags:**
```bash
-h, --help help for ictt
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### deploy
Deploys a Token Transferrer into a given Network and Subnets
**Usage:**
```bash
avalanche ictt deploy [subcommand] [flags]
```
**Flags:**
```bash
--c-chain-home set the Transferrer's Home Chain into C-Chain
--c-chain-remote set the Transferrer's Remote Chain into C-Chain
--cluster string operate on the given cluster
--deploy-erc20-home string deploy a Transferrer Home for the given Chain's ERC20 Token
--deploy-native-home deploy a Transferrer Home for the Chain's Native Token
--deploy-native-remote deploy a Transferrer Remote for the Chain's Native Token
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for deploy
--home-blockchain string set the Transferrer's Home Chain into the given CLI blockchain
--home-genesis-key use genesis allocated key to deploy Transferrer Home
--home-key string CLI stored key to use to deploy Transferrer Home
--home-private-key string private key to use to deploy Transferrer Home
--home-rpc string use the given RPC URL to connect to the home blockchain
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--remote-blockchain string set the Transferrer's Remote Chain into the given CLI blockchain
--remote-genesis-key use genesis allocated key to deploy Transferrer Remote
--remote-key string CLI stored key to use to deploy Transferrer Remote
--remote-private-key string private key to use to deploy Transferrer Remote
--remote-rpc string use the given RPC URL to connect to the remote blockchain
--remote-token-decimals uint8 use the given number of token decimals for the Transferrer Remote [defaults to token home's decimals (18 for a new wrapped native home token)]
--remove-minter-admin remove the native minter precompile admin found on remote blockchain genesis
-t, --testnet fuji operate on testnet (alias to fuji)
--use-home string use the given Transferrer's Home Address
--version string tag/branch/commit of Avalanche Interchain Token Transfer (ICTT) to be used (defaults to main branch)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche interchain
The interchain command suite provides a collection of tools to
set and manage interoperability between blockchains.
**Usage:**
```bash
avalanche interchain [subcommand] [flags]
```
**Subcommands:**
- [`messenger`](#avalanche-interchain-messenger): The messenger command suite provides a collection of tools for interacting
with ICM messenger contracts.
- [`relayer`](#avalanche-interchain-relayer): The relayer command suite provides a collection of tools for deploying
and configuring an ICM relayers.
- [`tokenTransferrer`](#avalanche-interchain-tokentransferrer): The tokenTransfer command suite provides tools to deploy and manage Token Transferrers.
**Flags:**
```bash
-h, --help help for interchain
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### messenger
The messenger command suite provides a collection of tools for interacting
with ICM messenger contracts.
**Usage:**
```bash
avalanche interchain messenger [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-interchain-messenger-deploy): Deploys ICM Messenger and Registry into a given L1.
- [`sendMsg`](#avalanche-interchain-messenger-sendmsg): Sends and wait reception for a ICM msg between two blockchains.
**Flags:**
```bash
-h, --help help for messenger
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### messenger deploy
Deploys ICM Messenger and Registry into a given L1.
For Local Networks, it also deploys into C-Chain.
**Usage:**
```bash
avalanche interchain messenger deploy [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string deploy ICM into the given CLI blockchain
--blockchain-id string deploy ICM into the given blockchain ID/Alias
--c-chain deploy ICM into C-Chain
--cchain-key string key to be used to pay fees to deploy ICM to C-Chain
--cluster string operate on the given cluster
--deploy-messenger deploy ICM Messenger (default true)
--deploy-registry deploy ICM Registry (default true)
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force-registry-deploy deploy ICM Registry even if Messenger has already been deployed
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key to fund ICM deploy
-h, --help help for deploy
--include-cchain deploy ICM also to C-Chain
--key string CLI stored key to use to fund ICM deploy
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--messenger-contract-address-path string path to a messenger contract address file
--messenger-deployer-address-path string path to a messenger deployer address file
--messenger-deployer-tx-path string path to a messenger deployer tx file
--private-key string private key to use to fund ICM deploy
--registry-bytecode-path string path to a registry bytecode file
--rpc-url string use the given RPC URL to connect to the subnet
-t, --testnet fuji operate on testnet (alias to fuji)
--version string version to deploy (default "latest")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### messenger sendMsg
Sends and wait reception for a ICM msg between two blockchains.
**Usage:**
```bash
avalanche interchain messenger sendMsg [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--dest-rpc string use the given destination blockchain rpc endpoint
--destination-address string deliver the message to the given contract destination address
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key as message originator and to pay source blockchain fees
-h, --help help for sendMsg
--hex-encoded given message is hex encoded
--key string CLI stored key to use as message originator and to pay source blockchain fees
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--private-key string private key to use as message originator and to pay source blockchain fees
--source-rpc string use the given source blockchain rpc endpoint
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### relayer
The relayer command suite provides a collection of tools for deploying
and configuring an ICM relayers.
**Usage:**
```bash
avalanche interchain relayer [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-interchain-relayer-deploy): Deploys an ICM Relayer for the given Network.
- [`logs`](#avalanche-interchain-relayer-logs): Shows pretty formatted AWM relayer logs
- [`start`](#avalanche-interchain-relayer-start): Starts AWM relayer on the specified network (Currently only for local network).
- [`stop`](#avalanche-interchain-relayer-stop): Stops AWM relayer on the specified network (Currently only for local network, cluster).
**Flags:**
```bash
-h, --help help for relayer
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### relayer deploy
Deploys an ICM Relayer for the given Network.
**Usage:**
```bash
avalanche interchain relayer deploy [subcommand] [flags]
```
**Flags:**
```bash
--allow-private-ips allow relayer to connec to private ips (default true)
--amount float automatically fund l1s fee payments with the given amount
--bin-path string use the given relayer binary
--blockchain-funding-key string key to be used to fund relayer account on all l1s
--blockchains strings blockchains to relay as source and destination
--cchain relay C-Chain as source and destination
--cchain-amount float automatically fund cchain fee payments with the given amount
--cchain-funding-key string key to be used to fund relayer account on cchain
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for deploy
--key string key to be used by default both for rewards and to pay fees
-l, --local operate on a local network
--log-level string log level to use for relayer logs
-t, --testnet fuji operate on testnet (alias to fuji)
--version string version to deploy (default "latest-prerelease")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--skip-update-check skip check for new versions
```
#### relayer logs
Shows pretty formatted AWM relayer logs
**Usage:**
```bash
avalanche interchain relayer logs [subcommand] [flags]
```
**Flags:**
```bash
--endpoint string use the given endpoint for network operations
--first uint output first N log lines
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for logs
--last uint output last N log lines
-l, --local operate on a local network
--raw raw logs output
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### relayer start
Starts AWM relayer on the specified network (Currently only for local network).
**Usage:**
```bash
avalanche interchain relayer start [subcommand] [flags]
```
**Flags:**
```bash
--bin-path string use the given relayer binary
--cluster string operate on the given cluster
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for start
-l, --local operate on a local network
-t, --testnet fuji operate on testnet (alias to fuji)
--version string version to use (default "latest-prerelease")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### relayer stop
Stops AWM relayer on the specified network (Currently only for local network, cluster).
**Usage:**
```bash
avalanche interchain relayer stop [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for stop
-l, --local operate on a local network
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### tokenTransferrer
The tokenTransfer command suite provides tools to deploy and manage Token Transferrers.
**Usage:**
```bash
avalanche interchain tokenTransferrer [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-interchain-tokentransferrer-deploy): Deploys a Token Transferrer into a given Network and Subnets
**Flags:**
```bash
-h, --help help for tokenTransferrer
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### tokenTransferrer deploy
Deploys a Token Transferrer into a given Network and Subnets
**Usage:**
```bash
avalanche interchain tokenTransferrer deploy [subcommand] [flags]
```
**Flags:**
```bash
--c-chain-home set the Transferrer's Home Chain into C-Chain
--c-chain-remote set the Transferrer's Remote Chain into C-Chain
--cluster string operate on the given cluster
--deploy-erc20-home string deploy a Transferrer Home for the given Chain's ERC20 Token
--deploy-native-home deploy a Transferrer Home for the Chain's Native Token
--deploy-native-remote deploy a Transferrer Remote for the Chain's Native Token
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for deploy
--home-blockchain string set the Transferrer's Home Chain into the given CLI blockchain
--home-genesis-key use genesis allocated key to deploy Transferrer Home
--home-key string CLI stored key to use to deploy Transferrer Home
--home-private-key string private key to use to deploy Transferrer Home
--home-rpc string use the given RPC URL to connect to the home blockchain
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--remote-blockchain string set the Transferrer's Remote Chain into the given CLI blockchain
--remote-genesis-key use genesis allocated key to deploy Transferrer Remote
--remote-key string CLI stored key to use to deploy Transferrer Remote
--remote-private-key string private key to use to deploy Transferrer Remote
--remote-rpc string use the given RPC URL to connect to the remote blockchain
--remote-token-decimals uint8 use the given number of token decimals for the Transferrer Remote [defaults to token home's decimals (18 for a new wrapped native home token)]
--remove-minter-admin remove the native minter precompile admin found on remote blockchain genesis
-t, --testnet fuji operate on testnet (alias to fuji)
--use-home string use the given Transferrer's Home Address
--version string tag/branch/commit of Avalanche Interchain Token Transfer (ICTT) to be used (defaults to main branch)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche key
The key command suite provides a collection of tools for creating and managing
signing keys. You can use these keys to deploy Subnets to the Fuji Testnet,
but these keys are NOT suitable to use in production environments. DO NOT use
these keys on Mainnet.
To get started, use the key create command.
**Usage:**
```bash
avalanche key [subcommand] [flags]
```
**Subcommands:**
- [`create`](#avalanche-key-create): The key create command generates a new private key to use for creating and controlling
test Subnets. Keys generated by this command are NOT cryptographically secure enough to
use in production environments. DO NOT use these keys on Mainnet.
The command works by generating a secp256 key and storing it with the provided keyName. You
can use this key in other commands by providing this keyName.
If you'd like to import an existing key instead of generating one from scratch, provide the
--file flag.
- [`delete`](#avalanche-key-delete): The key delete command deletes an existing signing key.
To delete a key, provide the keyName. The command prompts for confirmation
before deleting the key. To skip the confirmation, provide the --force flag.
- [`export`](#avalanche-key-export): The key export command exports a created signing key. You can use an exported key in other
applications or import it into another instance of Avalanche-CLI.
By default, the tool writes the hex encoded key to stdout. If you provide the --output
flag, the command writes the key to a file of your choosing.
- [`list`](#avalanche-key-list): The key list command prints information for all stored signing
keys or for the ledger addresses associated to certain indices.
- [`transfer`](#avalanche-key-transfer): The key transfer command allows to transfer funds between stored keys or ledger addresses.
**Flags:**
```bash
-h, --help help for key
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### create
The key create command generates a new private key to use for creating and controlling
test Subnets. Keys generated by this command are NOT cryptographically secure enough to
use in production environments. DO NOT use these keys on Mainnet.
The command works by generating a secp256 key and storing it with the provided keyName. You
can use this key in other commands by providing this keyName.
If you'd like to import an existing key instead of generating one from scratch, provide the
--file flag.
**Usage:**
```bash
avalanche key create [subcommand] [flags]
```
**Flags:**
```bash
--file string import the key from an existing key file
-f, --force overwrite an existing key with the same name
-h, --help help for create
--skip-balances do not query public network balances for an imported key
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### delete
The key delete command deletes an existing signing key.
To delete a key, provide the keyName. The command prompts for confirmation
before deleting the key. To skip the confirmation, provide the --force flag.
**Usage:**
```bash
avalanche key delete [subcommand] [flags]
```
**Flags:**
```bash
-f, --force delete the key without confirmation
-h, --help help for delete
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### export
The key export command exports a created signing key. You can use an exported key in other
applications or import it into another instance of Avalanche-CLI.
By default, the tool writes the hex encoded key to stdout. If you provide the --output
flag, the command writes the key to a file of your choosing.
**Usage:**
```bash
avalanche key export [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for export
-o, --output string write the key to the provided file path
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### list
The key list command prints information for all stored signing
keys or for the ledger addresses associated to certain indices.
**Usage:**
```bash
avalanche key list [subcommand] [flags]
```
**Flags:**
```bash
-a, --all-networks list all network addresses
--blockchains strings blockchains to show information about (p=p-chain, x=x-chain, c=c-chain, and blockchain names) (default p,x,c)
-c, --cchain list C-Chain addresses (default true)
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for list
--keys strings list addresses for the given keys
-g, --ledger uints list ledger addresses for the given indices (default [])
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--pchain list P-Chain addresses (default true)
--subnets strings subnets to show information about (p=p-chain, x=x-chain, c=c-chain, and blockchain names) (default p,x,c)
-t, --testnet fuji operate on testnet (alias to fuji)
--tokens strings provide balance information for the given token contract addresses (Evm only) (default [Native])
--use-gwei use gwei for EVM balances
-n, --use-nano-avax use nano Avax for balances
--xchain list X-Chain addresses (default true)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### transfer
The key transfer command allows to transfer funds between stored keys or ledger addresses.
**Usage:**
```bash
avalanche key transfer [subcommand] [flags]
```
**Flags:**
```bash
-o, --amount float amount to send or receive (AVAX or TOKEN units)
--c-chain-receiver receive at C-Chain
--c-chain-sender send from C-Chain
--cluster string operate on the given cluster
-a, --destination-addr string destination address
--destination-key string key associated to a destination address
--destination-subnet string subnet where the funds will be sent (token transferrer experimental)
--destination-transferrer-address string token transferrer address at the destination subnet (token transferrer experimental)
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for transfer
-k, --key string key associated to the sender or receiver address
-i, --ledger uint32 ledger index associated to the sender or receiver address (default 32768)
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--origin-subnet string subnet where the funds belong (token transferrer experimental)
--origin-transferrer-address string token transferrer address at the origin subnet (token transferrer experimental)
--p-chain-receiver receive at P-Chain
--p-chain-sender send from P-Chain
--receiver-blockchain string receive at the given CLI blockchain
--receiver-blockchain-id string receive at the given blockchain ID/Alias
--sender-blockchain string send from the given CLI blockchain
--sender-blockchain-id string send from the given blockchain ID/Alias
-t, --testnet fuji operate on testnet (alias to fuji)
--x-chain-receiver receive at X-Chain
--x-chain-sender send from X-Chain
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche network
The network command suite provides a collection of tools for managing local Blockchain
deployments.
When you deploy a Blockchain locally, it runs on a local, multi-node Avalanche network. The
blockchain deploy command starts this network in the background. This command suite allows you
to shutdown, restart, and clear that network.
This network currently supports multiple, concurrently deployed Blockchains.
**Usage:**
```bash
avalanche network [subcommand] [flags]
```
**Subcommands:**
- [`clean`](#avalanche-network-clean): The network clean command shuts down your local, multi-node network. All deployed Subnets
shutdown and delete their state. You can restart the network by deploying a new Subnet
configuration.
- [`start`](#avalanche-network-start): The network start command starts a local, multi-node Avalanche network on your machine.
By default, the command loads the default snapshot. If you provide the --snapshot-name
flag, the network loads that snapshot instead. The command fails if the local network is
already running.
- [`status`](#avalanche-network-status): The network status command prints whether or not a local Avalanche
network is running and some basic stats about the network.
- [`stop`](#avalanche-network-stop): The network stop command shuts down your local, multi-node network.
All deployed Subnets shutdown gracefully and save their state. If you provide the
--snapshot-name flag, the network saves its state under this named snapshot. You can
reload this snapshot with network start --snapshot-name `snapshotName`. Otherwise, the
network saves to the default snapshot, overwriting any existing state. You can reload the
default snapshot with network start.
**Flags:**
```bash
-h, --help help for network
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### clean
The network clean command shuts down your local, multi-node network. All deployed Subnets
shutdown and delete their state. You can restart the network by deploying a new Subnet
configuration.
**Usage:**
```bash
avalanche network clean [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for clean
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### start
The network start command starts a local, multi-node Avalanche network on your machine.
By default, the command loads the default snapshot. If you provide the --snapshot-name
flag, the network loads that snapshot instead. The command fails if the local network is
already running.
**Usage:**
```bash
avalanche network start [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-path string use this avalanchego binary path
--avalanchego-version string use this version of avalanchego (ex: v1.17.12) (default "latest-prerelease")
-h, --help help for start
--num-nodes uint32 number of nodes to be created on local network (default 2)
--relayer-path string use this relayer binary path
--relayer-version string use this relayer version (default "latest-prerelease")
--snapshot-name string name of snapshot to use to start the network from (default "default")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### status
The network status command prints whether or not a local Avalanche
network is running and some basic stats about the network.
**Usage:**
```bash
avalanche network status [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for status
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### stop
The network stop command shuts down your local, multi-node network.
All deployed Subnets shutdown gracefully and save their state. If you provide the
--snapshot-name flag, the network saves its state under this named snapshot. You can
reload this snapshot with network start --snapshot-name `snapshotName`. Otherwise, the
network saves to the default snapshot, overwriting any existing state. You can reload the
default snapshot with network start.
**Usage:**
```bash
avalanche network stop [subcommand] [flags]
```
**Flags:**
```bash
--dont-save do not save snapshot, just stop the network
-h, --help help for stop
--snapshot-name string name of snapshot to use to save network state into (default "default")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche node
The node command suite provides a collection of tools for creating and maintaining
validators on Avalanche Network.
To get started, use the node create command wizard to walk through the
configuration to make your node a primary validator on Avalanche public network. You can use the
rest of the commands to maintain your node and make your node a Subnet Validator.
**Usage:**
```bash
avalanche node [subcommand] [flags]
```
**Subcommands:**
- [`addDashboard`](#avalanche-node-adddashboard): (ALPHA Warning) This command is currently in experimental mode.
The node addDashboard command adds custom dashboard to the Grafana monitoring dashboard for the
cluster.
- [`create`](#avalanche-node-create): (ALPHA Warning) This command is currently in experimental mode.
The node create command sets up a validator on a cloud server of your choice.
The validator will be validating the Avalanche Primary Network and Subnet
of your choice. By default, the command runs an interactive wizard. It
walks you through all the steps you need to set up a validator.
Once this command is completed, you will have to wait for the validator
to finish bootstrapping on the primary network before running further
commands on it, e.g. validating a Subnet. You can check the bootstrapping
status by running avalanche node status
The created node will be part of group of validators called `clusterName`
and users can call node commands with `clusterName` so that the command
will apply to all nodes in the cluster
- [`destroy`](#avalanche-node-destroy): (ALPHA Warning) This command is currently in experimental mode.
The node destroy command terminates all running nodes in cloud server and deletes all storage disks.
If there is a static IP address attached, it will be released.
- [`devnet`](#avalanche-node-devnet): (ALPHA Warning) This command is currently in experimental mode.
The node devnet command suite provides a collection of commands related to devnets.
You can check the updated status by calling avalanche node status `clusterName`
- [`export`](#avalanche-node-export): (ALPHA Warning) This command is currently in experimental mode.
The node export command exports cluster configuration and its nodes config to a text file.
If no file is specified, the configuration is printed to the stdout.
Use --include-secrets to include keys in the export. In this case please keep the file secure as it contains sensitive information.
Exported cluster configuration without secrets can be imported by another user using node import command.
- [`import`](#avalanche-node-import): (ALPHA Warning) This command is currently in experimental mode.
The node import command imports cluster configuration and its nodes configuration from a text file
created from the node export command.
Prior to calling this command, call node whitelist command to have your SSH public key and IP whitelisted by
the cluster owner. This will enable you to use avalanche-cli commands to manage the imported cluster.
Please note, that this imported cluster will be considered as EXTERNAL by avalanche-cli, so some commands
affecting cloud nodes like node create or node destroy will be not applicable to it.
- [`list`](#avalanche-node-list): (ALPHA Warning) This command is currently in experimental mode.
The node list command lists all clusters together with their nodes.
- [`loadtest`](#avalanche-node-loadtest): (ALPHA Warning) This command is currently in experimental mode.
The node loadtest command suite starts and stops a load test for an existing devnet cluster.
- [`local`](#avalanche-node-local): The node local command suite provides a collection of commands related to local nodes
- [`refresh-ips`](#avalanche-node-refresh-ips): (ALPHA Warning) This command is currently in experimental mode.
The node refresh-ips command obtains the current IP for all nodes with dynamic IPs in the cluster,
and updates the local node information used by CLI commands.
- [`resize`](#avalanche-node-resize): (ALPHA Warning) This command is currently in experimental mode.
The node resize command can change the amount of CPU, memory and disk space available for the cluster nodes.
- [`scp`](#avalanche-node-scp): (ALPHA Warning) This command is currently in experimental mode.
The node scp command securely copies files to and from nodes. Remote source or destionation can be specified using the following format:
[clusterName|nodeID|instanceID|IP]:/path/to/file. Regular expressions are supported for the source files like /tmp/*.txt.
File transfer to the nodes are parallelized. IF source or destination is cluster, the other should be a local file path.
If both destinations are remote, they must be nodes for the same cluster and not clusters themselves.
For example:
$ avalanche node scp [cluster1|node1]:/tmp/file.txt /tmp/file.txt
$ avalanche node scp /tmp/file.txt [cluster1|NodeID-XXXX]:/tmp/file.txt
$ avalanche node scp node1:/tmp/file.txt NodeID-XXXX:/tmp/file.txt
- [`ssh`](#avalanche-node-ssh): (ALPHA Warning) This command is currently in experimental mode.
The node ssh command execute a given command [cmd] using ssh on all nodes in the cluster if ClusterName is given.
If no command is given, just prints the ssh command to be used to connect to each node in the cluster.
For provided NodeID or InstanceID or IP, the command [cmd] will be executed on that node.
If no [cmd] is provided for the node, it will open ssh shell there.
- [`status`](#avalanche-node-status): (ALPHA Warning) This command is currently in experimental mode.
The node status command gets the bootstrap status of all nodes in a cluster with the Primary Network.
If no cluster is given, defaults to node list behaviour.
To get the bootstrap status of a node with a Blockchain, use --blockchain flag
- [`sync`](#avalanche-node-sync): (ALPHA Warning) This command is currently in experimental mode.
The node sync command enables all nodes in a cluster to be bootstrapped to a Blockchain.
You can check the blockchain bootstrap status by calling avalanche node status `clusterName` --blockchain `blockchainName`
- [`update`](#avalanche-node-update): (ALPHA Warning) This command is currently in experimental mode.
The node update command suite provides a collection of commands for nodes to update
their avalanchego or VM config.
You can check the status after update by calling avalanche node status
- [`upgrade`](#avalanche-node-upgrade): (ALPHA Warning) This command is currently in experimental mode.
The node update command suite provides a collection of commands for nodes to update
their avalanchego or VM version.
You can check the status after upgrade by calling avalanche node status
- [`validate`](#avalanche-node-validate): (ALPHA Warning) This command is currently in experimental mode.
The node validate command suite provides a collection of commands for nodes to join
the Primary Network and Subnets as validators.
If any of the commands is run before the nodes are bootstrapped on the Primary Network, the command
will fail. You can check the bootstrap status by calling avalanche node status `clusterName`
- [`whitelist`](#avalanche-node-whitelist): (ALPHA Warning) The whitelist command suite provides a collection of tools for granting access to the cluster.
Command adds IP if --ip params provided to cloud security access rules allowing it to access all nodes in the cluster via ssh or http.
It also command adds SSH public key to all nodes in the cluster if --ssh params is there.
If no params provided it detects current user IP automaticaly and whitelists it
**Flags:**
```bash
-h, --help help for node
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### addDashboard
(ALPHA Warning) This command is currently in experimental mode.
The node addDashboard command adds custom dashboard to the Grafana monitoring dashboard for the
cluster.
**Usage:**
```bash
avalanche node addDashboard [subcommand] [flags]
```
**Flags:**
```bash
--add-grafana-dashboard string path to additional grafana dashboard json file
-h, --help help for addDashboard
--subnet string subnet that the dasbhoard is intended for (if any)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### create
(ALPHA Warning) This command is currently in experimental mode.
The node create command sets up a validator on a cloud server of your choice.
The validator will be validating the Avalanche Primary Network and Subnet
of your choice. By default, the command runs an interactive wizard. It
walks you through all the steps you need to set up a validator.
Once this command is completed, you will have to wait for the validator
to finish bootstrapping on the primary network before running further
commands on it, e.g. validating a Subnet. You can check the bootstrapping
status by running avalanche node status
The created node will be part of group of validators called `clusterName`
and users can call node commands with `clusterName` so that the command
will apply to all nodes in the cluster
**Usage:**
```bash
avalanche node create [subcommand] [flags]
```
**Flags:**
```bash
--add-grafana-dashboard string path to additional grafana dashboard json file
--alternative-key-pair-name string key pair name to use if default one generates conflicts
--authorize-access authorize CLI to create cloud resources
--auto-replace-keypair automatically replaces key pair to access node if previous key pair is not found
--avalanchego-version-from-subnet string install latest avalanchego version, that is compatible with the given subnet, on node/s
--aws create node/s in AWS cloud
--aws-profile string aws profile to use (default "default")
--aws-volume-iops int AWS iops (for gp3, io1, and io2 volume types only) (default 3000)
--aws-volume-size int AWS volume size in GB (default 1000)
--aws-volume-throughput int AWS throughput in MiB/s (for gp3 volume type only) (default 125)
--aws-volume-type string AWS volume type (default "gp3")
--bootstrap-ids stringArray nodeIDs of bootstrap nodes
--bootstrap-ips stringArray IP:port pairs of bootstrap nodes
--cluster string operate on the given cluster
--custom-avalanchego-version string install given avalanchego version on node/s
--devnet operate on a devnet network
--enable-monitoring set up Prometheus monitoring for created nodes. This option creates a separate monitoring cloud instance and incures additional cost
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--gcp create node/s in GCP cloud
--gcp-credentials string use given GCP credentials
--gcp-project string use given GCP project
--genesis string path to genesis file
--grafana-pkg string use grafana pkg instead of apt repo(by default), for example https://dl.grafana.com/oss/release/grafana_10.4.1_amd64.deb
-h, --help help for create
--latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s
--latest-avalanchego-version install latest avalanchego release version on node/s
-m, --mainnet operate on mainnet
--node-type string cloud instance type. Use 'default' to use recommended default instance type
--num-apis ints number of API nodes(nodes without stake) to create in the new Devnet
--num-validators ints number of nodes to create per region(s). Use comma to separate multiple numbers for each region in the same order as --region flag
--partial-sync primary network partial sync (default true)
--public-http-port allow public access to avalanchego HTTP port
--region strings create node(s) in given region(s). Use comma to separate multiple regions
--ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used
-t, --testnet fuji operate on testnet (alias to fuji)
--upgrade string path to upgrade file
--use-ssh-agent use ssh agent(ex: Yubikey) for ssh auth
--use-static-ip attach static Public IP on cloud servers (default true)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### destroy
(ALPHA Warning) This command is currently in experimental mode.
The node destroy command terminates all running nodes in cloud server and deletes all storage disks.
If there is a static IP address attached, it will be released.
**Usage:**
```bash
avalanche node destroy [subcommand] [flags]
```
**Flags:**
```bash
--all destroy all existing clusters created by Avalanche CLI
--authorize-access authorize CLI to release cloud resources
-y, --authorize-all authorize all CLI requests
--authorize-remove authorize CLI to remove all local files related to cloud nodes
--aws-profile string aws profile to use (default "default")
-h, --help help for destroy
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### devnet
(ALPHA Warning) This command is currently in experimental mode.
The node devnet command suite provides a collection of commands related to devnets.
You can check the updated status by calling avalanche node status `clusterName`
**Usage:**
```bash
avalanche node devnet [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-node-devnet-deploy): (ALPHA Warning) This command is currently in experimental mode.
The node devnet deploy command deploys a subnet into a devnet cluster, creating subnet and blockchain txs for it.
It saves the deploy info both locally and remotely.
- [`wiz`](#avalanche-node-devnet-wiz): (ALPHA Warning) This command is currently in experimental mode.
The node wiz command creates a devnet and deploys, sync and validate a subnet into it. It creates the subnet if so needed.
**Flags:**
```bash
-h, --help help for devnet
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### devnet deploy
(ALPHA Warning) This command is currently in experimental mode.
The node devnet deploy command deploys a subnet into a devnet cluster, creating subnet and blockchain txs for it.
It saves the deploy info both locally and remotely.
**Usage:**
```bash
avalanche node devnet deploy [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for deploy
--no-checks do not check for healthy status or rpc compatibility of nodes against subnet
--subnet-aliases strings additional subnet aliases to be used for RPC calls in addition to subnet blockchain name
--subnet-only only create a subnet
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### devnet wiz
(ALPHA Warning) This command is currently in experimental mode.
The node wiz command creates a devnet and deploys, sync and validate a subnet into it. It creates the subnet if so needed.
**Usage:**
```bash
avalanche node devnet wiz [subcommand] [flags]
```
**Flags:**
```bash
--add-grafana-dashboard string path to additional grafana dashboard json file
--alternative-key-pair-name string key pair name to use if default one generates conflicts
--authorize-access authorize CLI to create cloud resources
--auto-replace-keypair automatically replaces key pair to access node if previous key pair is not found
--aws create node/s in AWS cloud
--aws-profile string aws profile to use (default "default")
--aws-volume-iops int AWS iops (for gp3, io1, and io2 volume types only) (default 3000)
--aws-volume-size int AWS volume size in GB (default 1000)
--aws-volume-throughput int AWS throughput in MiB/s (for gp3 volume type only) (default 125)
--aws-volume-type string AWS volume type (default "gp3")
--chain-config string path to the chain configuration for subnet
--custom-avalanchego-version string install given avalanchego version on node/s
--custom-subnet use a custom VM as the subnet virtual machine
--custom-vm-branch string custom vm branch or commit
--custom-vm-build-script string custom vm build-script
--custom-vm-repo-url string custom vm repository url
--default-validator-params use default weight/start/duration params for subnet validator
--deploy-icm-messenger deploy Interchain Messenger (default true)
--deploy-icm-registry deploy Interchain Registry (default true)
--deploy-teleporter-messenger deploy Interchain Messenger (default true)
--deploy-teleporter-registry deploy Interchain Registry (default true)
--enable-monitoring set up Prometheus monitoring for created nodes. Please note that this option creates a separate monitoring instance and incures additional cost
--evm-chain-id uint chain ID to use with Subnet-EVM
--evm-defaults use default production settings with Subnet-EVM
--evm-production-defaults use default production settings for your blockchain
--evm-subnet use Subnet-EVM as the subnet virtual machine
--evm-test-defaults use default test settings for your blockchain
--evm-token string token name to use with Subnet-EVM
--evm-version string version of Subnet-EVM to use
--force-subnet-create overwrite the existing subnet configuration if one exists
--gcp create node/s in GCP cloud
--gcp-credentials string use given GCP credentials
--gcp-project string use given GCP project
--grafana-pkg string use grafana pkg instead of apt repo(by default), for example https://dl.grafana.com/oss/release/grafana_10.4.1_amd64.deb
-h, --help help for wiz
--icm generate an icm-ready vm
--icm-messenger-contract-address-path string path to an icm messenger contract address file
--icm-messenger-deployer-address-path string path to an icm messenger deployer address file
--icm-messenger-deployer-tx-path string path to an icm messenger deployer tx file
--icm-registry-bytecode-path string path to an icm registry bytecode file
--icm-version string icm version to deploy (default "latest")
--latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s
--latest-avalanchego-version install latest avalanchego release version on node/s
--latest-evm-version use latest Subnet-EVM released version
--latest-pre-released-evm-version use latest Subnet-EVM pre-released version
--node-config string path to avalanchego node configuration for subnet
--node-type string cloud instance type. Use 'default' to use recommended default instance type
--num-apis ints number of API nodes(nodes without stake) to create in the new Devnet
--num-validators ints number of nodes to create per region(s). Use comma to separate multiple numbers for each region in the same order as --region flag
--public-http-port allow public access to avalanchego HTTP port
--region strings create node/s in given region(s). Use comma to separate multiple regions
--relayer run AWM relayer when deploying the vm
--ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used.
--subnet-aliases strings additional subnet aliases to be used for RPC calls in addition to subnet blockchain name
--subnet-config string path to the subnet configuration for subnet
--subnet-genesis string file path of the subnet genesis
--teleporter generate an icm-ready vm
--teleporter-messenger-contract-address-path string path to an icm messenger contract address file
--teleporter-messenger-deployer-address-path string path to an icm messenger deployer address file
--teleporter-messenger-deployer-tx-path string path to an icm messenger deployer tx file
--teleporter-registry-bytecode-path string path to an icm registry bytecode file
--teleporter-version string icm version to deploy (default "latest")
--use-ssh-agent use ssh agent for ssh
--use-static-ip attach static Public IP on cloud servers (default true)
--validators strings deploy subnet into given comma separated list of validators. defaults to all cluster nodes
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### export
(ALPHA Warning) This command is currently in experimental mode.
The node export command exports cluster configuration and its nodes config to a text file.
If no file is specified, the configuration is printed to the stdout.
Use --include-secrets to include keys in the export. In this case please keep the file secure as it contains sensitive information.
Exported cluster configuration without secrets can be imported by another user using node import command.
**Usage:**
```bash
avalanche node export [subcommand] [flags]
```
**Flags:**
```bash
--file string specify the file to export the cluster configuration to
--force overwrite the file if it exists
-h, --help help for export
--include-secrets include keys in the export
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### import
(ALPHA Warning) This command is currently in experimental mode.
The node import command imports cluster configuration and its nodes configuration from a text file
created from the node export command.
Prior to calling this command, call node whitelist command to have your SSH public key and IP whitelisted by
the cluster owner. This will enable you to use avalanche-cli commands to manage the imported cluster.
Please note, that this imported cluster will be considered as EXTERNAL by avalanche-cli, so some commands
affecting cloud nodes like node create or node destroy will be not applicable to it.
**Usage:**
```bash
avalanche node import [subcommand] [flags]
```
**Flags:**
```bash
--file string specify the file to export the cluster configuration to
-h, --help help for import
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### list
(ALPHA Warning) This command is currently in experimental mode.
The node list command lists all clusters together with their nodes.
**Usage:**
```bash
avalanche node list [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for list
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### loadtest
(ALPHA Warning) This command is currently in experimental mode.
The node loadtest command suite starts and stops a load test for an existing devnet cluster.
**Usage:**
```bash
avalanche node loadtest [subcommand] [flags]
```
**Subcommands:**
- [`start`](#avalanche-node-loadtest-start): (ALPHA Warning) This command is currently in experimental mode.
The node loadtest command starts load testing for an existing devnet cluster. If the cluster does
not have an existing load test host, the command creates a separate cloud server and builds the load
test binary based on the provided load test Git Repo URL and load test binary build command.
The command will then run the load test binary based on the provided load test run command.
- [`stop`](#avalanche-node-loadtest-stop): (ALPHA Warning) This command is currently in experimental mode.
The node loadtest stop command stops load testing for an existing devnet cluster and terminates the
separate cloud server created to host the load test.
**Flags:**
```bash
-h, --help help for loadtest
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### loadtest start
(ALPHA Warning) This command is currently in experimental mode.
The node loadtest command starts load testing for an existing devnet cluster. If the cluster does
not have an existing load test host, the command creates a separate cloud server and builds the load
test binary based on the provided load test Git Repo URL and load test binary build command.
The command will then run the load test binary based on the provided load test run command.
**Usage:**
```bash
avalanche node loadtest start [subcommand] [flags]
```
**Flags:**
```bash
--authorize-access authorize CLI to create cloud resources
--aws create loadtest node in AWS cloud
--aws-profile string aws profile to use (default "default")
--gcp create loadtest in GCP cloud
-h, --help help for start
--load-test-branch string load test branch or commit
--load-test-build-cmd string command to build load test binary
--load-test-cmd string command to run load test
--load-test-repo string load test repo url to use
--node-type string cloud instance type for loadtest script
--region string create load test node in a given region
--ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used
--use-ssh-agent use ssh agent(ex: Yubikey) for ssh auth
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### loadtest stop
(ALPHA Warning) This command is currently in experimental mode.
The node loadtest stop command stops load testing for an existing devnet cluster and terminates the
separate cloud server created to host the load test.
**Usage:**
```bash
avalanche node loadtest stop [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for stop
--load-test strings stop specified load test node(s). Use comma to separate multiple load test instance names
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### local
The node local command suite provides a collection of commands related to local nodes
**Usage:**
```bash
avalanche node local [subcommand] [flags]
```
**Subcommands:**
- [`destroy`](#avalanche-node-local-destroy): Cleanup local node.
- [`start`](#avalanche-node-local-start): The node local start command creates Avalanche nodes on the local machine.
Once this command is completed, you will have to wait for the Avalanche node
to finish bootstrapping on the primary network before running further
commands on it, e.g. validating a Subnet.
You can check the bootstrapping status by running avalanche node status local.
- [`status`](#avalanche-node-local-status): Get status of local node.
- [`stop`](#avalanche-node-local-stop): Stop local node.
- [`track`](#avalanche-node-local-track): Track specified blockchain with local node
- [`validate`](#avalanche-node-local-validate): Use Avalanche Node set up on local machine to set up specified L1 by providing the
RPC URL of the L1.
This command can only be used to validate Proof of Stake L1.
**Flags:**
```bash
-h, --help help for local
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local destroy
Cleanup local node.
**Usage:**
```bash
avalanche node local destroy [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for destroy
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local start
The node local start command creates Avalanche nodes on the local machine.
Once this command is completed, you will have to wait for the Avalanche node
to finish bootstrapping on the primary network before running further
commands on it, e.g. validating a Subnet.
You can check the bootstrapping status by running avalanche node status local.
**Usage:**
```bash
avalanche node local start [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-path string use this avalanchego binary path
--bootstrap-id stringArray nodeIDs of bootstrap nodes
--bootstrap-ip stringArray IP:port pairs of bootstrap nodes
--cluster string operate on the given cluster
--custom-avalanchego-version string install given avalanchego version on node/s
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--genesis string path to genesis file
-h, --help help for start
--latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s (default true)
--latest-avalanchego-version install latest avalanchego release version on node/s
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-config string path to common avalanchego config settings for all nodes
--num-nodes uint32 number of Avalanche nodes to create on local machine (default 1)
--partial-sync primary network partial sync (default true)
--staking-cert-key-path string path to provided staking cert key for node
--staking-signer-key-path string path to provided staking signer key for node
--staking-tls-key-path string path to provided staking tls key for node
-t, --testnet fuji operate on testnet (alias to fuji)
--upgrade string path to upgrade file
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local status
Get status of local node.
**Usage:**
```bash
avalanche node local status [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string specify the blockchain the node is syncing with
-h, --help help for status
--l1 string specify the blockchain the node is syncing with
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local stop
Stop local node.
**Usage:**
```bash
avalanche node local stop [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for stop
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local track
Track specified blockchain with local node
**Usage:**
```bash
avalanche node local track [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-path string use this avalanchego binary path
--custom-avalanchego-version string install given avalanchego version on node/s
-h, --help help for track
--latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s (default true)
--latest-avalanchego-version install latest avalanchego release version on node/s
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local validate
Use Avalanche Node set up on local machine to set up specified L1 by providing the
RPC URL of the L1.
This command can only be used to validate Proof of Stake L1.
**Usage:**
```bash
avalanche node local validate [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-log-level string log level to use with signature aggregator (default "Debug")
--aggregator-log-to-stdout use stdout for signature aggregator logs
--balance float amount of AVAX to increase validator's balance by
--blockchain string specify the blockchain the node is syncing with
--delegation-fee uint16 delegation fee (in bips) (default 100)
--disable-owner string P-Chain address that will able to disable the validator with a P-Chain transaction
-h, --help help for validate
--l1 string specify the blockchain the node is syncing with
--minimum-stake-duration uint minimum stake duration (in seconds) (default 100)
--remaining-balance-owner string P-Chain address that will receive any leftover AVAX from the validator when it is removed from Subnet
--rpc string connect to validator manager at the given rpc endpoint
--stake-amount uint amount of tokens to stake
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### refresh-ips
(ALPHA Warning) This command is currently in experimental mode.
The node refresh-ips command obtains the current IP for all nodes with dynamic IPs in the cluster,
and updates the local node information used by CLI commands.
**Usage:**
```bash
avalanche node refresh-ips [subcommand] [flags]
```
**Flags:**
```bash
--aws-profile string aws profile to use (default "default")
-h, --help help for refresh-ips
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### resize
(ALPHA Warning) This command is currently in experimental mode.
The node resize command can change the amount of CPU, memory and disk space available for the cluster nodes.
**Usage:**
```bash
avalanche node resize [subcommand] [flags]
```
**Flags:**
```bash
--aws-profile string aws profile to use (default "default")
--disk-size string Disk size to resize in Gb (e.g. 1000Gb)
-h, --help help for resize
--node-type string Node type to resize (e.g. t3.2xlarge)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### scp
(ALPHA Warning) This command is currently in experimental mode.
The node scp command securely copies files to and from nodes. Remote source or destionation can be specified using the following format:
[clusterName|nodeID|instanceID|IP]:/path/to/file. Regular expressions are supported for the source files like /tmp/*.txt.
File transfer to the nodes are parallelized. IF source or destination is cluster, the other should be a local file path.
If both destinations are remote, they must be nodes for the same cluster and not clusters themselves.
For example:
$ avalanche node scp [cluster1|node1]:/tmp/file.txt /tmp/file.txt
$ avalanche node scp /tmp/file.txt [cluster1|NodeID-XXXX]:/tmp/file.txt
$ avalanche node scp node1:/tmp/file.txt NodeID-XXXX:/tmp/file.txt
**Usage:**
```bash
avalanche node scp [subcommand] [flags]
```
**Flags:**
```bash
--compress use compression for ssh
-h, --help help for scp
--recursive copy directories recursively
--with-loadtest include loadtest node for scp cluster operations
--with-monitor include monitoring node for scp cluster operations
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### ssh
(ALPHA Warning) This command is currently in experimental mode.
The node ssh command execute a given command [cmd] using ssh on all nodes in the cluster if ClusterName is given.
If no command is given, just prints the ssh command to be used to connect to each node in the cluster.
For provided NodeID or InstanceID or IP, the command [cmd] will be executed on that node.
If no [cmd] is provided for the node, it will open ssh shell there.
**Usage:**
```bash
avalanche node ssh [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for ssh
--parallel run ssh command on all nodes in parallel
--with-loadtest include loadtest node for ssh cluster operations
--with-monitor include monitoring node for ssh cluster operations
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### status
(ALPHA Warning) This command is currently in experimental mode.
The node status command gets the bootstrap status of all nodes in a cluster with the Primary Network.
If no cluster is given, defaults to node list behaviour.
To get the bootstrap status of a node with a Blockchain, use --blockchain flag
**Usage:**
```bash
avalanche node status [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string specify the blockchain the node is syncing with
-h, --help help for status
--subnet string specify the blockchain the node is syncing with
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### sync
(ALPHA Warning) This command is currently in experimental mode.
The node sync command enables all nodes in a cluster to be bootstrapped to a Blockchain.
You can check the blockchain bootstrap status by calling avalanche node status `clusterName` --blockchain `blockchainName`
**Usage:**
```bash
avalanche node sync [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for sync
--no-checks do not check for bootstrapped/healthy status or rpc compatibility of nodes against subnet
--subnet-aliases strings subnet alias to be used for RPC calls. defaults to subnet blockchain ID
--validators strings sync subnet into given comma separated list of validators. defaults to all cluster nodes
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### update
(ALPHA Warning) This command is currently in experimental mode.
The node update command suite provides a collection of commands for nodes to update
their avalanchego or VM config.
You can check the status after update by calling avalanche node status
**Usage:**
```bash
avalanche node update [subcommand] [flags]
```
**Subcommands:**
- [`subnet`](#avalanche-node-update-subnet): (ALPHA Warning) This command is currently in experimental mode.
The node update subnet command updates all nodes in a cluster with latest Subnet configuration and VM for custom VM.
You can check the updated subnet bootstrap status by calling avalanche node status `clusterName` --subnet `subnetName`
**Flags:**
```bash
-h, --help help for update
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### update subnet
(ALPHA Warning) This command is currently in experimental mode.
The node update subnet command updates all nodes in a cluster with latest Subnet configuration and VM for custom VM.
You can check the updated subnet bootstrap status by calling avalanche node status `clusterName` --subnet `subnetName`
**Usage:**
```bash
avalanche node update subnet [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for subnet
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### upgrade
(ALPHA Warning) This command is currently in experimental mode.
The node update command suite provides a collection of commands for nodes to update
their avalanchego or VM version.
You can check the status after upgrade by calling avalanche node status
**Usage:**
```bash
avalanche node upgrade [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for upgrade
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### validate
(ALPHA Warning) This command is currently in experimental mode.
The node validate command suite provides a collection of commands for nodes to join
the Primary Network and Subnets as validators.
If any of the commands is run before the nodes are bootstrapped on the Primary Network, the command
will fail. You can check the bootstrap status by calling avalanche node status `clusterName`
**Usage:**
```bash
avalanche node validate [subcommand] [flags]
```
**Subcommands:**
- [`primary`](#avalanche-node-validate-primary): (ALPHA Warning) This command is currently in experimental mode.
The node validate primary command enables all nodes in a cluster to be validators of Primary
Network.
- [`subnet`](#avalanche-node-validate-subnet): (ALPHA Warning) This command is currently in experimental mode.
The node validate subnet command enables all nodes in a cluster to be validators of a Subnet.
If the command is run before the nodes are Primary Network validators, the command will first
make the nodes Primary Network validators before making them Subnet validators.
If The command is run before the nodes are bootstrapped on the Primary Network, the command will fail.
You can check the bootstrap status by calling avalanche node status `clusterName`
If The command is run before the nodes are synced to the subnet, the command will fail.
You can check the subnet sync status by calling avalanche node status `clusterName` --subnet `subnetName`
**Flags:**
```bash
-h, --help help for validate
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### validate primary
(ALPHA Warning) This command is currently in experimental mode.
The node validate primary command enables all nodes in a cluster to be validators of Primary
Network.
**Usage:**
```bash
avalanche node validate primary [subcommand] [flags]
```
**Flags:**
```bash
-e, --ewoq use ewoq key [fuji/devnet only]
-h, --help help for primary
-k, --key string select the key to use [fuji only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
--stake-amount uint how many AVAX to stake in the validator
--staking-period duration how long validator validates for after start time
--start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### validate subnet
(ALPHA Warning) This command is currently in experimental mode.
The node validate subnet command enables all nodes in a cluster to be validators of a Subnet.
If the command is run before the nodes are Primary Network validators, the command will first
make the nodes Primary Network validators before making them Subnet validators.
If The command is run before the nodes are bootstrapped on the Primary Network, the command will fail.
You can check the bootstrap status by calling avalanche node status `clusterName`
If The command is run before the nodes are synced to the subnet, the command will fail.
You can check the subnet sync status by calling avalanche node status `clusterName` --subnet `subnetName`
**Usage:**
```bash
avalanche node validate subnet [subcommand] [flags]
```
**Flags:**
```bash
--default-validator-params use default weight/start/duration params for subnet validator
-e, --ewoq use ewoq key [fuji/devnet only]
-h, --help help for subnet
-k, --key string select the key to use [fuji/devnet only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
--no-checks do not check for bootstrapped status or healthy status
--no-validation-checks do not check if subnet is already synced or validated (default true)
--stake-amount uint how many AVAX to stake in the validator
--staking-period duration how long validator validates for after start time
--start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format
--validators strings validate subnet for the given comma separated list of validators. defaults to all cluster nodes
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### whitelist
(ALPHA Warning) The whitelist command suite provides a collection of tools for granting access to the cluster.
Command adds IP if --ip params provided to cloud security access rules allowing it to access all nodes in the cluster via ssh or http.
It also command adds SSH public key to all nodes in the cluster if --ssh params is there.
If no params provided it detects current user IP automaticaly and whitelists it
**Usage:**
```bash
avalanche node whitelist [subcommand] [flags]
```
**Flags:**
```bash
-y, --current-ip whitelist current host ip
-h, --help help for whitelist
--ip string ip address to whitelist
--ssh string ssh public key to whitelist
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche primary
The primary command suite provides a collection of tools for interacting with the
Primary Network
**Usage:**
```bash
avalanche primary [subcommand] [flags]
```
**Subcommands:**
- [`addValidator`](#avalanche-primary-addvalidator): The primary addValidator command adds a node as a validator
in the Primary Network
- [`describe`](#avalanche-primary-describe): The subnet describe command prints details of the primary network configuration to the console.
**Flags:**
```bash
-h, --help help for primary
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### addValidator
The primary addValidator command adds a node as a validator
in the Primary Network
**Usage:**
```bash
avalanche primary addValidator [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--delegation-fee uint32 set the delegation fee (20 000 is equivalent to 2%)
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for addValidator
-k, --key string select the key to use [fuji only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji)
--ledger-addrs strings use the given ledger addresses
-m, --mainnet operate on mainnet
--nodeID string set the NodeID of the validator to add
--proof-of-possession string set the BLS proof of possession of the validator to add
--public-key string set the BLS public key of the validator to add
--staking-period duration how long this validator will be staking
--start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format
-t, --testnet fuji operate on testnet (alias to fuji)
--weight uint set the staking weight of the validator to add
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### describe
The subnet describe command prints details of the primary network configuration to the console.
**Usage:**
```bash
avalanche primary describe [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
-h, --help help for describe
-l, --local operate on a local network
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche transaction
The transaction command suite provides all of the utilities required to sign multisig transactions.
**Usage:**
```bash
avalanche transaction [subcommand] [flags]
```
**Subcommands:**
- [`commit`](#avalanche-transaction-commit): The transaction commit command commits a transaction by submitting it to the P-Chain.
- [`sign`](#avalanche-transaction-sign): The transaction sign command signs a multisig transaction.
**Flags:**
```bash
-h, --help help for transaction
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### commit
The transaction commit command commits a transaction by submitting it to the P-Chain.
**Usage:**
```bash
avalanche transaction commit [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for commit
--input-tx-filepath string Path to the transaction signed by all signatories
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### sign
The transaction sign command signs a multisig transaction.
**Usage:**
```bash
avalanche transaction sign [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for sign
--input-tx-filepath string Path to the transaction file for signing
-k, --key string select the key to use [fuji only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji)
--ledger-addrs strings use the given ledger addresses
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche update
Check if an update is available, and prompt the user to install it
**Usage:**
```bash
avalanche update [subcommand] [flags]
```
**Flags:**
```bash
-c, --confirm Assume yes for installation
-h, --help help for update
-v, --version version for update
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche validator
The validator command suite provides a collection of tools for managing validator
balance on P-Chain.
Validator's balance is used to pay for continuous fee to the P-Chain. When this Balance reaches 0,
the validator will be considered inactive and will no longer participate in validating the L1
**Usage:**
```bash
avalanche validator [subcommand] [flags]
```
**Subcommands:**
- [`getBalance`](#avalanche-validator-getbalance): This command gets the remaining validator P-Chain balance that is available to pay
P-Chain continuous fee
- [`increaseBalance`](#avalanche-validator-increasebalance): This command increases the validator P-Chain balance
- [`list`](#avalanche-validator-list): This command gets a list of the validators of the L1
**Flags:**
```bash
-h, --help help for validator
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### getBalance
This command gets the remaining validator P-Chain balance that is available to pay
P-Chain continuous fee
**Usage:**
```bash
avalanche validator getBalance [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for getBalance
--l1 string name of L1
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-id string node ID of the validator
-t, --testnet fuji operate on testnet (alias to fuji)
--validation-id string validation ID of the validator
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### increaseBalance
This command increases the validator P-Chain balance
**Usage:**
```bash
avalanche validator increaseBalance [subcommand] [flags]
```
**Flags:**
```bash
--balance float amount of AVAX to increase validator's balance by
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for increaseBalance
-k, --key string select the key to use [fuji/devnet deploy only]
--l1 string name of L1 (to increase balance of bootstrap validators only)
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-id string node ID of the validator
-t, --testnet fuji operate on testnet (alias to fuji)
--validation-id string validationIDStr of the validator
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### list
This command gets a list of the validators of the L1
**Usage:**
```bash
avalanche validator list [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for list
-l, --local operate on a local network
-m, --mainnet operate on mainnet
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
# Deploy a Smart Contract (/docs/avalanche-l1s/add-utility/deploy-smart-contract)
---
title: Deploy a Smart Contract
description: Deploy a smart contract on your Avalanche L1.
---
{/*
EVM Version Warning - TEMPORARY
Remove this section when Avalanche adds Pectra support (after SAE implementation)
Last reviewed: December 2025
*/}
Avalanche C-Chain and Subnet-EVM currently support the **Cancun** EVM version and do not yet support newer hardforks like **Pectra**. Since Solidity v0.8.30 changed its default target to Pectra, you must explicitly configure your compiler to target `cancun`.
**In Remix:** Open the Solidity Compiler panel → expand Advanced Configurations → set EVM Version to **cancun**.
For **Hardhat** or **Foundry** configurations, see the [contract verification guide](/docs/primary-network/verify-contract/hardhat).
This tutorial assumes that:
- [an Avalanche L1 and EVM blockchain](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet) has been created
- Your Node is currently validating your target Avalanche L1
- Your wallet has a balance of the Avalanche L1 Native Token(Specified under _alloc_ in your [Genesis File](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#genesis)).
Step 1: Setting up Core[](#step-1-setting-up-core "Direct link to heading")
----------------------------------------------------------------------------
### **EVM Avalanche L1 Settings**: [(EVM Core Tutorial)](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet#connect-with-core)[](#evm-avalanche-l1-settings-evm-core-tutorial "Direct link to heading")
- **`Network Name`**: Custom Subnet-EVM
- **`New RPC URL`**: http://NodeIPAddress:9650/ext/bc/BlockchainID/rpc (Note: the port number should match your local setting which can be different from 9650.)
- **`ChainID`**: Subnet-EVM ChainID
- **`Symbol`**: Subnet-EVM Token Symbol
- **`Explorer`**: N/A
You should see a balance of your Avalanche L1's Native Token in Core.

Step 2: Connect Core and Deploy a Smart Contract[](#step-2-connect-core-and-deploy-a-smart-contract "Direct link to heading")
------------------------------------------------------------------------------------------------------------------------------
### Using Remix[](#using-remix "Direct link to heading")
Open [Remix](https://remix.ethereum.org/) -> Select Solidity.

Create the smart contracts that we want to compile and deploy using Remix file explorer
### Using GitHub[](#using-github "Direct link to heading")
In Remix Home _Click_ the GitHub button.

Paste the [link to the Smart Contract](https://github.com/ava-labs/avalanche-smart-contract-quickstart/blob/main/contracts/NFT.sol) into the popup and _Click_ import.

For this example, we will deploy an ERC721 contract from the [Avalanche Smart Contract Quickstart Repository](https://github.com/ava-labs/avalanche-smart-contract-quickstart).

Navigate to Deploy Tab -> Open the "ENVIRONMENT" drop-down and select Injected Web3 (make sure Core is loaded).

Once we injected the web3-> Go back to the compiler, and compile the selected contract -> Navigate to Deploy Tab.

Now, the smart contract is compiled, Core is injected, and we are ready to deploy our ERC721. Click "Deploy."

Confirm the transaction on the Core pop up.

Our contract is successfully deployed!

Now, we can expand it by selecting it from the "Deployed Contracts" tab and test it out.

The contract ABI and Bytecode are available on the compiler tab.

If you had any difficulties following this tutorial or simply want to discuss Avalanche with us, you can join our community at [Discord](https://chat.avalabs.org/)!
You can use Subnet-EVM just like you use C-Chain and EVM tools. Only differences are `chainID` and RPC URL. For example you can deploy your contracts with [Hardhat](https://hardhat.org/getting-started) by changing `url` and `chainId` in the `hardhat.config.ts`.
# Add a Testnet Faucet (/docs/avalanche-l1s/add-utility/testnet-faucet)
---
title: Add a Testnet Faucet
description: This guide will help you add a testnet faucet to your Avalanche L1.
---
There are thousands of networks and chains in the blockchain space, each with its capabilities and use-cases. Each network requires native coins to do any transaction on them, which can have a monetary value as well. These coins can be collected through centralized exchanges, token sales, etc in exchange for some monetary assets like USD.
But we cannot risk our funds on the network or on any applications hosted on that network, without testing them first. So, these networks often have test networks or testnets, where the native coins do not have any monetary value, and thus can be obtained freely through faucets.
These testnets are often the testbeds for any new native feature of the network itself, or any dapp or [Avalanche L1](/docs/avalanche-l1s) that is going live on the main network (Mainnet). For example, [Fuji](/docs/primary-network) network is the Testnet for Avalanche's Mainnet.
Besides Fuji Testnet, the [Avalanche Faucet](https://core.app/tools/testnet-faucet/?avalanche-l1=c&token=c) can be used to get free test tokens on testnet Avalanche L1s like:
- [WAGMI Testnet](https://core.app/tools/testnet-faucet/?avalanche-l1=wagmi)
- [DeFI Kingdoms Testnet](https://core.app/tools/testnet-faucet/?avalanche-l1=dfk)
- [Beam Testnet](https://core.app/tools/testnet-faucet/?avalanche-l1=beam&token=beam) and many more.
You can use this [repository](https://github.com/ava-labs/avalanche-faucet) to deploy your faucet or just make a PR with the [configurations](https://github.com/ava-labs/avalanche-faucet/blob/main/config.json) of the Avalanche L1. This faucet comes with many features like multiple chain support, custom rate-limiting per Avalanche L1, CAPTCHA verification, and concurrent transaction handling.
Summary[](#summary "Direct link to heading")
---------------------------------------------
A [Faucet](https://core.app/tools/testnet-faucet/) powered by Avalanche for Fuji Network and other Avalanche L1s. You can -
- Request test coins for the supported Avalanche L1s
- Integrate your EVM Avalanche L1 with the faucet by making a PR with the [chain configurations](https://github.com/ava-labs/avalanche-faucet/blob/main/config.json)
- Fork the [repository](https://github.com/ava-labs/avalanche-faucet) to deploy your faucet for any EVM chain
Adding a New Avalanche L1[](#adding-a-new-avalanche-l1 "Direct link to heading")
---------------------------------------------------------------------
You can also integrate a new Avalanche L1 on the live [faucet](https://core.app/tools/testnet-faucet/) with just a few lines of configuration parameters. All you have to do is make a PR on the [Avalanche Faucet](https://github.com/ava-labs/avalanche-faucet) git repository with the Avalanche L1's information. The following parameters are required.
```json
{
"ID": string,
"NAME": string,
"TOKEN": string,
"RPC": string,
"CHAINID": number,
"EXPLORER": string,
"IMAGE": string,
"MAX_PRIORITY_FEE": string,
"MAX_FEE": string,
"DRIP_AMOUNT": number,
"RATELIMIT": {
"MAX_LIMIT": number,
"WINDOW_SIZE": number
}
}
```
- `ID` - Each Avalanche L1 chain should have a unique and relatable ID.
- `NAME` - Name of the Avalanche L1 chain that will appear on the site.
- `RPC` - A valid RPC URL for accessing the chain.
- `CHAINID` - ChainID of the chain
- `EXPLORER` - Base URL of standard explorer's site.
- `IMAGE` - URL of the icon of the chain that will be shown in the dropdown.
- `MAX_PRIORITY_FEE` - Maximum tip per faucet drop in **wei** or **10\-18** unit (for EIP1559 supported chains)
- `MAX_FEE` - Maximum fee that can be paid for a faucet drop in **wei** or **10\-18** unit
- `DRIP_AMOUNT` - Amount of coins to send per request in **gwei** or **10\-9** unit
- `RECALIBRATE` _(optional)_ - Number of seconds after which the nonce and balance will recalibrate
- `RATELIMIT` - Number of times (MAX\_LIMIT) to allow per user within the WINDOW\_SIZE (in minutes)
Add the configuration in the array of `evmchains` inside the [config.json](https://github.com/ava-labs/avalanche-faucet/blob/main/config.json) file and make a PR.
Building and Deploying a Faucet[](#building-and-deploying-a-faucet "Direct link to heading")
---------------------------------------------------------------------------------------------
You can also deploy and build your faucet by using the [Avalanche Faucet](https://github.com/ava-labs/avalanche-faucet) repository.
### Requirements[](#requirements "Direct link to heading")
- [Node](https://nodejs.org/en) >= 17.0 and [npm](https://www.npmjs.com/) >= 8.0
- [Google's reCAPTCHA](https://www.google.com/recaptcha/intro/v3.html) v3 keys
- [Docker](https://www.docker.com/get-started/)
### Installation[](#installation "Direct link to heading")
Clone this repository at your preferred location.
```bash
git clone https://github.com/ava-labs/avalanche-faucet
```
The repository cloning method used is HTTPS, but SSH can be used too:
`git clone git@github.com:ava-labs/avalanche-faucet.git`
You can find more about SSH and how to use it [here](https://docs.github.com/en/authentication/connecting-to-github-with-ssh/about-ssh).
### Client-Side Configurations[](#client-side-configurations "Direct link to heading")
We need to configure our application with the server API endpoints and CAPTCHA site keys. All the client-side configurations are there in the `client/src/config.json` file. Since there are no secrets on the client-side, we do not need any environment variables. Update the config files according to your need.
```json
{
"banner": "/banner.png",
"apiBaseEndpointProduction": "/api/",
"apiBaseEndpointDevelopment": "http://localhost:8000/api/",
"apiTimeout": 10000,
"CAPTCHA": {
"siteKey": "6LcNScYfAAAAAJH8fauA-okTZrmAxYqfF9gOmujf",
"action": "faucetdrip"
}
}
```
Put the Google's reCAPTCHA site-key without which the faucet client can't send the necessary CAPTCHA response to the server. This key is not a secret and could be public.
In the above file, there are 2 base endpoints for the faucet server `apiBaseEndpointProduction` and `apiBaseEndpointDevelopment`.
In production mode, the client-side will be served as static content over the server's endpoint, and hence we do not have to provide the server's IP address or domain.
The URL path should be valid, where the server's APIs are hosted. If the endpoints for API have a leading `/v1/api` and the server is running on localhost at port 3000, then you should use `http://localhost:3000/v1/api` or `/v1/api/` depending on whether it is production or development.
### Server-Side Configurations[](#server-side-configurations "Direct link to heading")
On the server-side, we need to configure 2 files - `.env` for secret keys and `config.json` for chain and API rate limiting configurations.
#### Setup Environment Variables[](#setup-environment-variables "Direct link to heading")
Setup the environment variable with your private key and reCAPTCHA secret. Make a `.env` file in your preferred location with the following credentials, as this file will not be committed to the repository. The faucet server can handle multiple EVM chains, and therefore requires private keys for addresses with funds on each of the chains.
If you have funds on the same address on every chain, then you can specify them with the single variable`PK`. But if you have funds on different addresses on different chains, then you can provide each of the private keys against the ID of the chain, as shown below.
```bash
C="C chain private key"
WAGMI="Wagmi chain private key"
PK="Sender Private Key with Funds in it"
CAPTCHA_SECRET="Google reCAPTCHA Secret"
```
`PK` will act as a fallback private key, in case, the key for any chain is not provided.
#### Setup EVM Chain Configurations[](#setup-evm-chain-configurations "Direct link to heading")
You can create a faucet server for any EVM chain by making changes in the `config.json` file. Add your chain configuration as shown below in the `evmchains` object. Configuration for Fuji's C-Chain and WAGMI chain is shown below for example.
```json
"evmchains": [
{
"ID": "C",
"NAME": "Fuji (C-Chain)",
"TOKEN": "AVAX",
"RPC": "https://api.avax-test.network/ext/C/rpc",
"CHAINID": 43113,
"EXPLORER": "https://testnet.snowtrace.io",
"IMAGE": "/avaxred.png",
"MAX_PRIORITY_FEE": "2000000000",
"MAX_FEE": "100000000000",
"DRIP_AMOUNT": 2000000000,
"RECALIBRATE": 30,
"RATELIMIT": {
"MAX_LIMIT": 1,
"WINDOW_SIZE": 1440
}
},
{
"ID": "WAGMI",
"NAME": "WAGMI Testnet",
"TOKEN": "WGM",
"RPC": "https://subnets.avax.network/wagmi/wagmi-chain-testnet/rpc",
"CHAINID": 11111,
"EXPLORER": "https://subnets.avax.network/wagmi/wagmi-chain-testnet/explorer",
"IMAGE": "/wagmi.png",
"MAX_PRIORITY_FEE": "2000000000",
"MAX_FEE": "100000000000",
"DRIP_AMOUNT": 2000000000,
"RATELIMIT": {
"MAX_LIMIT": 1,
"WINDOW_SIZE": 1440
}
}
]
```
In the above configuration drip amount is in `nAVAX` or `gwei`, whereas fees are in `wei`. For example, with the above configurations, the faucet will send `1 AVAX` with maximum fees per gas being `100 nAVAX` and priority fee as `2 nAVAX`.
The rate limiter for C-Chain will only accept 1 request in 60 minutes for a particular API and 2 requests in 60 minutes for the WAGMI chain. Though it will skip any failed requests so that users can request tokens again, even if there is some internal error in the application. On the other hand, the global rate limiter will allow 15 requests per minute on every API. This time failed requests will also get counted so that no one can abuse the APIs.
### API Endpoints[](#api-endpoints "Direct link to heading")
This server will expose the following APIs
#### Health API[](#health-api "Direct link to heading")
The `/health` API will always return a response with a `200` status code. This endpoint can be used to know the health of the server.
```bash
curl http://localhost:8000/health
```
Response
#### Get Faucet Address[](#get-faucet-address "Direct link to heading")
This API will be used for fetching the faucet address.
```bash
curl http://localhost:8000/api/faucetAddress?chain=C
```
It will give the following response:
```bash
0x3EA53fA26b41885cB9149B62f0b7c0BAf76C78D4
```
#### Get Faucet Balance[](#get-faucet-balance "Direct link to heading")
This API will be used for fetching the faucet address.
```bash
curl http://localhost:8000/api/getBalance?chain=C
```
#### Send Token[](#send-token "Direct link to heading")
This API endpoint will handle token requests from users. It will return the transaction hash as a receipt of the faucet drip.
```bash
curl -d '{
"address": "0x3EA53fA26b41885cB9149B62f0b7c0BAf76C78D4"
"chain": "C"
}' -H 'Content-Type: application/json' http://localhost:8000/api/sendToken
```
Send token API requires a CAPTCHA response token that is generated using the CAPTCHA site key on the client-side.
Since we can't generate and pass this token while making a curl request, we have to disable the CAPTCHA verification for testing purposes. You can find the steps to disable it in the next sections. The response is shown below
```json
{
"message": "Transaction successful on Avalanche C Chain!",
"txHash": "0x3d1f1c3facf59c5cd7d6937b3b727d047a1e664f52834daf20b0555e89fc8317"
}
```
### Rate Limiters[](#rate-limiters-important "Direct link to heading")
The rate limiters are applied on the global (all endpoints) as well as on the `/api/sendToken` API. These can be configured from the `config.json` file. Rate limiting parameters for chains are passed in the chain configuration as shown above.
```json
"GLOBAL_RL": {
"ID": "GLOBAL",
"RATELIMIT": {
"REVERSE_PROXIES": 4,
"MAX_LIMIT": 40,
"WINDOW_SIZE": 1,
"PATH": "/",
"SKIP_FAILED_REQUESTS": false
}
}
```
There could be multiple proxies between the server and the client. The server will see the IP address of the adjacent proxy connected with the server, and this may not be the client's actual IP.
The IPs of all the proxies that the request has hopped through are stuffed inside the header **x-forwarded-for** array. But the proxies in between can easily manipulate these headers to bypass rate limiters. So, we cannot trust all the proxies and hence all the IPs inside the header.
The proxies that are set up by the owner of the server (reverse-proxies) are the trusted proxies on which we can rely and know that they have stuffed the actual IP of the callers in between. Any proxy that is not set up by the server, should be considered an untrusted proxy. So, we can jump to the IP address added by the last proxy that we trust. The number of jumps that we want can be configured in the `config.json` file inside the `GLOBAL_RL` object.

#### Clients Behind Same Proxy[](#clients-behind-same-proxy "Direct link to heading")
Consider the below diagram. The server is set up with 2 reverse proxies. If the client is behind proxies, then we cannot get the client's actual IP, and instead will consider the proxy's IP as the client's IP. And if some other client is behind the same proxy, then those clients will be considered as a single entity and might get rate-limited faster.

Therefore it is advised to the users, to avoid using any proxy for accessing applications that have critical rate limits, like this faucet.
#### Wrong Number of Reverse Proxies[](#wrong-number-of-reverse-proxies "Direct link to heading")
So, if you want to deploy this faucet, and have some reverse proxies in between, then you should configure this inside the `GLOBAL_RL` key of the `config.json` file. If this is not configured properly, then the users might get rate-limited very frequently, since the server-side proxy's IP addresses are being viewed as the client's IP. You can verify this in the code [here](https://github.com/ava-labs/avalanche-faucet/blob/23eb300635b64130bc9ce10d9e894f0a0b3d81ea/middlewares/rateLimiter.ts#L25).
```json
"GLOBAL_RL": {
"ID": "GLOBAL",
"RATELIMIT": {
"REVERSE_PROXIES": 4,
...
}
}
```

It is also quite common to have Cloudflare as the last reverse proxy or the exposed server. Cloudflare provides a header **cf-connecting-ip** which is the IP of the client that requested the faucet and hence Cloudflare. We are using this as default.
### CAPTCHA Verification[](#captcha-verification "Direct link to heading")
CAPTCHA is required to prove the user is a human and not a bot. For this purpose, we will use [Google's reCAPTCHA](https://www.google.com/recaptcha/intro/v3.html). The server-side will require `CAPTCHA_SECRET` that should not be exposed. You can set the threshold score to pass the CAPTCHA test by the users [here](https://github.com/ava-labs/avalanche-faucet/blob/23eb300635b64130bc9ce10d9e894f0a0b3d81ea/middlewares/verifyCaptcha.ts#L20).
You can disable these CAPTCHA verifications and rate limiters for testing the purpose, by tweaking in the `server.ts` file.
### Disabling Rate Limiters[](#disabling-rate-limiters "Direct link to heading")
Comment or remove these two lines from the `server.ts` file
```ts title="server.ts"
new RateLimiter(app, [GLOBAL_RL]);
new RateLimiter(app, evmchains);
```
### Disabling CAPTCHA Verification[](#disabling-captcha-verification "Direct link to heading")
Remove the `captcha.middleware` from `sendToken` API.
### Starting the Faucet[](#starting-the-faucet "Direct link to heading")
Follow the below commands to start your local faucet.
#### Installing Dependencies[](#installing-dependencies "Direct link to heading")
This will concurrently install dependencies for both client and server.
If ports have a default configuration, then the client will start at port 3000 and the server will start at port 8000 while in development mode.
#### Starting in Development Mode[](#starting-in-development-mode "Direct link to heading")
This will concurrently start the server and client in development mode.
#### Building for Production[](#building-for-production "Direct link to heading")
The following command will build server and client at `build/` and `build/client` directories.
#### Starting in Production Mode[](#starting-in-production-mode "Direct link to heading")
This command should only be run after successfully building the client and server-side code.
### Setting up with Docker[](#setting-up-with-docker "Direct link to heading")
Follow the steps to run this application in a Docker container.
#### Build Docker Image[](#build-docker-image "Direct link to heading")
Docker images can be served as the built versions of our application, that can be used to deploy on Docker container.
```bash
docker build . -t faucet-image
```
#### Starting Application inside Docker Container[](#starting-application-inside-docker-container "Direct link to heading")
Now we can create any number of containers using the above `faucet` image. We also have to supply the `.env` file or the environment variables with the secret keys to create the container. Once the container is created, these variables and configurations will be persisted and can be easily started or stopped with a single command.
```bash
docker run -p 3000:8000 --name faucet-container --env-file ../.env faucet-image
```
The server will run on port 8000, and our Docker will also expose this port for the outer world to interact. We have exposed this port in the `Dockerfile`. But we cannot directly interact with the container port, so we had to bind this container port to our host port. For the host port, we have chosen 3000. This flag `-p 3000:8000` achieves the same.
This will start our faucet application in a Docker container at port 3000 (port 8000 on the container). You can interact with the application by visiting \[http://localhost:3000\] in your browser.
#### Stopping the Container[](#stopping-the-container "Direct link to heading")
You can easily stop the container using the following command
```bash
docker stop faucet-container
```
#### Restarting the Container[](#restarting-the-container "Direct link to heading")
To restart the container, use the following command
```bash
docker start faucet-container
```
Using the Faucet[](#using-the-faucet "Direct link to heading")
---------------------------------------------------------------
Using the faucet is quite straightforward, but for the sake of completeness, let's go through the steps, to collect your first test coins.
### Visit Avalanche Faucet Site[](#visit-avalanche-faucet-site "Direct link to heading")
Go to [https://core.app/tools/testnet-faucet/](https://core.app/tools/testnet-faucet/). You will see various network parameters like network name, faucet balance, drop amount, drop limit, faucet address, etc.

### Select Network[](#select-network "Direct link to heading")
You can use the dropdown to select the network of your choice and get some free coins (each network may have a different drop amount).

### Put Address and Request Coins[](#put-address-and-request-coins "Direct link to heading")
If you already have an AVAX balance greater than zero on Mainnet, paste your C-Chain address there, and request test tokens. Otherwise, please request a faucet coupon on [Guild](https://guild.xyz/avalanche). Admins and mods on the official [Discord](https://discord.com/invite/RwXY7P6) can provide testnet AVAX if developers are unable to obtain it from the other two options.
Within a second, you will get a **transaction hash** for the processed transaction. The hash would be a hyperlink to Avalanche L1's explorer. You can see the transaction status, by clicking on that hyperlink.

### More Interactions[](#more-interactions "Direct link to heading")
This is not just it. Using the buttons shown below, you can go to the Avalanche L1 explorer or add the Avalanche L1 to your browser wallet extensions like Core or MetaMask with a single click.

### Probable Errors and Troubleshooting[](#probable-errors-and-troubleshooting "Direct link to heading")
Errors are not expected, but if you are facing some of the errors shown, then you could try troubleshooting as shown below. If none of the troubleshooting works, reach us through [Discord](https://discord.com/channels/578992315641626624/).
1. **Too many requests. Please try again after X minutes**: This is a rate-limiting message. Every Avalanche L1 can set its drop limits. The above message suggests that you have reached your drop limit, that is the number of times you could request coins within the window of X minutes. You should try requesting after X minutes. If you are facing this problem, even when you are requesting for the first time in the window, you may be behind some proxy, Wi-Fi, or VPN service that is also being used by some other user.
2. **CAPTCHA verification failed! Try refreshing**: We are using v3 of [Google's reCAPTCHA](https://developers.google.com/recaptcha/docs/v3). This version uses scores between 0 and 1 to rate the interaction of humans with the site, with 0 being the most suspicious one. You do not have to solve any puzzle or mark the **I am not a Robot** checkbox. The score will be automatically calculated. We want our users to score at least 0.3 to use the faucet. This is configurable, and we will update the threshold after having broader data. But if you are facing this issue, then you can try refreshing your page, disabling ad-blockers, or switching off any VPN. You can follow this [guide](https://2captcha.com/blog/google-doesnt-accept-recaptcha-answers) to get rid of this issue.
3. **Internal RPC error! Please try after sometime**: This is an internal error in the Avalanche L1's node, on which we are making an RPC for sending transactions. A regular check will update the RPC's health status every 30 seconds (default) or whatever is set in the configuration. This may happen only in rare scenarios and you cannot do much about it, rather than waiting.
4. **Timeout of 10000ms exceeded**: There could be many reasons for this message. It could be an internal server error, or the request didn't receive by the server, slow internet, etc. You could try again after some time, and if the problem persists, then you should raise this issue on our [Discord](https://discord.com/channels/578992315641626624/) server.
5. **Couldn't see any transaction status on explorer**: The transaction hash that you get for each drop is pre-computed using the expected nonce, amount, and receiver's address. Though transactions on Avalanche are near-instant, the explorer may take time to index those transactions. You should wait for a few more seconds, before raising any issue or reaching out to us.
# Background and Requirements (/docs/avalanche-l1s/custom-precompiles/background-requirements)
---
title: Background and Requirements
description: Learn about the background and requirements for customizing Ethereum Virtual Machine.
---
This is a brief overview of what this tutorial will cover.
- Write a Solidity interface
- Generate the precompile template
- Implement the precompile functions in Golang
- Write and run tests
Stateful precompiles are [alpha software](https://en.wikipedia.org/wiki/Software_release_life_cycle#Alpha). Build at your own risk.
In this tutorial, we used a branch based on Subnet-EVM version `v0.5.2`. You can find the branch [here](https://github.com/ava-labs/subnet-evm/tree/helloworld-official-tutorial-v2). The code in this branch is the same as Subnet-EVM except for the `precompile/contracts/helloworld` directory. The directory contains the code for the `HelloWorld` precompile. We will be using this precompile as an example to learn how to write a stateful precompile. The code in this branch can become outdated. You should always use the latest version of Subnet-EVM when you develop your own precompile.
## Precompile-EVM
Subnet-EVM precompiles can be registered from an external repo. This allows developer to build their precompiles without maintaining a fork of Subnet-EVM. The precompiles are then registered in the Subnet-EVM at build time.
The difference between using Subnet-EVM and Precompile-EVM is that with Subnet-EVM you can change EVM internals to interact with your precompiles. Such as changing fee structure, adding new opcodes, changing how to build a block, etc. With Precompile-EVM you can only add new stateful precompiles that can interact with the StateDB. Precompiles built with Precompile-EVM are still very powerful because it can directly access to the state and modify it.
There is a template repo for how to build a precompile with this way called [Precompile-EVM](https://github.com/ava-labs/precompile-evm). Both Subnet-EVM and Precompile-EVM share similar directory structures and common codes.
You can reference the Precompile-EVM PR that adds Hello World precompile [here](https://github.com/ava-labs/precompile-evm/pull/12).
## Requirements
This tutorial assumes familiarity with Golang and JavaScript.
Additionally, users should be deeply familiar with the EVM in order to understand its invariants since adding a Stateful Precompile modifies the EVM itself.
Here are some recommended resources to learn the ins and outs of the EVM:
- [The Ethereum Virtual Machine](https://github.com/ethereumbook/ethereumbook/blob/develop/13evm.asciidoc)
- [Precompiles in Solidity](https://medium.com/@rbkhmrcr/precompiles-solidity-e5d29bd428c4)
- [Deconstructing a Smart Contract](https://blog.openzeppelin.com/deconstructing-a-solidity-contract-part-i-introduction-832efd2d7737/)
- [Layout of State Variables in Storage](https://docs.soliditylang.org/en/v0.8.10/internals/layout_in_storage.html)
- [Layout in Memory](https://docs.soliditylang.org/en/v0.8.10/internals/layout_in_memory.html)
- [Layout of Call Data](https://docs.soliditylang.org/en/v0.8.10/internals/layout_in_calldata.html)
- [Contract ABI Specification](https://docs.soliditylang.org/en/v0.8.10/abi-spec.html)
- [Customizing the EVM with Stateful Precompiles](https://medium.com/avalancheavax/customizing-the-evm-with-stateful-precompiles-f44a34f39efd)
Please install the following before getting started.
First, install the latest version of Go. Follow the instructions [here](https://go.dev/doc/install). You can verify by running `go version`.
Set the `$GOPATH` environment variable properly for Go to look for Go Workspaces. Please read [this](https://go.dev/doc/gopath_code) for details. You can verify by running `echo $GOPATH`.
See [here](https://github.com/golang/go/wiki/SettingGOPATH) for instructions on setting the GOPATH based on system configurations.
As a few things will be installed into `$GOPATH/bin`, please make sure that `$GOPATH/bin` is in your `$PATH`, otherwise, you may get an error running the commands below. To do that, run the command: `export PATH=$PATH:$GOROOT/bin:$GOPATH/bin`
Download the following prerequisites into your `$GOPATH`:
- Git Clone the repository (Subnet-EVM or Precompile-EVM)
- Git Clone [AvalancheGo](https://github.com/ava-labs/avalanchego) repository
- Install [Avalanche Network Runner](/docs/tooling/avalanche-cli)
- Install [solc](https://github.com/ethereum/solc-js#usage-on-the-command-line)
- Install [Node.js and NPM](https://nodejs.org/en/download) For easy copy paste, use the below commands:
```bash
cd $GOPATH
mkdir -p src/github.com/ava-labs
cd src/github.com/ava-labs
```
Clone the repository:
```bash
git clone git@github.com:ava-labs/subnet-evm.git
```
Then run the following commands:
```bash
git clone git@github.com:ava-labs/avalanchego.git
curl -sSfL https://raw.githubusercontent.com/ava-labs/avalanche-network-runner/main/scripts/install.sh | sh -s
npm install -g solc
```
```bash
git clone git@github.com:ava-labs/precompile-evm.git
```
Alternatively you can use it as a template repo from github.
Then run the following commands:
```bash
git clone git@github.com:ava-labs/avalanchego.git
curl -sSfL https://raw.githubusercontent.com/ava-labs/avalanche-network-runner/main/scripts/install.sh | sh -s
npm install -g solc
```
## Complete Code
You can inspect example pull request for the complete code.
[Subnet-EVM Hello World Pull Request](https://github.com/ava-labs/subnet-evm/pull/565/)
[Precompile-EVM Hello World Pull Request](https://github.com/ava-labs/precompile-evm/pull/12/)
For a full-fledged example, you can also check out the [Reward Manager Precompile](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/rewardmanager/).
# Generating Your Precompile (/docs/avalanche-l1s/custom-precompiles/create-precompile)
---
title: Generating Your Precompile
description: In this section, we will go over the process for automatically generating the template code which you can configure accordingly for your stateful precompile.
---
First, we must create the Solidity interface that we want our precompile to implement. This will be the HelloWorld Interface. It will have two simple functions, `sayHello()`, `setGreeting()` and an event `GreetingChanged`. These two functions will demonstrate the getting and setting respectively of a value stored in the precompile's state space.
The `sayHello()` function is a `view` function, meaning it does not modify the state of the precompile and returns a string result. The `setGreeting()` function is a state changer function, meaning it modifies the state of the precompile. The `HelloWorld` interface inherits `IAllowList` interface to use the allow list functionality.
For this tutorial, we will be working in a new branch in Subnet-EVM/Precompile-EVM repo.
```bash
cd $GOPATH/src/github.com/ava-labs/subnet-evm
```
We will start off in this directory `./contracts/`:
```bash
cd contracts/
```
Create a new file called `IHelloWorld.sol` and copy and paste the below code:
```solidity title="contracts/IHelloWorld.sol"
// (c) 2022-2023, Ava Labs, Inc. All rights reserved.
// See the file LICENSE for licensing terms.
// SPDX-License-Identifier: MIT
pragma solidity >=0.8.0;
import "./IAllowList.sol";
interface IHelloWorld is IAllowList {
event GreetingChanged(
address indexed sender,
string oldGreeting,
string newGreeting
);
// sayHello returns the stored greeting string
function sayHello() external view returns (string calldata result);
// setGreeting stores the greeting string
function setGreeting(string calldata response) external;
}
```
Now we have an interface that our precompile can implement! Let's create an [ABI](https://docs.soliditylang.org/en/v0.8.13/abi-spec.html#contract-abi-specification) of our Solidity interface.
In the same directory, let's run:
```bash
solc --abi ./contracts/interfaces/IHelloWorld.sol -o ./abis
```
This generates the ABI code under `./abis/contracts_interfaces_IHelloWorld_sol_IHelloWorld.abi`.
```
[
{
"anonymous": false,
"inputs": [
{
"indexed": true,
"internalType": "address",
"name": "sender",
"type": "address"
},
{
"indexed": false,
"internalType": "string",
"name": "oldGreeting",
"type": "string"
},
{
"indexed": false,
"internalType": "string",
"name": "newGreeting",
"type": "string"
}
],
"name": "GreetingChanged",
"type": "event"
},
{
"anonymous": false,
"inputs": [
{
"indexed": true,
"internalType": "uint256",
"name": "role",
"type": "uint256"
},
{
"indexed": true,
"internalType": "address",
"name": "account",
"type": "address"
},
{
"indexed": true,
"internalType": "address",
"name": "sender",
"type": "address"
},
{
"indexed": false,
"internalType": "uint256",
"name": "oldRole",
"type": "uint256"
}
],
"name": "RoleSet",
"type": "event"
},
{
"inputs": [
{ "internalType": "address", "name": "addr", "type": "address" }
],
"name": "readAllowList",
"outputs": [
{ "internalType": "uint256", "name": "role", "type": "uint256" }
],
"stateMutability": "view",
"type": "function"
},
{
"inputs": [],
"name": "sayHello",
"outputs": [
{ "internalType": "string", "name": "result", "type": "string" }
],
"stateMutability": "view",
"type": "function"
},
{
"inputs": [
{ "internalType": "address", "name": "addr", "type": "address" }
],
"name": "setAdmin",
"outputs": [],
"stateMutability": "nonpayable",
"type": "function"
},
{
"inputs": [
{ "internalType": "address", "name": "addr", "type": "address" }
],
"name": "setEnabled",
"outputs": [],
"stateMutability": "nonpayable",
"type": "function"
},
{
"inputs": [
{ "internalType": "string", "name": "response", "type": "string" }
],
"name": "setGreeting",
"outputs": [],
"stateMutability": "nonpayable",
"type": "function"
},
{
"inputs": [
{ "internalType": "address", "name": "addr", "type": "address" }
],
"name": "setManager",
"outputs": [],
"stateMutability": "nonpayable",
"type": "function"
},
{
"inputs": [
{ "internalType": "address", "name": "addr", "type": "address" }
],
"name": "setNone",
"outputs": [],
"stateMutability": "nonpayable",
"type": "function"
}
]
```
As you can see the ABI also contains the `IAllowList` interface functions. This is because the `IHelloWorld` interface inherits from the `IAllowList` interface.
Note: The ABI must have named outputs in order to generate the precompile template.
Now that we have an ABI for the precompile gen tool to interact with, we can run the following command to generate our HelloWorld precompile files!
Let's go back to the root of the repository and run the PrecompileGen script helper:
```bash
cd ..
```
Both of these Subnet-EVM and Precompile-EVM have the same `generate_precompile.sh` script. The one in Precompile-EVM installs the script from Subnet-EVM and runs it.
```bash
./scripts/generate_precompile.sh --help
# output
Using branch: precompile-tutorial
NAME:
precompilegen - subnet-evm precompile generator tool
USAGE:
main [global options] command [command options] [arguments...]
VERSION:
1.10.26-stable
COMMANDS:
help, h Shows a list of commands or help for one command
GLOBAL OPTIONS:
--abi value
Path to the contract ABI json to generate, - for STDIN
--out value
Output folder for the generated precompile files, - for STDOUT (default =
./precompile/contracts/{pkg}). Test files won't be generated if STDOUT is used
--pkg value
Go package name to generate the precompile into (default = {type})
--type value
Struct name for the precompile (default = {abi file name})
MISC
--help, -h (default: false)
show help
--version, -v (default: false)
print the version
COPYRIGHT:
Copyright 2013-2022 The go-ethereum Authors
```
Now let's generate the precompile template files!
```bash
cd $GOPATH/src/github.com/ava-labs/precompile-evm
```
We will start off in this directory `./contracts/`:
```bash
cd contracts/
```
For Precompile-EVM interfaces and other contracts in Subnet-EVM can be accessible through `@avalabs/subnet-evm-contracts` package. This is already added to the `package.json` file. You can install it by running `npm install`. In order to import `IAllowList` interface, you can use the following import statement:
```solidity
import "@avalabs/subnet-evm-contracts/contracts/interfaces/IAllowList.sol";
```
The full file looks like this:
```solidity
// SPDX-License-Identifier: MIT
pragma solidity >=0.8.0;
import "@avalabs/subnet-evm-contracts/contracts/interfaces/IAllowList.sol";
interface IHelloWorld is IAllowList {
event GreetingChanged(
address indexed sender,
string oldGreeting,
string newGreeting
);
// sayHello returns the stored greeting string
function sayHello() external view returns (string calldata result);
// setGreeting stores the greeting string
function setGreeting(string calldata response) external;
}
```
Now we have an interface that our precompile can implement! Let's create an ABI of our Solidity interface.
In Precompile-EVM we import contracts from `@avalabs/subnet-evm-contracts` package. In order to generate the ABI in Precompile-EVM we need to include the `node_modules` folder to find imported contracts with following flags:
- `--abi`: ABI specification of the contracts.
- `--base-path path`: Use the given path as the root of the source tree instead of the root of the filesystem.
- `--include-path path`: Make an additional source directory available to the default import callback. Use this option if you want to import contracts whose location is not fixed in relation to your main source tree; for example third-party libraries installed using a package manager. Can be used multiple times. Can only be used if base path has a non-empty value.
- `--output-dir path`: If given, creates one file per output component and contract/file at the specified directory.
- `--overwrite`: Overwrite existing files (used together with` --output-dir`).
```bash
solc --abi ./contracts/interfaces/IHelloWorld.sol -o ./abis --base-path . --include-path ./node_modules
```
This generates the ABI code under `./abis/contracts_interfaces_IHelloWorld_sol_IHelloWorld.abi`.
```
[
{
"anonymous": false,
"inputs": [
{
"indexed": true,
"internalType": "address",
"name": "sender",
"type": "address"
},
{
"indexed": false,
"internalType": "string",
"name": "oldGreeting",
"type": "string"
},
{
"indexed": false,
"internalType": "string",
"name": "newGreeting",
"type": "string"
}
],
"name": "GreetingChanged",
"type": "event"
},
{
"anonymous": false,
"inputs": [
{
"indexed": true,
"internalType": "uint256",
"name": "role",
"type": "uint256"
},
{
"indexed": true,
"internalType": "address",
"name": "account",
"type": "address"
},
{
"indexed": true,
"internalType": "address",
"name": "sender",
"type": "address"
},
{
"indexed": false,
"internalType": "uint256",
"name": "oldRole",
"type": "uint256"
}
],
"name": "RoleSet",
"type": "event"
},
{
"inputs": [
{ "internalType": "address", "name": "addr", "type": "address" }
],
"name": "readAllowList",
"outputs": [
{ "internalType": "uint256", "name": "role", "type": "uint256" }
],
"stateMutability": "view",
"type": "function"
},
{
"inputs": [],
"name": "sayHello",
"outputs": [
{ "internalType": "string", "name": "result", "type": "string" }
],
"stateMutability": "view",
"type": "function"
},
{
"inputs": [
{ "internalType": "address", "name": "addr", "type": "address" }
],
"name": "setAdmin",
"outputs": [],
"stateMutability": "nonpayable",
"type": "function"
},
{
"inputs": [
{ "internalType": "address", "name": "addr", "type": "address" }
],
"name": "setEnabled",
"outputs": [],
"stateMutability": "nonpayable",
"type": "function"
},
{
"inputs": [
{ "internalType": "string", "name": "response", "type": "string" }
],
"name": "setGreeting",
"outputs": [],
"stateMutability": "nonpayable",
"type": "function"
},
{
"inputs": [
{ "internalType": "address", "name": "addr", "type": "address" }
],
"name": "setManager",
"outputs": [],
"stateMutability": "nonpayable",
"type": "function"
},
{
"inputs": [
{ "internalType": "address", "name": "addr", "type": "address" }
],
"name": "setNone",
"outputs": [],
"stateMutability": "nonpayable",
"type": "function"
}
]
```
As you can see the ABI also contains the `IAllowList` interface functions. This is because the `IHelloWorld` interface inherits from the `IAllowList` interface.
Note: The ABI must have named outputs in order to generate the precompile template.
Now that we have an ABI for the precompile gen tool to interact with, we can run the following command to generate our HelloWorld precompile files!
Let's go back to the root of the repository and run the PrecompileGen script helper:
```bash
cd ..
```
Both of these Subnet-EVM and Precompile-EVM have the same generate_precompile.sh script. The one in Precompile-EVM installs the script from Subnet-EVM and runs it.
```bash
./scripts/generate_precompile.sh --help
# output
Using branch: precompile-tutorial
NAME:
precompilegen - subnet-evm precompile generator tool
USAGE:
main [global options] command [command options] [arguments...]
VERSION:
1.10.26-stable
COMMANDS:
help, h Shows a list of commands or help for one command
GLOBAL OPTIONS:
--abi value
Path to the contract ABI json to generate, - for STDIN
--out value
Output folder for the generated precompile files, - for STDOUT (default =
./precompile/contracts/{pkg}). Test files won't be generated if STDOUT is used
--pkg value
Go package name to generate the precompile into (default = {type})
--type value
Struct name for the precompile (default = {abi file name})
MISC
--help, -h (default: false)
show help
--version, -v (default: false)
print the version
COPYRIGHT:
Copyright 2013-2022 The go-ethereum Authors
```
Now let's generate the precompile template files!
In Subnet-EVM precompile implementations reside under the `./precompile/contracts` directory. Let's generate our precompile template in the `./precompile/contracts/helloworld` directory, where `helloworld` is the name of the Go package we want to generate the precompile into.
```bash
./scripts/generate_precompile.sh --abi ./contracts/abis/contracts_interfaces_IHelloWorld_sol_IHelloWorld.abi --type HelloWorld --pkg helloworld
```
This generates a precompile template files `contract.go`, `contract.abi`, `config.go`, `module.go`, `event.go` and `README.md` files. `README.md` explains general guidelines for precompile development. You should carefully read this file before modifying the precompile template.
```
There are some must-be-done changes waiting in the generated file. Each area requiring you to add your code is marked with CUSTOM CODE to make them easy to find and modify.
Additionally there are other files you need to edit to activate your precompile.
These areas are highlighted with comments "ADD YOUR PRECOMPILE HERE".
For testing take a look at other precompile tests in contract_test.go and config_test.go in other precompile folders.
General guidelines for precompile development:
1- Set a suitable config key in generated module.go. E.g: "yourPrecompileConfig"
2- Read the comment and set a suitable contract address in generated module.go. E.g:
ContractAddress = common.HexToAddress("ASUITABLEHEXADDRESS")
3- It is recommended to only modify code in the highlighted areas marked with "CUSTOM CODE STARTS HERE". Typically, custom codes are required in only those areas.
Modifying code outside of these areas should be done with caution and with a deep understanding of how these changes may impact the EVM.
4- If you have any event defined in your precompile, review the generated event.go file and set your event gas costs. You should also emit your event in your function in the contract.go file.
5- Set gas costs in generated contract.go
6- Force import your precompile package in precompile/registry/registry.go
7- Add your config unit tests under generated package config_test.go
8- Add your contract unit tests under generated package contract_test.go
9- Additionally you can add a full-fledged VM test for your precompile under plugin/vm/vm_test.go. See existing precompile tests for examples.
10- Add your solidity interface and test contract to contracts/contracts
11- Write solidity contract tests for your precompile in contracts/contracts/test
12- Write TypeScript DS-Test counterparts for your solidity tests in contracts/test
13- Create your genesis with your precompile enabled in tests/precompile/genesis/
14- Create e2e test for your solidity test in tests/precompile/solidity/suites.go
15- Run your e2e precompile Solidity tests with './scripts/run_ginkgo.sh`
```
Let's follow these steps and create our HelloWorld precompile.
For Precompile-EVM we don't need to put files under a deep directory structure. We can just generate the precompile template under its own directory via `--out ./helloworld` flag.
```bash
./scripts/generate_precompile.sh --abi ./contracts/abis/contracts_interfaces_IHelloWorld_sol_IHelloWorld.abi --type HelloWorld --pkg helloworld --out ./helloworld
```
This generates a precompile template files `contract.go`, `contract.abi`, `config.go`, `module.go`, `event.go` and `README.md` files. `README.md` explains general guidelines for precompile development. You should carefully read this file before modifying the precompile template.
```
There are some must-be-done changes waiting in the generated file. Each area requiring you to add your code is marked with CUSTOM CODE to make them easy to find and modify.
Additionally there are other files you need to edit to activate your precompile.
These areas are highlighted with comments "ADD YOUR PRECOMPILE HERE".
For testing take a look at other precompile tests in contract_test.go and config_test.go in other precompile folders.
General guidelines for precompile development:
1- Set a suitable config key in generated module.go. E.g: "yourPrecompileConfig"
2- Read the comment and set a suitable contract address in generated module.go. E.g:
ContractAddress = common.HexToAddress("ASUITABLEHEXADDRESS")
3- It is recommended to only modify code in the highlighted areas marked with "CUSTOM CODE STARTS HERE". Typically, custom codes are required in only those areas.
Modifying code outside of these areas should be done with caution and with a deep understanding of how these changes may impact the EVM.
4- If you have any event defined in your precompile, review the generated event.go file and set your event gas costs. You should also emit your event in your function in the contract.go file.
5- Set gas costs in generated contract.go
6- Force import your precompile package in precompile/registry/registry.go
7- Add your config unit tests under generated package config_test.go
8- Add your contract unit tests under generated package contract_test.go
9- Additionally you can add a full-fledged VM test for your precompile under plugin/vm/vm_test.go. See existing precompile tests for examples.
10- Add your solidity interface and test contract to contracts/contracts
11- Write solidity contract tests for your precompile in contracts/contracts/test
12- Write TypeScript DS-Test counterparts for your solidity tests in contracts/test
13- Create your genesis with your precompile enabled in tests/precompile/genesis/
14- Create e2e test for your solidity test in tests/precompile/solidity/suites.go
15- Run your e2e precompile Solidity tests with './scripts/run_ginkgo.sh`
```
Let's follow these steps and create our HelloWorld precompile!
# Defining Your Precompile (/docs/avalanche-l1s/custom-precompiles/defining-precompile)
---
title: Defining Your Precompile
description: Now that we have autogenerated the template code required for our precompile, let's actually write the logic for the precompile itself.
---
## Setting Config Key
Let's jump to `helloworld/module.go` file first. This file contains the module definition for our precompile. You can see the `ConfigKey` is set to some default value of `helloWorldConfig`. This key should be unique to the precompile.
This config key determines which JSON key to use when reading the precompile's config from the JSON upgrade/genesis file. In this case, the config key is `helloWorldConfig` and the JSON config should look like this:
```json
{
"helloWorldConfig": {
"blockTimestamp": 0
...
}
}
```
## Setting Contract Address
In the `helloworld/module.go` you can see the `ContractAddress` is set to some default value. This should be changed to a suitable address for your precompile. The address should be unique to the precompile. There is a registry of precompile addresses under [`precompile/registry/registry.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/registry/registry.go).
A list of addresses is specified in the comments under this file. Modify the default value to be the next user available stateful precompile address. For forks of Subnet-EVM or Precompile-EVM, users should start at `0x0300000000000000000000000000000000000000` to ensure that their own modifications do not conflict with stateful precompiles that may be added to Subnet-EVM in the future. You should pick an address that is not already taken.
```go title="helloworld/module.go"
// This list is kept just for reference. The actual addresses defined in respective packages of precompiles.
// Note: it is important that none of these addresses conflict with each other or any other precompiles
// in core/vm/contracts.go.
// The first stateful precompiles were added in coreth to support nativeAssetCall and nativeAssetBalance. New stateful precompiles
// originating in coreth will continue at this prefix, so we reserve this range in subnet-evm so that they can be migrated into
// subnet-evm without issue.
// These start at the address: 0x0100000000000000000000000000000000000000 and will increment by 1.
// Optional precompiles implemented in subnet-evm start at 0x0200000000000000000000000000000000000000 and will increment by 1
// from here to reduce the risk of conflicts.
// For forks of subnet-evm, users should start at 0x0300000000000000000000000000000000000000 to ensure
// that their own modifications do not conflict with stateful precompiles that may be added to subnet-evm
// in the future.
// ContractDeployerAllowListAddress = common.HexToAddress("0x0200000000000000000000000000000000000000")
// ContractNativeMinterAddress = common.HexToAddress("0x0200000000000000000000000000000000000001")
// TxAllowListAddress = common.HexToAddress("0x0200000000000000000000000000000000000002")
// FeeManagerAddress = common.HexToAddress("0x0200000000000000000000000000000000000003")
// RewardManagerAddress = common.HexToAddress("0x0200000000000000000000000000000000000004")
// HelloWorldAddress = common.HexToAddress("0x0300000000000000000000000000000000000000")
// ADD YOUR PRECOMPILE HERE
// {YourPrecompile}Address = common.HexToAddress("0x03000000000000000000000000000000000000??")
```
Don't forget to update the actual variable `ContractAddress` in `module.go` to the address you chose. It should look like this:
```go title="helloworld/module.go"
// ContractAddress is the defined address of the precompile contract.
// This should be unique across all precompile contracts.
// See params/precompile_modules.go for registered precompile contracts and more information.
var ContractAddress = common.HexToAddress("0x0300000000000000000000000000000000000000")
```
Now when Subnet-EVM sees the `helloworld.ContractAddress` as input when executing [`CALL`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/evm.go#L251), [`CALLCODE`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/evm.go#L341), [`DELEGATECALL`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/evm.go#L392), [`STATICCALL`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/evm.go#L435), it can run the precompile if the precompile is enabled.
## Adding Custom Code
Search (`CTRL F`) throughout the file with `CUSTOM CODE STARTS HERE` to find the areas in the precompile package that you need to modify. You should start with the reference imports code block.
### Module File
The module file contains fundamental information about the precompile. This includes the key for the precompile, the address of the precompile, and a configurator. This file is located at [`./precompile/helloworld/module.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/module.go) for Subnet-EVM and [./helloworld/module.go](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/module.go) for Precompile-EVM.
This file defines the module for the precompile. The module is used to register the precompile to the precompile registry. The precompile registry is used to read configs and enable the precompile. Registration is done in the `init()` function of the module file. `MakeConfig()` is used to create a new instance for the precompile config. This will be used in custom Unmarshal/Marshal logic. You don't need to override these functions.
#### Configure()
Module file contains a `configurator` which implements the `contract.Configurator` interface. This interface includes a `Configure()` function used to configure the precompile and set the initial state of the precompile. This function is called when the precompile is enabled. This is typically used to read from a given config in upgrade/genesis JSON and sets the initial state of the precompile accordingly. This function also calls `AllowListConfig.Configure()` to invoke AllowList configuration as the last step. You should keep it as it is if you want to use AllowList. You can modify this function for your custom logic. You can circle back to this function later after you have finalized the implementation of the precompile config.
### Config File
The config file contains the config for the precompile. This file is located at [`./precompile/helloworld/config.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/config.go) for Subnet-EVM and [./helloworld/config.go](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/config.go) for Precompile-EVM. This file contains the `Config` struct, which implements `precompileconfig.Config` interface. It has some embedded structs like `precompileconfig.Upgrade`. `Upgrade` is used to enable upgrades for the precompile. It contains the `BlockTimestamp` and `Disable` to enable/disable upgrades. `BlockTimestamp` is the timestamp of the block when the upgrade will be activated. `Disable` is used to disable the upgrade. If you use `AllowList` for the precompile, there is also `allowlist.AllowListConfig` embedded in the `Config` struct. `AllowListConfig` is used to specify initial roles for specified addresses. If you have any custom fields in your precompile config, you can add them here. These custom fields will be read from upgrade/genesis JSON and set in the precompile config.
```go title="precompile/helloworld/config.go"
// Config implements the precompileconfig.Config interface and
// adds specific configuration for HelloWorld.
type Config struct {
allowlist.AllowListConfig
precompileconfig.Upgrade
}
```
#### Verify()
`Verify()` is called on startup and an error is treated as fatal. Generated code contains a call to `AllowListConfig.Verify()` to verify the `AllowListConfig`. You can leave that as is and start adding your own custom verify code after that.
We can leave this function as is right now because there is no invalid custom configuration for the `Config`.
```go title="precompile/helloworld/config.go"
// Verify tries to verify Config and returns an error accordingly.
func (c *Config) Verify() error {
// Verify AllowList first
if err := c.AllowListConfig.Verify(); err != nil {
return err
}
// CUSTOM CODE STARTS HERE
// Add your own custom verify code for Config here
// and return an error accordingly
return nil
}
```
#### Equal()
Next, we see is `Equal()`. This function determines if two precompile configs are equal. This is used to determine if the precompile needs to be upgraded. There is some default code that is generated for checking `Upgrade` and `AllowListConfig` equality.
```go title="precompile/helloworld/config.go"
// Equal returns true if [s] is a [*Config] and it has been configured identical to [c].
func (c *Config) Equal(s precompileconfig.Config) bool {
// typecast before comparison
other, ok := (s).(*Config)
if !ok {
return false
}
// CUSTOM CODE STARTS HERE
// modify this boolean accordingly with your custom Config, to check if [other] and the current [c] are equal
// if Config contains only Upgrade and AllowListConfig you can skip modifying it.
equals := c.Upgrade.Equal(&other.Upgrade) && c.AllowListConfig.Equal(&other.AllowListConfig)
return equals
}
```
We can leave this function as is since we check `Upgrade` and `AllowListConfig` for equality which are the only fields that `Config` struct has.
### Modify Configure()
We can now circle back to `Configure()` in `module.go` as we finished implementing `Config` struct. This function configures the `state` with the initial configuration at`blockTimestamp` when the precompile is enabled.
In the HelloWorld example, we want to set up a default key-value mapping in the state where the key is `storageKey` and the value is `Hello World!`. The `StateDB` allows us to store a key-value mapping of 32-byte hashes. The below code snippet can be copied and pasted to overwrite the default `Configure()` code.
```go title="precompile/helloworld/module.go"
const defaultGreeting = "Hello World!"
// Configure configures [state] with the given [cfg] precompileconfig.
// This function is called by the EVM once per precompile contract activation.
// You can use this function to set up your precompile contract's initial state,
// by using the [cfg] config and [state] stateDB.
func (*configurator) Configure(chainConfig contract.ChainConfig, cfg precompileconfig.Config, state contract.StateDB, _ contract.BlockContext) error {
config, ok := cfg.(*Config)
if !ok {
return fmt.Errorf("incorrect config %T: %v", config, config)
}
// CUSTOM CODE STARTS HERE
// This will be called in the first block where HelloWorld stateful precompile is enabled.
// 1) If BlockTimestamp is nil, this will not be called
// 2) If BlockTimestamp is 0, this will be called while setting up the genesis block
// 3) If BlockTimestamp is 1000, this will be called while processing the first block
// whose timestamp is >= 1000
//
// Set the initial value under [common.BytesToHash([]byte("storageKey")] to "Hello World!"
StoreGreeting(state, defaultGreeting)
// AllowList is activated for this precompile. Configuring allowlist addresses here.
return config.AllowListConfig.Configure(state, ContractAddress)
}
```
### Event File
The event file contains the events that the precompile can emit. This file is located at [`./precompile/helloworld/event.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/event.go) for Subnet-EVM and [./helloworld/event.go](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/event.go) for Precompile-EVM. The file begins with a comment about events and how they can be emitted:
```go title="precompile/helloworld/event.go"
/* NOTE: Events can only be emitted in state-changing functions. So you cannot use events in read-only (view) functions.
Events are generally emitted at the end of a state-changing function with AddLog method of the StateDB. The AddLog method takes 4 arguments:
1. Address of the contract that emitted the event.
2. Topic hashes of the event.
3. Encoded non-indexed data of the event.
4. Block number at which the event was emitted.
The first argument is the address of the contract that emitted the event.
Topics can be at most 4 elements, the first topic is the hash of the event signature and the rest are the indexed event arguments. There can be at most 3 indexed arguments.
Topics cannot be fully unpacked into their original values since they're 32-bytes hashes.
The non-indexed arguments are encoded using the ABI encoding scheme. The non-indexed arguments can be unpacked into their original values.
Before packing the event, you need to calculate the gas cost of the event. The gas cost of an event is the base gas cost + the gas cost of the topics + the gas cost of the non-indexed data.
See Get{EvetName}EventGasCost functions for more details.
You can use the following code to emit an event in your state-changing precompile functions (generated packer might be different):*/
topics, data, err := PackMyEvent(
topic1,
topic2,
data1,
data2,
)
if err != nil {
return nil, remainingGas, err
}
accessibleState.GetStateDB().AddLog(&types.Log{
Address: ContractAddress,
Topics: topics,
Data: data,
BlockNumber: accessibleState.GetBlockContext().Number().Uint64(),
})
```
```go title="precompile/helloworld/event.go"
/* NOTE: Events can only be emitted in state-changing functions. So you cannot use events in read-only (view) functions.
Events are generally emitted at the end of a state-changing function with AddLog method of the StateDB. The AddLog method takes 4 arguments:
1. Address of the contract that emitted the event.
2. Topic hashes of the event.
3. Encoded non-indexed data of the event.
4. Block number at which the event was emitted.
The first argument is the address of the contract that emitted the event.
Topics can be at most 4 elements, the first topic is the hash of the event signature and the rest are the indexed event arguments. There can be at most 3 indexed arguments.
Topics cannot be fully unpacked into their original values since they're 32-bytes hashes.
The non-indexed arguments are encoded using the ABI encoding scheme. The non-indexed arguments can be unpacked into their original values.
Before packing the event, you need to calculate the gas cost of the event. The gas cost of an event is the base gas cost + the gas cost of the topics + the gas cost of the non-indexed data.
See Get{EvetName}EventGasCost functions for more details.
You can use the following code to emit an event in your state-changing precompile functions (generated packer might be different):*/
topics, data, err := PackMyEvent(
topic1,
topic2,
data1,
data2,
)
if err != nil {
return nil, remainingGas, err
}
accessibleState.GetStateDB().AddLog(
ContractAddress,
topics,
data,
accessibleState.GetBlockContext().Number().Uint64(),
)
```
In this file you should set your event's gas cost and implement the `Get{EventName}EventGasCost` function. This function should take the data you want to emit and calculate the gas cost. In this example we defined our event as follow, and plan to emit it in the `setGreeting` function:
```go
event GreetingChanged(address indexed sender, string oldGreeting, string newGreeting);
```
We used arbitrary strings as non-indexed event data, remind that each emitted event is stored on chain, thus charging right amount is critical. We calculated gas cost according to the length of the string to make sure we're charging right amount of gas. If you're sure that you're dealing with a fixed length data, you can use a fixed gas cost for your event. We will show how events can be emitted under the Contract File section.
### Contract File
The contract file contains the functions of the precompile contract that will be called by the EVM. The file is located at [`./precompile/helloworld/contract.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/contract.go) for Subnet-EVM and [./helloworld/contract.go](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/contract.go) for Precompile-EVM. Since we use `IAllowList` interface there will be auto-generated code for `AllowList` functions like below:
```go title="precompile/helloworld/contract.go"
// GetHelloWorldAllowListStatus returns the role of [address] for the HelloWorld list.
func GetHelloWorldAllowListStatus(stateDB contract.StateDB, address common.Address) allowlist.Role {
return allowlist.GetAllowListStatus(stateDB, ContractAddress, address)
}
// SetHelloWorldAllowListStatus sets the permissions of [address] to [role] for the
// HelloWorld list. Assumes [role] has already been verified as valid.
// This stores the [role] in the contract storage with address [ContractAddress]
// and [address] hash. It means that any reusage of the [address] key for different value
// conflicts with the same slot [role] is stored.
// Precompile implementations must use a different key than [address] for their storage.
func SetHelloWorldAllowListStatus(stateDB contract.StateDB, address common.Address, role allowlist.Role) {
allowlist.SetAllowListRole(stateDB, ContractAddress, address, role)
}
```
These will be helpful to use AllowList precompile helper in our functions.
#### Packers and Unpackers
There are also auto-generated Packers and Unpackers for the ABI. These will be used in `sayHello` and `setGreeting` functions to comfort the ABI. These functions are auto-generated and will be used in necessary places accordingly. You don't need to worry about how to deal with them, but it's good to know what they are.
Note: There were few changes to precompile packers with Durango. In this example we assumed that the HelloWorld precompile contract has been deployed before Durango. We need to activate this condition only after Durango. If this is a new precompile and never deployed before Durango, you can activate it immediately by removing the if condition.
Each input to a precompile contract function has it's own `Unpacker` function as follows (if deployed before Durango):
```go title="precompile/helloworld/contract.go"
// UnpackSetGreetingInput attempts to unpack [input] into the string type argument
// assumes that [input] does not include selector (omits first 4 func signature bytes)
// if [useStrictMode] is true, it will return an error if the length of [input] is not [common.HashLength]
func UnpackSetGreetingInput(input []byte, useStrictMode bool) (string, error) {
// Initially we had this check to ensure that the input was the correct length.
// However solidity does not always pack the input to the correct length, and allows
// for extra padding bytes to be added to the end of the input. Therefore, we have removed
// this check with the Durango. We still need to keep this check for backwards compatibility.
if useStrictMode && len(input) > common.HashLength {
return "", ErrInputExceedsLimit
}
res, err := HelloWorldABI.UnpackInput("setGreeting", input, useStrictMode)
if err != nil {
return "", err
}
unpacked := *abi.ConvertType(res[0], new(string)).(*string)
return unpacked, nil
}
```
If this is a new precompile that will be deployed after Durango, you can skip strict mode handling and use false:
```go title="precompile/helloworld/contract.go"
func UnpackSetGreetingInput(input []byte) (string, error) {
res, err := HelloWorldABI.UnpackInput("setGreeting", input, false)
if err != nil {
return "", err
}
unpacked := *abi.ConvertType(res[0], new(string)).(*string)
return unpacked, nil
}
```
The ABI is a binary format and the input to the precompile contract function is a byte array. The `Unpacker` function converts this input to a more easy-to-use format so that we can use it in our function.
Similarly, there is a `Packer` function for each output of a precompile contract function as follows:
```go title="precompile/helloworld/contract.go"
// PackSayHelloOutput attempts to pack given result of type string
// to conform the ABI outputs.
func PackSayHelloOutput(result string) ([]byte, error) {
return HelloWorldABI.PackOutput("sayHello", result)
}
```
This function converts the output of the function to a byte array that conforms to the ABI and can be returned to the EVM as a result.
#### Modify sayHello()
The next place to modify is in our `sayHello()` function. In a previous step, we created the `IHelloWorld.sol` interface with two functions `sayHello()` and `setGreeting()`. We finally get to implement them here. If any contract calls these functions from the interface, the below function gets executed. This function is a simple getter function.
In `Configure()` we set up a mapping with the key as `storageKey` and the value as `Hello World!`. In this function, we will be returning whatever value is at `storageKey`. The below code snippet can be copied and pasted to overwrite the default `setGreeting` code.
First, we add a helper function to get the greeting value from the stateDB, this will be helpful when we test our contract. We will use the `storageKeyHash` to store the value in the Contract's reserved storage in the stateDB.
```go title="precompile/helloworld/contract.go"
var (
// storageKeyHash is the hash of the storage key "storageKey" in the contract storage.
// This is used to store the value of the greeting in the contract storage.
// It is important to use a unique key here to avoid conflicts with other storage keys
// like addresses, AllowList, etc.
storageKeyHash = common.BytesToHash([]byte("storageKey"))
)
// GetGreeting returns the value of the storage key "storageKey" in the contract storage,
// with leading zeroes trimmed.
// This function is mostly used for tests.
func GetGreeting(stateDB contract.StateDB) string {
// Get the value set at recipient
value := stateDB.GetState(ContractAddress, storageKeyHash)
return string(common.TrimLeftZeroes(value.Bytes()))
}
```
Now we can modify the `sayHello` function to return the stored value.
```go title="precompile/helloworld/contract.go"
func sayHello(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) {
if remainingGas, err = contract.DeductGas(suppliedGas, SayHelloGasCost); err != nil {
return nil, 0, err
}
// CUSTOM CODE STARTS HERE
// Get the current state
currentState := accessibleState.GetStateDB()
// Get the value set at recipient
value := GetGreeting(currentState)
packedOutput, err := PackSayHelloOutput(value)
if err != nil {
return nil, remainingGas, err
}
// Return the packed output and the remaining gas
return packedOutput, remainingGas, nil
}
```
#### Modify setGreeting()
`setGreeting()` function is a simple setter function. It takes in `input` and we will set that as the value in the state mapping with the key as `storageKey`. It also checks if the VM running the precompile is in read-only mode. If it is, it returns an error. At the end of a successful execution, it will emit `GreetingChanged` event.
There is also a generated `AllowList` code in that function. This generated code checks if the caller address is eligible to perform this state-changing operation. If not, it returns an error.
Let's add the helper function to set the greeting value in the stateDB, this will be helpful when we test our contract.
```go title="precompile/helloworld/contract.go"
// StoreGreeting sets the value of the storage key "storageKey" in the contract storage.
func StoreGreeting(stateDB contract.StateDB, input string) {
inputPadded := common.LeftPadBytes([]byte(input), common.HashLength)
inputHash := common.BytesToHash(inputPadded)
stateDB.SetState(ContractAddress, storageKeyHash, inputHash)
}
```
The below code snippet can be copied and pasted to overwrite the default `setGreeting()` code.
```go title="precompile/helloworld/contract.go"
func setGreeting(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) {
if remainingGas, err = contract.DeductGas(suppliedGas, SetGreetingGasCost); err != nil {
return nil, 0, err
}
if readOnly {
return nil, remainingGas, vmerrs.ErrWriteProtection
}
// do not use strict mode after Durango
useStrictMode := !contract.IsDurangoActivated(accessibleState)
// attempts to unpack [input] into the arguments to the SetGreetingInput.
// Assumes that [input] does not include selector
// You can use unpacked [inputStruct] variable in your code
inputStruct, err := UnpackSetGreetingInput(input, useStrictMode)
if err != nil {
return nil, remainingGas, err
}
// Allow list is enabled and SetGreeting is a state-changer function.
// This part of the code restricts the function to be called only by enabled/admin addresses in the allow list.
// You can modify/delete this code if you don't want this function to be restricted by the allow list.
stateDB := accessibleState.GetStateDB()
// Verify that the caller is in the allow list and therefore has the right to call this function.
callerStatus := allowlist.GetAllowListStatus(stateDB, ContractAddress, caller)
if !callerStatus.IsEnabled() {
return nil, remainingGas, fmt.Errorf("%w: %s", ErrCannotSetGreeting, caller)
}
// allow list code ends here.
// CUSTOM CODE STARTS HERE
// With Durango, you can emit an event in your state-changing precompile functions.
// Note: If you have been using the precompile before Durango, you should activate it only after Durango.
// Activating this code before Durango will result in a consensus failure.
// If this is a new precompile and never deployed before Durango, you can activate it immediately by removing
// the if condition.
// We will first read the old greeting. So we should charge the gas for reading the storage.
if remainingGas, err = contract.DeductGas(remainingGas, contract.ReadGasCostPerSlot); err != nil {
return nil, 0, err
}
oldGreeting := GetGreeting(stateDB)
eventData := GreetingChangedEventData{
OldGreeting: oldGreeting,
NewGreeting: inputStruct,
}
topics, data, err := PackGreetingChangedEvent(caller, eventData)
if err != nil {
return nil, remainingGas, err
}
// Charge the gas for emitting the event.
eventGasCost := GetGreetingChangedEventGasCost(eventData)
if remainingGas, err = contract.DeductGas(remainingGas, eventGasCost); err != nil {
return nil, 0, err
}
// Emit the event
stateDB.AddLog(&types.Log{
Address: ContractAddress,
Topics: topics,
Data: data,
BlockNumber: accessibleState.GetBlockContext().Number().Uint64(),
})
// setGreeting is the execution function
// "SetGreeting(name string)" and sets the storageKey
// in the string returned by hello world
StoreGreeting(stateDB, inputStruct)
// This function does not return an output, leave this one as is
packedOutput := []byte{}
// Return the packed output and the remaining gas
return packedOutput, remainingGas, nil
}
```
```go title="precompile/helloworld/contract.go"
func setGreeting(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) {
if remainingGas, err = contract.DeductGas(suppliedGas, SetGreetingGasCost); err != nil {
return nil, 0, err
}
if readOnly {
return nil, remainingGas, vmerrs.ErrWriteProtection
}
// do not use strict mode after Durango
useStrictMode := !contract.IsDurangoActivated(accessibleState)
// attempts to unpack [input] into the arguments to the SetGreetingInput.
// Assumes that [input] does not include selector
// You can use unpacked [inputStruct] variable in your code
inputStruct, err := UnpackSetGreetingInput(input, useStrictMode)
if err != nil {
return nil, remainingGas, err
}
// Allow list is enabled and SetGreeting is a state-changer function.
// This part of the code restricts the function to be called only by enabled/admin addresses in the allow list.
// You can modify/delete this code if you don't want this function to be restricted by the allow list.
stateDB := accessibleState.GetStateDB()
// Verify that the caller is in the allow list and therefore has the right to call this function.
callerStatus := allowlist.GetAllowListStatus(stateDB, ContractAddress, caller)
if !callerStatus.IsEnabled() {
return nil, remainingGas, fmt.Errorf("%w: %s", ErrCannotSetGreeting, caller)
}
// allow list code ends here.
// CUSTOM CODE STARTS HERE
// With Durango, you can emit an event in your state-changing precompile functions.
// Note: If you have been using the precompile before Durango, you should activate it only after Durango.
// Activating this code before Durango will result in a consensus failure.
// If this is a new precompile and never deployed before Durango, you can activate it immediately by removing
// the if condition.
// We will first read the old greeting. So we should charge the gas for reading the storage.
if remainingGas, err = contract.DeductGas(remainingGas, contract.ReadGasCostPerSlot); err != nil {
return nil, 0, err
}
oldGreeting := GetGreeting(stateDB)
eventData := GreetingChangedEventData{
OldGreeting: oldGreeting,
NewGreeting: inputStruct,
}
topics, data, err := PackGreetingChangedEvent(caller, eventData)
if err != nil {
return nil, remainingGas, err
}
// Charge the gas for emitting the event.
eventGasCost := GetGreetingChangedEventGasCost(eventData)
if remainingGas, err = contract.DeductGas(remainingGas, eventGasCost); err != nil {
return nil, 0, err
}
// Emit the event
stateDB.AddLog(&types.Log{
Address: ContractAddress,
Topics: topics,
Data: data,
BlockNumber: accessibleState.GetBlockContext().Number().Uint64(),
})
// setGreeting is the execution function
// "SetGreeting(name string)" and sets the storageKey
// in the string returned by hello world
StoreGreeting(stateDB, inputStruct)
// This function does not return an output, leave this one as is
packedOutput := []byte{}
// Return the packed output and the remaining gas
return packedOutput, remainingGas, nil
}
```
Precompile events introduced with Durango. In this example we assumed that the `HelloWorld` precompile contract has been deployed before Durango.
If this is a new precompile and it will be deployed after Durango, you can activate it immediately by removing the Durango if condition (`contract.IsDurangoActivated(accessibleState)`).
### Setting Gas Costs
Setting gas costs for functions is very important and should be done carefully. If the gas costs are set too low, then functions can be abused and can cause DoS attacks. If the gas costs are set too high, then the contract will be too expensive to run.
Subnet-EVM has some predefined gas costs for write and read operations in [`precompile/contract/utils.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contract/utils.go#L19-L20). In order to provide a baseline for gas costs, we have set the following gas costs.
```go title="precompile/contract/utils.go"
// Gas costs for stateful precompiles
const (
WriteGasCostPerSlot = 20_000
ReadGasCostPerSlot = 5_000
)
```
- `WriteGasCostPerSlot` is the cost of one write such as modifying a state storage slot.
- `ReadGasCostPerSlot` is the cost of reading a state storage slot.
This should be in your gas cost estimations based on how many times the precompile function does a read or a write. For example, if the precompile modifies the state slot of its precompile address twice then the gas cost for that function would be `40_000`. However, if the precompile does additional operations and requires more computational power, then you should increase the gas costs accordingly.
On top of these gas costs, we also have to account for the gas costs of AllowList gas costs. These are the gas costs of reading and writing permissions for addresses in AllowList. These are defined under Subnet-EVM's [`precompile/allowlist/allowlist.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/allowlist/allowlist.go#L28-L29).
By default, these are added to the default gas costs of the state-change functions (SetGreeting) of the precompile. Meaning that these functions will cost an additional `ReadAllowListGasCost` in order to read permissions from the storage. If you don't plan to read permissions from the storage then you can omit these.
Now going back to our `/helloworld/contract.go`, we can modify our precompile function gas costs. Please search (`CTRL F`) `SET A GAS COST HERE` to locate the default gas cost code.
```go title="helloworld/contract.go"
SayHelloGasCost uint64 = 0 // SET A GAS COST HERE
SetGreetingGasCost uint64 = 0 + allowlist.ReadAllowListGasCost // SET A GAS COST HERE
```
We get and set our greeting with `sayHello()` and `setGreeting()` in one slot respectively so we can define the gas costs as follows. We also read permissions from the AllowList in `setGreeting()` so we keep `allowlist.ReadAllowListGasCost`.
```go title="helloworld/contract.go"
SayHelloGasCost uint64 = contract.ReadGasCostPerSlot
SetGreetingGasCost uint64 = contract.WriteGasCostPerSlot + allowlist.ReadAllowListGasCost
```
## Registering Your Precompile
We should register our precompile package to the Subnet-EVM to be discovered by other packages. Our `Module` file contains an `init()` function that registers our precompile. `init()` is called when the package is imported. We should register our precompile in a common package so that it can be imported by other packages.
For Subnet-EVM we have a precompile registry under [`/precompile/registry/registry.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/registry/registry.go). This registry force-imports precompiles from other packages, for example:
```go title="precompile/registry/registry.go"
// Force imports of each precompile to ensure each precompile's init function runs and registers itself
// with the registry.
import (
_ "github.com/ava-labs/subnet-evm/precompile/contracts/deployerallowlist"
_ "github.com/ava-labs/subnet-evm/precompile/contracts/nativeminter"
_ "github.com/ava-labs/subnet-evm/precompile/contracts/txallowlist"
_ "github.com/ava-labs/subnet-evm/precompile/contracts/feemanager"
_ "github.com/ava-labs/subnet-evm/precompile/contracts/rewardmanager"
_ "github.com/ava-labs/subnet-evm/precompile/contracts/helloworld"
// ADD YOUR PRECOMPILE HERE
// _ "github.com/ava-labs/subnet-evm/precompile/contracts/yourprecompile"
)
```
The registry itself also force-imported by the [\`/plugin/evm/vm.go](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/plugin/evm/vm.go#L50). This ensures that the registry is imported and the precompiles are registered.
For Precompile-EVM there is a `plugin/main.go` file in Precompile-EVM that orchestrates this precompile registration.
```go title="plugin/main.go"
// (c) 2019-2023, Ava Labs, Inc. All rights reserved.
// See the file LICENSE for licensing terms.
package main
import (
"fmt"
"github.com/ava-labs/avalanchego/version"
"github.com/ava-labs/subnet-evm/plugin/evm"
"github.com/ava-labs/subnet-evm/plugin/runner"
// Each precompile generated by the precompilegen tool has a self-registering init function
// that registers the precompile with the subnet-evm. Importing the precompile package here
// will cause the precompile to be registered with the subnet-evm.
_ "github.com/ava-labs/precompile-evm/helloworld"
// ADD YOUR PRECOMPILE HERE
//_ "github.com/ava-labs/precompile-evm/{yourprecompilepkg}"
)
```
# Writing Test Cases (/docs/avalanche-l1s/custom-precompiles/defining-test-cases)
---
title: Writing Test Cases
description: In this section, we will go over the different ways we can write test cases for our stateful precompile.
---
## Adding Config Tests
Precompile generation tool generates skeletons for unit tests as well. Generated config tests will be under [`./precompile/contracts/helloworld/config_test.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/config_test.go) for Subnet-EVM and [`./helloworld/config_test.go`](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/config_test.go) for Precompile-EVM. There are mainly two functions we need to test: `Verify` and `Equal`. `Verify` checks if the precompile is configured correctly. `Equal` checks if the precompile is equal to another precompile. Generated `Verify` tests contain a valid case.
You can add more invalid cases depending on your implementation. `Equal` tests generate some invalid cases to test different timestamps, types, and AllowList cases. You can check each `config_test.go` files for other precompiles under the Subnet-EVM's [`./precompile/contracts`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/) directory for more examples.
## Adding Contract Tests
The tool also generates contract tests to make sure our precompile is working correctly. Generated tests include cases to test allow list capabilities, gas costs, and calling functions in read-only mode. You can check other `contract_test.go` files in the `/precompile/contracts`. Hello World contract tests will be under [`./precompile/contracts/helloworld/contract_test.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/contract_test.go) for Subnet-EVM and [`./helloworld/contract_test.go`](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/contract_test.go) for Precompile-EVM.
We will also add more test to cover functionalities of `sayHello()` and `setGreeting()`. Contract tests are defined in a standard structure that each test can customize to their needs. The test structure is as follows:
```go
// PrecompileTest is a test case for a precompile
type PrecompileTest struct {
// Caller is the address of the precompile caller
Caller common.Address
// Input the raw input bytes to the precompile
Input []byte
// InputFn is a function that returns the raw input bytes to the precompile
// If specified, Input will be ignored.
InputFn func(t *testing.T) []byte
// SuppliedGas is the amount of gas supplied to the precompile
SuppliedGas uint64
// ReadOnly is whether the precompile should be called in read only
// mode. If true, the precompile should not modify the state.
ReadOnly bool
// Config is the config to use for the precompile
// It should be the same precompile config that is used in the
// precompile's configurator.
// If nil, Configure will not be called.
Config precompileconfig.Config
// BeforeHook is called before the precompile is called.
BeforeHook func(t *testing.T, state contract.StateDB)
// AfterHook is called after the precompile is called.
AfterHook func(t *testing.T, state contract.StateDB)
// ExpectedRes is the expected raw byte result returned by the precompile
ExpectedRes []byte
// ExpectedErr is the expected error returned by the precompile
ExpectedErr string
// BlockNumber is the block number to use for the precompile's block context
BlockNumber int64
}
```
Each test can populate the fields of the `PrecompileTest` struct to customize the test. This test uses an AllowList helper function `allowlist.RunPrecompileWithAllowListTests(t, Module, state.NewTestStateDB, tests)` which can run all specified tests plus AllowList test suites. If you don't plan to use AllowList, you can directly run them as follows:
```go
for name, test := range tests {
t.Run(name, func(t *testing.T) {
test.Run(t, module, newStateDB(t))
})
}
```
## Adding VM Tests (Optional)
This is only applicable for direct Subnet-EVM forks as test files are not directly exported in Golang. If you use Precompile-EVM you can skip this step.
VM tests are tests that run the precompile by calling it through the Subnet-EVM. These are the most comprehensive tests that we can run. If your precompile modifies how the Subnet-EVM works, for example changing blockchain rules, you should add a VM test. For example, you can take a look at the `TestRewardManagerPrecompileSetRewardAddress` function in [here](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/plugin/evm/vm_test.go#L2772).
For this Hello World example, we don't modify any Subnet-EVM rules, so we don't need to add any VM tests.
## Adding Solidity Test Contracts
Let's add our test contract to `./contracts/contracts`. This smart contract lets us interact with our precompile! We cast the `HelloWorld` precompile address to the `IHelloWorld` interface. In doing so, `helloWorld` is now a contract of type `IHelloWorld` and when we call any functions on that contract, we will be redirected to the HelloWorld precompile address.
The below code snippet can be copied and pasted into a new file called `ExampleHelloWorld.sol`:
```go
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.0;
import "./IHelloWorld.sol";
// ExampleHelloWorld shows how the HelloWorld precompile can be used in a smart contract.
contract ExampleHelloWorld {
address constant HELLO_WORLD_ADDRESS =
0x0300000000000000000000000000000000000000;
IHelloWorld helloWorld = IHelloWorld(HELLO_WORLD_ADDRESS);
function sayHello() public view returns (string memory) {
return helloWorld.sayHello();
}
function setGreeting(string calldata greeting) public {
helloWorld.setGreeting(greeting);
}
}
```
Hello World Precompile is a different contract than ExampleHelloWorld and has a different address. Since the precompile uses AllowList for a permissioned access, any call to the precompile including from ExampleHelloWorld will be denied unless the caller is added to the AllowList.
Please note that this contract is simply a wrapper and is calling the precompile functions. The reason why we add another example smart contract is to have a simpler stateless tests.
For the test contract we write our test in `./contracts/test/ExampleHelloWorldTest.sol`.
```solidity
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.0;
import "../ExampleHelloWorld.sol";
import "../interfaces/IHelloWorld.sol";
import "./AllowListTest.sol";
contract ExampleHelloWorldTest is AllowListTest {
IHelloWorld helloWorld = IHelloWorld(HELLO_WORLD_ADDRESS);
function step_getDefaultHelloWorld() public {
ExampleHelloWorld example = new ExampleHelloWorld();
address exampleAddress = address(example);
assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None);
assertEq(example.sayHello(), "Hello World!");
}
function step_doesNotSetGreetingBeforeEnabled() public {
ExampleHelloWorld example = new ExampleHelloWorld();
address exampleAddress = address(example);
assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None);
try example.setGreeting("testing") {
assertTrue(false, "setGreeting should fail");
} catch {}
}
function step_setAndGetGreeting() public {
ExampleHelloWorld example = new ExampleHelloWorld();
address exampleAddress = address(example);
assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None);
helloWorld.setEnabled(exampleAddress);
assertRole(
helloWorld.readAllowList(exampleAddress),
AllowList.Role.Enabled
);
string memory greeting = "testgreeting";
example.setGreeting(greeting);
assertEq(example.sayHello(), greeting);
}
}
```
For Precompile-EVM, you should import AllowListTest with `@avalabs/subnet-evm-contracts` NPM package:
```solidity
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.0;
import "../ExampleHelloWorld.sol";
import "../interfaces/IHelloWorld.sol";
import "@avalabs/subnet-evm-contracts/contracts/test/AllowListTest.sol";
contract ExampleHelloWorldTest is AllowListTest {
IHelloWorld helloWorld = IHelloWorld(HELLO_WORLD_ADDRESS);
function step_getDefaultHelloWorld() public {
ExampleHelloWorld example = new ExampleHelloWorld();
address exampleAddress = address(example);
assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None);
assertEq(example.sayHello(), "Hello World!");
}
function step_doesNotSetGreetingBeforeEnabled() public {
ExampleHelloWorld example = new ExampleHelloWorld();
address exampleAddress = address(example);
assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None);
try example.setGreeting("testing") {
assertTrue(false, "setGreeting should fail");
} catch {}
}
function step_setAndGetGreeting() public {
ExampleHelloWorld example = new ExampleHelloWorld();
address exampleAddress = address(example);
assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None);
helloWorld.setEnabled(exampleAddress);
assertRole(
helloWorld.readAllowList(exampleAddress),
AllowList.Role.Enabled
);
string memory greeting = "testgreeting";
example.setGreeting(greeting);
assertEq(example.sayHello(), greeting);
}
}
```
## Adding DS-Test Case
We can now trigger this test contract via `hardhat` tests. The test script uses Subnet-EVM's `test` framework test in `./contracts/test`. You can find more information about the test framework [here](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/contracts/test/utils.ts). We also can test the events emitted by the precompile. The test script looks like this:
The test script looks like this:
```go
// (c) 2019-2022, Ava Labs, Inc. All rights reserved.
// See the file LICENSE for licensing terms.
import { expect } from "chai";
import { SignerWithAddress } from "@nomiclabs/hardhat-ethers/signers";
import { Contract } from "ethers";
import { ethers } from "hardhat";
import { test } from "./utils";
// make sure this is always an admin for hello world precompile
const ADMIN_ADDRESS = "0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC";
const HELLO_WORLD_ADDRESS = "0x0300000000000000000000000000000000000000";
describe("ExampleHelloWorldTest", function () {
this.timeout("30s");
beforeEach("Setup DS-Test contract", async function () {
const signer = await ethers.getSigner(ADMIN_ADDRESS);
const helloWorldPromise = ethers.getContractAt(
"IHelloWorld",
HELLO_WORLD_ADDRESS,
signer
);
return ethers
.getContractFactory("ExampleHelloWorldTest", { signer })
.then((factory) => factory.deploy())
.then((contract) => {
this.testContract = contract;
return contract.deployed().then(() => contract);
})
.then(() => Promise.all([helloWorldPromise]))
.then(([helloWorld]) => helloWorld.setAdmin(this.testContract.address))
.then((tx) => tx.wait());
});
test("should gets default hello world", ["step_getDefaultHelloWorld"]);
test(
"should not set greeting before enabled",
"step_doesNotSetGreetingBeforeEnabled"
);
test(
"should set and get greeting with enabled account",
"step_setAndGetGreeting"
);
});
describe("IHelloWorld events", function () {
let owner: SignerWithAddress;
let contract: Contract;
let defaultGreeting = "Hello, World!";
before(async function () {
owner = await ethers.getSigner(ADMIN_ADDRESS);
contract = await ethers.getContractAt(
"IHelloWorld",
HELLO_WORLD_ADDRESS,
owner
);
// reset greeting
let tx = await contract.setGreeting(defaultGreeting);
await tx.wait();
});
it("should emit GreetingChanged event", async function () {
let newGreeting = "helloprecompile";
await expect(contract.setGreeting(newGreeting))
.to.emit(contract, "GreetingChanged")
.withArgs(
owner.address,
// old greeting
defaultGreeting,
// new greeting
newGreeting
);
});
});
```
The test script looks like this:
```go
// (c) 2019-2022, Ava Labs, Inc. All rights reserved.
// See the file LICENSE for licensing terms.
import { expect } from "chai";
import { SignerWithAddress } from "@nomiclabs/hardhat-ethers/signers";
import { Contract } from "ethers";
import { ethers } from "hardhat";
import { test } from "@avalabs/subnet-evm-contracts";
// make sure this is always an admin for hello world precompile
const ADMIN_ADDRESS = "0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC";
const HELLO_WORLD_ADDRESS = "0x0300000000000000000000000000000000000000";
describe("ExampleHelloWorldTest", function () {
this.timeout("30s");
beforeEach("Setup DS-Test contract", async function () {
const signer = await ethers.getSigner(ADMIN_ADDRESS);
const helloWorldPromise = ethers.getContractAt(
"IHelloWorld",
HELLO_WORLD_ADDRESS,
signer
);
return ethers
.getContractFactory("ExampleHelloWorldTest", { signer })
.then((factory) => factory.deploy())
.then((contract) => {
this.testContract = contract;
return contract.deployed().then(() => contract);
})
.then(() => Promise.all([helloWorldPromise]))
.then(([helloWorld]) => helloWorld.setAdmin(this.testContract.address))
.then((tx) => tx.wait());
});
test("should gets default hello world", ["step_getDefaultHelloWorld"]);
test(
"should not set greeting before enabled",
"step_doesNotSetGreetingBeforeEnabled"
);
test(
"should set and get greeting with enabled account",
"step_setAndGetGreeting"
);
});
describe("IHelloWorld events", function () {
let owner: SignerWithAddress;
let contract: Contract;
let defaultGreeting = "Hello, World!";
before(async function () {
owner = await ethers.getSigner(ADMIN_ADDRESS);
contract = await ethers.getContractAt(
"IHelloWorld",
HELLO_WORLD_ADDRESS,
owner
);
// reset greeting
let tx = await contract.setGreeting(defaultGreeting);
await tx.wait();
});
it("should emit GreetingChanged event", async function () {
let newGreeting = "helloprecompile";
await expect(contract.setGreeting(newGreeting))
.to.emit(contract, "GreetingChanged")
.withArgs(
owner.address,
// old greeting
defaultGreeting,
// new greeting
newGreeting
);
});
});
```
# Executing Test Cases (/docs/avalanche-l1s/custom-precompiles/executing-test-cases)
---
title: Executing Test Cases
description: In this section, we will go over how to be able to execute the test cases you wrote in the last section.
---
## Adding the Test Genesis File
To run our e2e contract tests, we will need to create an Avalanche L1 that has the `Hello World` precompile activated, so we will copy and paste the below genesis file into: `/tests/precompile/genesis/hello_world.json`.
Note: it's important that this has the same name as the HardHat test file we created previously.
```json
{
"config": {
"chainId": 99999,
"homesteadBlock": 0,
"eip150Block": 0,
"eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0",
"eip155Block": 0,
"eip158Block": 0,
"byzantiumBlock": 0,
"constantinopleBlock": 0,
"petersburgBlock": 0,
"istanbulBlock": 0,
"muirGlacierBlock": 0,
"feeConfig": {
"gasLimit": 20000000,
"minBaseFee": 1000000000,
"targetGas": 100000000,
"baseFeeChangeDenominator": 48,
"minBlockGasCost": 0,
"maxBlockGasCost": 10000000,
"targetBlockRate": 2,
"blockGasCostStep": 500000
},
"helloWorldConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
},
"alloc": {
"8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": {
"balance": "0x52B7D2DCC80CD2E4000000"
},
"0x0Fa8EA536Be85F32724D57A37758761B86416123": {
"balance": "0x52B7D2DCC80CD2E4000000"
}
},
"nonce": "0x0",
"timestamp": "0x66321C34",
"extraData": "0x00",
"gasLimit": "0x1312D00",
"difficulty": "0x0",
"mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000",
"coinbase": "0x0000000000000000000000000000000000000000",
"number": "0x0",
"gasUsed": "0x0",
"parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000"
}
```
Adding this to our genesis enables our HelloWorld precompile at the genesis block (0th block), with `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` as the admin address.
```json
{
"helloWorldConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
```
## Declaring the HardHat E2E Test
Now that we have declared the HardHat test and corresponding `genesis.json` file. The last step to running the e2e test is to declare the new test in `/tests/precompile/solidity/suites.go`.
At the bottom of the file you will see the following code commented out:
```go title="suites.go"
// ADD YOUR PRECOMPILE HERE
/*
ginkgo.It("your precompile", ginkgo.Label("Precompile"), ginkgo.Label("YourPrecompile"), func() {
ctx, cancel := context.WithTimeout(context.Background(), time.Minute)
defer cancel()
// Specify the name shared by the genesis file in ./tests/precompile/genesis/{your_precompile}.json
// and the test file in ./contracts/tests/{your_precompile}.ts
blockchainID := subnetsSuite.GetBlockchainID("{your_precompile}")
runDefaultHardhatTests(ctx, blockchainID, "{your_precompile}")
*/
```
`runDefaultHardhatTests` will run the default Hardhat test command and use the default genesis path. If you want to use a different test command and genesis path than the defaults, you can use the `utils.CreateSubnet` and `utils.RunTestCMD`. See how they were used with default params [here](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/tests/utils/subnet.go#L113)
You should copy and paste the ginkgo `It` node and update from `{your_precompile}` to `hello_world`. The string passed in to `utils.RunDefaultHardhatTests(ctx, "your_precompile")` will be used to find both the HardHat test file to execute and the genesis file, which is why you need to use the same name for both.
After modifying the `It` node, it should look like the following (you can copy and paste this directly if you prefer):
```go
ginkgo.It("hello world", ginkgo.Label("Precompile"), ginkgo.Label("HelloWorld"), func() {
ctx, cancel := context.WithTimeout(context.Background(), time.Minute)
defer cancel()
blockchainID := subnetsSuite.GetBlockchainID("hello_world")
runDefaultHardhatTests(ctx, blockchainID, "hello_world")
})
```
Now that we've set up the new ginkgo test, we can run the ginkgo test that we want by using the `GINKGO_LABEL_FILTER`. This environment variable is passed as a flag to Ginkgo in `./scripts/run_ginkgo.sh` and restricts what tests will run to only the tests with a matching label.
## Running E2E Tests
Before we start testing, we will need to build the AvalancheGo binary and the custom Subnet-EVM binary.
Precompile-EVM bundles Subnet-EVM and runs it under the hood in the [`plugins/main.go`](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/plugin/main.go#L24). Meaning that Precompile-EVM binary works the same way as Subnet-EVM binary. Precompile-EVM repo has also same scripts and the build process as Subnet-EVM. Following steps also apply to Precompile-EVM.
You should have cloned [AvalancheGo](https://github.com/ava-labs/avalanchego) within your `$GOPATH` in the [Background and Requirements](/docs/avalanche-l1s/custom-precompiles/background-requirements) section, so you can build AvalancheGo with the following command:
```bash
cd $GOPATH/src/github.com/ava-labs/avalanchego
./scripts/build.sh
```
Once you've built AvalancheGo, you can confirm that it was successful by printing the version:
```bash
./build/avalanchego --version
```
This should print something like the following (if you are running AvalancheGo v1.9.7):
```bash
avalanchego/1.11.0 [database=v1.4.5, rpcchainvm=33, commit=c60f7d2dd10c87f57382885b59d6fb2c763eded7, go=1.21.7]
```
This path will be used later as the environment variable `AVALANCHEGO_EXEC_PATH` in the network runner.
Please note that the RPCChainVM version of AvalancheGo and Subnet-EVM must match.
Once we've built AvalancheGo, we can navigate back to the repo and build the binary:
```bash
cd $GOPATH/src/github.com/ava-labs/subnet-evm
./scripts/build.sh
```
This will build the Subnet-EVM binary and place it in AvalancheGo's `build/plugins` directory by default at the file path: `$GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy`
To confirm that the Subnet-EVM binary is compatible with AvalancheGo, you can run the same version command and confirm the RPCChainVM version matches:
```bash
$GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy --version
```
This should give similar output:
```bash
Subnet-EVM/v0.6.1 [AvalancheGo=v1.11.1, rpcchainvm=33]
```
```bash
cd $GOPATH/src/github.com/ava-labs/precompile-evm
./scripts/build.sh
```
This will build the Precompile-EVM binary and place it in AvalancheGo's `build/plugins` directory by default at the file path: `$GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy`
To confirm that the Precompile-EVM binary is compatible with AvalancheGo, you can run the same version command and confirm the RPCChainVM version matches:
```bash
$GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy --version
```
This should give similar output:
```bash
Precompile-EVM/v0.2.0 Subnet-EVM/v0.6.1 [AvalancheGo=v1.11.1, rpcchainvm=33]
```
If the RPCChainVM Protocol version printed out does not match the one used in AvalancheGo then Subnet-EVM will not be able to talk to AvalancheGo and the blockchain will not start. You can find the compatibility table for AvalancheGo and Subnet-EVM [here](https://github.com/ava-labs/subnet-evm#avalanchego-compatibility).
The `build/plugins` directory will later be used as the `AVALANCHEGO_PLUGIN_PATH`.
### Running Ginkgo Tests
To run ONLY the HelloWorld precompile test, run the command:
```bash
cd $GOPATH/src/github.com/ava-labs/subnet-evm
```
```bash
cd $GOPATH/src/github.com/ava-labs/precompile-evm
```
use `GINKGO_LABEL_FILTER` env var to filter the test:
```bash
GINKGO_LABEL_FILTER=HelloWorld ./scripts/run_ginkgo.sh
```
You will first see the node starting up in the `BeforeSuite` section of the precompile test:
```bash
GINKGO_LABEL_FILTER=HelloWorld ./scripts/run_ginkgo.sh
# output
Using branch: hello-world-tutorial-walkthrough
building precompile.test
# github.com/ava-labs/subnet-evm/tests/precompile.test
ld: warning: could not create compact unwind for _blst_sha256_block_data_order: does not use RBP or RSP based frame
Compiled precompile.test
# github.com/ava-labs/subnet-evm/tests/load.test
ld: warning: could not create compact unwind for _blst_sha256_block_data_order: does not use RBP or RSP based frame
Compiled load.test
Running Suite: subnet-evm precompile ginkgo test suite - /Users/avalabs/go/src/github.com/ava-labs/subnet-evm
===================================================================================================================
Random Seed: 1674833631
Will run 1 of 7 specs
------------------------------
[BeforeSuite]
/Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/precompile_test.go:31
> Enter [BeforeSuite] TOP-LEVEL - /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/precompile_test.go:31 @ 01/27/23 10:33:51.001
INFO [01-27|10:33:51.002] Starting AvalancheGo node wd=/Users/avalabs/go/src/github.com/ava-labs/subnet-evm
INFO [01-27|10:33:51.002] Executing cmd="./scripts/run.sh "
[streaming output] Using branch: hello-world-tutorial-walkthrough
...
[BeforeSuite] PASSED [15.002 seconds]
```
After the `BeforeSuite` completes successfully, it will skip all but the `HelloWorld` labeled precompile test:
```bash
S [SKIPPED]
[Precompiles]
/Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/solidity/suites.go:26
contract native minter [Precompile, ContractNativeMinter]
/Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/solidity/suites.go:29
------------------------------
S [SKIPPED]
[Precompiles]
/Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/solidity/suites.go:26
tx allow list [Precompile, TxAllowList]
/Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/solidity/suites.go:36
------------------------------
...
Combined output:
Compiling 2 files with 0.8.0
Compilation finished successfully
ExampleHelloWorldTest
✓ should gets default hello world (4057ms)
✓ should not set greeting before enabled (4067ms)
✓ should set and get greeting with enabled account (4074ms)
3 passing (33s)
< Exit [It] hello world - /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/solidity/suites.go:64 @ 01/27/23 10:34:17.484 (11.48s)
• [11.480 seconds]
------------------------------
```
Finally, you will see the load test being skipped as well:
```bash
Running Suite: subnet-evm small load simulator test suite - /Users/avalabs/go/src/github.com/ava-labs/subnet-evm
======================================================================================================================
Random Seed: 1674833658
Will run 0 of 1 specs
S [SKIPPED]
[Load Simulator]
/Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/load/load_test.go:49
basic subnet load test [load]
/Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/load/load_test.go:50
------------------------------
Ran 0 of 1 Specs in 0.000 seconds
SUCCESS! -- 0 Passed | 0 Failed | 0 Pending | 1 Skipped
PASS
```
Looks like the tests are passing!
If your tests failed, please retrace your steps. Most likely the error is that the precompile was not enabled and some code is missing. Try running `npm install` in the contracts directory to ensure that hardhat and other packages are installed.
You may also use the [official tutorial implementation](https://github.com/ava-labs/subnet-evm/tree/helloworld-official-tutorial-v2) to double-check your work as well.
# Custom Precompiles (/docs/avalanche-l1s/custom-precompiles)
---
title: Custom Precompiles
description: In this tutorial, we are going to walk through how we can generate a stateful precompile from scratch. Before we start, let's brush up on what a precompile is, what a stateful precompile is, and why this is extremely useful.
---
## Background
### Precompiled Contracts
Ethereum uses precompiles to efficiently implement cryptographic primitives within the EVM instead of re-implementing the same primitives in Solidity. The following precompiles are currently included: ecrecover, sha256, blake2f, ripemd-160, Bn256Add, Bn256Mul, Bn256Pairing, the identity function, and modular exponentiation.
We can see these [precompile](https://github.com/ethereum/go-ethereum/blob/v1.11.1/core/vm/contracts.go#L82) mappings from address to function here in the Ethereum VM:
```go
// PrecompiledContractsBerlin contains the default set of pre-compiled Ethereum
// contracts used in the Berlin release.
var PrecompiledContractsBerlin = map[common.Address]PrecompiledContract{
common.BytesToAddress([]byte{1}): &ecrecover{},
common.BytesToAddress([]byte{2}): &sha256hash{},
common.BytesToAddress([]byte{3}): &ripemd160hash{},
common.BytesToAddress([]byte{4}): &dataCopy{},
common.BytesToAddress([]byte{5}): &bigModExp{eip2565: true},
common.BytesToAddress([]byte{6}): &bn256AddIstanbul{},
common.BytesToAddress([]byte{7}): &bn256ScalarMulIstanbul{},
common.BytesToAddress([]byte{8}): &bn256PairingIstanbul{},
common.BytesToAddress([]byte{9}): &blake2F{},
}
```
These precompile addresses start from `0x0000000000000000000000000000000000000001` and increment by 1.
A [precompile](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/contracts.go#L54-L57) follows this interface:
```go
// PrecompiledContract is the basic interface for native Go contracts. The implementation
// requires a deterministic gas count based on the input size of the Run method of the
// contract.
type PrecompiledContract interface {
RequiredGas(input []byte) uint64 // RequiredPrice calculates the contract gas use
Run(input []byte) ([]byte, error) // Run runs the precompiled contract
}
```
Here is an example of the [sha256 precompile](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/contracts.go#L237-L250) function.
```go
type sha256hash struct{}
// RequiredGas returns the gas required to execute the pre-compiled contract.
//
// This method does not require any overflow checking as the input size gas costs
// required for anything significant is so high it's impossible to pay for.
func (c *sha256hash) RequiredGas(input []byte) uint64 {
return uint64(len(input)+31)/32*params.Sha256PerWordGas + params.Sha256BaseGas
}
func (c *sha256hash) Run(input []byte) ([]byte, error) {
h := sha256.Sum256(input)
return h[:], nil
}
```
The CALL opcode (CALL, STATICCALL, DELEGATECALL, and CALLCODE) allows us to invoke this precompile.
The function signature of CALL in the EVM is as follows:
```go
Call(
caller ContractRef,
addr common.Address,
input []byte,
gas uint64,
value *big.Int,
)(ret []byte, leftOverGas uint64, err error)
```
Precompiles are a shortcut to execute a function implemented by the EVM itself, rather than an actual contract. A precompile is associated with a fixed address defined in the EVM. There is no byte code associated with that address.
When a precompile is called, the EVM checks if the input address is a precompile address, and if so it executes the precompile. Otherwise, it loads the smart contract at the input address and runs it on the EVM interpreter with the specified input data.
### Stateful Precompiled Contracts
A stateful precompile builds on a precompile in that it adds state access. Stateful precompiles are not available in the default EVM, and are specific to Avalanche EVMs such as [Coreth](https://github.com/ava-labs/avalanchego/tree/master/graft/coreth) and [Subnet-EVM](https://github.com/ava-labs/subnet-evm).
A stateful precompile follows this [interface](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contract/interfaces.go#L17-L20):
```go
// StatefulPrecompiledContract is the interface for executing a precompiled contract
type StatefulPrecompiledContract interface {
// Run executes the precompiled contract.
Run(accessibleState PrecompileAccessibleState,
caller common.Address,
addr common.Address,
input []byte,
suppliedGas uint64,
readOnly bool)
(ret []byte, remainingGas uint64, err error)
}
```
A stateful precompile injects state access through the `PrecompileAccessibleState` interface to provide access to the EVM state including the ability to modify balances and read/write storage.
This way we can provide even more customization of the EVM through Stateful Precompiles than we can with the original precompile interface!
### AllowList
The AllowList enables a precompile to enforce permissions on addresses. The AllowList is not a contract itself, but a helper structure to provide a control mechanism for wrapping contracts. It provides an `AllowListConfig` to the precompile so that it can take an initial configuration from genesis/upgrade. It also provides functions to set/read the permissions. In this tutorial, we used `IAllowList` interface to provide permission control to the `HelloWorld` precompile. `IAllowList` is defined in Subnet-EVM under [`./contracts/contracts/interfaces/IAllowList.sol`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/contracts/contracts/interfaces/IAllowList.sol). The interface is as follows:
```go
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.0;
interface IAllowList {
event RoleSet(
uint256 indexed role,
address indexed account,
address indexed sender,
uint256 oldRole
);
// Set [addr] to have the admin role over the precompile contract.
function setAdmin(address addr) external;
// Set [addr] to be enabled on the precompile contract.
function setEnabled(address addr) external;
// Set [addr] to have the manager role over the precompile contract.
function setManager(address addr) external;
// Set [addr] to have no role for the precompile contract.
function setNone(address addr) external;
// Read the status of [addr].
function readAllowList(address addr) external view returns (uint256 role);
}
```
You can find more information about the AllowList interface [here](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#allowlist-interface).
# Deploying Your Precompile (/docs/avalanche-l1s/custom-precompiles/precompile-deployment)
---
title: Deploying Your Precompile
description: Now that we have defined our precompile, let's deploy it to a local network.
---
We made it! Everything works in our Ginkgo tests, and now we want to spin up a local network with the Hello World precompile activated.
Start the server in a terminal in a new tab using avalanche-network-runner. Please check out [this link](/docs/tooling/avalanche-cli) for more information on Avalanche Network Runner, how to download it, and how to use it. The server will be in "listening" mode waiting for API calls.
We will start the server from the Subnet-EVM directory so that we can use a relative file path to the genesis JSON file:
```bash
cd $GOPATH/src/github.com/ava-labs/subnet-evm
```
```bash
cd $GOPATH/src/github.com/ava-labs/precompile-evm
```
Then run ANR:
```bash
avalanche-network-runner server \
--log-level debug \
--port=":8080" \
--grpc-gateway-port=":8081"
```
Since we already compiled AvalancheGo and Subnet-EVM/Precompile-EVM in a previous step, we should have the AvalancheGo and Subnet-EVM binaries ready to go.
We can now set the following paths. `AVALANCHEGO_EXEC_PATH` points to the latest AvalancheGo binary we have just built. `AVALANCHEGO_PLUGIN_PATH` points to the plugins path which should have the Subnet-EVM binary we have just built:
```bash
export AVALANCHEGO_EXEC_PATH="${GOPATH}/src/github.com/ava-labs/avalanchego/build/avalanchego"
export AVALANCHEGO_PLUGIN_PATH="${HOME}/.avalanchego/plugins"
```
The following command will "issue requests" to the server we just spun up. We can use avalanche-network-runner to spin up some nodes that run the latest version of Subnet-EVM:
```bash
avalanche-network-runner control start \
--log-level debug \
--endpoint="0.0.0.0:8080" \
--number-of-nodes=5 \
--avalanchego-path ${AVALANCHEGO_EXEC_PATH} \
--plugin-dir ${AVALANCHEGO_PLUGIN_PATH} \
--blockchain-specs '[{"vm_name": "subnetevm", "genesis": "./tests/precompile/genesis/hello_world.json"}]'
```
We can look at the server terminal tab and see it booting up the local network. If the network startup is successful then you should see something like this:
```bash
[blockchain RPC for "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy"] "http://127.0.0.1:9650/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU"
[blockchain RPC for "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy"] "http://127.0.0.1:9652/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU"
[blockchain RPC for "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy"] "http://127.0.0.1:9654/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU"
[blockchain RPC for "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy"] "http://127.0.0.1:9656/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU"
[blockchain RPC for "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy"] "http://127.0.0.1:9658/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU"
```
This shows the extension to the API server on AvalancheGo that's specific to the Subnet-EVM Blockchain instance. To interact with it, you will want to append the `/rpc` extension, which will supply the standard Ethereum API calls.
For example, you can use the RPC URL: `http://127.0.0.1:9650/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU/rpc`
## Maintenance
You should always keep your fork up to date with the latest changes in the official Subnet-EVM repo. If you have forked the Subnet-EVM repo, there could be conflicts and you may need to manually resolve them.
If you used Precompile-EVM, you can update your repo by bumping Subnet-EVM versions in [`go.mod`](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/go.mod#L7) and [`version.sh`](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/scripts/versions.sh#L4)
## Conclusion
We have now created a stateful precompile from scratch with the precompile generation tool. We hope you had fun and learned a little more about the Subnet-EVM. Now that you have created a simple stateful precompile, we urge you to create one of your own.
If you have an idea for a stateful precompile that may be useful to the community, feel free to create a fork of [Subnet-EVM](https://github.com/ava-labs/subnet-evm) and create a pull request.
# Webhooks API (/docs/api-reference/webhook-api)
---
title: Webhooks API
description: Real-time notifications for blockchain events on Avalanche networks
icon: Webhook
---
### What is the Webhooks API?
The Webhooks API lets you monitor real-time events on the Avalanche ecosystem, including the C-chain, L1s, and the Platform Chain (P/X chains). By subscribing to specific events, you can receive instant notifications for on-chain occurrences without continuously polling the network.
### Key Features:
* **Real-time notifications:** Receive immediate updates on specified on-chain activities without polling.
* **Customizable:** Specify the desired event type to listen for, customizing notifications based on your individual requirements.
* **Secure:** Employ shared secrets and signature-based verification to ensure that notifications originate from a trusted source.
* **Broad Coverage:**
* **C-chain:** Mainnet and testnet, covering smart contract events, NFT transfers, and wallet-to-wallet transactions.
* **Platform Chain (P and X chains):** Address and validator events, staking activities, and other platform-level transactions.
By supporting both the C-chain and the Platform Chain, you can monitor an even wider range of Avalanche activities.
### Use cases
* **NFT marketplace transactions**: Get alerts for NFT minting, transfers, auctions, bids, sales, and other interactions within NFT marketplaces.
* **Wallet notifications**: Receive alerts when an address performs actions such as sending, receiving, swapping, or burning assets.
* **DeFi activities**: Receive notifications for various DeFi activities such as liquidity provisioning, yield farming, borrowing, lending, and liquidations.
* **Staking rewards:** Get real-time notifications when a validator stakes, receives delegation, or earns staking rewards on the P-Chain, enabling seamless monitoring of validator earnings and participation.
## APIs for continuous polling vs. Webhooks for events data
The following example uses the address activity webhook topic to illustrate the difference between polling an API for wallet event data versus subscribing to a webhook topic to receive wallet events.
### Continous polling
Continuous polling is a method where your application repeatedly sends requests to an API at fixed intervals to check for new data or events. Think of it like checking your mailbox every five minutes to see if new mail has arrived, whether or not anything is there.
* You want to track new transactions for a specific wallet.
* Your application calls an API every few seconds (e.g., every 5 seconds) with a query like, “Are there any new transactions for this wallet since my last check?”
* The API responds with either new transaction data or a confirmation that nothing has changed.
**Downsides of continuous polling**
* **Inefficiency:** Your app makes requests even when no new transactions occur, wasting computational resources, bandwidth, and potentially incurring higher API costs.
For example, if no transactions happen for an hour, your app still sends hundreds of unnecessary requests.
* **Delayed updates:**
Since polling happens at set intervals, there’s a potential delay in detecting events. If a transaction occurs just after a poll, your app won’t know until the next check—up to 5 seconds later in our example.
This lag can be critical for time-sensitive applications, like trading or notifications.
* **Scalability challenges:** Monitoring one wallet might be manageable, but if you’re tracking dozens or hundreds of wallets, the number of requests multiplies quickly.
### Webhook subscription
Webhooks are an event-driven alternative where your application subscribes to specific events, and the Avalanche service notifies you instantly when those events occur. It’s like signing up for a delivery alert—when the package (event) arrives, you get a text message right away, instead of checking the tracking site repeatedly.
* Your app registers a webhook specifying an endpoint (e.g., `https://your-app.com/webhooks/transactions`) and the event type (e.g., `address_activity`).
* When a new transaction occurs we send a POST request to your endpoint with the transaction details.
* Your app receives the data only when something happens, with no need to ask repeatedly.
**Benefits of Avalanche webhooks**
* **Real-Time updates:** Notifications arrive the moment a transaction is processed, eliminating delays inherent in polling. This is ideal for applications needing immediate responses, like alerting users or triggering automated actions.
* **Efficiency:** Your app doesn’t waste resources making requests when there’s no new data. Data flows only when events occur. This reduces server load, bandwidth usage, and API call quotas.
* **Scalability:** You can subscribe to events for multiple wallets or event types (e.g., transactions, smart contract calls) without increasing the number of requests your app makes. We handle the event detection and delivery, so your app scales effortlessly as monitoring needs grow.
## Event payload structure
The Event structure always begins with the following parameters:
```json theme={null}
{
"webhookId": "6d1bd383-aa8d-47b5-b793-da6d8a115fde",
"eventType": "address_activity",
"messageId": "8e4e7284-852a-478b-b425-27631c8d22d2",
"event": {
}
}
```
**Parameters:**
* `webhookId`: Unique identifier for the webhook in your account.
* `eventType`: The event that caused the webhook to be triggered. In the future, there will be multiple types of events, for the time being only the address\_activity event is supported. The address\_activity event gets triggered whenever the specified addresses participate in a token or AVAX transaction.
* `messageId`: Unique identifier per event sent.
* `event`: Event payload. It contains details about the transaction, logs, and traces. By default logs and internal transactions are not included, if you want to include them use `"includeLogs": true`, and `"includeInternalTxs": true`.
### Address Activity webhook
The address activity webhook allows you to track any interaction with an address (any address). Here is an example of this type of event:
```json theme={null}
{
"webhookId": "263942d1-74a4-4416-aeb4-948b9b9bb7cc",
"eventType": "address_activity",
"messageId": "94df1881-5d93-49d1-a1bd-607830608de2",
"event": {
"transaction": {
"blockHash": "0xbd093536009f7dd785e9a5151d80069a93cc322f8b2df63d373865af4f6ee5be",
"blockNumber": "44568834",
"from": "0xf73166f0c75a3DF444fAbdFDC7e5EE4a73fA51C7",
"gas": "651108",
"gasPrice": "31466275484",
"maxFeePerGas": "31466275484",
"maxPriorityFeePerGas": "31466275484",
"txHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4",
"txStatus": "1",
"input": "0xb80c2f090000000000000000000000000000000000000000000000000000000000000000000000000000000000000000eeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeee000000000000000000000000b97ef9ef8734c71904d8002f8b6bc66dd9c48a6e000000000000000000000000000000000000000000000000006ca0c737b131f2000000000000000000000000000000000000000000000000000000000011554e000000000000000000000000000000000000000000000000000000006627dadc0000000000000000000000000000000000000000000000000000000000000120000000000000000000000000000000000000000000000000000000000000016000000000000000000000000000000000000000000000000000000000000004600000000000000000000000000000000000000000000000000000000000000001000000000000000000000000000000000000000000000000006ca0c737b131f2000000000000000000000000000000000000000000000000000000000000000100000000000000000000000000000000000000000000000000000000000000200000000000000000000000000000000000000000000000000000000000000001000000000000000000000000000000000000000000000000000000000000002000000000000000000000000000000000000000000000000000000000000000a000000000000000000000000000000000000000000000000000000000000000e000000000000000000000000000000000000000000000000000000000000001200000000000000000000000000000000000000000000000000000000000000160000000000000000000000000b31f66aa3c1e785363f0875a1b74e27b85fd66c70000000000000000000000000000000000000000000000000000000000000001000000000000000000000000be882fb094143b59dc5335d32cecb711570ebdd40000000000000000000000000000000000000000000000000000000000000001000000000000000000000000be882fb094143b59dc5335d32cecb711570ebdd400000000000000000000000000000000000000000000000000000000000000010000000000000000000027100e663593657b064e1bae76d28625df5d0ebd44210000000000000000000000000000000000000000000000000000000000000001000000000000000000000000000000000000000000000000000000000000002000000000000000000000000000000000000000000000000000000000000000c0000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000400000000000000000000000000000000000000000000000000000000000000060000000000000000000000000b31f66aa3c1e785363f0875a1b74e27b85fd66c7000000000000000000000000b97ef9ef8734c71904d8002f8b6bc66dd9c48a6e0000000000000000000000000000000000000000000000000000000000000bb80000000000000000000000000000000000000000000000000000000000000000",
"nonce": "4",
"to": "0x1dac23e41fc8ce857e86fd8c1ae5b6121c67d96d",
"transactionIndex": 0,
"value": "30576074978046450",
"type": 0,
"chainId": "43114",
"receiptCumulativeGasUsed": "212125",
"receiptGasUsed": "212125",
"receiptEffectiveGasPrice": "31466275484",
"receiptRoot": "0xf355b81f3e76392e1b4926429d6abf8ec24601cc3d36d0916de3113aa80dd674",
"erc20Transfers": [
{
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4",
"type": "ERC20",
"from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d",
"to": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4",
"value": "30576074978046450",
"blockTimestamp": 1713884373,
"logIndex": 2,
"erc20Token": {
"address": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7",
"name": "Wrapped AVAX",
"symbol": "WAVAX",
"decimals": 18,
"valueWithDecimals": "0.030576074978046448"
}
},
{
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4",
"type": "ERC20",
"from": "0x0E663593657B064e1baE76d28625Df5D0eBd4421",
"to": "0xf73166f0c75a3DF444fAbdFDC7e5EE4a73fA51C7",
"value": "1195737",
"blockTimestamp": 1713884373,
"logIndex": 3,
"erc20Token": {
"address": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E",
"name": "USD Coin",
"symbol": "USDC",
"decimals": 6,
"valueWithDecimals": "1.195737"
}
},
{
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4",
"type": "ERC20",
"from": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4",
"to": "0x0E663593657B064e1baE76d28625Df5D0eBd4421",
"value": "30576074978046450",
"blockTimestamp": 1713884373,
"logIndex": 4,
"erc20Token": {
"address": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7",
"name": "Wrapped AVAX",
"symbol": "WAVAX",
"decimals": 18,
"valueWithDecimals": "0.030576074978046448"
}
}
],
"erc721Transfers": [],
"erc1155Transfers": [],
"internalTransactions": [
{
"from": "0xf73166f0c75a3DF444fAbdFDC7e5EE4a73fA51C7",
"to": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d",
"internalTxType": "CALL",
"value": "30576074978046450",
"gasUsed": "212125",
"gasLimit": "651108",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d",
"to": "0xF2781Bb34B6f6Bb9a6B5349b24de91487E653119",
"internalTxType": "DELEGATECALL",
"value": "30576074978046450",
"gasUsed": "176417",
"gasLimit": "605825",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d",
"to": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E",
"internalTxType": "STATICCALL",
"value": "0",
"gasUsed": "9750",
"gasLimit": "585767",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E",
"to": "0x30DFE0469803BcE76F8F62aC24b18d33D3d6FfE6",
"internalTxType": "DELEGATECALL",
"value": "0",
"gasUsed": "2553",
"gasLimit": "569571",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d",
"to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7",
"internalTxType": "CALL",
"value": "30576074978046450",
"gasUsed": "23878",
"gasLimit": "566542",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d",
"to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7",
"internalTxType": "CALL",
"value": "0",
"gasUsed": "25116",
"gasLimit": "540114",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d",
"to": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4",
"internalTxType": "CALL",
"value": "0",
"gasUsed": "81496",
"gasLimit": "511279",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4",
"to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7",
"internalTxType": "STATICCALL",
"value": "0",
"gasUsed": "491",
"gasLimit": "501085",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4",
"to": "0x0E663593657B064e1baE76d28625Df5D0eBd4421",
"internalTxType": "CALL",
"value": "0",
"gasUsed": "74900",
"gasLimit": "497032",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x0E663593657B064e1baE76d28625Df5D0eBd4421",
"to": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E",
"internalTxType": "CALL",
"value": "0",
"gasUsed": "32063",
"gasLimit": "463431",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E",
"to": "0x30DFE0469803BcE76F8F62aC24b18d33D3d6FfE6",
"internalTxType": "DELEGATECALL",
"value": "0",
"gasUsed": "31363",
"gasLimit": "455542",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x0E663593657B064e1baE76d28625Df5D0eBd4421",
"to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7",
"internalTxType": "STATICCALL",
"value": "0",
"gasUsed": "2491",
"gasLimit": "430998",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x0E663593657B064e1baE76d28625Df5D0eBd4421",
"to": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4",
"internalTxType": "CALL",
"value": "0",
"gasUsed": "7591",
"gasLimit": "427775",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4",
"to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7",
"internalTxType": "CALL",
"value": "0",
"gasUsed": "6016",
"gasLimit": "419746",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x0E663593657B064e1baE76d28625Df5D0eBd4421",
"to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7",
"internalTxType": "STATICCALL",
"value": "0",
"gasUsed": "491",
"gasLimit": "419670",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d",
"to": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E",
"internalTxType": "STATICCALL",
"value": "0",
"gasUsed": "3250",
"gasLimit": "430493",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E",
"to": "0x30DFE0469803BcE76F8F62aC24b18d33D3d6FfE6",
"internalTxType": "DELEGATECALL",
"value": "0",
"gasUsed": "2553",
"gasLimit": "423121",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d",
"to": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E",
"internalTxType": "STATICCALL",
"value": "0",
"gasUsed": "1250",
"gasLimit": "426766",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
},
{
"from": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E",
"to": "0x30DFE0469803BcE76F8F62aC24b18d33D3d6FfE6",
"internalTxType": "DELEGATECALL",
"value": "0",
"gasUsed": "553",
"gasLimit": "419453",
"transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4"
}
],
"blockTimestamp": 1713884373
}
}
}
```
# Rate Limits (/docs/api-reference/webhook-api/rate-limits)
---
title: Rate Limits
description: Rate Limits for the Webhooks API
icon: Clock
---
Rate limiting is managed through a weighted scoring system, known as Compute Units (CUs). Each API request consumes a specified number of CUs, determined by the complexity of the request. This system is designed to accommodate basic requests while efficiently handling more computationally intensive operations.
## Rate Limit Tiers
The maximum CUs (rate-limiting score) for a user depends on their subscription level and is delineated in the following table:
| Subscription Level | Per Minute Limit (CUs) | Per Day Limit (CUs) |
| :----------------- | :--------------------- | :------------------ |
| Unauthenticated | 6,000 | 1,200,000 |
| Free | 8,000 | 2,000,000 |
| Base | 10,000 | 3,750,000 |
| Growth | 14,000 | 11,200,000 |
| Pro | 20,000 | 25,000,000 |
To update your subscription level use the [AvaCloud Portal](https://app.avacloud.io/)
Note: Rate limits apply collectively across both Webhooks and Data APIs, with usage from each counting toward your total CU limit.
## Rate Limit Categories
The CUs for each category are defined in the following table:
| Weight | CU Value |
| :----- | :------- |
| Free | 1 |
| Small | 10 |
| Medium | 20 |
| Large | 50 |
| XL | 100 |
| XXL | 200 |
## Rate Limits for Webhook Endpoints
The CUs for each route are defined in the table below:
| Endpoint | Method | Weight | CU Value |
| :------------------------------------------ | :----- | :----- | :------- |
| `/v1/webhooks` | POST | Medium | 20 |
| `/v1/webhooks` | GET | Small | 10 |
| `/v1/webhooks/{id}` | GET | Small | 10 |
| `/v1/webhooks/{id}` | DELETE | Medium | 20 |
| `/v1/webhooks/{id}` | PATCH | Medium | 20 |
| `/v1/webhooks:generateOrRotateSharedSecret` | POST | Medium | 20 |
| `/v1/webhooks:getSharedSecret` | GET | Small | 10 |
| `/v1/webhooks/{id}/addresses` | PATCH | Medium | 20 |
| `/v1/webhooks/{id}/addresses` | DELETE | Medium | 20 |
| `/v1/webhooks/{id}/addresses` | GET | Medium | 20 |
All rate limits, weights, and CU values are subject to change.
# Retry mechanism (/docs/api-reference/webhook-api/retries)
---
title: Retry mechanism
description: Retry mechanism for the Webhook API
icon: RotateCcw
---
Our webhook system is designed to ensure you receive all your messages, even if temporary issues prevent immediate delivery. To achieve this, we’ve implemented a retry mechanism that resends messages if they don’t get through on the first attempt. Importantly, **retries are handled on a per-message basis**, meaning each webhook message follows its own independent retry schedule. This ensures that the failure of one message doesn’t affect the delivery attempts of others.
This guide will walk you through how the retry mechanism works, the differences between free and paid tier users, and practical steps you can take to ensure your system handles webhooks effectively.
## How it works
When we send a webhook message to your server, we expect a `200` status code within 10 seconds to confirm successful receipt. Your server should return this response immediately and process the message afterward. Processing the message before sending the response can lead to timeouts and trigger unnecessary retries.
* **Attempt 1:** We send the message expecting a respose with `200` status code. If we do not receive a `200` status code within **10 seconds**, the attempt is considered failed. During this window, any non-`2xx` responses are ignored.
* **Attempt 2:** Occurs **10 seconds** after the first attempt, with another 10-second timeout and the same rule for ignoring non-`2xx` responses.
* **Retry Queue After Two Failed Attempts**
If both initial attempts fail, the message enters a **retry queue** with progressively longer intervals between attempts. Each retry attempt still has a 10-second timeout, and non-`2xx` responses are ignored during this window.
The retry schedule is as follows:
| Attempt | Interval |
| ------- | -------- |
| 3 | 1 min |
| 4 | 5 min |
| 5 | 10 min |
| 6 | 30 min |
| 7 | 2 hours |
| 8 | 6 hours |
| 9 | 12 hours |
| 10 | 24 hours |
**Total Retry Duration:** Up to approximately 44.8 hours (2,688 minutes) if all retries are exhausted.
**Interval Timing:** Each retry interval starts 10 seconds after the previous attempt is deemed failed. For example, if attempt 2 fails at t=20 seconds, attempt 3 will start at t=80 seconds (20s + 1 minute interval + 10s).
Since retries are per message, multiple messages can be in different stages of their retry schedules simultaneously without interfering with each other.
## Differences Between Free and Paid Tier Users
The behavior of the retry mechanism varies based on your subscription tier:
**Free tier users**
* **Initial attempts limit:** If six messages fail both the first and second attempts, your webhook will be automatically deactivated.
* **Retry queue limit:** Only five messages can enter the retry queue over the lifetime of the subscription. If a sixth message requires retry queuing, or if any message fails all 10 retry attempts, the subscription will be deactivated.
**Paid tier users**
* For paid users, webhooks will be deactivated if a single message, retried at the 24-hour interval, fails to process successfully.
## What you can do
**Ensure server availability:**
* Keep your server running smoothly to receive webhook messages without interruption.
* Implement logging for incoming webhook requests and your server's responses to help identify any issues quickly.
**Design for idempotency**
* Set up your webhook handler so it can safely process the same message multiple times without causing errors or unwanted effects. This way, if retries occur, they won't negatively impact your system.
* The webhook retry mechanism is designed to maximize the reliability of message delivery while minimizing the impact of temporary issues. By understanding how retries work—especially the per-message nature of the system—and following best practices like ensuring server availability and designing for idempotency, you can ensure a seamless experience with webhooks.
## Key Takeaways
* Each message has its own retry schedule, ensuring isolation and reliability.
* Free tier users have limits on failed attempts and retry queue entries, while paid users do not.
* Implement logging and idempotency to handle retries effectively and avoid disruptions.
* By following this guide, you’ll be well-equipped to manage webhooks and ensure your system remains robust, even in the face of temporary challenges.
# Webhook Signature (/docs/api-reference/webhook-api/webhooks-signature)
---
title: Webhook Signature
description: Webhook Signature for the Webhook API
icon: Signature
---
To make your webhooks extra secure, you can verify that they originated from our side by generating an HMAC SHA-256 hash code using your Authentication Token and request body. You can get the signing secret through the AvaCloud portal or Glacier API.
### Find your signing secret
**Using the portal**\
Navigate to the webhook section and click on Generate Signing Secret. Create the secret and copy it to your code.
**Using Data API**\
The following endpoint retrieves a shared secret:
```bash
curl --location 'https://glacier-api.avax.network/v1/webhooks:getSharedSecret' \
--header 'x-glacier-api-key: ' \
```
### Validate the signature received
Every outbound request will include an authentication signature in the header. This signature is generated by:
1. **Canonicalizing the JSON Payload**: This means arranging the JSON data in a standard format.
2. **Generating a Hash**: Using the HMAC SHA256 hash algorithm to create a hash of the canonicalized JSON payload.
To verify that the signature is from us, follow these steps:
1. Generate the HMAC SHA256 hash of the received JSON payload.
2. Compare this generated hash with the signature in the request header.
This process, known as verifying the digital signature, ensures the authenticity and integrity of the request.
**Example Request Header**
```
Content-Type: application/json;
x-signature: your-hashed-signature
```
### Example Signature Validation Function
This Node.js code sets up an HTTP server using the Express framework. It listens for POST requests sent to the `/callback` endpoint. Upon receiving a request, it validates the signature of the request against a predefined `signingSecret`. If the signature is valid, it logs match; otherwise, it logs no match. The server responds with a JSON object indicating that the request was received.
### Node (JavaScript)
```javascript
const express = require('express');
const crypto = require('crypto');
const { canonicalize } = require('json-canonicalize');
const app = express();
app.use(express.json({limit: '50mb'}));
const signingSecret = 'c13cc017c4ed63bcc842c8edfb49df37512280326a32826de3b885340b8a3d53';
function isValidSignature(signingSecret, signature, payload) {
const canonicalizedPayload = canonicalize(payload);
const hmac = crypto.createHmac('sha256', Buffer.from(signingSecret, 'hex'));
const digest = hmac.update(canonicalizedPayload).digest('base64');
console.log("signature: ", signature);
console.log("digest", digest);
return signature === digest;
}
app.post('/callback', express.json({ type: 'application/json' }), (request, response) => {
const { body, headers } = request;
const signature = headers['x-signature'];
// Handle the event
switch (body.evenType) {
case 'address\*activity':
console.log("\*\** Address*activity \*\*\*");
console.log(body);
if (isValidSignature(signingSecret, signature, body)) {
console.log("match");
} else {
console.log("no match");
}
break;
// ... handle other event types
default:
console.log(`Unhandled event type ${body}`);
}
// Return a response to acknowledge receipt of the event
response.json({ received: true });
});
const PORT = 8000;
app.listen(PORT, () => console.log(`Running on port ${PORT}`));
```
### Python (Flask)
```python
from flask import Flask, request, jsonify
import hmac
import hashlib
import base64
import json
app = Flask(__name__)
SIGNING_SECRET = 'c13cc017c4ed63bcc842c8edfb49df37512280326a32826de3b885340b8a3d53'
def canonicalize(payload):
"""Function to canonicalize JSON payload"""
# In Python, canonicalization can be achieved by using sort_keys=True in json.dumps
return json.dumps(payload, separators=(',', ':'), sort_keys=True)
def is_valid_signature(signing_secret, signature, payload):
canonicalized_payload = canonicalize(payload)
hmac_obj = hmac.new(bytes.fromhex(signing_secret), canonicalized_payload.encode('utf-8'), hashlib.sha256)
digest = base64.b64encode(hmac_obj.digest()).decode('utf-8')
print("signature:", signature)
print("digest:", digest)
return signature == digest
@app.route('/callback', methods=['POST'])
def callback_handler():
body = request.json
signature = request.headers.get('x-signature')
# Handle the event
if body.get('eventType') == 'address_activity':
print("*** Address_activity ***")
print(body)
if is_valid_signature(SIGNING_SECRET, signature, body):
print("match")
else:
print("no match")
else:
print(f"Unhandled event type {body}")
# Return a response to acknowledge receipt of the event
return jsonify({"received": True})
if __name__ == '__main__':
PORT = 8000
print(f"Running on port {PORT}")
app.run(port=PORT)
```
### Go (net/http)
```go
package main
import (
"crypto/hmac"
"crypto/sha256"
"encoding/base64"
"encoding/hex"
"encoding/json"
"fmt"
"net/http"
"sort"
"strings"
)
const signingSecret = "c13cc017c4ed63bcc842c8edfb49df37512280326a32826de3b885340b8a3d53"
// Canonicalize function sorts the JSON keys and produces a canonicalized string
func Canonicalize(payload map[string]interface{}) (string, error) {
var sb strings.Builder
var keys []string
for k := range payload {
keys = append(keys, k)
}
sort.Strings(keys)
sb.WriteString("{")
for i, k := range keys {
v, err := json.Marshal(payload[k])
if err != nil {
return "", err
}
sb.WriteString(fmt.Sprintf("\"%s\":%s", k, v))
if i < len(keys)-1 {
sb.WriteString(",")
}
}
sb.WriteString("}")
return sb.String(), nil
}
func isValidSignature(signingSecret, signature string, payload map[string]interface{}) bool {
canonicalizedPayload, err := Canonicalize(payload)
if err != nil {
fmt.Println("Error canonicalizing payload:", err)
return false
}
key, err := hex.DecodeString(signingSecret)
if err != nil {
fmt.Println("Error decoding signing secret:", err)
return false
}
h := hmac.New(sha256.New, key)
h.Write([]byte(canonicalizedPayload))
digest := h.Sum(nil)
encodedDigest := base64.StdEncoding.EncodeToString(digest)
fmt.Println("signature:", signature)
fmt.Println("digest:", encodedDigest)
return signature == encodedDigest
}
func callbackHandler(w http.ResponseWriter, r *http.Request) {
var body map[string]interface{}
err := json.NewDecoder(r.Body).Decode(&body)
if err != nil {
fmt.Println("Error decoding body:", err)
http.Error(w, "Invalid request body", http.StatusBadRequest)
return
}
signature := r.Header.Get("x-signature")
eventType, ok := body["eventType"].(string)
if !ok {
fmt.Println("Error parsing eventType")
http.Error(w, "Invalid event type", http.StatusBadRequest)
return
}
switch eventType {
case "address_activity":
fmt.Println("*** Address_activity ***")
fmt.Println(body)
if isValidSignature(signingSecret, signature, body) {
fmt.Println("match")
} else {
fmt.Println("no match")
}
default:
fmt.Printf("Unhandled event type %s\n", eventType)
}
w.Header().Set("Content-Type", "application/json")
json.NewEncoder(w).Encode(map[string]bool{"received": true})
}
func main() {
http.HandleFunc("/callback", callbackHandler)
fmt.Println("Running on port 8000")
http.ListenAndServe(":8000", nil)
}
```
### Rust (actix-web)
```rust
use actix_web::{web, App, HttpServer, HttpResponse, Responder, post};
use serde::Deserialize;
use hmac::{Hmac, Mac};
use sha2::Sha256;
use base64::encode;
use std::collections::BTreeMap;
type HmacSha256 = Hmac;
const SIGNING_SECRET: &str = "c13cc017c4ed63bcc842c8edfb49df37512280326a32826de3b885340b8a3d53";
#[derive(Deserialize)]
struct EventPayload {
eventType: String,
// Add other fields as necessary
}
// Canonicalize the JSON payload by sorting keys
fn canonicalize(payload: &BTreeMap) -> String {
serde_json::to_string(payload).unwrap()
}
fn is_valid_signature(signing_secret: &str, signature: &str, payload: &BTreeMap) -> bool {
let canonicalized_payload = canonicalize(payload);
let mut mac = HmacSha256::new_from_slice(signing_secret.as_bytes())
.expect("HMAC can take key of any size");
mac.update(canonicalized_payload.as_bytes());
let result = mac.finalize();
let digest = encode(result.into_bytes());
println!("signature: {}", signature);
println!("digest: {}", digest);
digest == signature
}
#[post("/callback")]
async fn callback(body: web::Json>, req: web::HttpRequest) -> impl Responder {
let signature = req.headers().get("x-signature").unwrap().to_str().unwrap();
if let Some(event_type) = body.get("eventType").and_then(|v| v.as_str()) {
match event_type {
"address_activity" => {
println!("*** Address_activity ***");
println!("{:?}", body);
if is_valid_signature(SIGNING_SECRET, signature, &body) {
println!("match");
} else {
println!("no match");
}
}
_ => {
println!("Unhandled event type: {}", event_type);
}
}
} else {
println!("Error parsing eventType");
return HttpResponse::BadRequest().finish();
}
HttpResponse::Ok().json(serde_json::json!({ "received": true }))
}
#[actix_web::main]
async fn main() -> std::io::Result<()> {
HttpServer::new(|| {
App::new()
.service(callback)
})
.bind("0.0.0.0:8000")?
.run()
.await
}
```
### TypeScript (ChainKit SDK)
```typescript
import { isValidSignature } from '@avalanche-sdk/chainkit/utils';
import express from 'express';
const app = express();
app.use(express.json());
const signingSecret = 'your-signing-secret'; // Replace with your signing secret
app.post('/webhook', (req, res) => {
const signature = req.headers['x-signature'];
const payload = req.body;
if (isValidSignature(signingSecret, signature, payload)) {
console.log('Valid signature');
// Process the request
} else {
console.log('Invalid signature');
}
res.json({ received: true });
});
app.listen(8000, () => console.log('Server running on port 8000'));
```
# WebSockets vs Webhooks (/docs/api-reference/webhook-api/wss-vs-webhooks)
---
title: WebSockets vs Webhooks
description: WebSockets vs Webhooks for the Webhook API
icon: GitCompare
---
Reacting to real-time events from Avalanche smart contracts allows for immediate responses and automation, improving user experience and streamlining application functionality. It ensures that applications stay synchronized with the blockchain state.
There are two primary methods for receiving these on-chain events:
* **WebSockets**, using libraries like Ethers.js or Viem
* **Webhooks**, which send structured event data directly to your app via HTTP POST.
Both approaches enable real-time interactions, but they differ drastically in their reliability, ease of implementation, and long-term maintainability. In this post, we break down why Webhooks are the better, more resilient choice for most Avalanche developers.
## Architecture Overview
The diagram below compares the two models side-by-side:
**WebSockets**
* The app connects to the Avalanche RPC API over WSS to receive raw log data.
* It must decode logs, manage connection state, and store data locally.
* On disconnection, it must re-sync via an external Data API or using standard `eth_*` RPC calls (e.g., `eth_getLogs`, `eth_getBlockByNumber`).
Important: WSS is a transport protocol—not real-time by itself. Real-time capabilities come from the availability of `eth_subscribe`, which requires node support.
**Webhooks**
* The app exposes a simple HTTP endpoint.
* Decoded event data is pushed directly via POST, including token metadata.
* Built-in retries ensure reliable delivery, even during downtime.
Important: Webhooks have a 48-hour retry window. If your app is down for longer, you still need a re-sync strategy using `eth_*` calls to recover older missed events.
***
## Using WebSockets: Real-time but high maintenance
WebSockets allow you to subscribe to events using methods like eth\_subscribe. These subscriptions notify your app in real-time whenever new logs, blocks, or pending transactions meet your criteria.
```javascript
import { createPublicClient, webSocket, formatUnits } from 'viem';
import { avalancheFuji } from 'viem/chains';
import { usdcAbi } from './usdc-abi.mjs'; // Ensure this includes the Transfer event
// Your wallet address (case-insensitive comparison)
const MY_WALLET = '0x8ae323046633A07FB162043f28Cea39FFc23B50A'.toLowerCase(); //Chrome
async function monitorTransfers() {
try {
// USDC.e contract address on Avalanche Fuji
const usdcAddress = '0x5425890298aed601595a70AB815c96711a31Bc65';
// Set up the WebSocket client for Avalanche Fuji
const client = createPublicClient({
chain: avalancheFuji,
transport: webSocket('wss://api.avax-test.network/ext/bc/C/ws'),
});
// Watch for Transfer events on the USDC contract
client.watchContractEvent({
address: usdcAddress,
abi: usdcAbi,
eventName: 'Transfer',
onLogs: (logs) => {
logs.forEach((log) => {
const { from, to, value } = log.args;
const fromLower = from.toLowerCase();
// Filter for transactions where 'from' matches your wallet
if (fromLower === MY_WALLET) {
console.log('*******');
console.log('Transfer from my wallet:');
console.log(`From: ${from}`);
console.log(`To: ${to}`);
console.log(`Value: ${formatUnits(value, 6)} USDC`); // USDC has 6 decimals
console.log(`Transaction Hash: ${log.transactionHash}`);
}
});
},
onError: (error) => {
console.error('Event watching error:', error.message);
},
});
console.log('Monitoring USDC Transfer events on Fuji...');
} catch (error) {
console.error('Error setting up transfer monitoring:', error.message);
}
}
// Start monitoring
monitorTransfers();
```
The downside? If your connection drops, you lose everything in between. You’ll need to:
* Set up a database to track the latest processed block and log index.
* Correctly handling dropped connections and reconnection by hand can be challenging to get right.
* Use `eth_getLogs` to re-fetch missed logs.
* Decode and process raw logs yourself to rebuild app state.
This requires extra infrastructure, custom recovery logic, and significant maintenance overhead.
***
## Webhooks: Resilient and developer-friendly
Webhooks eliminate the complexity of managing live connections. Instead, you register an HTTP endpoint to receive blockchain event payloads when they occur.
Webhook payload example:
```json
{
"eventType": "address_activity",
"event": {
"transaction": {
"txHash": "0x1d8f...",
"from": "0x3D3B...",
"to": "0x9702...",
"erc20Transfers": [
{
"valueWithDecimals": "110.56",
"erc20Token": {
"symbol": "USDt",
"decimals": 6
}
}
]
}
}
}
```
You get everything you need:
* Decoded event data
* Token metadata (name, symbol, decimals)
* Full transaction context
* No extra calls. No parsing. No manual re-sync logic.
***
## Key Advantages of Webhooks
* **Reliable delivery with zero effort:** Built-in retries ensure no missed events during downtime
* **Instant enrichment:** Payloads contain decoded logs, token metadata, and transaction context
* **No extra infrastructure:** No WebSocket connections, no DB, no external APIs
* **Faster development:** Go from idea to production with fewer moving parts
* **Lower operational cost:** Less compute, fewer network calls, smaller surface area to manage
If we compare using a table:
| Feature | WebSockets (Ethers.js/Viem) | Webhooks | | |
| :----------------------------- | :------------------------------------------------- | :--------------------------------------------------- | - | - |
| **Interruption Handling** | Manual; Requires complex custom logic | Automatic; Built-in queues & retries | | |
| **Data Recovery** | Requires DB + External API for re-sync | Handled by provider; No re-sync logic needed | | |
| **Dev Complexity** | High; Error-prone custom resilience code | Low; Focus on processing incoming POST data | | |
| **Infrastructure** | WSS connection + DB + Potential Data API cost | Application API endpoint | | |
| **Data Integrity** | Risk of gaps if recovery logic fails | High; Ensures eventual delivery | | |
| **Payload** | Often raw; Requires extra calls for context | Typically enriched and ready-to-use | | |
| **Multiple addresses** | Manual filtering or separate listeners per address | Supports direct configuration for multiple addresses | | |
| **Listen to wallet addresses** | Requires manual block/transaction filtering | Can monitor wallet addresses and smart contracts | | |
## Summary
* WebSockets offer real-time access to Avalanche data, but come with complexity: raw logs, reconnect logic, re-sync handling, and decoding responsibilities.
* Webhooks flip the model: the data comes to you, pre-processed and reliable. You focus on your product logic instead of infrastructure.
* If you want to ship faster, operate more reliably, and reduce overhead, Webhooks are the better path forward for Avalanche event monitoring.
# Getting Started (/docs/api-reference/metrics-api/getting-started)
---
title: Getting Started
description: Getting Started with the Metrics API
icon: Rocket
---
The Metrics API is designed to be simple and accessible, requiring no authentication to get started. Just choose your endpoint, make your query, and instantly access on-chain data and analytics to power your applications.
The following query retrieves the daily count of active addresses on the Avalanche C-Chain(43114) over the course of one month (from August 1, 2024 12:00:00 AM to August 31, 2024 12:00:00 AM), providing insights into user activity on the chain for each day during that period. With this data you can use JavaScript visualization tools like Chart.js, D3.js, Highcharts, Plotly.js, or Recharts to create interactive and insightful visual representations.
```bash
curl --request GET \
--url 'https://metrics.avax.network/v2/chains/43114/metrics/activeAddresses?startTimestamp=1722470400&endTimestamp=1725062400&timeInterval=day&pageSize=31'
```
Response:
```json
{
"results": [
{
"value": 37738,
"timestamp": 1724976000
},
{
"value": 53934,
"timestamp": 1724889600
},
{
"value": 58992,
"timestamp": 1724803200
},
{
"value": 73792,
"timestamp": 1724716800
},
{
"value": 70057,
"timestamp": 1724630400
},
{
"value": 46452,
"timestamp": 1724544000
},
{
"value": 46323,
"timestamp": 1724457600
},
{
"value": 73399,
"timestamp": 1724371200
},
{
"value": 52661,
"timestamp": 1724284800
},
{
"value": 52497,
"timestamp": 1724198400
},
{
"value": 50574,
"timestamp": 1724112000
},
{
"value": 46999,
"timestamp": 1724025600
},
{
"value": 45320,
"timestamp": 1723939200
},
{
"value": 54964,
"timestamp": 1723852800
},
{
"value": 60251,
"timestamp": 1723766400
},
{
"value": 48493,
"timestamp": 1723680000
},
{
"value": 71091,
"timestamp": 1723593600
},
{
"value": 50456,
"timestamp": 1723507200
},
{
"value": 46989,
"timestamp": 1723420800
},
{
"value": 50984,
"timestamp": 1723334400
},
{
"value": 46988,
"timestamp": 1723248000
},
{
"value": 66943,
"timestamp": 1723161600
},
{
"value": 64209,
"timestamp": 1723075200
},
{
"value": 57478,
"timestamp": 1722988800
},
{
"value": 80553,
"timestamp": 1722902400
},
{
"value": 70472,
"timestamp": 1722816000
},
{
"value": 53678,
"timestamp": 1722729600
},
{
"value": 70818,
"timestamp": 1722643200
},
{
"value": 99842,
"timestamp": 1722556800
},
{
"value": 76515,
"timestamp": 1722470400
}
]
}
```
Congratulations! You’ve successfully made your first query to the Metrics API. 🚀🚀🚀
# Metrics API (/docs/api-reference/metrics-api)
---
title: Metrics API
description: Access real-time and historical metrics for Avalanche networks
icon: ChartLine
---
### What is the Metrics API?
The Metrics API equips web3 developers with a robust suite of tools to access and analyze on-chain activity across Avalanche’s primary network, Avalanche L1s, and other supported EVM chains. This API delivers comprehensive metrics and analytics, enabling you to seamlessly integrate historical data on transactions, gas consumption, throughput, staking, and more into your applications.
The Metrics API, along with the [Data API](/docs/api-reference/data-api) are the driving force behind every graph you see on the [Avalanche Explorer](https://explorer.avax.network/). From transaction trends to staking insights, the visualizations and data presented are all powered by these APIs, offering real-time and historical insights that are essential for building sophisticated, data-driven blockchain products..
### Features
* **Chain Throughput:** Retrieve detailed metrics on gas consumption, Transactions Per Second (TPS), and gas prices, including rolling windows of data for granular analysis.
* **Cumulative Metrics:** Access cumulative data on addresses, contracts, deployers, and transaction counts, providing insights into network growth over time.
* **Staking Information:** Obtain staking-related data, including the number of validators and delegators, along with their respective weights, across different subnets.
* **Blockchains and Subnets:** Get information about supported blockchains, including EVM Chain IDs, blockchain IDs, and subnet associations, facilitating multi-chain analytics.
* **Composite Queries:** Perform advanced queries by combining different metric types and conditions, enabling detailed and customizable data retrieval.
The Metrics API is designed to provide developers with powerful tools to analyze and monitor on-chain activity across Avalanche’s primary network, Avalanche L1s, and other supported EVM chains. Below is an overview of the key features available:
### Chain Throughput Metrics
* **Gas Consumption**
Track the average and maximum gas consumption per second, helping to understand network performance and efficiency.
* **Transactions Per Second (TPS)**
Monitor the average and peak TPS to assess the network’s capacity and utilization.
* **Gas Prices**
Analyze average and maximum gas prices over time to optimize transaction costs and predict fee trends.
Monitor the average and peak TPS to assess the network’s capacity and utilization.
### Cumulative Metrics
* **Address Growth**
Access the cumulative number of active addresses on a chain, providing insights into network adoption and user activity.
* **Contract Deployment**
Monitor the cumulative number of smart contracts deployed, helping to gauge developer engagement and platform usage.
* **Transaction Count**
Track the cumulative number of transactions, offering a clear view of network activity and transaction volume.
### Staking Information
* **Validator and Delegator Counts**
Retrieve the number of active validators and delegators for a given L1, crucial for understanding network security and decentralization.
* **Staking Weights**
Access the total stake weight of validators and delegators, helping to assess the distribution of staked assets across the network.
### Rolling Window Analytics
* **Short-Term and Long-Term Metrics:** Perform rolling window analysis on various metrics like gas used, TPS, and gas prices, allowing for both short-term and long-term trend analysis.
* **Customizable Time Frames:** Choose from different time intervals (hourly, daily, monthly) to suit your specific analytical needs.
### Blockchain and L1 Information
* **Chain and L1 Mapping:** Get detailed information about EVM chains and their associated L1s, including chain IDs, blockchain IDs, and subnet IDs, facilitating cross-chain analytics.
### Advanced Composite Queries
* **Custom Metrics Combinations**: Combine multiple metrics and apply logical operators to perform sophisticated queries, enabling deep insights and tailored analytics.
* **Paginated Results:** Handle large datasets efficiently with paginated responses, ensuring seamless data retrieval in your applications.
The Metrics API equips developers with the tools needed to build robust analytics, monitoring, and reporting solutions, leveraging the full power of multi-chain data across the Avalanche ecosystem and beyond.
# Rate Limits (/docs/api-reference/metrics-api/rate-limits)
---
title: Rate Limits
description: Rate Limits for the Metrics API
icon: Clock
---
# Rate Limits
Rate limiting is managed through a weighted scoring system, known as Compute Units (CUs). Each API request consumes a specified number of CUs, determined by the complexity of the request. This system is designed to accommodate basic requests while efficiently handling more computationally intensive operations.
## Rate Limit Tiers
The maximum CUs (rate-limiting score) for a user depends on their subscription level and is delineated in the following table:
| Subscription Level | Per Minute Limit (CUs) | Per Day Limit (CUs) |
| :----------------- | :--------------------- | :------------------ |
| Free | 8,000 | 1,200,000 |
> We are working on new subscription tiers with higher rate limits to support even greater request volumes.
## Rate Limit Categories
The CUs for each category are defined in the following table:
| Weight | CU Value |
| :----- | :------- |
| Free | 1 |
| Small | 20 |
| Medium | 100 |
| Large | 500 |
| XL | 1000 |
| XXL | 3000 |
## Rate Limits for Metrics Endpoints
The CUs for each route are defined in the table below:
| Endpoint | Method | Weight | CU Value |
| :---------------------------------------------------------- | :----- | :----- | :------- |
| `/v2/health-check` | GET | Free | 1 |
| `/v2/chains` | GET | Free | 1 |
| `/v2/chains/{chainId}` | GET | Free | 1 |
| `/v2/chains/{chainId}/metrics/{metric}` | GET | Medium | 100 |
| `/v2/chains/{chainId}/teleporterMetrics/{metric}` | GET | Medium | 100 |
| `/v2/chains/{chainId}/rollingWindowMetrics/{metric}` | GET | Medium | 100 |
| `/v2/networks/{network}/metrics/{metric}` | GET | Medium | 100 |
| `/v2/chains/{chainId}/contracts/{address}/nfts:listHolders` | GET | Large | 500 |
| `/v2/chains/{chainId}/contracts/{address}/balances` | GET | XL | 1000 |
| `/v2/chains/43114/btcb/bridged:getAddresses` | GET | Large | 500 |
| `/v2/subnets/{subnetId}/validators:getAddresses` | GET | Large | 500 |
| `/v2/lookingGlass/compositeQuery` | POST | XXL | 3000 |
All rate limits, weights, and CU values are subject to change.
# Usage Guide (/docs/api-reference/metrics-api/usage-guide)
---
title: Usage Guide
description: Usage Guide for the Metrics API
icon: Code
---
The Metrics API does not require authentication, making it straightforward to integrate into your applications. You can start making API requests without the need for an API key or any authentication headers.
#### Making Requests
You can interact with the Metrics API by sending HTTP GET requests to the provided endpoints. Below is an example of a simple `curl` request.
```bash
curl -H "Content-Type: Application/json" "https://metrics.avax.network/v1/avg_tps/{chainId}"
```
In the above request Replace `chainId` with the specific chain ID you want to query. For example, to retrieve the average transactions per second (TPS) for a specific chain (in this case, chain ID 43114), you can use the following endpoint:
```bash
curl "https://metrics.avax.network/v1/avg_tps/43114"
```
The API will return a JSON response containing the average TPS for the specified chain over a series of timestamps and `lastRun` is a timestamp indicating when the last data point was updated:
```json
{
"results": [
{"timestamp": 1724716800, "value": 1.98},
{"timestamp": 1724630400, "value": 2.17},
{"timestamp": 1724544000, "value": 1.57},
{"timestamp": 1724457600, "value": 1.82},
// Additional data points...
],
"status": 200,
"lastRun": 1724780812
}
```
### Rate Limits
Even though the Metrics API does not require authentication, it still enforces rate limits to ensure stability and performance. If you exceed these limits, the server will respond with a 429 Too Many Requests HTTP response code.
### Error Types
The API generates standard error responses along with error codes based on provided requests and parameters.
Typically, response codes within the `2XX` range signifies successful requests, while those within the `4XX` range points to errors originating from the client's side. Meanwhile, response codes within the `5XX` range indicates problems on the server's side.
The error response body is formatted like this:
```json
{
"message": ["Invalid address format"], // route specific error message
"error": "Bad Request", // error type
"statusCode": 400 // http response code
}
```
Let's go through every error code that we can respond with:
| Error Code | Error Type | Description |
| ---------- | --------------------- | ----------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------- |
| **400** | Bad Request | Bad requests generally mean the client has passed invalid or malformed parameters. Error messages in the response could help in evaluating the error. |
| **401** | Unauthorized | When a client attempts to access resources that require authorization credentials but the client lacks proper authentication in the request, the server responds with 401. |
| **403** | Forbidden | When a client attempts to access resources with valid credentials but doesn't have the privilege to perform that action, the server responds with 403. |
| **404** | Not Found | The 404 error is mostly returned when the client requests with either mistyped URL, or the passed resource is moved or deleted, or the resource doesn't exist. |
| **500** | Internal Server Error | The 500 error is a generic server-side error that is returned for any uncaught and unexpected issues on the server side. This should be very rare, and you may reach out to us if the problem persists for a longer duration. |
| **502** | Bad Gateway | This is an internal error indicating invalid response received by the client-facing proxy or gateway from the upstream server. |
| **503** | Service Unavailable | The 503 error is returned for certain routes on a particular Subnet. This indicates an internal problem with our Subnet node, and may not necessarily mean the Subnet is down or affected. |
### Pagination
For endpoints that return large datasets, the Metrics API employs pagination to manage the results. When querying for lists of data, you may receive a nextPageToken in the response, which can be used to request the next page of data.
Example response with pagination:
```json
{
"results": [...],
"nextPageToken": "3d22deea-ea64-4d30-8a1e-c2a353b67e90"
}
```
To retrieve the next set of results, include the nextPageToken in your subsequent request:
```bash
curl -H "Content-Type: Application/json" \
"https://metrics.avax.network/v1/avg_tps/{chainId}?pageToken=3d22deea-ea64-4d30-8a1e-c2a353b67e90"
```
### Pagination Details
#### Page Token Structure
The `nextPageToken` is a UUID-based token provided in the response when additional pages of data are available. This token serves as a pointer to the next set of data.
* **UUID Generation**: The `nextPageToken` is generated uniquely for each pagination scenario, ensuring security and ensuring predictability.
* **Expiration**: The token is valid for 24 hours from the time it is generated. After this period, the token will expire, and a new request starting from the initial page will be required.
* **Presence**: The token is only included in the response when there is additional data available. If no more data exists, the token will not be present.
#### Integration and Usage
To use the pagination system effectively:
* Check if the `nextPageToken` is present in the response.
* If present, include this token in the subsequent request to fetch the next page of results.
* Ensure that the follow-up request is made within the 24-hour window after the token was generated to avoid token expiration.
By utilizing the pagination mechanism, you can efficiently manage and navigate through large datasets, ensuring a smooth data retrieval process.
### Swagger API Reference
You can explore the full API definitions and interact with the endpoints in the Swagger documentation at:
[https://metrics.avax.network/api](https://metrics.avax.network/api)
# cli info (/docs/avalanche-l1s/deploy-a-avalanche-l1/cli_structure)
---
title: cli info
description: cli flags and stuff
---
## avalanche blockchain
The blockchain command suite provides a collection of tools for developing
and deploying Blockchains.
To get started, use the blockchain create command wizard to walk through the
configuration of your very first Blockchain. Then, go ahead and deploy it
with the blockchain deploy command. You can use the rest of the commands to
manage your Blockchain configurations and live deployments.
**Usage:**
```bash
avalanche blockchain [subcommand] [flags]
```
**Subcommands:**
- [`addValidator`](#avalanche-blockchain-addvalidator): The blockchain addValidator command adds a node as a validator to
an L1 of the user provided deployed network. If the network is proof of
authority, the owner of the validator manager contract must sign the
transaction. If the network is proof of stake, the node must stake the L1's
staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain.
This command currently only works on Blockchains deployed to either the Fuji
Testnet or Mainnet.
- [`changeOwner`](#avalanche-blockchain-changeowner): The blockchain changeOwner changes the owner of the subnet of the deployed Blockchain.
- [`changeWeight`](#avalanche-blockchain-changeweight): The blockchain changeWeight command changes the weight of a Subnet Validator.
The Subnet has to be a Proof of Authority Subnet-Only Validator Subnet.
- [`configure`](#avalanche-blockchain-configure): AvalancheGo nodes support several different configuration files. Subnets have their own
Subnet config which applies to all chains/VMs in the Subnet. Each chain within the Subnet
can have its own chain config. A chain can also have special requirements for the AvalancheGo node
configuration itself. This command allows you to set all those files.
- [`create`](#avalanche-blockchain-create): The blockchain create command builds a new genesis file to configure your Blockchain.
By default, the command runs an interactive wizard. It walks you through
all the steps you need to create your first Blockchain.
The tool supports deploying Subnet-EVM, and custom VMs. You
can create a custom, user-generated genesis with a custom VM by providing
the path to your genesis and VM binaries with the --genesis and --vm flags.
By default, running the command with a blockchainName that already exists
causes the command to fail. If you'd like to overwrite an existing
configuration, pass the -f flag.
- [`delete`](#avalanche-blockchain-delete): The blockchain delete command deletes an existing blockchain configuration.
- [`deploy`](#avalanche-blockchain-deploy): The blockchain deploy command deploys your Blockchain configuration locally, to Fuji Testnet, or to Mainnet.
At the end of the call, the command prints the RPC URL you can use to interact with the Subnet.
Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent
attempts to deploy the same Blockchain to the same network (local, Fuji, Mainnet) aren't
allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call
avalanche network clean to reset all deployed chain state. Subsequent local deploys
redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks,
so you can take your locally tested Subnet and deploy it on Fuji or Mainnet.
- [`describe`](#avalanche-blockchain-describe): The blockchain describe command prints the details of a Blockchain configuration to the console.
By default, the command prints a summary of the configuration. By providing the --genesis
flag, the command instead prints out the raw genesis file.
- [`export`](#avalanche-blockchain-export): The blockchain export command write the details of an existing Blockchain deploy to a file.
The command prompts for an output path. You can also provide one with
the --output flag.
- [`import`](#avalanche-blockchain-import): Import blockchain configurations into avalanche-cli.
This command suite supports importing from a file created on another computer,
or importing from blockchains running public networks
(e.g. created manually or with the deprecated subnet-cli)
- [`join`](#avalanche-blockchain-join): The subnet join command configures your validator node to begin validating a new Blockchain.
To complete this process, you must have access to the machine running your validator. If the
CLI is running on the same machine as your validator, it can generate or update your node's
config file automatically. Alternatively, the command can print the necessary instructions
to update your node manually. To complete the validation process, the Subnet's admins must add
the NodeID of your validator to the Subnet's allow list by calling addValidator with your
NodeID.
After you update your validator's config, you need to restart your validator manually. If
you provide the --avalanchego-config flag, this command attempts to edit the config file
at that path.
This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet.
- [`list`](#avalanche-blockchain-list): The blockchain list command prints the names of all created Blockchain configurations. Without any flags,
it prints some general, static information about the Blockchain. With the --deployed flag, the command
shows additional information including the VMID, BlockchainID and SubnetID.
- [`publish`](#avalanche-blockchain-publish): The blockchain publish command publishes the Blockchain's VM to a repository.
- [`removeValidator`](#avalanche-blockchain-removevalidator): The blockchain removeValidator command stops a whitelisted, subnet network validator from
validating your deployed Blockchain.
To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass
these prompts by providing the values with flags.
- [`stats`](#avalanche-blockchain-stats): The blockchain stats command prints validator statistics for the given Blockchain.
- [`upgrade`](#avalanche-blockchain-upgrade): The blockchain upgrade command suite provides a collection of tools for
updating your developmental and deployed Blockchains.
- [`validators`](#avalanche-blockchain-validators): The blockchain validators command lists the validators of a blockchain's subnet and provides
several statistics about them.
- [`vmid`](#avalanche-blockchain-vmid): The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain.
**Flags:**
```bash
-h, --help help for blockchain
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### addValidator
The blockchain addValidator command adds a node as a validator to
an L1 of the user provided deployed network. If the network is proof of
authority, the owner of the validator manager contract must sign the
transaction. If the network is proof of stake, the node must stake the L1's
staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain.
This command currently only works on Blockchains deployed to either the Fuji
Testnet or Mainnet.
**Usage:**
```bash
avalanche blockchain addValidator [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true)
--aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation
--aggregator-log-level string log level to use with signature aggregator (default "Off")
--balance uint set the AVAX balance of the validator that will be used for continuous fee on P-Chain
--blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's registration (blockchain gas token)
--blockchain-key string CLI stored key to use to pay fees for completing the validator's registration (blockchain gas token)
--blockchain-private-key string private key to use to pay fees for completing the validator's registration (blockchain gas token)
--bls-proof-of-possession string set the BLS proof of possession of the validator to add
--bls-public-key string set the BLS public key of the validator to add
--cluster string operate on the given cluster
--create-local-validator create additional local validator and add it to existing running local node
--default-duration (for Subnets, not L1s) set duration so as to validate until primary validator ends its period
--default-start-time (for Subnets, not L1s) use default start time for subnet validator (5 minutes later for fuji & mainnet, 30 seconds later for devnet)
--default-validator-params (for Subnets, not L1s) use default weight/start/duration params for subnet validator
--delegation-fee uint16 (PoS only) delegation fee (in bips) (default 100)
--devnet operate on a devnet network
--disable-owner string P-Chain address that will able to disable the validator with a P-Chain transaction
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet only]
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for addValidator
-k, --key string select the key to use [fuji/devnet only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-endpoint string gather node id/bls from publicly available avalanchego apis on the given endpoint
--node-id string node-id of the validator to add
--output-tx-path string (for Subnets, not L1s) file path of the add validator tx
--partial-sync set primary network partial sync for new validators (default true)
--remaining-balance-owner string P-Chain address that will receive any leftover AVAX from the validator when it is removed from Subnet
--rpc string connect to validator manager at the given rpc endpoint
--stake-amount uint (PoS only) amount of tokens to stake
--staking-period duration how long this validator will be staking
--start-time string (for Subnets, not L1s) UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format
--subnet-auth-keys strings (for Subnets, not L1s) control keys that will be used to authenticate add validator tx
-t, --testnet fuji operate on testnet (alias to fuji)
--wait-for-tx-acceptance (for Subnets, not L1s) just issue the add validator tx, without waiting for its acceptance (default true)
--weight uint set the staking weight of the validator to add (default 20)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### changeOwner
The blockchain changeOwner changes the owner of the subnet of the deployed Blockchain.
**Usage:**
```bash
avalanche blockchain changeOwner [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--control-keys strings addresses that may make subnet changes
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet]
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for changeOwner
-k, --key string select the key to use [fuji/devnet]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--output-tx-path string file path of the transfer subnet ownership tx
-s, --same-control-key use the fee-paying key as control key
--subnet-auth-keys strings control keys that will be used to authenticate transfer subnet ownership tx
-t, --testnet fuji operate on testnet (alias to fuji)
--threshold uint32 required number of control key signatures to make subnet changes
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### changeWeight
The blockchain changeWeight command changes the weight of a Subnet Validator.
The Subnet has to be a Proof of Authority Subnet-Only Validator Subnet.
**Usage:**
```bash
avalanche blockchain changeWeight [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet only]
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for changeWeight
-k, --key string select the key to use [fuji/devnet only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-id string node-id of the validator
-t, --testnet fuji operate on testnet (alias to fuji)
--weight uint set the new staking weight of the validator (default 20)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### configure
AvalancheGo nodes support several different configuration files. Subnets have their own
Subnet config which applies to all chains/VMs in the Subnet. Each chain within the Subnet
can have its own chain config. A chain can also have special requirements for the AvalancheGo node
configuration itself. This command allows you to set all those files.
**Usage:**
```bash
avalanche blockchain configure [subcommand] [flags]
```
**Flags:**
```bash
--chain-config string path to the chain configuration
-h, --help help for configure
--node-config string path to avalanchego node configuration
--per-node-chain-config string path to per node chain configuration for local network
--subnet-config string path to the subnet configuration
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### create
The blockchain create command builds a new genesis file to configure your Blockchain.
By default, the command runs an interactive wizard. It walks you through
all the steps you need to create your first Blockchain.
The tool supports deploying Subnet-EVM, and custom VMs. You
can create a custom, user-generated genesis with a custom VM by providing
the path to your genesis and VM binaries with the --genesis and --vm flags.
By default, running the command with a blockchainName that already exists
causes the command to fail. If you'd like to overwrite an existing
configuration, pass the -f flag.
**Usage:**
```bash
avalanche blockchain create [subcommand] [flags]
```
**Flags:**
```bash
--custom use a custom VM template
--custom-vm-branch string custom vm branch or commit
--custom-vm-build-script string custom vm build-script
--custom-vm-path string file path of custom vm to use
--custom-vm-repo-url string custom vm repository url
--debug enable blockchain debugging (default true)
--evm use the Subnet-EVM as the base template
--evm-chain-id uint chain ID to use with Subnet-EVM
--evm-defaults deprecation notice: use '--production-defaults'
--evm-token string token symbol to use with Subnet-EVM
--external-gas-token use a gas token from another blockchain
-f, --force overwrite the existing configuration if one exists
--from-github-repo generate custom VM binary from github repository
--genesis string file path of genesis to use
-h, --help help for create
--icm interoperate with other blockchains using ICM
--icm-registry-at-genesis setup ICM registry smart contract on genesis [experimental]
--latest use latest Subnet-EVM released version, takes precedence over --vm-version
--pre-release use latest Subnet-EVM pre-released version, takes precedence over --vm-version
--production-defaults use default production settings for your blockchain
--proof-of-authority use proof of authority(PoA) for validator management
--proof-of-stake use proof of stake(PoS) for validator management
--proxy-contract-owner string EVM address that controls ProxyAdmin for TransparentProxy of ValidatorManager contract
--reward-basis-points uint (PoS only) reward basis points for PoS Reward Calculator (default 100)
--sovereign set to false if creating non-sovereign blockchain (default true)
--teleporter interoperate with other blockchains using ICM
--test-defaults use default test settings for your blockchain
--validator-manager-owner string EVM address that controls Validator Manager Owner
--vm string file path of custom vm to use. alias to custom-vm-path
--vm-version string version of Subnet-EVM template to use
--warp generate a vm with warp support (needed for ICM) (default true)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### delete
The blockchain delete command deletes an existing blockchain configuration.
**Usage:**
```bash
avalanche blockchain delete [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for delete
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### deploy
The blockchain deploy command deploys your Blockchain configuration locally, to Fuji Testnet, or to Mainnet.
At the end of the call, the command prints the RPC URL you can use to interact with the Subnet.
Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent
attempts to deploy the same Blockchain to the same network (local, Fuji, Mainnet) aren't
allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call
avalanche network clean to reset all deployed chain state. Subsequent local deploys
redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks,
so you can take your locally tested Subnet and deploy it on Fuji or Mainnet.
**Usage:**
```bash
avalanche blockchain deploy [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true)
--aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation
--aggregator-log-level string log level to use with signature aggregator (default "Off")
--avalanchego-path string use this avalanchego binary path
--avalanchego-version string use this version of avalanchego (ex: v1.17.12) (default "latest-prerelease")
--balance float set the AVAX balance of each bootstrap validator that will be used for continuous fee on P-Chain (default 0.1)
--blockchain-genesis-key use genesis allocated key to fund validator manager initialization
--blockchain-key string CLI stored key to use to fund validator manager initialization
--blockchain-private-key string private key to use to fund validator manager initialization
--bootstrap-endpoints strings take validator node info from the given endpoints
--bootstrap-filepath string JSON file path that provides details about bootstrap validators, leave Node-ID and BLS values empty if using --generate-node-id=true
--cchain-funding-key string key to be used to fund relayer account on cchain
--cchain-icm-key string key to be used to pay for ICM deploys on C-Chain
--change-owner-address string address that will receive change if node is no longer L1 validator
--cluster string operate on the given cluster
--control-keys strings addresses that may make subnet changes
--convert-only avoid node track, restart and poa manager setup
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet deploy only]
-f, --fuji testnet operate on fuji (alias to testnet
--generate-node-id whether to create new node id for bootstrap validators (Node-ID and BLS values in bootstrap JSON file will be overridden if --bootstrap-filepath flag is used)
-h, --help help for deploy
--icm-key string key to be used to pay for ICM deploys (default "cli-teleporter-deployer")
--icm-version string ICM version to deploy (default "latest")
-k, --key string select the key to use [fuji/devnet deploy only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--mainnet-chain-id uint32 use different ChainID for mainnet deployment
--noicm skip automatic ICM deploy
--num-bootstrap-validators int (only if --generate-node-id is true) number of bootstrap validators to set up in sovereign L1 validator)
--num-local-nodes int number of nodes to be created on local machine
--num-nodes uint32 number of nodes to be created on local network deploy (default 2)
--output-tx-path string file path of the blockchain creation tx
--partial-sync set primary network partial sync for new validators (default true)
--pos-maximum-stake-amount uint maximum stake amount (default 1000)
--pos-maximum-stake-multiplier uint8 maximum stake multiplier (default 1)
--pos-minimum-delegation-fee uint16 minimum delegation fee (default 1)
--pos-minimum-stake-amount uint minimum stake amount (default 1)
--pos-minimum-stake-duration uint minimum stake duration (default 100)
--pos-weight-to-value-factor uint weight to value factor (default 1)
--relay-cchain relay C-Chain as source and destination (default true)
--relayer-allow-private-ips allow relayer to connec to private ips (default true)
--relayer-amount float automatically fund relayer fee payments with the given amount
--relayer-key string key to be used by default both for rewards and to pay fees
--relayer-log-level string log level to be used for relayer logs (default "info")
--relayer-path string relayer binary to use
--relayer-version string relayer version to deploy (default "latest-prerelease")
-s, --same-control-key use the fee-paying key as control key
--skip-icm-deploy skip automatic ICM deploy
--skip-local-teleporter skip automatic ICM deploy on local networks [to be deprecated]
--skip-relayer skip relayer deploy
--skip-teleporter-deploy skip automatic ICM deploy
--subnet-auth-keys strings control keys that will be used to authenticate chain creation
-u, --subnet-id string do not create a subnet, deploy the blockchain into the given subnet id
--subnet-only only create a subnet
--teleporter-messenger-contract-address-path string path to an ICM Messenger contract address file
--teleporter-messenger-deployer-address-path string path to an ICM Messenger deployer address file
--teleporter-messenger-deployer-tx-path string path to an ICM Messenger deployer tx file
--teleporter-registry-bytecode-path string path to an ICM Registry bytecode file
--teleporter-version string ICM version to deploy (default "latest")
-t, --testnet fuji operate on testnet (alias to fuji)
--threshold uint32 required number of control key signatures to make subnet changes
--use-local-machine use local machine as a blockchain validator
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### describe
The blockchain describe command prints the details of a Blockchain configuration to the console.
By default, the command prints a summary of the configuration. By providing the --genesis
flag, the command instead prints out the raw genesis file.
**Usage:**
```bash
avalanche blockchain describe [subcommand] [flags]
```
**Flags:**
```bash
-g, --genesis Print the genesis to the console directly instead of the summary
-h, --help help for describe
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### export
The blockchain export command write the details of an existing Blockchain deploy to a file.
The command prompts for an output path. You can also provide one with
the --output flag.
**Usage:**
```bash
avalanche blockchain export [subcommand] [flags]
```
**Flags:**
```bash
--custom-vm-branch string custom vm branch
--custom-vm-build-script string custom vm build-script
--custom-vm-repo-url string custom vm repository url
-h, --help help for export
-o, --output string write the export data to the provided file path
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### import
Import blockchain configurations into avalanche-cli.
This command suite supports importing from a file created on another computer,
or importing from blockchains running public networks
(e.g. created manually or with the deprecated subnet-cli)
**Usage:**
```bash
avalanche blockchain import [subcommand] [flags]
```
**Subcommands:**
- [`file`](#avalanche-blockchain-import-file): The blockchain import command will import a blockchain configuration from a file or a git repository.
To import from a file, you can optionally provide the path as a command-line argument.
Alternatively, running the command without any arguments triggers an interactive wizard.
To import from a repository, go through the wizard. By default, an imported Blockchain doesn't
overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
- [`public`](#avalanche-blockchain-import-public): The blockchain import public command imports a Blockchain configuration from a running network.
By default, an imported Blockchain
doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
**Flags:**
```bash
-h, --help help for import
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### import file
The blockchain import command will import a blockchain configuration from a file or a git repository.
To import from a file, you can optionally provide the path as a command-line argument.
Alternatively, running the command without any arguments triggers an interactive wizard.
To import from a repository, go through the wizard. By default, an imported Blockchain doesn't
overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
**Usage:**
```bash
avalanche blockchain import file [subcommand] [flags]
```
**Flags:**
```bash
--branch string the repo branch to use if downloading a new repo
-f, --force overwrite the existing configuration if one exists
-h, --help help for file
--repo string the repo to import (ex: ava-labs/avalanche-plugins-core) or url to download the repo from
--subnet string the subnet configuration to import from the provided repo
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### import public
The blockchain import public command imports a Blockchain configuration from a running network.
By default, an imported Blockchain
doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
**Usage:**
```bash
avalanche blockchain import public [subcommand] [flags]
```
**Flags:**
```bash
--blockchain-id string the blockchain ID
--cluster string operate on the given cluster
--custom use a custom VM template
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--evm import a subnet-evm
--force overwrite the existing configuration if one exists
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for public
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-url string [optional] URL of an already running subnet validator
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### join
The subnet join command configures your validator node to begin validating a new Blockchain.
To complete this process, you must have access to the machine running your validator. If the
CLI is running on the same machine as your validator, it can generate or update your node's
config file automatically. Alternatively, the command can print the necessary instructions
to update your node manually. To complete the validation process, the Subnet's admins must add
the NodeID of your validator to the Subnet's allow list by calling addValidator with your
NodeID.
After you update your validator's config, you need to restart your validator manually. If
you provide the --avalanchego-config flag, this command attempts to edit the config file
at that path.
This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet.
**Usage:**
```bash
avalanche blockchain join [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-config string file path of the avalanchego config file
--cluster string operate on the given cluster
--data-dir string path of avalanchego's data dir directory
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force-write if true, skip to prompt to overwrite the config file
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for join
-k, --key string select the key to use [fuji only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-id string set the NodeID of the validator to check
--plugin-dir string file path of avalanchego's plugin directory
--print if true, print the manual config without prompting
--stake-amount uint amount of tokens to stake on validator
--staking-period duration how long validator validates for after start time
--start-time string start time that validator starts validating
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### list
The blockchain list command prints the names of all created Blockchain configurations. Without any flags,
it prints some general, static information about the Blockchain. With the --deployed flag, the command
shows additional information including the VMID, BlockchainID and SubnetID.
**Usage:**
```bash
avalanche blockchain list [subcommand] [flags]
```
**Flags:**
```bash
--deployed show additional deploy information
-h, --help help for list
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### publish
The blockchain publish command publishes the Blockchain's VM to a repository.
**Usage:**
```bash
avalanche blockchain publish [subcommand] [flags]
```
**Flags:**
```bash
--alias string We publish to a remote repo, but identify the repo locally under a user-provided alias (e.g. myrepo).
--force If true, ignores if the subnet has been published in the past, and attempts a forced publish.
-h, --help help for publish
--no-repo-path string Do not let the tool manage file publishing, but have it only generate the files and put them in the location given by this flag.
--repo-url string The URL of the repo where we are publishing
--subnet-file-path string Path to the Subnet description file. If not given, a prompting sequence will be initiated.
--vm-file-path string Path to the VM description file. If not given, a prompting sequence will be initiated.
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### removeValidator
The blockchain removeValidator command stops a whitelisted, subnet network validator from
validating your deployed Blockchain.
To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass
these prompts by providing the values with flags.
**Usage:**
```bash
avalanche blockchain removeValidator [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true)
--aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation
--aggregator-log-level string log level to use with signature aggregator (default "Off")
--blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's removal (blockchain gas token)
--blockchain-key string CLI stored key to use to pay fees for completing the validator's removal (blockchain gas token)
--blockchain-private-key string private key to use to pay fees for completing the validator's removal (blockchain gas token)
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force force validator removal even if it's not getting rewarded
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for removeValidator
-k, --key string select the key to use [fuji deploy only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-endpoint string remove validator that responds to the given endpoint
--node-id string node-id of the validator
--output-tx-path string (for non-SOV blockchain only) file path of the removeValidator tx
--rpc string connect to validator manager at the given rpc endpoint
--subnet-auth-keys strings (for non-SOV blockchain only) control keys that will be used to authenticate the removeValidator tx
-t, --testnet fuji operate on testnet (alias to fuji)
--uptime uint validator's uptime in seconds. If not provided, it will be automatically calculated
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### stats
The blockchain stats command prints validator statistics for the given Blockchain.
**Usage:**
```bash
avalanche blockchain stats [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for stats
-l, --local operate on a local network
-m, --mainnet operate on mainnet
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### upgrade
The blockchain upgrade command suite provides a collection of tools for
updating your developmental and deployed Blockchains.
**Usage:**
```bash
avalanche blockchain upgrade [subcommand] [flags]
```
**Subcommands:**
- [`apply`](#avalanche-blockchain-upgrade-apply): Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade.
For public networks (Fuji Testnet or Mainnet), to complete this process,
you must have access to the machine running your validator.
If the CLI is running on the same machine as your validator, it can manipulate your node's
configuration automatically. Alternatively, the command can print the necessary instructions
to upgrade your node manually.
After you update your validator's configuration, you need to restart your validator manually.
If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path.
Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation.
- [`export`](#avalanche-blockchain-upgrade-export): Export the upgrade bytes file to a location of choice on disk
- [`generate`](#avalanche-blockchain-upgrade-generate): The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It
guides the user through the process using an interactive wizard.
- [`import`](#avalanche-blockchain-upgrade-import): Import the upgrade bytes file into the local environment
- [`print`](#avalanche-blockchain-upgrade-print): Print the upgrade.json file content
- [`vm`](#avalanche-blockchain-upgrade-vm): The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command
can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet.
The command walks the user through an interactive wizard. The user can skip the wizard by providing
command line flags.
**Flags:**
```bash
-h, --help help for upgrade
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade apply
Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade.
For public networks (Fuji Testnet or Mainnet), to complete this process,
you must have access to the machine running your validator.
If the CLI is running on the same machine as your validator, it can manipulate your node's
configuration automatically. Alternatively, the command can print the necessary instructions
to upgrade your node manually.
After you update your validator's configuration, you need to restart your validator manually.
If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path.
Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation.
**Usage:**
```bash
avalanche blockchain upgrade apply [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-chain-config-dir string avalanchego's chain config file directory (default "/Users/owen.wahlgren/.avalanchego/chains")
--config create upgrade config for future subnet deployments (same as generate)
--force If true, don't prompt for confirmation of timestamps in the past
--fuji fuji apply upgrade existing fuji deployment (alias for `testnet`)
-h, --help help for apply
--local local apply upgrade existing local deployment
--mainnet mainnet apply upgrade existing mainnet deployment
--print if true, print the manual config without prompting (for public networks only)
--testnet testnet apply upgrade existing testnet deployment (alias for `fuji`)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade export
Export the upgrade bytes file to a location of choice on disk
**Usage:**
```bash
avalanche blockchain upgrade export [subcommand] [flags]
```
**Flags:**
```bash
--force If true, overwrite a possibly existing file without prompting
-h, --help help for export
--upgrade-filepath string Export upgrade bytes file to location of choice on disk
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade generate
The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It
guides the user through the process using an interactive wizard.
**Usage:**
```bash
avalanche blockchain upgrade generate [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for generate
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade import
Import the upgrade bytes file into the local environment
**Usage:**
```bash
avalanche blockchain upgrade import [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for import
--upgrade-filepath string Import upgrade bytes file into local environment
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade print
Print the upgrade.json file content
**Usage:**
```bash
avalanche blockchain upgrade print [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for print
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade vm
The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command
can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet.
The command walks the user through an interactive wizard. The user can skip the wizard by providing
command line flags.
**Usage:**
```bash
avalanche blockchain upgrade vm [subcommand] [flags]
```
**Flags:**
```bash
--binary string Upgrade to custom binary
--config upgrade config for future subnet deployments
--fuji fuji upgrade existing fuji deployment (alias for `testnet`)
-h, --help help for vm
--latest upgrade to latest version
--local local upgrade existing local deployment
--mainnet mainnet upgrade existing mainnet deployment
--plugin-dir string plugin directory to automatically upgrade VM
--print print instructions for upgrading
--testnet testnet upgrade existing testnet deployment (alias for `fuji`)
--version string Upgrade to custom version
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### validators
The blockchain validators command lists the validators of a blockchain's subnet and provides
several statistics about them.
**Usage:**
```bash
avalanche blockchain validators [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for validators
-l, --local operate on a local network
-m, --mainnet operate on mainnet
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### vmid
The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain.
**Usage:**
```bash
avalanche blockchain vmid [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for vmid
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche config
Customize configuration for Avalanche-CLI
**Usage:**
```bash
avalanche config [subcommand] [flags]
```
**Subcommands:**
- [`authorize-cloud-access`](#avalanche-config-authorize-cloud-access): set preferences to authorize access to cloud resources
- [`metrics`](#avalanche-config-metrics): set user metrics collection preferences
- [`migrate`](#avalanche-config-migrate): migrate command migrates old ~/.avalanche-cli.json and ~/.avalanche-cli/config to /.avalanche-cli/config.json..
- [`snapshotsAutoSave`](#avalanche-config-snapshotsautosave): set user preference between auto saving local network snapshots or not
- [`update`](#avalanche-config-update): set user preference between update check or not
**Flags:**
```bash
-h, --help help for config
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### authorize-cloud-access
set preferences to authorize access to cloud resources
**Usage:**
```bash
avalanche config authorize-cloud-access [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for authorize-cloud-access
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### metrics
set user metrics collection preferences
**Usage:**
```bash
avalanche config metrics [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for metrics
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### migrate
migrate command migrates old ~/.avalanche-cli.json and ~/.avalanche-cli/config to /.avalanche-cli/config.json..
**Usage:**
```bash
avalanche config migrate [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for migrate
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### snapshotsAutoSave
set user preference between auto saving local network snapshots or not
**Usage:**
```bash
avalanche config snapshotsAutoSave [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for snapshotsAutoSave
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### update
set user preference between update check or not
**Usage:**
```bash
avalanche config update [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for update
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche contract
The contract command suite provides a collection of tools for deploying
and interacting with smart contracts.
**Usage:**
```bash
avalanche contract [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-contract-deploy): The contract command suite provides a collection of tools for deploying
smart contracts.
- [`initValidatorManager`](#avalanche-contract-initvalidatormanager): Initializes Proof of Authority(PoA) or Proof of Stake(PoS)Validator Manager contract on a Blockchain and sets up initial validator set on the Blockchain. For more info on Validator Manager, please head to https://github.com/ava-labs/icm-contracts/tree/main/contracts/validator-manager
**Flags:**
```bash
-h, --help help for contract
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### deploy
The contract command suite provides a collection of tools for deploying
smart contracts.
**Usage:**
```bash
avalanche contract deploy [subcommand] [flags]
```
**Subcommands:**
- [`erc20`](#avalanche-contract-deploy-erc20): Deploy an ERC20 token into a given Network and Blockchain
**Flags:**
```bash
-h, --help help for deploy
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### deploy erc20
Deploy an ERC20 token into a given Network and Blockchain
**Usage:**
```bash
avalanche contract deploy erc20 [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string deploy the ERC20 contract into the given CLI blockchain
--blockchain-id string deploy the ERC20 contract into the given blockchain ID/Alias
--c-chain deploy the ERC20 contract into C-Chain
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--funded string set the funded address
--genesis-key use genesis allocated key as contract deployer
-h, --help help for erc20
--key string CLI stored key to use as contract deployer
-l, --local operate on a local network
--private-key string private key to use as contract deployer
--rpc string deploy the contract into the given rpc endpoint
--supply uint set the token supply
--symbol string set the token symbol
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### initValidatorManager
Initializes Proof of Authority(PoA) or Proof of Stake(PoS)Validator Manager contract on a Blockchain and sets up initial validator set on the Blockchain. For more info on Validator Manager, please head to https://github.com/ava-labs/icm-contracts/tree/main/contracts/validator-manager
**Usage:**
```bash
avalanche contract initValidatorManager [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true)
--aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation
--aggregator-log-level string log level to use with signature aggregator (default "Off")
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key as contract deployer
-h, --help help for initValidatorManager
--key string CLI stored key to use as contract deployer
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--pos-maximum-stake-amount uint (PoS only) maximum stake amount (default 1000)
--pos-maximum-stake-multiplier uint8 (PoS only )maximum stake multiplier (default 1)
--pos-minimum-delegation-fee uint16 (PoS only) minimum delegation fee (default 1)
--pos-minimum-stake-amount uint (PoS only) minimum stake amount (default 1)
--pos-minimum-stake-duration uint (PoS only) minimum stake duration (default 100)
--pos-reward-calculator-address string (PoS only) initialize the ValidatorManager with reward calculator address
--pos-weight-to-value-factor uint (PoS only) weight to value factor (default 1)
--private-key string private key to use as contract deployer
--rpc string deploy the contract into the given rpc endpoint
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche help
Help provides help for any command in the application.
Simply type avalanche help [path to command] for full details.
**Usage:**
```bash
avalanche help [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for help
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche icm
The messenger command suite provides a collection of tools for interacting
with ICM messenger contracts.
**Usage:**
```bash
avalanche icm [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-icm-deploy): Deploys ICM Messenger and Registry into a given L1.
- [`sendMsg`](#avalanche-icm-sendmsg): Sends and wait reception for a ICM msg between two subnets.
**Flags:**
```bash
-h, --help help for icm
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### deploy
Deploys ICM Messenger and Registry into a given L1.
**Usage:**
```bash
avalanche icm deploy [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string deploy ICM into the given CLI blockchain
--blockchain-id string deploy ICM into the given blockchain ID/Alias
--c-chain deploy ICM into C-Chain
--cchain-key string key to be used to pay fees to deploy ICM to C-Chain
--cluster string operate on the given cluster
--deploy-messenger deploy ICM Messenger (default true)
--deploy-registry deploy ICM Registry (default true)
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force-registry-deploy deploy ICM Registry even if Messenger has already been deployed
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key to fund ICM deploy
-h, --help help for deploy
--include-cchain deploy ICM also to C-Chain
--key string CLI stored key to use to fund ICM deploy
-l, --local operate on a local network
--messenger-contract-address-path string path to a messenger contract address file
--messenger-deployer-address-path string path to a messenger deployer address file
--messenger-deployer-tx-path string path to a messenger deployer tx file
--private-key string private key to use to fund ICM deploy
--registry-bytecode-path string path to a registry bytecode file
--rpc-url string use the given RPC URL to connect to the subnet
-t, --testnet fuji operate on testnet (alias to fuji)
--version string version to deploy (default "latest")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### sendMsg
Sends and wait reception for a ICM msg between two subnets.
**Usage:**
```bash
avalanche icm sendMsg [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--dest-rpc string use the given destination blockchain rpc endpoint
--destination-address string deliver the message to the given contract destination address
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key as message originator and to pay source blockchain fees
-h, --help help for sendMsg
--hex-encoded given message is hex encoded
--key string CLI stored key to use as message originator and to pay source blockchain fees
-l, --local operate on a local network
--private-key string private key to use as message originator and to pay source blockchain fees
--source-rpc string use the given source blockchain rpc endpoint
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche ictt
The ictt command suite provides tools to deploy and manage Interchain Token Transferrers.
**Usage:**
```bash
avalanche ictt [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-ictt-deploy): Deploys a Token Transferrer into a given Network and Subnets
**Flags:**
```bash
-h, --help help for ictt
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### deploy
Deploys a Token Transferrer into a given Network and Subnets
**Usage:**
```bash
avalanche ictt deploy [subcommand] [flags]
```
**Flags:**
```bash
--c-chain-home set the Transferrer's Home Chain into C-Chain
--c-chain-remote set the Transferrer's Remote Chain into C-Chain
--cluster string operate on the given cluster
--deploy-erc20-home string deploy a Transferrer Home for the given Chain's ERC20 Token
--deploy-native-home deploy a Transferrer Home for the Chain's Native Token
--deploy-native-remote deploy a Transferrer Remote for the Chain's Native Token
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for deploy
--home-blockchain string set the Transferrer's Home Chain into the given CLI blockchain
--home-genesis-key use genesis allocated key to deploy Transferrer Home
--home-key string CLI stored key to use to deploy Transferrer Home
--home-private-key string private key to use to deploy Transferrer Home
--home-rpc string use the given RPC URL to connect to the home blockchain
-l, --local operate on a local network
--remote-blockchain string set the Transferrer's Remote Chain into the given CLI blockchain
--remote-genesis-key use genesis allocated key to deploy Transferrer Remote
--remote-key string CLI stored key to use to deploy Transferrer Remote
--remote-private-key string private key to use to deploy Transferrer Remote
--remote-rpc string use the given RPC URL to connect to the remote blockchain
--remote-token-decimals uint8 use the given number of token decimals for the Transferrer Remote [defaults to token home's decimals (18 for a new wrapped native home token)]
--remove-minter-admin remove the native minter precompile admin found on remote blockchain genesis
-t, --testnet fuji operate on testnet (alias to fuji)
--use-home string use the given Transferrer's Home Address
--version string tag/branch/commit of Avalanche Interchain Token Transfer (ICTT) to be used (defaults to main branch)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche interchain
The interchain command suite provides a collection of tools to
set and manage interoperability between blockchains.
**Usage:**
```bash
avalanche interchain [subcommand] [flags]
```
**Subcommands:**
- [`messenger`](#avalanche-interchain-messenger): The messenger command suite provides a collection of tools for interacting
with ICM messenger contracts.
- [`relayer`](#avalanche-interchain-relayer): The relayer command suite provides a collection of tools for deploying
and configuring an ICM relayers.
- [`tokenTransferrer`](#avalanche-interchain-tokentransferrer): The tokenTransfer command suite provides tools to deploy and manage Token Transferrers.
**Flags:**
```bash
-h, --help help for interchain
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### messenger
The messenger command suite provides a collection of tools for interacting
with ICM messenger contracts.
**Usage:**
```bash
avalanche interchain messenger [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-interchain-messenger-deploy): Deploys ICM Messenger and Registry into a given L1.
- [`sendMsg`](#avalanche-interchain-messenger-sendmsg): Sends and wait reception for a ICM msg between two subnets.
**Flags:**
```bash
-h, --help help for messenger
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### messenger deploy
Deploys ICM Messenger and Registry into a given L1.
**Usage:**
```bash
avalanche interchain messenger deploy [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string deploy ICM into the given CLI blockchain
--blockchain-id string deploy ICM into the given blockchain ID/Alias
--c-chain deploy ICM into C-Chain
--cchain-key string key to be used to pay fees to deploy ICM to C-Chain
--cluster string operate on the given cluster
--deploy-messenger deploy ICM Messenger (default true)
--deploy-registry deploy ICM Registry (default true)
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force-registry-deploy deploy ICM Registry even if Messenger has already been deployed
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key to fund ICM deploy
-h, --help help for deploy
--include-cchain deploy ICM also to C-Chain
--key string CLI stored key to use to fund ICM deploy
-l, --local operate on a local network
--messenger-contract-address-path string path to a messenger contract address file
--messenger-deployer-address-path string path to a messenger deployer address file
--messenger-deployer-tx-path string path to a messenger deployer tx file
--private-key string private key to use to fund ICM deploy
--registry-bytecode-path string path to a registry bytecode file
--rpc-url string use the given RPC URL to connect to the subnet
-t, --testnet fuji operate on testnet (alias to fuji)
--version string version to deploy (default "latest")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### messenger sendMsg
Sends and wait reception for a ICM msg between two subnets.
**Usage:**
```bash
avalanche interchain messenger sendMsg [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--dest-rpc string use the given destination blockchain rpc endpoint
--destination-address string deliver the message to the given contract destination address
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key as message originator and to pay source blockchain fees
-h, --help help for sendMsg
--hex-encoded given message is hex encoded
--key string CLI stored key to use as message originator and to pay source blockchain fees
-l, --local operate on a local network
--private-key string private key to use as message originator and to pay source blockchain fees
--source-rpc string use the given source blockchain rpc endpoint
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### relayer
The relayer command suite provides a collection of tools for deploying
and configuring an ICM relayers.
**Usage:**
```bash
avalanche interchain relayer [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-interchain-relayer-deploy): Deploys an ICM Relayer for the given Network.
- [`logs`](#avalanche-interchain-relayer-logs): Shows pretty formatted AWM relayer logs
- [`start`](#avalanche-interchain-relayer-start): Starts AWM relayer on the specified network (Currently only for local network).
- [`stop`](#avalanche-interchain-relayer-stop): Stops AWM relayer on the specified network (Currently only for local network, cluster).
**Flags:**
```bash
-h, --help help for relayer
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### relayer deploy
Deploys an ICM Relayer for the given Network.
**Usage:**
```bash
avalanche interchain relayer deploy [subcommand] [flags]
```
**Flags:**
```bash
--allow-private-ips allow relayer to connec to private ips (default true)
--amount float automatically fund l1s fee payments with the given amount
--bin-path string use the given relayer binary
--blockchain-funding-key string key to be used to fund relayer account on all l1s
--blockchains strings blockchains to relay as source and destination
--cchain relay C-Chain as source and destination
--cchain-amount float automatically fund cchain fee payments with the given amount
--cchain-funding-key string key to be used to fund relayer account on cchain
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for deploy
--key string key to be used by default both for rewards and to pay fees
-l, --local operate on a local network
--log-level string log level to use for relayer logs
-t, --testnet fuji operate on testnet (alias to fuji)
--version string version to deploy (default "latest-prerelease")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--skip-update-check skip check for new versions
```
#### relayer logs
Shows pretty formatted AWM relayer logs
**Usage:**
```bash
avalanche interchain relayer logs [subcommand] [flags]
```
**Flags:**
```bash
--endpoint string use the given endpoint for network operations
--first uint output first N log lines
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for logs
--last uint output last N log lines
-l, --local operate on a local network
--raw raw logs output
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### relayer start
Starts AWM relayer on the specified network (Currently only for local network).
**Usage:**
```bash
avalanche interchain relayer start [subcommand] [flags]
```
**Flags:**
```bash
--bin-path string use the given relayer binary
--cluster string operate on the given cluster
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for start
-l, --local operate on a local network
-t, --testnet fuji operate on testnet (alias to fuji)
--version string version to use (default "latest-prerelease")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### relayer stop
Stops AWM relayer on the specified network (Currently only for local network, cluster).
**Usage:**
```bash
avalanche interchain relayer stop [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for stop
-l, --local operate on a local network
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### tokenTransferrer
The tokenTransfer command suite provides tools to deploy and manage Token Transferrers.
**Usage:**
```bash
avalanche interchain tokenTransferrer [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-interchain-tokentransferrer-deploy): Deploys a Token Transferrer into a given Network and Subnets
**Flags:**
```bash
-h, --help help for tokenTransferrer
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### tokenTransferrer deploy
Deploys a Token Transferrer into a given Network and Subnets
**Usage:**
```bash
avalanche interchain tokenTransferrer deploy [subcommand] [flags]
```
**Flags:**
```bash
--c-chain-home set the Transferrer's Home Chain into C-Chain
--c-chain-remote set the Transferrer's Remote Chain into C-Chain
--cluster string operate on the given cluster
--deploy-erc20-home string deploy a Transferrer Home for the given Chain's ERC20 Token
--deploy-native-home deploy a Transferrer Home for the Chain's Native Token
--deploy-native-remote deploy a Transferrer Remote for the Chain's Native Token
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for deploy
--home-blockchain string set the Transferrer's Home Chain into the given CLI blockchain
--home-genesis-key use genesis allocated key to deploy Transferrer Home
--home-key string CLI stored key to use to deploy Transferrer Home
--home-private-key string private key to use to deploy Transferrer Home
--home-rpc string use the given RPC URL to connect to the home blockchain
-l, --local operate on a local network
--remote-blockchain string set the Transferrer's Remote Chain into the given CLI blockchain
--remote-genesis-key use genesis allocated key to deploy Transferrer Remote
--remote-key string CLI stored key to use to deploy Transferrer Remote
--remote-private-key string private key to use to deploy Transferrer Remote
--remote-rpc string use the given RPC URL to connect to the remote blockchain
--remote-token-decimals uint8 use the given number of token decimals for the Transferrer Remote [defaults to token home's decimals (18 for a new wrapped native home token)]
--remove-minter-admin remove the native minter precompile admin found on remote blockchain genesis
-t, --testnet fuji operate on testnet (alias to fuji)
--use-home string use the given Transferrer's Home Address
--version string tag/branch/commit of Avalanche Interchain Token Transfer (ICTT) to be used (defaults to main branch)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche key
The key command suite provides a collection of tools for creating and managing
signing keys. You can use these keys to deploy Subnets to the Fuji Testnet,
but these keys are NOT suitable to use in production environments. DO NOT use
these keys on Mainnet.
To get started, use the key create command.
**Usage:**
```bash
avalanche key [subcommand] [flags]
```
**Subcommands:**
- [`create`](#avalanche-key-create): The key create command generates a new private key to use for creating and controlling
test Subnets. Keys generated by this command are NOT cryptographically secure enough to
use in production environments. DO NOT use these keys on Mainnet.
The command works by generating a secp256 key and storing it with the provided keyName. You
can use this key in other commands by providing this keyName.
If you'd like to import an existing key instead of generating one from scratch, provide the
--file flag.
- [`delete`](#avalanche-key-delete): The key delete command deletes an existing signing key.
To delete a key, provide the keyName. The command prompts for confirmation
before deleting the key. To skip the confirmation, provide the --force flag.
- [`export`](#avalanche-key-export): The key export command exports a created signing key. You can use an exported key in other
applications or import it into another instance of Avalanche-CLI.
By default, the tool writes the hex encoded key to stdout. If you provide the --output
flag, the command writes the key to a file of your choosing.
- [`list`](#avalanche-key-list): The key list command prints information for all stored signing
keys or for the ledger addresses associated to certain indices.
- [`transfer`](#avalanche-key-transfer): The key transfer command allows to transfer funds between stored keys or ledger addresses.
**Flags:**
```bash
-h, --help help for key
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### create
The key create command generates a new private key to use for creating and controlling
test Subnets. Keys generated by this command are NOT cryptographically secure enough to
use in production environments. DO NOT use these keys on Mainnet.
The command works by generating a secp256 key and storing it with the provided keyName. You
can use this key in other commands by providing this keyName.
If you'd like to import an existing key instead of generating one from scratch, provide the
--file flag.
**Usage:**
```bash
avalanche key create [subcommand] [flags]
```
**Flags:**
```bash
--file string import the key from an existing key file
-f, --force overwrite an existing key with the same name
-h, --help help for create
--skip-balances do not query public network balances for an imported key
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### delete
The key delete command deletes an existing signing key.
To delete a key, provide the keyName. The command prompts for confirmation
before deleting the key. To skip the confirmation, provide the --force flag.
**Usage:**
```bash
avalanche key delete [subcommand] [flags]
```
**Flags:**
```bash
-f, --force delete the key without confirmation
-h, --help help for delete
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### export
The key export command exports a created signing key. You can use an exported key in other
applications or import it into another instance of Avalanche-CLI.
By default, the tool writes the hex encoded key to stdout. If you provide the --output
flag, the command writes the key to a file of your choosing.
**Usage:**
```bash
avalanche key export [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for export
-o, --output string write the key to the provided file path
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### list
The key list command prints information for all stored signing
keys or for the ledger addresses associated to certain indices.
**Usage:**
```bash
avalanche key list [subcommand] [flags]
```
**Flags:**
```bash
-a, --all-networks list all network addresses
--blockchains strings blockchains to show information about (p=p-chain, x=x-chain, c=c-chain, and blockchain names) (default p,x,c)
-c, --cchain list C-Chain addresses (default true)
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for list
--keys strings list addresses for the given keys
-g, --ledger uints list ledger addresses for the given indices (default [])
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--pchain list P-Chain addresses (default true)
--subnets strings subnets to show information about (p=p-chain, x=x-chain, c=c-chain, and subnet names) (default p,x,c)
-t, --testnet fuji operate on testnet (alias to fuji)
--tokens strings provide balance information for the given token contract addresses (Evm only) (default [Native])
--use-gwei use gwei for EVM balances
-n, --use-nano-avax use nano Avax for balances
--xchain list X-Chain addresses (default true)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### transfer
The key transfer command allows to transfer funds between stored keys or ledger addresses.
**Usage:**
```bash
avalanche key transfer [subcommand] [flags]
```
**Flags:**
```bash
-o, --amount float amount to send or receive (AVAX or TOKEN units)
--c-chain-receiver receive at C-Chain
--c-chain-sender send from C-Chain
--cluster string operate on the given cluster
-a, --destination-addr string destination address
--destination-key string key associated to a destination address
--destination-subnet string subnet where the funds will be sent (token transferrer experimental)
--destination-transferrer-address string token transferrer address at the destination subnet (token transferrer experimental)
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for transfer
-k, --key string key associated to the sender or receiver address
-i, --ledger uint32 ledger index associated to the sender or receiver address (default 32768)
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--origin-subnet string subnet where the funds belong (token transferrer experimental)
--origin-transferrer-address string token transferrer address at the origin subnet (token transferrer experimental)
--p-chain-receiver receive at P-Chain
--p-chain-sender send from P-Chain
--receiver-blockchain string receive at the given CLI blockchain
--receiver-blockchain-id string receive at the given blockchain ID/Alias
--sender-blockchain string send from the given CLI blockchain
--sender-blockchain-id string send from the given blockchain ID/Alias
-t, --testnet fuji operate on testnet (alias to fuji)
--x-chain-receiver receive at X-Chain
--x-chain-sender send from X-Chain
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche network
The network command suite provides a collection of tools for managing local Subnet
deployments.
When you deploy a Subnet locally, it runs on a local, multi-node Avalanche network. The
subnet deploy command starts this network in the background. This command suite allows you
to shutdown, restart, and clear that network.
This network currently supports multiple, concurrently deployed Subnets.
**Usage:**
```bash
avalanche network [subcommand] [flags]
```
**Subcommands:**
- [`clean`](#avalanche-network-clean): The network clean command shuts down your local, multi-node network. All deployed Subnets
shutdown and delete their state. You can restart the network by deploying a new Subnet
configuration.
- [`start`](#avalanche-network-start): The network start command starts a local, multi-node Avalanche network on your machine.
By default, the command loads the default snapshot. If you provide the --snapshot-name
flag, the network loads that snapshot instead. The command fails if the local network is
already running.
- [`status`](#avalanche-network-status): The network status command prints whether or not a local Avalanche
network is running and some basic stats about the network.
- [`stop`](#avalanche-network-stop): The network stop command shuts down your local, multi-node network.
All deployed Subnets shutdown gracefully and save their state. If you provide the
--snapshot-name flag, the network saves its state under this named snapshot. You can
reload this snapshot with network start --snapshot-name `snapshotName`. Otherwise, the
network saves to the default snapshot, overwriting any existing state. You can reload the
default snapshot with network start.
**Flags:**
```bash
-h, --help help for network
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### clean
The network clean command shuts down your local, multi-node network. All deployed Subnets
shutdown and delete their state. You can restart the network by deploying a new Subnet
configuration.
**Usage:**
```bash
avalanche network clean [subcommand] [flags]
```
**Flags:**
```bash
--hard Also clean downloaded avalanchego and plugin binaries
-h, --help help for clean
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### start
The network start command starts a local, multi-node Avalanche network on your machine.
By default, the command loads the default snapshot. If you provide the --snapshot-name
flag, the network loads that snapshot instead. The command fails if the local network is
already running.
**Usage:**
```bash
avalanche network start [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-path string use this avalanchego binary path
--avalanchego-version string use this version of avalanchego (ex: v1.17.12) (default "latest-prerelease")
-h, --help help for start
--num-nodes uint32 number of nodes to be created on local network (default 2)
--relayer-path string use this relayer binary path
--relayer-version string use this relayer version (default "latest-prerelease")
--snapshot-name string name of snapshot to use to start the network from (default "default-1654102509")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### status
The network status command prints whether or not a local Avalanche
network is running and some basic stats about the network.
**Usage:**
```bash
avalanche network status [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for status
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### stop
The network stop command shuts down your local, multi-node network.
All deployed Subnets shutdown gracefully and save their state. If you provide the
--snapshot-name flag, the network saves its state under this named snapshot. You can
reload this snapshot with network start --snapshot-name `snapshotName`. Otherwise, the
network saves to the default snapshot, overwriting any existing state. You can reload the
default snapshot with network start.
**Usage:**
```bash
avalanche network stop [subcommand] [flags]
```
**Flags:**
```bash
--dont-save do not save snapshot, just stop the network
-h, --help help for stop
--snapshot-name string name of snapshot to use to save network state into (default "default-1654102509")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche node
The node command suite provides a collection of tools for creating and maintaining
validators on Avalanche Network.
To get started, use the node create command wizard to walk through the
configuration to make your node a primary validator on Avalanche public network. You can use the
rest of the commands to maintain your node and make your node a Subnet Validator.
**Usage:**
```bash
avalanche node [subcommand] [flags]
```
**Subcommands:**
- [`addDashboard`](#avalanche-node-adddashboard): (ALPHA Warning) This command is currently in experimental mode.
The node addDashboard command adds custom dashboard to the Grafana monitoring dashboard for the
cluster.
- [`create`](#avalanche-node-create): (ALPHA Warning) This command is currently in experimental mode.
The node create command sets up a validator on a cloud server of your choice.
The validator will be validating the Avalanche Primary Network and Subnet
of your choice. By default, the command runs an interactive wizard. It
walks you through all the steps you need to set up a validator.
Once this command is completed, you will have to wait for the validator
to finish bootstrapping on the primary network before running further
commands on it, e.g. validating a Subnet. You can check the bootstrapping
status by running avalanche node status
The created node will be part of group of validators called `clusterName`
and users can call node commands with `clusterName` so that the command
will apply to all nodes in the cluster
- [`destroy`](#avalanche-node-destroy): (ALPHA Warning) This command is currently in experimental mode.
The node destroy command terminates all running nodes in cloud server and deletes all storage disks.
If there is a static IP address attached, it will be released.
- [`devnet`](#avalanche-node-devnet): (ALPHA Warning) This command is currently in experimental mode.
The node devnet command suite provides a collection of commands related to devnets.
You can check the updated status by calling avalanche node status `clusterName`
- [`export`](#avalanche-node-export): (ALPHA Warning) This command is currently in experimental mode.
The node export command exports cluster configuration and its nodes config to a text file.
If no file is specified, the configuration is printed to the stdout.
Use --include-secrets to include keys in the export. In this case please keep the file secure as it contains sensitive information.
Exported cluster configuration without secrets can be imported by another user using node import command.
- [`import`](#avalanche-node-import): (ALPHA Warning) This command is currently in experimental mode.
The node import command imports cluster configuration and its nodes configuration from a text file
created from the node export command.
Prior to calling this command, call node whitelist command to have your SSH public key and IP whitelisted by
the cluster owner. This will enable you to use avalanche-cli commands to manage the imported cluster.
Please note, that this imported cluster will be considered as EXTERNAL by avalanche-cli, so some commands
affecting cloud nodes like node create or node destroy will be not applicable to it.
- [`list`](#avalanche-node-list): (ALPHA Warning) This command is currently in experimental mode.
The node list command lists all clusters together with their nodes.
- [`loadtest`](#avalanche-node-loadtest): (ALPHA Warning) This command is currently in experimental mode.
The node loadtest command suite starts and stops a load test for an existing devnet cluster.
- [`local`](#avalanche-node-local): (ALPHA Warning) This command is currently in experimental mode.
The node local command suite provides a collection of commands related to local nodes
- [`refresh-ips`](#avalanche-node-refresh-ips): (ALPHA Warning) This command is currently in experimental mode.
The node refresh-ips command obtains the current IP for all nodes with dynamic IPs in the cluster,
and updates the local node information used by CLI commands.
- [`resize`](#avalanche-node-resize): (ALPHA Warning) This command is currently in experimental mode.
The node resize command can change the amount of CPU, memory and disk space available for the cluster nodes.
- [`scp`](#avalanche-node-scp): (ALPHA Warning) This command is currently in experimental mode.
The node scp command securely copies files to and from nodes. Remote source or destionation can be specified using the following format:
[clusterName|nodeID|instanceID|IP]:/path/to/file. Regular expressions are supported for the source files like /tmp/*.txt.
File transfer to the nodes are parallelized. IF source or destination is cluster, the other should be a local file path.
If both destinations are remote, they must be nodes for the same cluster and not clusters themselves.
For example:
$ avalanche node scp [cluster1|node1]:/tmp/file.txt /tmp/file.txt
$ avalanche node scp /tmp/file.txt [cluster1|NodeID-XXXX]:/tmp/file.txt
$ avalanche node scp node1:/tmp/file.txt NodeID-XXXX:/tmp/file.txt
- [`ssh`](#avalanche-node-ssh): (ALPHA Warning) This command is currently in experimental mode.
The node ssh command execute a given command [cmd] using ssh on all nodes in the cluster if ClusterName is given.
If no command is given, just prints the ssh command to be used to connect to each node in the cluster.
For provided NodeID or InstanceID or IP, the command [cmd] will be executed on that node.
If no [cmd] is provided for the node, it will open ssh shell there.
- [`status`](#avalanche-node-status): (ALPHA Warning) This command is currently in experimental mode.
The node status command gets the bootstrap status of all nodes in a cluster with the Primary Network.
If no cluster is given, defaults to node list behaviour.
To get the bootstrap status of a node with a Blockchain, use --blockchain flag
- [`sync`](#avalanche-node-sync): (ALPHA Warning) This command is currently in experimental mode.
The node sync command enables all nodes in a cluster to be bootstrapped to a Blockchain.
You can check the blockchain bootstrap status by calling avalanche node status `clusterName` --blockchain `blockchainName`
- [`update`](#avalanche-node-update): (ALPHA Warning) This command is currently in experimental mode.
The node update command suite provides a collection of commands for nodes to update
their avalanchego or VM config.
You can check the status after update by calling avalanche node status
- [`upgrade`](#avalanche-node-upgrade): (ALPHA Warning) This command is currently in experimental mode.
The node update command suite provides a collection of commands for nodes to update
their avalanchego or VM version.
You can check the status after upgrade by calling avalanche node status
- [`validate`](#avalanche-node-validate): (ALPHA Warning) This command is currently in experimental mode.
The node validate command suite provides a collection of commands for nodes to join
the Primary Network and Subnets as validators.
If any of the commands is run before the nodes are bootstrapped on the Primary Network, the command
will fail. You can check the bootstrap status by calling avalanche node status `clusterName`
- [`whitelist`](#avalanche-node-whitelist): (ALPHA Warning) The whitelist command suite provides a collection of tools for granting access to the cluster.
Command adds IP if --ip params provided to cloud security access rules allowing it to access all nodes in the cluster via ssh or http.
It also command adds SSH public key to all nodes in the cluster if --ssh params is there.
If no params provided it detects current user IP automaticaly and whitelists it
**Flags:**
```bash
-h, --help help for node
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### addDashboard
(ALPHA Warning) This command is currently in experimental mode.
The node addDashboard command adds custom dashboard to the Grafana monitoring dashboard for the
cluster.
**Usage:**
```bash
avalanche node addDashboard [subcommand] [flags]
```
**Flags:**
```bash
--add-grafana-dashboard string path to additional grafana dashboard json file
-h, --help help for addDashboard
--subnet string subnet that the dasbhoard is intended for (if any)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### create
(ALPHA Warning) This command is currently in experimental mode.
The node create command sets up a validator on a cloud server of your choice.
The validator will be validating the Avalanche Primary Network and Subnet
of your choice. By default, the command runs an interactive wizard. It
walks you through all the steps you need to set up a validator.
Once this command is completed, you will have to wait for the validator
to finish bootstrapping on the primary network before running further
commands on it, e.g. validating a Subnet. You can check the bootstrapping
status by running avalanche node status
The created node will be part of group of validators called `clusterName`
and users can call node commands with `clusterName` so that the command
will apply to all nodes in the cluster
**Usage:**
```bash
avalanche node create [subcommand] [flags]
```
**Flags:**
```bash
--add-grafana-dashboard string path to additional grafana dashboard json file
--alternative-key-pair-name string key pair name to use if default one generates conflicts
--authorize-access authorize CLI to create cloud resources
--auto-replace-keypair automatically replaces key pair to access node if previous key pair is not found
--avalanchego-version-from-subnet string install latest avalanchego version, that is compatible with the given subnet, on node/s
--aws create node/s in AWS cloud
--aws-profile string aws profile to use (default "default")
--aws-volume-iops int AWS iops (for gp3, io1, and io2 volume types only) (default 3000)
--aws-volume-size int AWS volume size in GB (default 1000)
--aws-volume-throughput int AWS throughput in MiB/s (for gp3 volume type only) (default 125)
--aws-volume-type string AWS volume type (default "gp3")
--bootstrap-ids stringArray nodeIDs of bootstrap nodes
--bootstrap-ips stringArray IP:port pairs of bootstrap nodes
--cluster string operate on the given cluster
--custom-avalanchego-version string install given avalanchego version on node/s
--devnet operate on a devnet network
--enable-monitoring set up Prometheus monitoring for created nodes. This option creates a separate monitoring cloud instance and incures additional cost
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--gcp create node/s in GCP cloud
--gcp-credentials string use given GCP credentials
--gcp-project string use given GCP project
--genesis string path to genesis file
--grafana-pkg string use grafana pkg instead of apt repo(by default), for example https://dl.grafana.com/oss/release/grafana_10.4.1_amd64.deb
-h, --help help for create
--latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s
--latest-avalanchego-version install latest avalanchego release version on node/s
-m, --mainnet operate on mainnet
--node-type string cloud instance type. Use 'default' to use recommended default instance type
--num-apis ints number of API nodes(nodes without stake) to create in the new Devnet
--num-validators ints number of nodes to create per region(s). Use comma to separate multiple numbers for each region in the same order as --region flag
--partial-sync primary network partial sync (default true)
--public-http-port allow public access to avalanchego HTTP port
--region strings create node(s) in given region(s). Use comma to separate multiple regions
--ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used
-t, --testnet fuji operate on testnet (alias to fuji)
--upgrade string path to upgrade file
--use-ssh-agent use ssh agent(ex: Yubikey) for ssh auth
--use-static-ip attach static Public IP on cloud servers (default true)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### destroy
(ALPHA Warning) This command is currently in experimental mode.
The node destroy command terminates all running nodes in cloud server and deletes all storage disks.
If there is a static IP address attached, it will be released.
**Usage:**
```bash
avalanche node destroy [subcommand] [flags]
```
**Flags:**
```bash
--all destroy all existing clusters created by Avalanche CLI
--authorize-access authorize CLI to release cloud resources
-y, --authorize-all authorize all CLI requests
--authorize-remove authorize CLI to remove all local files related to cloud nodes
--aws-profile string aws profile to use (default "default")
-h, --help help for destroy
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### devnet
(ALPHA Warning) This command is currently in experimental mode.
The node devnet command suite provides a collection of commands related to devnets.
You can check the updated status by calling avalanche node status `clusterName`
**Usage:**
```bash
avalanche node devnet [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-node-devnet-deploy): (ALPHA Warning) This command is currently in experimental mode.
The node devnet deploy command deploys a subnet into a devnet cluster, creating subnet and blockchain txs for it.
It saves the deploy info both locally and remotely.
- [`wiz`](#avalanche-node-devnet-wiz): (ALPHA Warning) This command is currently in experimental mode.
The node wiz command creates a devnet and deploys, sync and validate a subnet into it. It creates the subnet if so needed.
**Flags:**
```bash
-h, --help help for devnet
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### devnet deploy
(ALPHA Warning) This command is currently in experimental mode.
The node devnet deploy command deploys a subnet into a devnet cluster, creating subnet and blockchain txs for it.
It saves the deploy info both locally and remotely.
**Usage:**
```bash
avalanche node devnet deploy [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for deploy
--no-checks do not check for healthy status or rpc compatibility of nodes against subnet
--subnet-aliases strings additional subnet aliases to be used for RPC calls in addition to subnet blockchain name
--subnet-only only create a subnet
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### devnet wiz
(ALPHA Warning) This command is currently in experimental mode.
The node wiz command creates a devnet and deploys, sync and validate a subnet into it. It creates the subnet if so needed.
**Usage:**
```bash
avalanche node devnet wiz [subcommand] [flags]
```
**Flags:**
```bash
--add-grafana-dashboard string path to additional grafana dashboard json file
--alternative-key-pair-name string key pair name to use if default one generates conflicts
--authorize-access authorize CLI to create cloud resources
--auto-replace-keypair automatically replaces key pair to access node if previous key pair is not found
--aws create node/s in AWS cloud
--aws-profile string aws profile to use (default "default")
--aws-volume-iops int AWS iops (for gp3, io1, and io2 volume types only) (default 3000)
--aws-volume-size int AWS volume size in GB (default 1000)
--aws-volume-throughput int AWS throughput in MiB/s (for gp3 volume type only) (default 125)
--aws-volume-type string AWS volume type (default "gp3")
--chain-config string path to the chain configuration for subnet
--custom-avalanchego-version string install given avalanchego version on node/s
--custom-subnet use a custom VM as the subnet virtual machine
--custom-vm-branch string custom vm branch or commit
--custom-vm-build-script string custom vm build-script
--custom-vm-repo-url string custom vm repository url
--default-validator-params use default weight/start/duration params for subnet validator
--deploy-icm-messenger deploy Interchain Messenger (default true)
--deploy-icm-registry deploy Interchain Registry (default true)
--deploy-teleporter-messenger deploy Interchain Messenger (default true)
--deploy-teleporter-registry deploy Interchain Registry (default true)
--enable-monitoring set up Prometheus monitoring for created nodes. Please note that this option creates a separate monitoring instance and incures additional cost
--evm-chain-id uint chain ID to use with Subnet-EVM
--evm-defaults use default production settings with Subnet-EVM
--evm-production-defaults use default production settings for your blockchain
--evm-subnet use Subnet-EVM as the subnet virtual machine
--evm-test-defaults use default test settings for your blockchain
--evm-token string token name to use with Subnet-EVM
--evm-version string version of Subnet-EVM to use
--force-subnet-create overwrite the existing subnet configuration if one exists
--gcp create node/s in GCP cloud
--gcp-credentials string use given GCP credentials
--gcp-project string use given GCP project
--grafana-pkg string use grafana pkg instead of apt repo(by default), for example https://dl.grafana.com/oss/release/grafana_10.4.1_amd64.deb
-h, --help help for wiz
--icm generate an icm-ready vm
--icm-messenger-contract-address-path string path to an icm messenger contract address file
--icm-messenger-deployer-address-path string path to an icm messenger deployer address file
--icm-messenger-deployer-tx-path string path to an icm messenger deployer tx file
--icm-registry-bytecode-path string path to an icm registry bytecode file
--icm-version string icm version to deploy (default "latest")
--latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s
--latest-avalanchego-version install latest avalanchego release version on node/s
--latest-evm-version use latest Subnet-EVM released version
--latest-pre-released-evm-version use latest Subnet-EVM pre-released version
--node-config string path to avalanchego node configuration for subnet
--node-type string cloud instance type. Use 'default' to use recommended default instance type
--num-apis ints number of API nodes(nodes without stake) to create in the new Devnet
--num-validators ints number of nodes to create per region(s). Use comma to separate multiple numbers for each region in the same order as --region flag
--public-http-port allow public access to avalanchego HTTP port
--region strings create node/s in given region(s). Use comma to separate multiple regions
--relayer run AWM relayer when deploying the vm
--ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used.
--subnet-aliases strings additional subnet aliases to be used for RPC calls in addition to subnet blockchain name
--subnet-config string path to the subnet configuration for subnet
--subnet-genesis string file path of the subnet genesis
--teleporter generate an icm-ready vm
--teleporter-messenger-contract-address-path string path to an icm messenger contract address file
--teleporter-messenger-deployer-address-path string path to an icm messenger deployer address file
--teleporter-messenger-deployer-tx-path string path to an icm messenger deployer tx file
--teleporter-registry-bytecode-path string path to an icm registry bytecode file
--teleporter-version string icm version to deploy (default "latest")
--use-ssh-agent use ssh agent for ssh
--use-static-ip attach static Public IP on cloud servers (default true)
--validators strings deploy subnet into given comma separated list of validators. defaults to all cluster nodes
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### export
(ALPHA Warning) This command is currently in experimental mode.
The node export command exports cluster configuration and its nodes config to a text file.
If no file is specified, the configuration is printed to the stdout.
Use --include-secrets to include keys in the export. In this case please keep the file secure as it contains sensitive information.
Exported cluster configuration without secrets can be imported by another user using node import command.
**Usage:**
```bash
avalanche node export [subcommand] [flags]
```
**Flags:**
```bash
--file string specify the file to export the cluster configuration to
--force overwrite the file if it exists
-h, --help help for export
--include-secrets include keys in the export
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### import
(ALPHA Warning) This command is currently in experimental mode.
The node import command imports cluster configuration and its nodes configuration from a text file
created from the node export command.
Prior to calling this command, call node whitelist command to have your SSH public key and IP whitelisted by
the cluster owner. This will enable you to use avalanche-cli commands to manage the imported cluster.
Please note, that this imported cluster will be considered as EXTERNAL by avalanche-cli, so some commands
affecting cloud nodes like node create or node destroy will be not applicable to it.
**Usage:**
```bash
avalanche node import [subcommand] [flags]
```
**Flags:**
```bash
--file string specify the file to export the cluster configuration to
-h, --help help for import
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### list
(ALPHA Warning) This command is currently in experimental mode.
The node list command lists all clusters together with their nodes.
**Usage:**
```bash
avalanche node list [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for list
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### loadtest
(ALPHA Warning) This command is currently in experimental mode.
The node loadtest command suite starts and stops a load test for an existing devnet cluster.
**Usage:**
```bash
avalanche node loadtest [subcommand] [flags]
```
**Subcommands:**
- [`start`](#avalanche-node-loadtest-start): (ALPHA Warning) This command is currently in experimental mode.
The node loadtest command starts load testing for an existing devnet cluster. If the cluster does
not have an existing load test host, the command creates a separate cloud server and builds the load
test binary based on the provided load test Git Repo URL and load test binary build command.
The command will then run the load test binary based on the provided load test run command.
- [`stop`](#avalanche-node-loadtest-stop): (ALPHA Warning) This command is currently in experimental mode.
The node loadtest stop command stops load testing for an existing devnet cluster and terminates the
separate cloud server created to host the load test.
**Flags:**
```bash
-h, --help help for loadtest
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### loadtest start
(ALPHA Warning) This command is currently in experimental mode.
The node loadtest command starts load testing for an existing devnet cluster. If the cluster does
not have an existing load test host, the command creates a separate cloud server and builds the load
test binary based on the provided load test Git Repo URL and load test binary build command.
The command will then run the load test binary based on the provided load test run command.
**Usage:**
```bash
avalanche node loadtest start [subcommand] [flags]
```
**Flags:**
```bash
--authorize-access authorize CLI to create cloud resources
--aws create loadtest node in AWS cloud
--aws-profile string aws profile to use (default "default")
--gcp create loadtest in GCP cloud
-h, --help help for start
--load-test-branch string load test branch or commit
--load-test-build-cmd string command to build load test binary
--load-test-cmd string command to run load test
--load-test-repo string load test repo url to use
--node-type string cloud instance type for loadtest script
--region string create load test node in a given region
--ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used
--use-ssh-agent use ssh agent(ex: Yubikey) for ssh auth
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### loadtest stop
(ALPHA Warning) This command is currently in experimental mode.
The node loadtest stop command stops load testing for an existing devnet cluster and terminates the
separate cloud server created to host the load test.
**Usage:**
```bash
avalanche node loadtest stop [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for stop
--load-test strings stop specified load test node(s). Use comma to separate multiple load test instance names
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### local
(ALPHA Warning) This command is currently in experimental mode.
The node local command suite provides a collection of commands related to local nodes
**Usage:**
```bash
avalanche node local [subcommand] [flags]
```
**Subcommands:**
- [`destroy`](#avalanche-node-local-destroy): Cleanup local node.
- [`start`](#avalanche-node-local-start): (ALPHA Warning) This command is currently in experimental mode.
The node local start command sets up a validator on a local server.
The validator will be validating the Avalanche Primary Network and Subnet
of your choice. By default, the command runs an interactive wizard. It
walks you through all the steps you need to set up a validator.
Once this command is completed, you will have to wait for the validator
to finish bootstrapping on the primary network before running further
commands on it, e.g. validating a Subnet. You can check the bootstrapping
status by running avalanche node status local
- [`status`](#avalanche-node-local-status): Get status of local node.
- [`stop`](#avalanche-node-local-stop): Stop local node.
- [`track`](#avalanche-node-local-track): (ALPHA Warning) make the local node at the cluster to track given blockchain
**Flags:**
```bash
-h, --help help for local
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local destroy
Cleanup local node.
**Usage:**
```bash
avalanche node local destroy [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for destroy
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local start
(ALPHA Warning) This command is currently in experimental mode.
The node local start command sets up a validator on a local server.
The validator will be validating the Avalanche Primary Network and Subnet
of your choice. By default, the command runs an interactive wizard. It
walks you through all the steps you need to set up a validator.
Once this command is completed, you will have to wait for the validator
to finish bootstrapping on the primary network before running further
commands on it, e.g. validating a Subnet. You can check the bootstrapping
status by running avalanche node status local
**Usage:**
```bash
avalanche node local start [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-path string use this avalanchego binary path
--bootstrap-id stringArray nodeIDs of bootstrap nodes
--bootstrap-ip stringArray IP:port pairs of bootstrap nodes
--cluster string operate on the given cluster
--custom-avalanchego-version string install given avalanchego version on node/s
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--genesis string path to genesis file
-h, --help help for start
--latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s (default true)
--latest-avalanchego-version install latest avalanchego release version on node/s
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-config string path to common avalanchego config settings for all nodes
--num-nodes uint32 number of nodes to start (default 1)
--partial-sync primary network partial sync (default true)
--staking-cert-key-path string path to provided staking cert key for node
--staking-signer-key-path string path to provided staking signer key for node
--staking-tls-key-path string path to provided staking tls key for node
-t, --testnet fuji operate on testnet (alias to fuji)
--upgrade string path to upgrade file
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local status
Get status of local node.
**Usage:**
```bash
avalanche node local status [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string specify the blockchain the node is syncing with
-h, --help help for status
--subnet string specify the blockchain the node is syncing with
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local stop
Stop local node.
**Usage:**
```bash
avalanche node local stop [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for stop
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### local track
(ALPHA Warning) make the local node at the cluster to track given blockchain
**Usage:**
```bash
avalanche node local track [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-path string use this avalanchego binary path
--custom-avalanchego-version string install given avalanchego version on node/s
-h, --help help for track
--latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s (default true)
--latest-avalanchego-version install latest avalanchego release version on node/s
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### refresh-ips
(ALPHA Warning) This command is currently in experimental mode.
The node refresh-ips command obtains the current IP for all nodes with dynamic IPs in the cluster,
and updates the local node information used by CLI commands.
**Usage:**
```bash
avalanche node refresh-ips [subcommand] [flags]
```
**Flags:**
```bash
--aws-profile string aws profile to use (default "default")
-h, --help help for refresh-ips
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### resize
(ALPHA Warning) This command is currently in experimental mode.
The node resize command can change the amount of CPU, memory and disk space available for the cluster nodes.
**Usage:**
```bash
avalanche node resize [subcommand] [flags]
```
**Flags:**
```bash
--aws-profile string aws profile to use (default "default")
--disk-size string Disk size to resize in Gb (e.g. 1000Gb)
-h, --help help for resize
--node-type string Node type to resize (e.g. t3.2xlarge)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### scp
(ALPHA Warning) This command is currently in experimental mode.
The node scp command securely copies files to and from nodes. Remote source or destionation can be specified using the following format:
[clusterName|nodeID|instanceID|IP]:/path/to/file. Regular expressions are supported for the source files like /tmp/*.txt.
File transfer to the nodes are parallelized. IF source or destination is cluster, the other should be a local file path.
If both destinations are remote, they must be nodes for the same cluster and not clusters themselves.
For example:
$ avalanche node scp [cluster1|node1]:/tmp/file.txt /tmp/file.txt
$ avalanche node scp /tmp/file.txt [cluster1|NodeID-XXXX]:/tmp/file.txt
$ avalanche node scp node1:/tmp/file.txt NodeID-XXXX:/tmp/file.txt
**Usage:**
```bash
avalanche node scp [subcommand] [flags]
```
**Flags:**
```bash
--compress use compression for ssh
-h, --help help for scp
--recursive copy directories recursively
--with-loadtest include loadtest node for scp cluster operations
--with-monitor include monitoring node for scp cluster operations
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### ssh
(ALPHA Warning) This command is currently in experimental mode.
The node ssh command execute a given command [cmd] using ssh on all nodes in the cluster if ClusterName is given.
If no command is given, just prints the ssh command to be used to connect to each node in the cluster.
For provided NodeID or InstanceID or IP, the command [cmd] will be executed on that node.
If no [cmd] is provided for the node, it will open ssh shell there.
**Usage:**
```bash
avalanche node ssh [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for ssh
--parallel run ssh command on all nodes in parallel
--with-loadtest include loadtest node for ssh cluster operations
--with-monitor include monitoring node for ssh cluster operations
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### status
(ALPHA Warning) This command is currently in experimental mode.
The node status command gets the bootstrap status of all nodes in a cluster with the Primary Network.
If no cluster is given, defaults to node list behaviour.
To get the bootstrap status of a node with a Blockchain, use --blockchain flag
**Usage:**
```bash
avalanche node status [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string specify the blockchain the node is syncing with
-h, --help help for status
--subnet string specify the blockchain the node is syncing with
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### sync
(ALPHA Warning) This command is currently in experimental mode.
The node sync command enables all nodes in a cluster to be bootstrapped to a Blockchain.
You can check the blockchain bootstrap status by calling avalanche node status `clusterName` --blockchain `blockchainName`
**Usage:**
```bash
avalanche node sync [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for sync
--no-checks do not check for bootstrapped/healthy status or rpc compatibility of nodes against subnet
--subnet-aliases strings subnet alias to be used for RPC calls. defaults to subnet blockchain ID
--validators strings sync subnet into given comma separated list of validators. defaults to all cluster nodes
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### update
(ALPHA Warning) This command is currently in experimental mode.
The node update command suite provides a collection of commands for nodes to update
their avalanchego or VM config.
You can check the status after update by calling avalanche node status
**Usage:**
```bash
avalanche node update [subcommand] [flags]
```
**Subcommands:**
- [`subnet`](#avalanche-node-update-subnet): (ALPHA Warning) This command is currently in experimental mode.
The node update subnet command updates all nodes in a cluster with latest Subnet configuration and VM for custom VM.
You can check the updated subnet bootstrap status by calling avalanche node status `clusterName` --subnet `subnetName`
**Flags:**
```bash
-h, --help help for update
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### update subnet
(ALPHA Warning) This command is currently in experimental mode.
The node update subnet command updates all nodes in a cluster with latest Subnet configuration and VM for custom VM.
You can check the updated subnet bootstrap status by calling avalanche node status `clusterName` --subnet `subnetName`
**Usage:**
```bash
avalanche node update subnet [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for subnet
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### upgrade
(ALPHA Warning) This command is currently in experimental mode.
The node update command suite provides a collection of commands for nodes to update
their avalanchego or VM version.
You can check the status after upgrade by calling avalanche node status
**Usage:**
```bash
avalanche node upgrade [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for upgrade
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### validate
(ALPHA Warning) This command is currently in experimental mode.
The node validate command suite provides a collection of commands for nodes to join
the Primary Network and Subnets as validators.
If any of the commands is run before the nodes are bootstrapped on the Primary Network, the command
will fail. You can check the bootstrap status by calling avalanche node status `clusterName`
**Usage:**
```bash
avalanche node validate [subcommand] [flags]
```
**Subcommands:**
- [`primary`](#avalanche-node-validate-primary): (ALPHA Warning) This command is currently in experimental mode.
The node validate primary command enables all nodes in a cluster to be validators of Primary
Network.
- [`subnet`](#avalanche-node-validate-subnet): (ALPHA Warning) This command is currently in experimental mode.
The node validate subnet command enables all nodes in a cluster to be validators of a Subnet.
If the command is run before the nodes are Primary Network validators, the command will first
make the nodes Primary Network validators before making them Subnet validators.
If The command is run before the nodes are bootstrapped on the Primary Network, the command will fail.
You can check the bootstrap status by calling avalanche node status `clusterName`
If The command is run before the nodes are synced to the subnet, the command will fail.
You can check the subnet sync status by calling avalanche node status `clusterName` --subnet `subnetName`
**Flags:**
```bash
-h, --help help for validate
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### validate primary
(ALPHA Warning) This command is currently in experimental mode.
The node validate primary command enables all nodes in a cluster to be validators of Primary
Network.
**Usage:**
```bash
avalanche node validate primary [subcommand] [flags]
```
**Flags:**
```bash
-e, --ewoq use ewoq key [fuji/devnet only]
-h, --help help for primary
-k, --key string select the key to use [fuji only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
--stake-amount uint how many AVAX to stake in the validator
--staking-period duration how long validator validates for after start time
--start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### validate subnet
(ALPHA Warning) This command is currently in experimental mode.
The node validate subnet command enables all nodes in a cluster to be validators of a Subnet.
If the command is run before the nodes are Primary Network validators, the command will first
make the nodes Primary Network validators before making them Subnet validators.
If The command is run before the nodes are bootstrapped on the Primary Network, the command will fail.
You can check the bootstrap status by calling avalanche node status `clusterName`
If The command is run before the nodes are synced to the subnet, the command will fail.
You can check the subnet sync status by calling avalanche node status `clusterName` --subnet `subnetName`
**Usage:**
```bash
avalanche node validate subnet [subcommand] [flags]
```
**Flags:**
```bash
--default-validator-params use default weight/start/duration params for subnet validator
-e, --ewoq use ewoq key [fuji/devnet only]
-h, --help help for subnet
-k, --key string select the key to use [fuji/devnet only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
--no-checks do not check for bootstrapped status or healthy status
--no-validation-checks do not check if subnet is already synced or validated (default true)
--stake-amount uint how many AVAX to stake in the validator
--staking-period duration how long validator validates for after start time
--start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format
--validators strings validate subnet for the given comma separated list of validators. defaults to all cluster nodes
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### whitelist
(ALPHA Warning) The whitelist command suite provides a collection of tools for granting access to the cluster.
Command adds IP if --ip params provided to cloud security access rules allowing it to access all nodes in the cluster via ssh or http.
It also command adds SSH public key to all nodes in the cluster if --ssh params is there.
If no params provided it detects current user IP automaticaly and whitelists it
**Usage:**
```bash
avalanche node whitelist [subcommand] [flags]
```
**Flags:**
```bash
-y, --current-ip whitelist current host ip
-h, --help help for whitelist
--ip string ip address to whitelist
--ssh string ssh public key to whitelist
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche primary
The primary command suite provides a collection of tools for interacting with the
Primary Network
**Usage:**
```bash
avalanche primary [subcommand] [flags]
```
**Subcommands:**
- [`addValidator`](#avalanche-primary-addvalidator): The primary addValidator command adds a node as a validator
in the Primary Network
- [`describe`](#avalanche-primary-describe): The subnet describe command prints details of the primary network configuration to the console.
**Flags:**
```bash
-h, --help help for primary
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### addValidator
The primary addValidator command adds a node as a validator
in the Primary Network
**Usage:**
```bash
avalanche primary addValidator [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--delegation-fee uint32 set the delegation fee (20 000 is equivalent to 2%)
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for addValidator
-k, --key string select the key to use [fuji only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji)
--ledger-addrs strings use the given ledger addresses
-m, --mainnet operate on mainnet
--nodeID string set the NodeID of the validator to add
--proof-of-possession string set the BLS proof of possession of the validator to add
--public-key string set the BLS public key of the validator to add
--staking-period duration how long this validator will be staking
--start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format
-t, --testnet fuji operate on testnet (alias to fuji)
--weight uint set the staking weight of the validator to add
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### describe
The subnet describe command prints details of the primary network configuration to the console.
**Usage:**
```bash
avalanche primary describe [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
-h, --help help for describe
-l, --local operate on a local network
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche subnet
The subnet command suite provides a collection of tools for developing
and deploying Blockchains.
To get started, use the subnet create command wizard to walk through the
configuration of your very first Blockchain. Then, go ahead and deploy it
with the subnet deploy command. You can use the rest of the commands to
manage your Blockchain configurations and live deployments.
Deprecation notice: use 'avalanche blockchain'
**Usage:**
```bash
avalanche subnet [subcommand] [flags]
```
**Subcommands:**
- [`addValidator`](#avalanche-subnet-addvalidator): The blockchain addValidator command adds a node as a validator to
an L1 of the user provided deployed network. If the network is proof of
authority, the owner of the validator manager contract must sign the
transaction. If the network is proof of stake, the node must stake the L1's
staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain.
This command currently only works on Blockchains deployed to either the Fuji
Testnet or Mainnet.
- [`changeOwner`](#avalanche-subnet-changeowner): The blockchain changeOwner changes the owner of the subnet of the deployed Blockchain.
- [`changeWeight`](#avalanche-subnet-changeweight): The blockchain changeWeight command changes the weight of a Subnet Validator.
The Subnet has to be a Proof of Authority Subnet-Only Validator Subnet.
- [`configure`](#avalanche-subnet-configure): AvalancheGo nodes support several different configuration files. Subnets have their own
Subnet config which applies to all chains/VMs in the Subnet. Each chain within the Subnet
can have its own chain config. A chain can also have special requirements for the AvalancheGo node
configuration itself. This command allows you to set all those files.
- [`create`](#avalanche-subnet-create): The blockchain create command builds a new genesis file to configure your Blockchain.
By default, the command runs an interactive wizard. It walks you through
all the steps you need to create your first Blockchain.
The tool supports deploying Subnet-EVM, and custom VMs. You
can create a custom, user-generated genesis with a custom VM by providing
the path to your genesis and VM binaries with the --genesis and --vm flags.
By default, running the command with a blockchainName that already exists
causes the command to fail. If you'd like to overwrite an existing
configuration, pass the -f flag.
- [`delete`](#avalanche-subnet-delete): The blockchain delete command deletes an existing blockchain configuration.
- [`deploy`](#avalanche-subnet-deploy): The blockchain deploy command deploys your Blockchain configuration locally, to Fuji Testnet, or to Mainnet.
At the end of the call, the command prints the RPC URL you can use to interact with the Subnet.
Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent
attempts to deploy the same Blockchain to the same network (local, Fuji, Mainnet) aren't
allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call
avalanche network clean to reset all deployed chain state. Subsequent local deploys
redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks,
so you can take your locally tested Subnet and deploy it on Fuji or Mainnet.
- [`describe`](#avalanche-subnet-describe): The blockchain describe command prints the details of a Blockchain configuration to the console.
By default, the command prints a summary of the configuration. By providing the --genesis
flag, the command instead prints out the raw genesis file.
- [`export`](#avalanche-subnet-export): The blockchain export command write the details of an existing Blockchain deploy to a file.
The command prompts for an output path. You can also provide one with
the --output flag.
- [`import`](#avalanche-subnet-import): Import blockchain configurations into avalanche-cli.
This command suite supports importing from a file created on another computer,
or importing from blockchains running public networks
(e.g. created manually or with the deprecated subnet-cli)
- [`join`](#avalanche-subnet-join): The subnet join command configures your validator node to begin validating a new Blockchain.
To complete this process, you must have access to the machine running your validator. If the
CLI is running on the same machine as your validator, it can generate or update your node's
config file automatically. Alternatively, the command can print the necessary instructions
to update your node manually. To complete the validation process, the Subnet's admins must add
the NodeID of your validator to the Subnet's allow list by calling addValidator with your
NodeID.
After you update your validator's config, you need to restart your validator manually. If
you provide the --avalanchego-config flag, this command attempts to edit the config file
at that path.
This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet.
- [`list`](#avalanche-subnet-list): The blockchain list command prints the names of all created Blockchain configurations. Without any flags,
it prints some general, static information about the Blockchain. With the --deployed flag, the command
shows additional information including the VMID, BlockchainID and SubnetID.
- [`publish`](#avalanche-subnet-publish): The blockchain publish command publishes the Blockchain's VM to a repository.
- [`removeValidator`](#avalanche-subnet-removevalidator): The blockchain removeValidator command stops a whitelisted, subnet network validator from
validating your deployed Blockchain.
To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass
these prompts by providing the values with flags.
- [`stats`](#avalanche-subnet-stats): The blockchain stats command prints validator statistics for the given Blockchain.
- [`upgrade`](#avalanche-subnet-upgrade): The blockchain upgrade command suite provides a collection of tools for
updating your developmental and deployed Blockchains.
- [`validators`](#avalanche-subnet-validators): The blockchain validators command lists the validators of a blockchain's subnet and provides
several statistics about them.
- [`vmid`](#avalanche-subnet-vmid): The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain.
**Flags:**
```bash
-h, --help help for subnet
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### addValidator
The blockchain addValidator command adds a node as a validator to
an L1 of the user provided deployed network. If the network is proof of
authority, the owner of the validator manager contract must sign the
transaction. If the network is proof of stake, the node must stake the L1's
staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain.
This command currently only works on Blockchains deployed to either the Fuji
Testnet or Mainnet.
**Usage:**
```bash
avalanche subnet addValidator [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true)
--aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation
--aggregator-log-level string log level to use with signature aggregator (default "Off")
--balance uint set the AVAX balance of the validator that will be used for continuous fee on P-Chain
--blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's registration (blockchain gas token)
--blockchain-key string CLI stored key to use to pay fees for completing the validator's registration (blockchain gas token)
--blockchain-private-key string private key to use to pay fees for completing the validator's registration (blockchain gas token)
--bls-proof-of-possession string set the BLS proof of possession of the validator to add
--bls-public-key string set the BLS public key of the validator to add
--cluster string operate on the given cluster
--create-local-validator create additional local validator and add it to existing running local node
--default-duration (for Subnets, not L1s) set duration so as to validate until primary validator ends its period
--default-start-time (for Subnets, not L1s) use default start time for subnet validator (5 minutes later for fuji & mainnet, 30 seconds later for devnet)
--default-validator-params (for Subnets, not L1s) use default weight/start/duration params for subnet validator
--delegation-fee uint16 (PoS only) delegation fee (in bips) (default 100)
--devnet operate on a devnet network
--disable-owner string P-Chain address that will able to disable the validator with a P-Chain transaction
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet only]
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for addValidator
-k, --key string select the key to use [fuji/devnet only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-endpoint string gather node id/bls from publicly available avalanchego apis on the given endpoint
--node-id string node-id of the validator to add
--output-tx-path string (for Subnets, not L1s) file path of the add validator tx
--partial-sync set primary network partial sync for new validators (default true)
--remaining-balance-owner string P-Chain address that will receive any leftover AVAX from the validator when it is removed from Subnet
--rpc string connect to validator manager at the given rpc endpoint
--stake-amount uint (PoS only) amount of tokens to stake
--staking-period duration how long this validator will be staking
--start-time string (for Subnets, not L1s) UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format
--subnet-auth-keys strings (for Subnets, not L1s) control keys that will be used to authenticate add validator tx
-t, --testnet fuji operate on testnet (alias to fuji)
--wait-for-tx-acceptance (for Subnets, not L1s) just issue the add validator tx, without waiting for its acceptance (default true)
--weight uint set the staking weight of the validator to add (default 20)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### changeOwner
The blockchain changeOwner changes the owner of the subnet of the deployed Blockchain.
**Usage:**
```bash
avalanche subnet changeOwner [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--control-keys strings addresses that may make subnet changes
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet]
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for changeOwner
-k, --key string select the key to use [fuji/devnet]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--output-tx-path string file path of the transfer subnet ownership tx
-s, --same-control-key use the fee-paying key as control key
--subnet-auth-keys strings control keys that will be used to authenticate transfer subnet ownership tx
-t, --testnet fuji operate on testnet (alias to fuji)
--threshold uint32 required number of control key signatures to make subnet changes
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### changeWeight
The blockchain changeWeight command changes the weight of a Subnet Validator.
The Subnet has to be a Proof of Authority Subnet-Only Validator Subnet.
**Usage:**
```bash
avalanche subnet changeWeight [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet only]
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for changeWeight
-k, --key string select the key to use [fuji/devnet only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-id string node-id of the validator
-t, --testnet fuji operate on testnet (alias to fuji)
--weight uint set the new staking weight of the validator (default 20)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### configure
AvalancheGo nodes support several different configuration files. Subnets have their own
Subnet config which applies to all chains/VMs in the Subnet. Each chain within the Subnet
can have its own chain config. A chain can also have special requirements for the AvalancheGo node
configuration itself. This command allows you to set all those files.
**Usage:**
```bash
avalanche subnet configure [subcommand] [flags]
```
**Flags:**
```bash
--chain-config string path to the chain configuration
-h, --help help for configure
--node-config string path to avalanchego node configuration
--per-node-chain-config string path to per node chain configuration for local network
--subnet-config string path to the subnet configuration
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### create
The blockchain create command builds a new genesis file to configure your Blockchain.
By default, the command runs an interactive wizard. It walks you through
all the steps you need to create your first Blockchain.
The tool supports deploying Subnet-EVM, and custom VMs. You
can create a custom, user-generated genesis with a custom VM by providing
the path to your genesis and VM binaries with the --genesis and --vm flags.
By default, running the command with a blockchainName that already exists
causes the command to fail. If you'd like to overwrite an existing
configuration, pass the -f flag.
**Usage:**
```bash
avalanche subnet create [subcommand] [flags]
```
**Flags:**
```bash
--custom use a custom VM template
--custom-vm-branch string custom vm branch or commit
--custom-vm-build-script string custom vm build-script
--custom-vm-path string file path of custom vm to use
--custom-vm-repo-url string custom vm repository url
--debug enable blockchain debugging (default true)
--evm use the Subnet-EVM as the base template
--evm-chain-id uint chain ID to use with Subnet-EVM
--evm-defaults deprecation notice: use '--production-defaults'
--evm-token string token symbol to use with Subnet-EVM
--external-gas-token use a gas token from another blockchain
-f, --force overwrite the existing configuration if one exists
--from-github-repo generate custom VM binary from github repository
--genesis string file path of genesis to use
-h, --help help for create
--icm interoperate with other blockchains using ICM
--icm-registry-at-genesis setup ICM registry smart contract on genesis [experimental]
--latest use latest Subnet-EVM released version, takes precedence over --vm-version
--pre-release use latest Subnet-EVM pre-released version, takes precedence over --vm-version
--production-defaults use default production settings for your blockchain
--proof-of-authority use proof of authority(PoA) for validator management
--proof-of-stake use proof of stake(PoS) for validator management
--proxy-contract-owner string EVM address that controls ProxyAdmin for TransparentProxy of ValidatorManager contract
--reward-basis-points uint (PoS only) reward basis points for PoS Reward Calculator (default 100)
--sovereign set to false if creating non-sovereign blockchain (default true)
--teleporter interoperate with other blockchains using ICM
--test-defaults use default test settings for your blockchain
--validator-manager-owner string EVM address that controls Validator Manager Owner
--vm string file path of custom vm to use. alias to custom-vm-path
--vm-version string version of Subnet-EVM template to use
--warp generate a vm with warp support (needed for ICM) (default true)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### delete
The blockchain delete command deletes an existing blockchain configuration.
**Usage:**
```bash
avalanche subnet delete [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for delete
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### deploy
The blockchain deploy command deploys your Blockchain configuration locally, to Fuji Testnet, or to Mainnet.
At the end of the call, the command prints the RPC URL you can use to interact with the Subnet.
Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent
attempts to deploy the same Blockchain to the same network (local, Fuji, Mainnet) aren't
allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call
avalanche network clean to reset all deployed chain state. Subsequent local deploys
redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks,
so you can take your locally tested Subnet and deploy it on Fuji or Mainnet.
**Usage:**
```bash
avalanche subnet deploy [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true)
--aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation
--aggregator-log-level string log level to use with signature aggregator (default "Off")
--avalanchego-path string use this avalanchego binary path
--avalanchego-version string use this version of avalanchego (ex: v1.17.12) (default "latest-prerelease")
--balance float set the AVAX balance of each bootstrap validator that will be used for continuous fee on P-Chain (default 0.1)
--blockchain-genesis-key use genesis allocated key to fund validator manager initialization
--blockchain-key string CLI stored key to use to fund validator manager initialization
--blockchain-private-key string private key to use to fund validator manager initialization
--bootstrap-endpoints strings take validator node info from the given endpoints
--bootstrap-filepath string JSON file path that provides details about bootstrap validators, leave Node-ID and BLS values empty if using --generate-node-id=true
--cchain-funding-key string key to be used to fund relayer account on cchain
--cchain-icm-key string key to be used to pay for ICM deploys on C-Chain
--change-owner-address string address that will receive change if node is no longer L1 validator
--cluster string operate on the given cluster
--control-keys strings addresses that may make subnet changes
--convert-only avoid node track, restart and poa manager setup
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-e, --ewoq use ewoq key [fuji/devnet deploy only]
-f, --fuji testnet operate on fuji (alias to testnet
--generate-node-id whether to create new node id for bootstrap validators (Node-ID and BLS values in bootstrap JSON file will be overridden if --bootstrap-filepath flag is used)
-h, --help help for deploy
--icm-key string key to be used to pay for ICM deploys (default "cli-teleporter-deployer")
--icm-version string ICM version to deploy (default "latest")
-k, --key string select the key to use [fuji/devnet deploy only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--mainnet-chain-id uint32 use different ChainID for mainnet deployment
--noicm skip automatic ICM deploy
--num-bootstrap-validators int (only if --generate-node-id is true) number of bootstrap validators to set up in sovereign L1 validator)
--num-local-nodes int number of nodes to be created on local machine
--num-nodes uint32 number of nodes to be created on local network deploy (default 2)
--output-tx-path string file path of the blockchain creation tx
--partial-sync set primary network partial sync for new validators (default true)
--pos-maximum-stake-amount uint maximum stake amount (default 1000)
--pos-maximum-stake-multiplier uint8 maximum stake multiplier (default 1)
--pos-minimum-delegation-fee uint16 minimum delegation fee (default 1)
--pos-minimum-stake-amount uint minimum stake amount (default 1)
--pos-minimum-stake-duration uint minimum stake duration (default 100)
--pos-weight-to-value-factor uint weight to value factor (default 1)
--relay-cchain relay C-Chain as source and destination (default true)
--relayer-allow-private-ips allow relayer to connec to private ips (default true)
--relayer-amount float automatically fund relayer fee payments with the given amount
--relayer-key string key to be used by default both for rewards and to pay fees
--relayer-log-level string log level to be used for relayer logs (default "info")
--relayer-path string relayer binary to use
--relayer-version string relayer version to deploy (default "latest-prerelease")
-s, --same-control-key use the fee-paying key as control key
--skip-icm-deploy skip automatic ICM deploy
--skip-local-teleporter skip automatic ICM deploy on local networks [to be deprecated]
--skip-relayer skip relayer deploy
--skip-teleporter-deploy skip automatic ICM deploy
--subnet-auth-keys strings control keys that will be used to authenticate chain creation
-u, --subnet-id string do not create a subnet, deploy the blockchain into the given subnet id
--subnet-only only create a subnet
--teleporter-messenger-contract-address-path string path to an ICM Messenger contract address file
--teleporter-messenger-deployer-address-path string path to an ICM Messenger deployer address file
--teleporter-messenger-deployer-tx-path string path to an ICM Messenger deployer tx file
--teleporter-registry-bytecode-path string path to an ICM Registry bytecode file
--teleporter-version string ICM version to deploy (default "latest")
-t, --testnet fuji operate on testnet (alias to fuji)
--threshold uint32 required number of control key signatures to make subnet changes
--use-local-machine use local machine as a blockchain validator
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### describe
The blockchain describe command prints the details of a Blockchain configuration to the console.
By default, the command prints a summary of the configuration. By providing the --genesis
flag, the command instead prints out the raw genesis file.
**Usage:**
```bash
avalanche subnet describe [subcommand] [flags]
```
**Flags:**
```bash
-g, --genesis Print the genesis to the console directly instead of the summary
-h, --help help for describe
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### export
The blockchain export command write the details of an existing Blockchain deploy to a file.
The command prompts for an output path. You can also provide one with
the --output flag.
**Usage:**
```bash
avalanche subnet export [subcommand] [flags]
```
**Flags:**
```bash
--custom-vm-branch string custom vm branch
--custom-vm-build-script string custom vm build-script
--custom-vm-repo-url string custom vm repository url
-h, --help help for export
-o, --output string write the export data to the provided file path
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### import
Import blockchain configurations into avalanche-cli.
This command suite supports importing from a file created on another computer,
or importing from blockchains running public networks
(e.g. created manually or with the deprecated subnet-cli)
**Usage:**
```bash
avalanche subnet import [subcommand] [flags]
```
**Subcommands:**
- [`file`](#avalanche-subnet-import-file): The blockchain import command will import a blockchain configuration from a file or a git repository.
To import from a file, you can optionally provide the path as a command-line argument.
Alternatively, running the command without any arguments triggers an interactive wizard.
To import from a repository, go through the wizard. By default, an imported Blockchain doesn't
overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
- [`public`](#avalanche-subnet-import-public): The blockchain import public command imports a Blockchain configuration from a running network.
By default, an imported Blockchain
doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
**Flags:**
```bash
-h, --help help for import
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### import file
The blockchain import command will import a blockchain configuration from a file or a git repository.
To import from a file, you can optionally provide the path as a command-line argument.
Alternatively, running the command without any arguments triggers an interactive wizard.
To import from a repository, go through the wizard. By default, an imported Blockchain doesn't
overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
**Usage:**
```bash
avalanche subnet import file [subcommand] [flags]
```
**Flags:**
```bash
--branch string the repo branch to use if downloading a new repo
-f, --force overwrite the existing configuration if one exists
-h, --help help for file
--repo string the repo to import (ex: ava-labs/avalanche-plugins-core) or url to download the repo from
--subnet string the subnet configuration to import from the provided repo
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### import public
The blockchain import public command imports a Blockchain configuration from a running network.
By default, an imported Blockchain
doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force
flag.
**Usage:**
```bash
avalanche subnet import public [subcommand] [flags]
```
**Flags:**
```bash
--blockchain-id string the blockchain ID
--cluster string operate on the given cluster
--custom use a custom VM template
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--evm import a subnet-evm
--force overwrite the existing configuration if one exists
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for public
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-url string [optional] URL of an already running subnet validator
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### join
The subnet join command configures your validator node to begin validating a new Blockchain.
To complete this process, you must have access to the machine running your validator. If the
CLI is running on the same machine as your validator, it can generate or update your node's
config file automatically. Alternatively, the command can print the necessary instructions
to update your node manually. To complete the validation process, the Subnet's admins must add
the NodeID of your validator to the Subnet's allow list by calling addValidator with your
NodeID.
After you update your validator's config, you need to restart your validator manually. If
you provide the --avalanchego-config flag, this command attempts to edit the config file
at that path.
This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet.
**Usage:**
```bash
avalanche subnet join [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-config string file path of the avalanchego config file
--cluster string operate on the given cluster
--data-dir string path of avalanchego's data dir directory
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force-write if true, skip to prompt to overwrite the config file
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for join
-k, --key string select the key to use [fuji only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-id string set the NodeID of the validator to check
--plugin-dir string file path of avalanchego's plugin directory
--print if true, print the manual config without prompting
--stake-amount uint amount of tokens to stake on validator
--staking-period duration how long validator validates for after start time
--start-time string start time that validator starts validating
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### list
The blockchain list command prints the names of all created Blockchain configurations. Without any flags,
it prints some general, static information about the Blockchain. With the --deployed flag, the command
shows additional information including the VMID, BlockchainID and SubnetID.
**Usage:**
```bash
avalanche subnet list [subcommand] [flags]
```
**Flags:**
```bash
--deployed show additional deploy information
-h, --help help for list
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### publish
The blockchain publish command publishes the Blockchain's VM to a repository.
**Usage:**
```bash
avalanche subnet publish [subcommand] [flags]
```
**Flags:**
```bash
--alias string We publish to a remote repo, but identify the repo locally under a user-provided alias (e.g. myrepo).
--force If true, ignores if the subnet has been published in the past, and attempts a forced publish.
-h, --help help for publish
--no-repo-path string Do not let the tool manage file publishing, but have it only generate the files and put them in the location given by this flag.
--repo-url string The URL of the repo where we are publishing
--subnet-file-path string Path to the Subnet description file. If not given, a prompting sequence will be initiated.
--vm-file-path string Path to the VM description file. If not given, a prompting sequence will be initiated.
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### removeValidator
The blockchain removeValidator command stops a whitelisted, subnet network validator from
validating your deployed Blockchain.
To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass
these prompts by providing the values with flags.
**Usage:**
```bash
avalanche subnet removeValidator [subcommand] [flags]
```
**Flags:**
```bash
--aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true)
--aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation
--aggregator-log-level string log level to use with signature aggregator (default "Off")
--blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's removal (blockchain gas token)
--blockchain-key string CLI stored key to use to pay fees for completing the validator's removal (blockchain gas token)
--blockchain-private-key string private key to use to pay fees for completing the validator's removal (blockchain gas token)
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force force validator removal even if it's not getting rewarded
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for removeValidator
-k, --key string select the key to use [fuji deploy only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji)
--ledger-addrs strings use the given ledger addresses
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-endpoint string remove validator that responds to the given endpoint
--node-id string node-id of the validator
--output-tx-path string (for non-SOV blockchain only) file path of the removeValidator tx
--rpc string connect to validator manager at the given rpc endpoint
--subnet-auth-keys strings (for non-SOV blockchain only) control keys that will be used to authenticate the removeValidator tx
-t, --testnet fuji operate on testnet (alias to fuji)
--uptime uint validator's uptime in seconds. If not provided, it will be automatically calculated
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### stats
The blockchain stats command prints validator statistics for the given Blockchain.
**Usage:**
```bash
avalanche subnet stats [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for stats
-l, --local operate on a local network
-m, --mainnet operate on mainnet
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### upgrade
The blockchain upgrade command suite provides a collection of tools for
updating your developmental and deployed Blockchains.
**Usage:**
```bash
avalanche subnet upgrade [subcommand] [flags]
```
**Subcommands:**
- [`apply`](#avalanche-subnet-upgrade-apply): Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade.
For public networks (Fuji Testnet or Mainnet), to complete this process,
you must have access to the machine running your validator.
If the CLI is running on the same machine as your validator, it can manipulate your node's
configuration automatically. Alternatively, the command can print the necessary instructions
to upgrade your node manually.
After you update your validator's configuration, you need to restart your validator manually.
If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path.
Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation.
- [`export`](#avalanche-subnet-upgrade-export): Export the upgrade bytes file to a location of choice on disk
- [`generate`](#avalanche-subnet-upgrade-generate): The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It
guides the user through the process using an interactive wizard.
- [`import`](#avalanche-subnet-upgrade-import): Import the upgrade bytes file into the local environment
- [`print`](#avalanche-subnet-upgrade-print): Print the upgrade.json file content
- [`vm`](#avalanche-subnet-upgrade-vm): The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command
can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet.
The command walks the user through an interactive wizard. The user can skip the wizard by providing
command line flags.
**Flags:**
```bash
-h, --help help for upgrade
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade apply
Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade.
For public networks (Fuji Testnet or Mainnet), to complete this process,
you must have access to the machine running your validator.
If the CLI is running on the same machine as your validator, it can manipulate your node's
configuration automatically. Alternatively, the command can print the necessary instructions
to upgrade your node manually.
After you update your validator's configuration, you need to restart your validator manually.
If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path.
Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation.
**Usage:**
```bash
avalanche subnet upgrade apply [subcommand] [flags]
```
**Flags:**
```bash
--avalanchego-chain-config-dir string avalanchego's chain config file directory (default "/Users/owen.wahlgren/.avalanchego/chains")
--config create upgrade config for future subnet deployments (same as generate)
--force If true, don't prompt for confirmation of timestamps in the past
--fuji fuji apply upgrade existing fuji deployment (alias for `testnet`)
-h, --help help for apply
--local local apply upgrade existing local deployment
--mainnet mainnet apply upgrade existing mainnet deployment
--print if true, print the manual config without prompting (for public networks only)
--testnet testnet apply upgrade existing testnet deployment (alias for `fuji`)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade export
Export the upgrade bytes file to a location of choice on disk
**Usage:**
```bash
avalanche subnet upgrade export [subcommand] [flags]
```
**Flags:**
```bash
--force If true, overwrite a possibly existing file without prompting
-h, --help help for export
--upgrade-filepath string Export upgrade bytes file to location of choice on disk
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade generate
The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It
guides the user through the process using an interactive wizard.
**Usage:**
```bash
avalanche subnet upgrade generate [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for generate
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade import
Import the upgrade bytes file into the local environment
**Usage:**
```bash
avalanche subnet upgrade import [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for import
--upgrade-filepath string Import upgrade bytes file into local environment
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade print
Print the upgrade.json file content
**Usage:**
```bash
avalanche subnet upgrade print [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for print
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
#### upgrade vm
The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command
can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet.
The command walks the user through an interactive wizard. The user can skip the wizard by providing
command line flags.
**Usage:**
```bash
avalanche subnet upgrade vm [subcommand] [flags]
```
**Flags:**
```bash
--binary string Upgrade to custom binary
--config upgrade config for future subnet deployments
--fuji fuji upgrade existing fuji deployment (alias for `testnet`)
-h, --help help for vm
--latest upgrade to latest version
--local local upgrade existing local deployment
--mainnet mainnet upgrade existing mainnet deployment
--plugin-dir string plugin directory to automatically upgrade VM
--print print instructions for upgrading
--testnet testnet upgrade existing testnet deployment (alias for `fuji`)
--version string Upgrade to custom version
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### validators
The blockchain validators command lists the validators of a blockchain's subnet and provides
several statistics about them.
**Usage:**
```bash
avalanche subnet validators [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for validators
-l, --local operate on a local network
-m, --mainnet operate on mainnet
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### vmid
The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain.
**Usage:**
```bash
avalanche subnet vmid [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for vmid
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche teleporter
The messenger command suite provides a collection of tools for interacting
with ICM messenger contracts.
**Usage:**
```bash
avalanche teleporter [subcommand] [flags]
```
**Subcommands:**
- [`deploy`](#avalanche-teleporter-deploy): Deploys ICM Messenger and Registry into a given L1.
- [`sendMsg`](#avalanche-teleporter-sendmsg): Sends and wait reception for a ICM msg between two subnets.
**Flags:**
```bash
-h, --help help for teleporter
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### deploy
Deploys ICM Messenger and Registry into a given L1.
**Usage:**
```bash
avalanche teleporter deploy [subcommand] [flags]
```
**Flags:**
```bash
--blockchain string deploy ICM into the given CLI blockchain
--blockchain-id string deploy ICM into the given blockchain ID/Alias
--c-chain deploy ICM into C-Chain
--cchain-key string key to be used to pay fees to deploy ICM to C-Chain
--cluster string operate on the given cluster
--deploy-messenger deploy ICM Messenger (default true)
--deploy-registry deploy ICM Registry (default true)
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
--force-registry-deploy deploy ICM Registry even if Messenger has already been deployed
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key to fund ICM deploy
-h, --help help for deploy
--include-cchain deploy ICM also to C-Chain
--key string CLI stored key to use to fund ICM deploy
-l, --local operate on a local network
--messenger-contract-address-path string path to a messenger contract address file
--messenger-deployer-address-path string path to a messenger deployer address file
--messenger-deployer-tx-path string path to a messenger deployer tx file
--private-key string private key to use to fund ICM deploy
--registry-bytecode-path string path to a registry bytecode file
--rpc-url string use the given RPC URL to connect to the subnet
-t, --testnet fuji operate on testnet (alias to fuji)
--version string version to deploy (default "latest")
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### sendMsg
Sends and wait reception for a ICM msg between two subnets.
**Usage:**
```bash
avalanche teleporter sendMsg [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--dest-rpc string use the given destination blockchain rpc endpoint
--destination-address string deliver the message to the given contract destination address
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
--genesis-key use genesis allocated key as message originator and to pay source blockchain fees
-h, --help help for sendMsg
--hex-encoded given message is hex encoded
--key string CLI stored key to use as message originator and to pay source blockchain fees
-l, --local operate on a local network
--private-key string private key to use as message originator and to pay source blockchain fees
--source-rpc string use the given source blockchain rpc endpoint
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche transaction
The transaction command suite provides all of the utilities required to sign multisig transactions.
**Usage:**
```bash
avalanche transaction [subcommand] [flags]
```
**Subcommands:**
- [`commit`](#avalanche-transaction-commit): The transaction commit command commits a transaction by submitting it to the P-Chain.
- [`sign`](#avalanche-transaction-sign): The transaction sign command signs a multisig transaction.
**Flags:**
```bash
-h, --help help for transaction
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### commit
The transaction commit command commits a transaction by submitting it to the P-Chain.
**Usage:**
```bash
avalanche transaction commit [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for commit
--input-tx-filepath string Path to the transaction signed by all signatories
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### sign
The transaction sign command signs a multisig transaction.
**Usage:**
```bash
avalanche transaction sign [subcommand] [flags]
```
**Flags:**
```bash
-h, --help help for sign
--input-tx-filepath string Path to the transaction file for signing
-k, --key string select the key to use [fuji only]
-g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji)
--ledger-addrs strings use the given ledger addresses
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche update
Check if an update is available, and prompt the user to install it
**Usage:**
```bash
avalanche update [subcommand] [flags]
```
**Flags:**
```bash
-c, --confirm Assume yes for installation
-h, --help help for update
-v, --version version for update
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
## avalanche validator
The validator command suite provides a collection of tools for managing validator
balance on P-Chain.
Validator's balance is used to pay for continuous fee to the P-Chain. When this Balance reaches 0,
the validator will be considered inactive and will no longer participate in validating the L1
**Usage:**
```bash
avalanche validator [subcommand] [flags]
```
**Subcommands:**
- [`getBalance`](#avalanche-validator-getbalance): This command gets the remaining validator P-Chain balance that is available to pay
P-Chain continuous fee
- [`increaseBalance`](#avalanche-validator-increasebalance): This command increases the validator P-Chain balance
- [`list`](#avalanche-validator-list): This command gets a list of the validators of the L1
**Flags:**
```bash
-h, --help help for validator
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### getBalance
This command gets the remaining validator P-Chain balance that is available to pay
P-Chain continuous fee
**Usage:**
```bash
avalanche validator getBalance [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for getBalance
--l1 string name of L1
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-id string node ID of the validator
-t, --testnet fuji operate on testnet (alias to fuji)
--validation-id string validation ID of the validator
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### increaseBalance
This command increases the validator P-Chain balance
**Usage:**
```bash
avalanche validator increaseBalance [subcommand] [flags]
```
**Flags:**
```bash
--balance float amount of AVAX to increase validator's balance by
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for increaseBalance
-k, --key string select the key to use [fuji/devnet deploy only]
--l1 string name of L1 (to increase balance of bootstrap validators only)
-l, --local operate on a local network
-m, --mainnet operate on mainnet
--node-id string node ID of the validator
-t, --testnet fuji operate on testnet (alias to fuji)
--validation-id string validationIDStr of the validator
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
### list
This command gets a list of the validators of the L1
**Usage:**
```bash
avalanche validator list [subcommand] [flags]
```
**Flags:**
```bash
--cluster string operate on the given cluster
--devnet operate on a devnet network
--endpoint string use the given endpoint for network operations
-f, --fuji testnet operate on fuji (alias to testnet
-h, --help help for list
-l, --local operate on a local network
-m, --mainnet operate on mainnet
-t, --testnet fuji operate on testnet (alias to fuji)
--config string config file (default is $HOME/.avalanche-cli/config.json)
--log-level string log level for the application (default "ERROR")
--skip-update-check skip check for new versions
```
# AllowList Interface (/docs/avalanche-l1s/precompiles/allowlist-interface)
---
title: AllowList Interface
description: The AllowList interface is used by many default precompiles to permission access to the features they provide.
---
## Overview
The AllowList is a security feature used by precompiles to manage which addresses have permission to interact with certain contract functionalities. It provides a consistent role-based permission system inherited by all precompiles that use it.
| Property | Value |
|----------|-------|
| **Address** | Inherited by each precompile |
| **ConfigKey** | N/A (Interface only) |
## Role-Based Permissions
The AllowList implements a consistent role-based permission system:
| Role | Value | Description | Permissions |
|------|-------|-------------|-------------|
| Admin | 2 | Can manage all roles | Can add/remove any role (Admin, Manager, Enabled) |
| Manager | 3 | Can manage enabled addresses | Can add/remove only Enabled addresses |
| Enabled | 1 | Basic permissions | Can use the precompile's functionality |
| None | 0 | No permissions | Cannot use the precompile or manage permissions |
Each precompile that uses the AllowList interface follows this permission structure, though the specific actions allowed for "Enabled" addresses vary depending on the precompile's purpose. For example:
- In the Contract Deployer AllowList, "Enabled" addresses can deploy contracts
- In the Transaction AllowList, "Enabled" addresses can submit transactions
- In the Native Minter, "Enabled" addresses can mint tokens
## Interface
The AllowList interface is defined as follows:
```solidity
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.24;
interface IAllowList {
event RoleSet(uint256 indexed role, address indexed account, address indexed sender, uint256 oldRole);
// Set [addr] to have the admin role over the precompile contract.
function setAdmin(address addr) external;
// Set [addr] to be enabled on the precompile contract.
function setEnabled(address addr) external;
// Set [addr] to have the manager role over the precompile contract.
function setManager(address addr) external;
// Set [addr] to have no role for the precompile contract.
function setNone(address addr) external;
// Read the status of [addr].
function readAllowList(address addr) external view returns (uint256 role);
}
```
## Implementation
The AllowList interface is implemented by multiple precompiles in the Subnet-EVM. You can find the core implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/allowlist/allowlist.go).
## Precompiles Using AllowList
Several precompiles in Subnet-EVM use the AllowList interface:
- [Deployer AllowList](/docs/avalanche-l1s/precompiles/deployer-allowlist)
- [Transaction AllowList](/docs/avalanche-l1s/precompiles/transaction-allowlist)
- [Native Minter](/docs/avalanche-l1s/precompiles/native-minter)
- [Fee Manager](/docs/avalanche-l1s/precompiles/fee-manager)
- [Reward Manager](/docs/avalanche-l1s/precompiles/reward-manager)
# Deployer AllowList (/docs/avalanche-l1s/precompiles/deployer-allowlist)
---
title: Deployer AllowList
description: Control which addresses can deploy smart contracts on your Avalanche L1 blockchain.
---
## Overview
The Contract Deployer Allowlist allows you to maintain a controlled environment where only authorized addresses can deploy new smart contracts. This is particularly useful for:
- Maintaining a curated ecosystem of verified contracts
- Preventing malicious contract deployments
- Implementing KYC/AML requirements for contract deployers
| Property | Value |
|----------|-------|
| **Address** | `0x0200000000000000000000000000000000000000` |
| **ConfigKey** | `contractDeployerAllowListConfig` |
## Configuration
You can activate this precompile in your genesis file:
```json
{
"config": {
"contractDeployerAllowListConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
}
```
By enabling this feature, you can define which addresses are allowed to deploy smart contracts and manage these permissions over time.
## Interface
The Contract Deployer Allowlist implements the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface):
```solidity
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.24;
interface IAllowList {
event RoleSet(uint256 indexed role, address indexed account, address indexed sender, uint256 oldRole);
// Set [addr] to have the admin role over the precompile contract.
function setAdmin(address addr) external;
// Set [addr] to be enabled on the precompile contract.
function setEnabled(address addr) external;
// Set [addr] to have the manager role over the precompile contract.
function setManager(address addr) external;
// Set [addr] to have no role for the precompile contract.
function setNone(address addr) external;
// Read the status of [addr].
function readAllowList(address addr) external view returns (uint256 role);
}
```
## Permissions Management
The Deployer Allowlist uses the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface) to manage permissions. This provides a consistent way to:
- Assign and revoke deployment permissions
- Manage admin and manager roles
- Control who can deploy contracts
For detailed information about the role-based permission system and available functions, see the [AllowList interface documentation](/docs/avalanche-l1s/precompiles/allowlist-interface).
## Best Practices
1. **Initial Setup**: Always configure at least one admin address in the genesis file to ensure you can manage permissions after deployment.
2. **Role Management**:
- Use Admin roles sparingly and secure their private keys
- Assign Manager roles to trusted entities who need to manage user access
- Regularly audit the list of enabled addresses
3. **Security Considerations**:
- Keep private keys of admin addresses secure
- Implement a multi-sig wallet as an admin for additional security
- Maintain an off-chain record of role assignments
4. **Monitoring**:
- Monitor the `RoleSet` events to track permission changes
- Regularly audit the enabled addresses list
- Keep documentation of why each address was granted permissions
## Implementation
You can find the implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/deployerallowlist/contract.go).
## Interacting with the Precompile
For information on how to interact with this precompile, see:
- [Interacting with Precompiles](/docs/avalanche-l1s/precompiles/interacting-with-precompiles)
- [Deployer Allowlist Console](/console/l1-access-restrictions/deployer-allowlist)
# Fee Manager (/docs/avalanche-l1s/precompiles/fee-manager)
---
title: Fee Manager
description: Configure dynamic fee parameters and gas costs for your Avalanche L1 blockchain.
---
## Overview
The Fee Manager allows you to configure the parameters of the dynamic fee algorithm on-chain. This gives you control over:
- Gas limits and target block rates
- Base fee parameters
- Block gas cost parameters
| Property | Value |
|----------|-------|
| **Address** | `0x0200000000000000000000000000000000000003` |
| **ConfigKey** | `feeManagerConfig` |
## Configuration
You can activate this precompile in your genesis file:
```json
{
"config": {
"feeManagerConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"],
"initialFeeConfig": {
"gasLimit": 20000000,
"targetBlockRate": 2,
"minBaseFee": 1000000000,
"targetGas": 100000000,
"baseFeeChangeDenominator": 48,
"minBlockGasCost": 0,
"maxBlockGasCost": 10000000,
"blockGasCostStep": 500000
}
}
}
}
```
The following parameters were deprecated by the Granite upgrade:
- `targetBlockRate`
- `minBlockGasCost`
- `maxBlockGasCost`
- `blockGasCostStep`
## Fee Parameters
The Fee Manager allows configuration of the following parameters:
| Parameter | Description | Recommended Range |
|-----------|-------------|------------------|
| gasLimit | Maximum gas allowed per block | 8M - 100M |
| targetBlockRate | Target time between blocks (seconds) | 2 - 10 |
| minBaseFee | Minimum base fee (in wei) | 25 - 500 gwei |
| targetGas | Target gas spending over the last 10 seconds | 5M - 50M |
| baseFeeChangeDenominator | Controls how quickly base fee changes | 8 - 1000 |
| minBlockGasCost | Minimum gas cost for a block | 0 - 1B |
| maxBlockGasCost | Maximum gas cost for a block | > minBlockGasCost |
| blockGasCostStep | How quickly block gas cost changes | < 5M |
## Interface
```solidity
interface IFeeManager {
struct FeeConfig {
uint256 gasLimit;
uint256 targetBlockRate;
uint256 minBaseFee;
uint256 targetGas;
uint256 baseFeeChangeDenominator;
uint256 minBlockGasCost;
uint256 maxBlockGasCost;
uint256 blockGasCostStep;
}
event FeeConfigChanged(address indexed sender, FeeConfig oldFeeConfig, FeeConfig newFeeConfig);
function setFeeConfig(
uint256 gasLimit,
uint256 targetBlockRate,
uint256 minBaseFee,
uint256 targetGas,
uint256 baseFeeChangeDenominator,
uint256 minBlockGasCost,
uint256 maxBlockGasCost,
uint256 blockGasCostStep
) external;
function getFeeConfig() external view returns (
uint256 gasLimit,
uint256 targetBlockRate,
uint256 minBaseFee,
uint256 targetGas,
uint256 baseFeeChangeDenominator,
uint256 minBlockGasCost,
uint256 maxBlockGasCost,
uint256 blockGasCostStep
);
function getFeeConfigLastChangedAt() external view returns (uint256 blockNumber);
}
```
## Access Control and Additional Features
The FeeManager precompile uses the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface) to restrict access to its functionality.
In addition to the AllowList interface, the FeeManager adds the following capabilities:
- `getFeeConfig`: retrieves the current dynamic fee config
- `getFeeConfigLastChangedAt`: retrieves the timestamp of the last block where the fee config was updated
- `setFeeConfig`: sets the dynamic fee config on chain. This function can only be called by an Admin, Manager or Enabled address.
- `FeeConfigChanged`: an event that is emitted when the fee config is updated. Topics include the sender, the old fee config, and the new fee config.
You can also get the fee configuration at a block with the `eth_feeConfig` RPC method. For more information see [here](/docs/rpcs/subnet-evm#eth_feeconfig).
## Best Practices
1. **Fee Configuration**:
- Test fee changes on testnet first
- Monitor network congestion and adjust accordingly
- Document rationale for fee parameter changes
- Announce changes to validators in advance
2. **Security Considerations**:
- Use multi-sig for admin addresses
- Monitor events for unauthorized changes
- Have a plan for fee parameter adjustments
- Keep backup of previous configurations
## Implementation
You can find the Fee Manager implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/feemanager/contract.go).
## Interacting with the Precompile
For information on how to interact with this precompile, see:
- [Interacting with Precompiles](/docs/avalanche-l1s/precompiles/interacting-with-precompiles)
- [Fee Manager Console](/console/l1-tokenomics/fee-manager)
# Interacting with Precompiles (/docs/avalanche-l1s/precompiles/interacting-with-precompiles)
---
title: Interacting with Precompiles
description: Learn how to interact with Avalanche L1 precompiles using the Builder Hub Developer Console or Remix IDE.
---
This guide shows you how to interact with precompiled contracts on your Avalanche L1. For standard precompile implementations, we recommend using the **Builder Hub Developer Console** for the best experience. For custom implementations or advanced use cases, you can use **Remix IDE** with browser wallets.
## Recommended: Using Builder Hub Developer Console
The Builder Hub provides dedicated tools for interacting with standard Avalanche L1 precompiles. These tools offer:
- ✅ **User-friendly interface** - No need to manually enter contract addresses or ABIs
- ✅ **Built-in validation** - Prevents common configuration mistakes
- ✅ **Connected to your Builder account** - Track your L1s and configurations
- ✅ **Visual feedback** - See changes reflected in real-time
### Available Console Tools
| Precompile | Console Tool |
|------------|--------------|
| Fee Manager | [Fee Manager Console](/console/l1-tokenomics/fee-manager) |
| Reward Manager | [Reward Manager Console](/console/l1-tokenomics/reward-manager) |
| Native Minter | [Native Minter Console](/console/l1-tokenomics/native-minter) |
| Contract Deployer Allowlist | [Deployer Allowlist Console](/console/l1-access-restrictions/deployer-allowlist) |
| Transaction Allowlist | [Transactor Allowlist Console](/console/l1-access-restrictions/transactor-allowlist) |
### How to Use Console Tools
1. **Navigate** to the appropriate console tool from the table above
2. **Connect** your wallet (Core or MetaMask)
3. **Switch** to your L1 network in your wallet
4. The tool will automatically detect your permissions
5. **Configure** using the visual interface:
- For Fee Manager: Adjust gas limits, base fees, and target rates
- For Native Minter: Mint tokens to specific addresses
- For Allowlists: Add or remove addresses with specific roles
- For Reward Manager: Configure fee distribution settings
6. **Review** the transaction details
7. **Submit** and approve in your wallet
**Why use the Developer Console?**
Using the Builder Hub console tools allows us to:
- Provide better support for your L1
- Track feature usage to improve the platform
- Build your profile in our builders/developers database
- Offer personalized recommendations and resources
### Example Workflows
**Configuring Transaction Fees:**
1. Go to [Fee Manager Console](/console/l1-tokenomics/fee-manager)
2. Connect wallet and switch to your L1
3. Adjust fee parameters using sliders and inputs
4. See real-time preview of how changes affect gas costs
5. Submit transaction to update fees
**Minting Native Tokens:**
1. Go to [Native Minter Console](/console/l1-tokenomics/native-minter)
2. Connect with an admin/manager address
3. Enter recipient address and amount
4. Review the minting transaction
5. Approve to mint tokens instantly
**Managing Permissions:**
1. Go to [Deployer Allowlist](/console/l1-access-restrictions/deployer-allowlist) or [Transactor Allowlist](/console/l1-access-restrictions/transactor-allowlist)
2. Connect with an admin address
3. Add addresses with desired roles (Admin, Manager, Enabled)
4. Remove addresses by changing their role to "None"
5. View current allowlist status
## Alternative: Using Remix IDE
For custom precompile implementations or if you prefer a code-based approach, you can use Remix IDE to interact with precompiles directly.
### When to Use Remix
Use Remix when:
- You have a **custom precompile** implementation (non-standard addresses or interfaces)
- You need to interact with precompiles **programmatically**
- You're **debugging** contract interactions
- The Builder Console doesn't support your specific use case
### Prerequisites
- Access to an Avalanche L1 where you have admin/manager rights for a precompile
- [Core Browser Extension](https://core.app) or MetaMask
- Private key for an admin/manager address on your L1
- Your L1's RPC URL and Chain ID
## Setup Your Wallet
### Using Core
1. Install the [Core Browser Extension](https://core.app)
2. Import or create the account with admin/manager privileges
3. Enable **Testnet Mode** (if using testnet):
- Open Core extension
- Click hamburger menu → **Advanced**
- Toggle **Testnet Mode** on
4. Add your L1 network:
- Click the networks dropdown
- Select **Manage Networks**
- Click **Add Network** and enter:
- **Network Name**: Your L1 name
- **RPC URL**: Your L1's RPC endpoint
- **Chain ID**: Your L1's chain ID
- **Symbol**: Your native token symbol
- **Explorer**: (Optional) Your L1's explorer URL
5. Switch to your L1 network in the dropdown
### Using MetaMask
1. Install MetaMask browser extension
2. Import the account with admin/manager privileges
3. Add your L1 network:
- Click the networks dropdown
- Click **Add Network** → **Add a network manually**
- Enter your L1's network details
- Click **Save**
## Connect Remix to Your L1
1. Open [Remix IDE](https://remix.ethereum.org/) in your browser
2. In the left sidebar, click the **Deploy & run transactions** icon
3. In the **Environment** dropdown, select **Injected Provider - MetaMask** (or Core)
4. Approve the connection request in your wallet extension
5. Verify the connection shows your L1's network (e.g., "Custom (11111) network")
## Load Precompile Interfaces
You need to load the Solidity interfaces for the precompiles you want to interact with.
### Available Precompile Interfaces
From the Remix home screen, use **load from GitHub** to import:
**Required for all precompiles:**
- [IAllowList.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IAllowList.sol)
**Specific precompile interfaces:**
- [IFeeManager.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IFeeManager.sol) - For fee configuration
- [INativeMinter.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/INativeMinter.sol) - For minting native tokens
- [IAllowList.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IAllowList.sol) - For transaction/deployer allowlists
- [IRewardManager.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IRewardManager.sol) - For block rewards
### Compile the Interface
1. In Remix, click the **Solidity Compiler** icon in the left sidebar
2. Select the precompile interface file (e.g., `IFeeManager.sol`)
3. Click **Compile**
## Interact with Precompiles
### Connect to Deployed Precompile
Each precompile is deployed at a fixed address on your L1:
| Precompile | Address |
|------------|---------|
| NativeMinter | `0x0200000000000000000000000000000000000001` |
| ContractDeployerAllowList | `0x0200000000000000000000000000000000000000` |
| FeeManager | `0x0200000000000000000000000000000000000003` |
| RewardManager | `0x0200000000000000000000000000000000000004` |
| TransactionAllowList | `0x0200000000000000000000000000000000000002` |
1. In Remix, click **Deploy & run transactions**
2. In the **Contract** dropdown, select your compiled interface
3. Paste the precompile address in the **At Address** field
4. Click **At Address**
The precompile contract will appear in the **Deployed Contracts** section.
## Example: Using Fee Manager
### Read Current Fee Configuration
Anyone can read the current fee configuration (no special permissions required):
1. Expand the FeeManager contract in **Deployed Contracts**
2. Click **getFeeConfig**
3. View the current fee parameters:
- `gasLimit`: Maximum gas per block
- `targetBlockRate`: Target time between blocks (seconds)
- `minBaseFee`: Minimum base fee (wei)
- `targetGas`: Target gas per second
- `baseFeeChangeDenominator`: Rate of base fee adjustment
- `minBlockGasCost`: Minimum gas cost for a block
- `maxBlockGasCost`: Maximum gas cost for a block
- `blockGasCostStep`: Increment for block gas cost
### Update Fee Configuration
Only admin addresses can update the fee configuration:
1. Ensure you're connected with the admin address in your wallet
2. Expand **setFeeConfig** in the FeeManager contract
3. Fill in the new fee parameters:
```
gasLimit: 8000000
targetBlockRate: 2
minBaseFee: 25000000000
targetGas: 15000000
baseFeeChangeDenominator: 36
minBlockGasCost: 0
maxBlockGasCost: 1000000
blockGasCostStep: 200000
```
4. Click **transact**
5. Approve the transaction in your wallet
6. Wait for transaction confirmation
The new fee configuration takes effect immediately after the transaction is accepted.
## Example: Using Native Minter
### Mint Native Tokens
Only admin, manager, or enabled addresses can mint native tokens:
1. Expand the NativeMinter contract in **Deployed Contracts**
2. Click on **mintNativeCoin**
3. Fill in the parameters:
- `addr`: Recipient address (e.g., `0xB78cbAa319ffBD899951AA30D4320f5818938310`)
- `amount`: Amount to mint in wei (e.g., `1000000000000000000` for 1 token)
4. Click **transact**
5. Approve the transaction in your wallet
The minted tokens are added directly to the recipient's balance by the EVM (no sender transaction).
### Check Minting Permissions
Anyone can check who has minting permissions:
1. Click **readAllowList** with an address parameter
2. Returns:
- `0`: No permission
- `1`: Enabled (can mint)
- `2`: Manager (can mint and manage enabled addresses)
- `3`: Admin (full control)
## Example: Managing Allow Lists
### Add Address to Allow List
Admins can add addresses to transaction or deployer allow lists:
1. Expand the AllowList contract
2. Use **setAdmin**, **setManager**, or **setEnabled**:
```
addr: 0x1234...5678
```
3. Click **transact**
4. Approve in wallet
### Remove Address from Allow List
1. Use **setNone** with the address:
```
addr: 0x1234...5678
```
2. Click **transact**
### Check Address Status
1. Click **readAllowList**:
```
addr: 0x1234...5678
```
2. Returns permission level (0-3)
## Best Practices
### Security
- **Never share private keys** for admin addresses
- **Use hardware wallets** for admin accounts when possible
- **Test on testnet first** before making changes on mainnet
- **Use multi-sig contracts** for critical admin operations
- **Document all changes** and announce them to validators
### Network Upgrades
When enabling precompiles via network upgrades:
1. **Announce upgrades** well in advance on social media and Discord
2. **Coordinate with validators** to ensure they update their nodes
3. **Use upgrade.json** to schedule precompile activation (see [Precompile Upgrades](/docs/avalanche-l1s/upgrade/precompile-upgrades))
4. **Test the upgrade** on a testnet first
5. **Monitor** the network after activation
### Troubleshooting
**Connection Issues:**
- Verify your wallet is connected to the correct network
- Check that the RPC URL is accessible
- Ensure you have native tokens for gas fees
**Transaction Failures:**
- Confirm you're using an admin/manager address
- Check that the precompile is enabled on your L1
- Verify parameter formats (addresses must be checksummed)
- Ensure sufficient gas limit
**Precompile Not Found:**
- Verify the precompile address is correct
- Confirm the precompile is activated in your genesis or upgrade.json
- Check that you're on the correct network
## Additional Resources
### Builder Hub Console Tools
- [Fee Manager Console](/console/l1-tokenomics/fee-manager) - Configure transaction fees
- [Reward Manager Console](/console/l1-tokenomics/reward-manager) - Manage fee distribution
- [Native Minter Console](/console/l1-tokenomics/native-minter) - Mint native tokens
- [Deployer Allowlist Console](/console/l1-access-restrictions/deployer-allowlist) - Control contract deployment
- [Transactor Allowlist Console](/console/l1-access-restrictions/transactor-allowlist) - Control transaction submission
### Documentation
- [Precompile Configuration](/docs/avalanche-l1s/evm-configuration/evm-l1-customization) - Overview of precompiles
- [Fee Manager](/docs/avalanche-l1s/precompiles/fee-manager) - Fee Manager details
- [Reward Manager](/docs/avalanche-l1s/precompiles/reward-manager) - Reward Manager details
- [Native Minter](/docs/avalanche-l1s/precompiles/native-minter) - Native Minter details
- [Deployer AllowList](/docs/avalanche-l1s/precompiles/deployer-allowlist) - Deployer Allowlist details
- [Transaction AllowList](/docs/avalanche-l1s/precompiles/transaction-allowlist) - Transaction Allowlist details
- [Warp Messenger](/docs/avalanche-l1s/precompiles/warp-messenger) - Warp Messenger details
- [Precompile Upgrades](/docs/avalanche-l1s/upgrade/precompile-upgrades) - Network upgrade process
- [AllowList Interface](/docs/avalanche-l1s/precompiles/allowlist-interface) - Role-based access control
- [Subnet-EVM Contracts](https://github.com/ava-labs/subnet-evm/tree/master/contracts/contracts/interfaces) - Precompile interfaces
## Conclusion
For standard Avalanche L1 precompiles, **we strongly recommend using the [Builder Hub Developer Console tools](/console)** for the best experience. These tools provide:
- ✅ Guided workflows with validation
- ✅ No need to manage contract addresses or ABIs manually
- ✅ Integration with your Builder Hub account
- ✅ Support from the Builder Hub team
For custom implementations or advanced scenarios, the Remix IDE approach provides flexibility to interact with any contract at any address. This is useful for:
- Custom precompile implementations
- Testing and debugging
- Programmatic interactions
- Non-standard use cases
Whichever method you choose, always test on testnet first and follow security best practices when managing admin keys.
# Native Minter (/docs/avalanche-l1s/precompiles/native-minter)
---
title: Native Minter
description: Manage the minting and burning of native tokens on your Avalanche L1 blockchain.
---
## Overview
The Native Minter precompile allows authorized addresses to mint additional tokens after network launch. This is useful for:
- Implementing programmatic token emission schedules
- Providing validator rewards
- Supporting ecosystem growth initiatives
- Implementing monetary policy
| Property | Value |
|----------|-------|
| **Address** | `0x0200000000000000000000000000000000000001` |
| **ConfigKey** | `contractNativeMinterConfig` |
## Configuration
You can activate this precompile in your genesis file:
```json
{
"config": {
"contractNativeMinterConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
}
```
## Interface
```solidity
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.24;
interface INativeMinter {
event NativeCoinMinted(address indexed sender, address indexed recipient, uint256 amount);
// Mint [amount] number of native coins and send to [addr]
function mintNativeCoin(address addr, uint256 amount) external;
// IAllowList
event RoleSet(uint256 indexed role, address indexed account, address indexed sender, uint256 oldRole);
// Set [addr] to have the admin role over the precompile contract.
function setAdmin(address addr) external;
// Set [addr] to be enabled on the precompile contract.
function setEnabled(address addr) external;
// Set [addr] to have the manager role over the precompile contract.
function setManager(address addr) external;
// Set [addr] to have no role for the precompile contract.
function setNone(address addr) external;
// Read the status of [addr].
function readAllowList(address addr) external view returns (uint256 role);
}
```
The Native Minter precompile uses the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface) to restrict access to its functionality.
## Best Practices
1. **Minting Policy**:
- Define clear minting guidelines
- Use multi-sig for admin control
- Implement transparent emission schedules
- Monitor total supply changes
2. **Supply Management**:
- Balance minting with burning mechanisms
- Consider implementing supply caps
- Monitor token velocity and distribution
- Plan for long-term sustainability
3. **Security Considerations**:
- Use multi-sig wallets for admin addresses
- Implement time-locks for large mints
- Regular audits of minting activity
- Monitor for unusual minting patterns
4. **Validator Incentives**:
- Design sustainable reward mechanisms
- Balance inflation with network security
- Consider validator stake requirements
- Plan for long-term validator participation
## Example Implementations
### Programmatic Emission Schedule
```solidity
contract EmissionSchedule {
INativeMinter public constant NATIVE_MINTER = INativeMinter(0x0200000000000000000000000000000000000001);
uint256 public constant EMISSION_RATE = 1000 * 1e18; // 1000 tokens per day
uint256 public constant EMISSION_DURATION = 365 days;
uint256 public immutable startTime;
constructor() {
startTime = block.timestamp;
}
function mintDailyEmission() external {
require(block.timestamp < startTime + EMISSION_DURATION, "Emission ended");
NATIVE_MINTER.mintNativeCoin(address(this), EMISSION_RATE);
// Distribution logic here
}
}
```
### Validator Reward Contract
```solidity
contract ValidatorRewards {
INativeMinter public constant NATIVE_MINTER = INativeMinter(0x0200000000000000000000000000000000000001);
uint256 public constant REWARD_RATE = 10 * 1e18; // 10 tokens per block
function distributeRewards(address[] calldata validators) external {
uint256 reward = REWARD_RATE / validators.length;
for (uint i = 0; i < validators.length; i++) {
NATIVE_MINTER.mintNativeCoin(validators[i], reward);
}
}
}
```
## Implementation
You can find the Native Minter implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/nativeminter/contract.go).
## Interacting with the Precompile
For information on how to interact with this precompile, see:
- [Interacting with Precompiles](/docs/avalanche-l1s/precompiles/interacting-with-precompiles)
- [Native Minter Console](/console/l1-tokenomics/native-minter)
# Reward Manager (/docs/avalanche-l1s/precompiles/reward-manager)
---
title: Reward Manager
description: Control how transaction fees are distributed or burned on your Avalanche L1 blockchain.
---
## Overview
The Reward Manager allows you to control how transaction fees are handled in your network. You can:
- Send fees to a specific address (e.g., treasury)
- Allow validators to collect fees
- Burn fees entirely
| Property | Value |
|----------|-------|
| **Address** | `0x0200000000000000000000000000000000000004` |
| **ConfigKey** | `rewardManagerConfig` |
## Configuration
You can activate this precompile in your genesis file:
```json
{
"config": {
"rewardManagerConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"],
"initialRewardConfig": {
// Choose one of:
"allowFeeRecipients": true, // Allow validators to collect fees
"rewardAddress": "0x...", // Send fees to specific address
// Empty config = burn fees
}
}
}
}
```
## Reward Mechanisms
The Reward Manager supports three mutually exclusive mechanisms:
1. **Validator Fee Collection** (`allowFeeRecipients`)
- Validators can specify their own fee recipient addresses
- Fees go to the block producer's chosen address
- Good for incentivizing network participation
2. **Fixed Reward Address** (`rewardAddress`)
- All fees go to a single specified address
- Can be a contract or EOA
- Useful for treasury or DAO-controlled fee collection
3. **Fee Burning** (default)
- All transaction fees are burned
- Reduces total token supply over time
- Similar to Ethereum's EIP-1559
## Interface
```solidity
interface IRewardManager {
event RewardAddressChanged(
address indexed sender,
address indexed oldRewardAddress,
address indexed newRewardAddress
);
event FeeRecipientsAllowed(address indexed sender);
event RewardsDisabled(address indexed sender);
function setRewardAddress(address addr) external;
function allowFeeRecipients() external;
function disableRewards() external;
function currentRewardAddress() external view returns (address rewardAddress);
function areFeeRecipientsAllowed() external view returns (bool isAllowed);
}
```
The Reward Manager precompile uses the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface) to restrict access to its functionality.
## Best Practices
1. **Reward Management**:
- Choose reward mechanism based on network goals
- Consider using a multi-sig or DAO as reward address
- Monitor fee collection and distribution
- Keep documentation of fee policy changes
2. **Security Considerations**:
- Use multi-sig for admin addresses
- Test reward changes on testnet first
- Monitor events for unauthorized changes
- Have a plan for reward parameter adjustments
## Implementation
You can find the Reward Manager implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/rewardmanager/contract.go).
## Interacting with the Precompile
For information on how to interact with this precompile, see:
- [Interacting with Precompiles](/docs/avalanche-l1s/precompiles/interacting-with-precompiles)
- [Reward Manager Console](/console/l1-tokenomics/reward-manager)
# Transaction AllowList (/docs/avalanche-l1s/precompiles/transaction-allowlist)
---
title: Transaction AllowList
description: Control which addresses can submit transactions on your Avalanche L1 blockchain.
---
## Overview
The Transaction Allowlist enables you to control which addresses can submit transactions to your network. This is essential for:
- Creating fully permissioned networks
- Implementing KYC/AML requirements for users
- Controlling network access during testing or initial deployment
| Property | Value |
|----------|-------|
| **Address** | `0x0200000000000000000000000000000000000002` |
| **ConfigKey** | `txAllowListConfig` |
## Configuration
You can activate this precompile in your genesis file:
```json
{
"config": {
"txAllowListConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
}
```
By enabling this feature, you can define which addresses are allowed to submit transactions and manage these permissions over time.
## Interface
The Transaction Allowlist implements the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface):
```solidity
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.24;
interface IAllowList {
event RoleSet(uint256 indexed role, address indexed account, address indexed sender, uint256 oldRole);
// Set [addr] to have the admin role over the precompile contract.
function setAdmin(address addr) external;
// Set [addr] to be enabled on the precompile contract.
function setEnabled(address addr) external;
// Set [addr] to have the manager role over the precompile contract.
function setManager(address addr) external;
// Set [addr] to have no role for the precompile contract.
function setNone(address addr) external;
// Read the status of [addr].
function readAllowList(address addr) external view returns (uint256 role);
}
```
## Permissions Management
The Transaction Allowlist uses the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface) to manage permissions. This provides a consistent way to:
- Assign and revoke transaction permissions
- Manage admin and manager roles
- Control who can submit transactions
For detailed information about the role-based permission system and available functions, see the [AllowList interface documentation](/docs/avalanche-l1s/precompiles/allowlist-interface).
## Best Practices
1. **Initial Setup**: Always configure at least one admin address in the genesis file to ensure you can manage permissions after deployment.
2. **Role Management**:
- Use Admin roles sparingly and secure their private keys
- Assign Manager roles to trusted entities who need to manage user access
- Regularly audit the list of enabled addresses
3. **Security Considerations**:
- Keep private keys of admin addresses secure
- Implement a multi-sig wallet as an admin for additional security
- Maintain an off-chain record of role assignments
4. **Monitoring**:
- Monitor the `RoleSet` events to track permission changes
- Regularly audit the enabled addresses list
- Keep documentation of why each address was granted permissions
## Implementation
You can find the implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/txallowlist/contract.go).
## Interacting with the Precompile
For information on how to interact with this precompile, see:
- [Interacting with Precompiles](/docs/avalanche-l1s/precompiles/interacting-with-precompiles)
- [Transactor Allowlist Console](/console/l1-access-restrictions/transactor-allowlist)
# Warp Messenger (/docs/avalanche-l1s/precompiles/warp-messenger)
---
title: Warp Messenger
description: Enable cross-chain communication between Avalanche L1s using Avalanche Warp Messaging.
edit_url: https://github.com/ava-labs/subnet-evm/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/precompile/contracts/warp/README.md
---
## Overview
Avalanche Warp Messaging offers a basic primitive to enable Cross-L1 communication on the Avalanche Network. It is intended to allow communication between arbitrary Custom Virtual Machines (including, but not limited to Subnet-EVM and Coreth).
| Property | Value |
|----------|-------|
| **Address** | `0x0200000000000000000000000000000000000005` |
| **ConfigKey** | `warpConfig` |
## How does Avalanche Warp Messaging Work?
Avalanche Warp Messaging uses BLS Multi-Signatures with Public-Key Aggregation where every Avalanche validator registers a public key alongside its NodeID on the Avalanche P-Chain.
Every node tracking an Avalanche L1 has read access to the Avalanche P-Chain. This provides weighted sets of BLS Public Keys that correspond to the validator sets of each L1 on the Avalanche Network. Avalanche Warp Messaging provides a basic primitive for signing and verifying messages between L1s: the receiving network can verify whether an aggregation of signatures from a set of source L1 validators represents a threshold of stake large enough for the receiving network to process the message.
For more details on Avalanche Warp Messaging, see the AvalancheGo [Warp README](https://docs.avax.network/build/cross-chain/awm/deep-dive).
## Configuration
The Warp Messenger precompile is enabled by default on all Avalanche L1s and does not require explicit configuration in the genesis file. However, you can configure it if needed:
```json
{
"config": {
"warpConfig": {
"blockTimestamp": 0,
"quorumNumerator": 67
}
}
}
```
### Configuration Parameters
- `blockTimestamp`: The timestamp when the precompile should be activated (0 for genesis)
- `quorumNumerator`: The percentage of stake weight required to verify a message (default: 67, meaning 67%)
Unlike other precompiles, Warp Messenger does not use the AllowList interface - it is available to all addresses by default.
## Interface
The Warp Messenger precompile provides the following Solidity interface:
```solidity
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.24;
interface IWarpMessenger {
event SendWarpMessage(address indexed sender, bytes32 indexed messageID, bytes message);
// sendWarpMessage emits a request for the subnet to sign a Warp message with the provided payload
// The message emitted in the log is the unsigned Warp message
function sendWarpMessage(bytes calldata payload) external returns (bytes32 messageID);
// getVerifiedWarpMessage returns the verified Warp message if it exists, otherwise returns (WarpMessage, false)
function getVerifiedWarpMessage(uint32 index) external view returns (WarpMessage memory message, bool valid);
// getBlockchainID returns the blockchainID of the current chain
function getBlockchainID() external view returns (bytes32 blockchainID);
}
struct WarpMessage {
bytes32 sourceChainID;
address originSenderAddress;
bytes payload;
}
```
## Flow of Sending / Receiving a Warp Message within the EVM
The Avalanche Warp Precompile enables this flow to send a message from blockchain A to blockchain B:
1. Call the Warp Precompile `sendWarpMessage` function with the arguments for the `UnsignedMessage`
2. Warp Precompile emits an event / log containing the `UnsignedMessage` specified by the caller of `sendWarpMessage`
3. Network accepts the block containing the `UnsignedMessage` in the log, so that validators are willing to sign the message
4. An off-chain relayer queries the validators for their signatures of the message and aggregates the signatures to create a `SignedMessage`
5. The off-chain relayer encodes the `SignedMessage` as the [predicate](#predicate-encoding) in the AccessList of a transaction to deliver on blockchain B
6. The transaction is delivered on blockchain B, the signature is verified prior to executing the block, and the message is accessible via the Warp Precompile's `getVerifiedWarpMessage` during the execution of that transaction
## Warp Precompile Functions
The Warp Precompile is broken down into three functions defined in the Solidity interface file [here](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/contracts/contracts/interfaces/IWarpMessenger.sol).
### sendWarpMessage
`sendWarpMessage` is used to send a verifiable message. Calling this function results in sending a message with the following contents:
- `SourceChainID` - blockchainID of the sourceChain on the Avalanche P-Chain
- `SourceAddress` - `msg.sender` encoded as a 32 byte value that calls `sendWarpMessage`
- `Payload` - `payload` argument specified in the call to `sendWarpMessage` emitted as the unindexed data of the resulting log
Calling this function will issue a `SendWarpMessage` event from the Warp Precompile. Since the EVM limits the number of topics to 4 including the EventID, this message includes only the topics that would be expected to help filter messages emitted from the Warp Precompile the most.
Specifically, the `payload` is not emitted as a topic because each topic must be encoded as a hash. Therefore, we opt to take advantage of each possible topic to maximize the possible filtering for emitted Warp Messages.
Additionally, the `SourceChainID` is excluded because anyone parsing the chain can be expected to already know the blockchainID. Therefore, the `SendWarpMessage` event includes the indexable attributes:
- `sender`
- The `messageID` of the unsigned message (sha256 of the unsigned message)
The actual `message` is the entire [Avalanche Warp Unsigned Message](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/unsigned_message.go#L14) including an [AddressedCall](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm/warp/payload#readme). The unsigned message is emitted as the unindexed data in the log.
### getVerifiedMessage
`getVerifiedMessage` is used to read the contents of the delivered Avalanche Warp Message into the expected format.
It returns the message if present and a boolean indicating if a message is present.
To use this function, the transaction must include the signed Avalanche Warp Message encoded in the [predicate](#predicate-encoding) of the transaction. Prior to executing a block, the VM iterates through transactions and pre-verifies all predicates. If a transaction's predicate is invalid, then it is considered invalid to include in the block and dropped.
This leads to the following advantages:
1. The EVM execution does not need to verify the Warp Message at runtime (no signature verification or external calls to the P-Chain)
2. The EVM can deterministically re-execute and re-verify blocks assuming the predicate was verified by the network (e.g., in bootstrapping)
This pre-verification is performed using the ProposerVM Block header during [block verification](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/plugin/evm/block.go#L220) and [block building](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/miner/worker.go#L200).
### getBlockchainID
`getBlockchainID` returns the blockchainID of the blockchain that the VM is running on.
This is different from the conventional Ethereum ChainID registered to [ChainList](https://chainlist.org/).
The `blockchainID` in Avalanche refers to the txID that created the blockchain on the Avalanche P-Chain ([docs](https://docs.avax.network/specs/platform-transaction-serialization#unsigned-create-chain-tx)).
## Predicate Encoding
Avalanche Warp Messages are encoded as a signed Avalanche [Warp Message](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/message.go) where the [UnsignedMessage](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/unsigned_message.go)'s payload includes an [AddressedPayload](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/payload/payload.go).
Since the predicate is encoded into the [Transaction Access List](https://eips.ethereum.org/EIPS/eip-2930), it is packed into 32 byte hashes intended to declare storage slots that should be pre-warmed into the cache prior to transaction execution.
Therefore, we use the [Predicate Utils](https://github.com/ava-labs/subnet-evm/blob/master/predicate/Predicate.md) package to encode the actual byte slice of size N into the access list.
## Performance Optimization: Primary Network to Avalanche L1
The Primary Network has a large validator set compared to most Subnets and L1s, which makes Warp signature collection and verification from the entire Primary Network validator set costly. All Subnets and L1s track at least one blockchain of the Primary Network, so we can instead optimize this by using the validator set of the receiving L1 instead of the Primary Network for certain Warp messages.
### Subnets
Recall that Avalanche Subnet validators must also validate the Primary Network, so it tracks all of the blockchains in the Primary Network (X, C, and P-Chains).
When an Avalanche Subnet receives a message from a blockchain on the Primary Network, we use the validator set of the receiving Subnet instead of the entire network when validating the message.
Sending messages from the X, C, or P-Chain remains unchanged.
However, when the Subnet receives the message, it changes the semantics to the following:
1. Read the `SourceChainID` of the signed message
2. Look up the `SubnetID` that validates `SourceChainID`. In this case it will be the Primary Network's `SubnetID`
3. Look up the validator set of the Subnet (instead of the Primary Network) and the registered BLS Public Keys of the Subnet validators at the P-Chain height specified by the ProposerVM header
4. Continue Warp Message verification using the validator set of the Subnet instead of the Primary Network
This means that Primary Network to Subnet communication only requires a threshold of stake on the receiving Subnet to sign the message instead of a threshold of stake for the entire Primary Network.
Since the security of the Subnet is provided by trust in its validator set, requiring a threshold of stake from the receiving Subnet's validator set instead of the whole Primary Network does not meaningfully change the security of the receiving L1.
Note: this special case is ONLY applied during Warp Message verification. The message sent by the Primary Network will still contain the blockchainID of the Primary Network chain that sent the message as the sourceChainID and signatures will be served by querying the source chain directly.
### L1s
Avalanche L1s are only required to sync the P-Chain, but are not required to validate the Primary Network. Therefore, **for L1s, this optimization only applies to Warp messages sent by the P-Chain.** The rest of the description of this optimization in the above section applies to L1s.
Note that **in order to properly verify messages from the C-Chain and X-Chain, the Warp precompile must be configured with `requirePrimaryNetworkSigners` set to `true`**. Otherwise, we will attempt to verify the message signature against the receiving L1's validator set, which is not required to track the C-Chain or X-Chain, and therefore will not in general be able to produce a valid Warp message.
## Design Considerations
### Re-Processing Historical Blocks
Avalanche Warp Messaging depends on the Avalanche P-Chain state at the P-Chain height specified by the ProposerVM block header.
Verifying a message requires looking up the validator set of the source L1 on the P-Chain. To support this, Avalanche Warp Messaging uses the ProposerVM header, which includes the P-Chain height it was issued at as the canonical point to lookup the source L1's validator set.
This means verifying the Warp Message and therefore the state transition on a block depends on state that is external to the blockchain itself: the P-Chain.
The Avalanche P-Chain tracks only its current state and reverse diff layers (reversing the changes from past blocks) in order to re-calculate the validator set at a historical height. This means calculating a very old validator set that is used to verify a Warp Message in an old block may become prohibitively expensive.
Therefore, we need a heuristic to ensure that the network can correctly re-process old blocks (note: re-processing old blocks is a requirement to perform bootstrapping and is used in some VMs to serve or verify historical data).
As a result, we require that the block itself provides a deterministic hint which determines which Avalanche Warp Messages were considered valid/invalid during the block's execution. This ensures that we can always re-process blocks and use the hint to decide whether an Avalanche Warp Message should be treated as valid/invalid even after the P-Chain state that was used at the original execution time may no longer support fast lookups.
To provide that hint, we've explored two designs:
1. Include a predicate in the transaction to ensure any referenced message is valid
2. Append the results of checking whether a Warp Message is valid/invalid to the block data itself
The current implementation uses option (1).
The original reason for this was that the notion of predicates for precompiles was designed with Shared Memory in mind. In the case of shared memory, there is no canonical "P-Chain height" in the block which determines whether or not Avalanche Warp Messages are valid.
Instead, the VM interprets a shared memory import operation as valid as soon as the UTXO is available in shared memory. This means that if it were up to the block producer to staple the valid/invalid results of whether or not an attempted atomic operation should be treated as valid, a byzantine block producer could arbitrarily report that such atomic operations were invalid and cause a griefing attack to burn the gas of users that attempted to perform an import.
Therefore, a transaction specified predicate is required to implement the shared memory precompile to prevent such a griefing attack.
In contrast, Avalanche Warp Messages are validated within the context of an exact P-Chain height. Therefore, if a block producer attempted to lie about the validity of such a message, the network would interpret that block as invalid.
### Guarantees Offered by Warp Precompile vs. Built on Top
#### Guarantees Offered by Warp Precompile
The Warp Precompile was designed with the intention of minimizing the trusted computing base for the VM as much as possible. Therefore, it makes several tradeoffs which encourage users to use protocols built ON TOP of the Warp Precompile itself as opposed to directly using the Warp Precompile.
The Warp Precompile itself provides ONLY the following ability:
- Emit a verifiable message from (Address A, Blockchain A) to (Address B, Blockchain B) that can be verified by the destination chain
#### Explicitly Not Provided / Built on Top
The Warp Precompile itself does not provide any guarantees of:
- Eventual message delivery (may require re-send on blockchain A and additional assumptions about off-chain relayers and chain progress)
- Ordering of messages (requires ordering provided a layer above)
- Replay protection (requires replay protection provided a layer above)
# Complex Golang VM (/docs/avalanche-l1s/golang-vms/complex-golang-vm)
---
title: Complex Golang VM
description: In this tutorial, we'll walk through how to build a virtual machine by referencing the BlobVM.
---
The [BlobVM](https://github.com/ava-labs/blobvm) is a virtual machine that can be used to implement a decentralized key-value store. A blob (shorthand for "binary large object") is an arbitrary piece of data.
BlobVM stores a key-value pair by breaking it apart into multiple chunks stored with their hashes as their keys in the blockchain. A root key-value pair has references to these chunks for lookups. By default, the maximum chunk size is set to 200 KiB.
## Components
A VM defines how a blockchain should be built. A block is populated with a set of transactions which mutate the state of the blockchain when executed. When a block with a set of transactions is applied to a given state, a state transition occurs by executing all of the transactions in the block in-order and applying it to the previous block of the blockchain. By executing a series of blocks chronologically, anyone can verify and reconstruct the state of the blockchain at an arbitrary point in time.
The BlobVM repository has a few components to handle the lifecycle of tasks from a transaction being issued to a block being accepted across the network:
- **Transaction**: A state transition
- **Mempool**: Stores pending transactions that haven't been finalized yet
- **Network**: Propagates transactions from the mempool other nodes in the network
- **Block**: Defines the block format, how to verify it, and how it should be accepted or rejected across the network
- **Block Builder**: Builds blocks by including transactions from the mempool
- **Virtual Machine**: Application-level logic. Implements the VM interface needed to interact with Avalanche consensus and defines the blueprint for the blockchain.
- **Service**: Exposes APIs so users can interact with the VM
- **Factory**: Used to initialize the VM
## Lifecycle of a Transaction
A VM will often times expose a set of APIs so users can interact with the it. In the blockchain, blocks can contain a set of transactions which mutate the blockchain's state. Let's dive into the lifecycle of a transaction from its issuance to its finalization on the blockchain.
- A user makes an API request to `service.IssueRawTx` to issue their transaction. This API will deserialize the user's transaction and forward it to the VM
- The transaction is submitted to the VM which is then added to the VM's mempool
- The VM asynchronously periodically gossips new transactions in its mempool to other nodes in the network so they can learn about them
- The VM sends the Avalanche consensus engine a message to indicate that it has transactions in the mempool that are ready to be built into a block
- The VM proposes the block with to consensus
- Consensus verifies that the block is valid and well-formed
- Consensus gets the network to vote on whether the block should be accepted or rejected. If a block is rejected, its transactions are reclaimed by the mempool so they can be included in a future block. If a block is accepted, it's finalized by writing it to the blockchain.
## Coding the Virtual Machine
We'll dive into a few of the packages that are in the The BlobVM repository to learn more about how they work:
1. [`vm`](https://github.com/ava-labs/blobvm/tree/master/vm)
- `block_builder.go`
- `chain_vm.go`
- `network.go`
- `service.go`
- `vm.go`
2. [`chain`](https://github.com/ava-labs/blobvm/tree/master/chain)
- `unsigned_tx.go`
- `base_tx.go`
- `transfer_tx.go`
- `set_tx.go`
- `tx.go`
- `block.go`
- `mempool.go`
- `storage.go`
- `builder.go`
3. [`mempool`](https://github.com/ava-labs/blobvm/tree/master/mempool)
- `mempool.go`
### Transactions
The state the blockchain can only be mutated by getting the network to accept a signed transaction. A signed transaction contains the transaction to be executed alongside the signature of the issuer. The signature is required to cryptographically verify the sender's identity. A VM can define an arbitrary amount of unique transactions types to support different operations on the blockchain. The BlobVM implements two different transactions types:
- [TransferTx](https://github.com/ava-labs/blobvm/blob/master/chain/transfer_tx.go) - Transfers coins between accounts.
- [SetTx](https://github.com/ava-labs/blobvm/blob/master/chain/set_tx.go) - Stores a key-value pair on the blockchain.
#### UnsignedTransaction
All transactions in the BlobVM implement the common [`UnsignedTransaction`](https://github.com/ava-labs/blobvm/blob/master/chain/unsigned_tx.go) interface, which exposes shared functionality for all transaction types.
```go
type UnsignedTransaction interface {
Copy() UnsignedTransaction
GetBlockID() ids.ID
GetMagic() uint64
GetPrice() uint64
SetBlockID(ids.ID)
SetMagic(uint64)
SetPrice(uint64)
FeeUnits(*Genesis) uint64 // number of units to mine tx
LoadUnits(*Genesis) uint64 // units that should impact fee rate
ExecuteBase(*Genesis) error
Execute(*TransactionContext) error
TypedData() *tdata.TypedData
Activity() *Activity
}
```
#### BaseTx
Common functionality and metadata for transaction types are implemented by [`BaseTx`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go).
- [`SetBlockID`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L26) sets the transaction's block ID.
- [`GetBlockID`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L22) returns the transaction's block ID.
- [`SetMagic`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L34) sets the magic number. The magic number is used to differentiate chains to prevent replay attacks
- [`GetMagic`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L30) returns the magic number. Magic number is defined in genesis.
- [`SetPrice`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L42) sets the price per fee unit for this transaction.
- [`GetPrice`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L38) returns the price for this transaction.
- [`FeeUnits`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L59) returns the fee units this transaction will consume.
- [`LoadUnits`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L63) identical to `FeeUnits`
- [`ExecuteBase`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L46) executes common validation checks across different transaction types. This validates the transaction contains a valid block ID, magic number, and gas price as defined by genesis.
#### TransferTx
[`TransferTx`](https://github.com/ava-labs/blobvm/blob/master/chain/transfer_tx.go#L16) supports the transfer of tokens from one account to another.
```go
type TransferTx struct {
*BaseTx `serialize:"true" json:"baseTx"`
// To is the recipient of the [Units].
To common.Address `serialize:"true" json:"to"`
// Units are transferred to [To].
Units uint64 `serialize:"true" json:"units"`
}
```
`TransferTx` embeds `BaseTx` to avoid re-implementing common operations with other transactions, but implements its own [`Execute`](https://github.com/ava-labs/blobvm/blob/master/chain/transfer_tx.go#L26) to support token transfers.
This performs a few checks to ensure that the transfer is valid before transferring the tokens between the two accounts.
```go
func (t *TransferTx) Execute(c *TransactionContext) error {
// Must transfer to someone
if bytes.Equal(t.To[:], zeroAddress[:]) {
return ErrNonActionable
}
// This prevents someone from transferring to themselves.
if bytes.Equal(t.To[:], c.Sender[:]) {
return ErrNonActionable
}
if t.Units == 0 {
return ErrNonActionable
}
if _, err := ModifyBalance(c.Database, c.Sender, false, t.Units); err != nil {
return err
}
if _, err := ModifyBalance(c.Database, t.To, true, t.Units); err != nil {
return err
}
return nil
}
```
#### SetTx
`SetTx` is used to assign a value to a key.
```go
type SetTx struct {
*BaseTx `serialize:"true" json:"baseTx"`
Value []byte `serialize:"true" json:"value"`
}
```
`SetTx` implements its own [`FeeUnits`](https://github.com/ava-labs/blobvm/blob/master/chain/set_tx.go#L48) method to compensate the network according to the size of the blob being stored.
```go
func (s *SetTx) FeeUnits(g *Genesis) uint64 {
// We don't subtract by 1 here because we want to charge extra for any
// value-based interaction (even if it is small or a delete).
return s.BaseTx.FeeUnits(g) + valueUnits(g, uint64(len(s.Value)))
}
```
`SetTx`'s [`Execute`](https://github.com/ava-labs/blobvm/blob/master/chain/set_tx.go#L21) method performs a few safety checks to validate that the blob meets the size constraints enforced by genesis and doesn't overwrite an existing key before writing it to the blockchain.
```go
func (s *SetTx) Execute(t *TransactionContext) error {
g := t.Genesis
switch {
case len(s.Value) == 0:
return ErrValueEmpty
case uint64(len(s.Value)) > g.MaxValueSize:
return ErrValueTooBig
}
k := ValueHash(s.Value)
// Do not allow duplicate value setting
_, exists, err := GetValueMeta(t.Database, k)
if err != nil {
return err
}
if exists {
return ErrKeyExists
}
return PutKey(t.Database, k, &ValueMeta{
Size: uint64(len(s.Value)),
TxID: t.TxID,
Created: t.BlockTime,
})
}
```
#### Signed Transaction
The unsigned transactions mentioned previously can't be issued to the network without first being signed. BlobVM implements signed transactions by embedding the unsigned transaction alongside its signature in [`Transaction`](https://github.com/ava-labs/blobvm/blob/master/chain/tx.go). In BlobVM, a signature is defined as the [ECDSA signature](https://en.wikipedia.org/wiki/Elliptic_Curve_Digital_Signature_Algorithm) of the issuer's private key of the [KECCAK256](https://keccak.team/keccak.html) hash of the unsigned transaction's data ([digest hash](https://eips.ethereum.org/EIPS/eip-712)).
```go
type Transaction struct {
UnsignedTransaction `serialize:"true" json:"unsignedTransaction"`
Signature []byte `serialize:"true" json:"signature"`
digestHash []byte
bytes []byte
id ids.ID
size uint64
sender common.Address
}
```
The `Transaction` type wraps any unsigned transaction. When a `Transaction` is executed, it calls the `Execute` method of the underlying embedded `UnsignedTx` and performs the following sanity checks:
1. The underlying `UnsignedTx` must meet the requirements set by genesis. This includes checks to make sure that the transaction contains the correct magic number and meets the minimum gas price as defined by genesis
2. The transaction's block ID must be a recently accepted block
3. The transaction must not be a recently issued transaction
4. The issuer of the transaction must have enough gas
5. The transaction's gas price must be meet the next expected block's minimum gas price
6. The transaction must execute without error
If the transaction is successfully verified, it's submitted as a pending write to the blockchain.
```go
func (t *Transaction) Execute(g *Genesis, db database.Database, blk *StatelessBlock, context *Context) error {
if err := t.UnsignedTransaction.ExecuteBase(g); err != nil {
return err
}
if !context.RecentBlockIDs.Contains(t.GetBlockID()) {
// Hash must be recent to be any good
// Should not happen because of mempool cleanup
return ErrInvalidBlockID
}
if context.RecentTxIDs.Contains(t.ID()) {
// Tx hash must not be recently executed (otherwise could be replayed)
//
// NOTE: We only need to keep cached tx hashes around as long as the
// block hash referenced in the tx is valid
return ErrDuplicateTx
}
// Ensure sender has balance
if _, err := ModifyBalance(db, t.sender, false, t.FeeUnits(g)*t.GetPrice()); err != nil {
return err
}
if t.GetPrice() < context.NextPrice {
return ErrInsufficientPrice
}
if err := t.UnsignedTransaction.Execute(&TransactionContext{
Genesis: g,
Database: db,
BlockTime: uint64(blk.Tmstmp),
TxID: t.id,
Sender: t.sender,
}); err != nil {
return err
}
if err := SetTransaction(db, t); err != nil {
return err
}
return nil
}
```
##### Example
Let's walk through an example on how to issue a `SetTx` transaction to the BlobVM to write a key-value pair.
1. Create the unsigned transaction for `SetTx`
```go
utx := &chain.SetTx{
BaseTx: &chain.BaseTx{},
Value: []byte("data"),
}
utx.SetBlockID(lastAcceptedID)
utx.SetMagic(genesis.Magic)
utx.SetPrice(price + blockCost/utx.FeeUnits(genesis))
```
2. Calculate the [digest hash](https://github.com/ava-labs/blobvm/blob/master/chain/tx.go#L41) for the transaction.
```go
digest, err := chain.DigestHash(utx)
```
3. [Sign](https://github.com/ava-labs/blobvm/blob/master/chain/crypto.go#L17) the digest hash with the issuer's private key.
```go
signature, err := chain.Sign(digest, privateKey)
```
4. Create and initialize the new signed transaction.
```go
tx := chain.NewTx(utx, sig)
if err := tx.Init(g); err != nil {
return ids.Empty, 0, err
}
```
5. Issue the request with the client
```
txID, err = cli.IssueRawTx(ctx, tx.Bytes())
```
### Mempool
#### Overview
The [mempool](https://github.com/ava-labs/blobvm/blob/master/mempool/mempool.go) is a buffer of volatile memory that stores pending transactions. Transactions are stored in the mempool whenever a node learns about a new transaction either through gossip with other nodes or through an API call issued by a user.
The mempool is implemented as a min-max [heap](https://en.wikipedia.org/wiki/Heap_data_structure) ordered by each transaction's gas price. The mempool is created during the [initialization](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L93) of VM.
```go
vm.mempool = mempool.New(vm.genesis, vm.config.MempoolSize)
```
Whenever a transaction is submitted to VM, it first gets initialized, verified, and executed locally. If the transaction looks valid, then it's added to the [mempool](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L414).
#### Add Method
When a transaction is added to the mempool, [`Add`](https://github.com/ava-labs/blobvm/blob/master/mempool/mempool.go#L43) is called. This performs the following:
- Checks if the transaction being added already exists in the mempool or not
- The transaction is added to the min-max heap
- If the mempool's heap size is larger than the maximum configured value, then the lowest paying transaction is evicted
- The transaction is added to the list of transactions that are able to be gossiped to other peers
- A notification is sent through the in the `mempool.Pending` channel to indicate that the consensus engine should build a new block
### Block Builder
#### Overview
The [`TimeBuilder`](https://github.com/ava-labs/blobvm/blob/master/vm/block_builder.go) implementation for `BlockBuilder` acts as an intermediary notification service between the mempool and the consensus engine. It serves the following functions:
- Periodically gossips new transactions to other nodes in the network
- Periodically notifies the consensus engine that new transactions from the mempool are ready to be built into blocks
`TimeBuilder` and can exist in 3 states:
- `dontBuild` - There are no transactions in the mempool that are ready to be included in a block
- `building` - The consensus engine has been notified that it should build a block and there are currently transactions in the mempool that are eligible to be included into a block
- `mayBuild` - There are transactions in the mempool that are eligible to be included into a block, but the consensus engine has not been notified yet
#### Gossip Method
The [`Gossip`](https://github.com/ava-labs/blobvm/blob/master/vm/block_builder.go#L183) method initiates the gossip of new transactions from the mempool at periodically as defined by `vm.config.GossipInterval`.
#### Build Method
The [`Build`](https://github.com/ava-labs/blobvm/blob/master/vm/block_builder.go#L166) method consumes transactions from the mempool and signals the consensus engine when it's ready to build a block.
If the mempool signals the `TimeBuilder` that it has available transactions, `TimeBuilder` will signal consensus that the VM is ready to build a block by sending the consensus engine a `common.PendingTxs` message.
When the consensus engine receives the `common.PendingTxs` message it calls the VM's `BuildBlock` method. The VM will then build a block from eligible transactions in the mempool.
If there are still remaining transactions in the mempool after a block is built, then the `TimeBuilder` is put into the `mayBuild` state to indicate that there are still transactions that are eligible to be built into block, but the consensus engine isn't aware of it yet.
### Network
[Network](https://github.com/ava-labs/blobvm/blob/master/vm/network.go) handles the workflow of gossiping transactions from a node's mempool to other nodes in the network.
#### GossipNewTxs Method
`GossipNewTxs` sends a list of transactions to other nodes in the network. `TimeBuilder` calls the network's `GossipNewTxs` function to gossip new transactions in the mempool.
```go
func (n *PushNetwork) GossipNewTxs(newTxs []*chain.Transaction) error {
txs := []*chain.Transaction{}
// Gossip at most the target units of a block at once
for _, tx := range newTxs {
if _, exists := n.gossipedTxs.Get(tx.ID()); exists {
log.Debug("already gossiped, skipping", "txId", tx.ID())
continue
}
n.gossipedTxs.Put(tx.ID(), nil)
txs = append(txs, tx)
}
return n.sendTxs(txs)
}
```
Recently gossiped transactions are maintained in a cache to avoid DDoSing a node from repeated gossip failures.
Other nodes in the network will receive the gossiped transactions through their `AppGossip` handler. Once a gossip message is received, it's deserialized and the new transactions are submitted to the VM.
```go
func (vm *VM) AppGossip(nodeID ids.NodeID, msg []byte) error {
txs := make([]*chain.Transaction, 0)
if _, err := chain.Unmarshal(msg, &txs); err != nil {
return nil
}
// submit incoming gossip
log.Debug("AppGossip transactions are being submitted", "txs", len(txs))
if errs := vm.Submit(txs...); len(errs) > 0 {
for _, err := range errs {
}
}
return nil
}
```
### Block
Blocks go through a lifecycle of being proposed by a validator, verified, and decided by consensus. Upon acceptance, a block will be committed and will be finalized on the blockchain.
BlobVM implements two types of blocks, `StatefulBlock` and `StatelessBlock`.
#### StatefulBlock
A [`StatefulBlock`](https://github.com/ava-labs/blobvm/blob/master/chain/block.go#L27) contains strictly the metadata about the block that needs to be written to the database.
```go
type StatefulBlock struct {
Prnt ids.ID `serialize:"true" json:"parent"`
Tmstmp int64 `serialize:"true" json:"timestamp"`
Hght uint64 `serialize:"true" json:"height"`
Price uint64 `serialize:"true" json:"price"`
Cost uint64 `serialize:"true" json:"cost"`
AccessProof common.Hash `serialize:"true" json:"accessProof"`
Txs []*Transaction `serialize:"true" json:"txs"`
}
```
#### StatelessBlock
[StatelessBlock](https://github.com/ava-labs/blobvm/blob/master/chain/block.go#L40) is a superset of `StatefulBlock` and additionally contains fields that are needed to support block-level operations like verification and acceptance throughout its lifecycle in the VM.
```go
type StatelessBlock struct {
*StatefulBlock `serialize:"true" json:"block"`
id ids.ID
st choices.Status
t time.Time
bytes []byte
vm VM
children []*StatelessBlock
onAcceptDB *versiondb.Database
}
```
Let's have a look at the fields of StatelessBlock:
- `StatefulBlock`: The metadata about the block that will be written to the database upon acceptance
- `bytes`: The serialized form of the `StatefulBlock`.
- `id`: The Keccak256 hash of `bytes`.
- `st`: The status of the block in consensus (i.e `Processing`, `Accepted`, or `Rejected`)
- `children`: The children of this block
- `onAcceptDB`: The database this block should be written to upon acceptance.
When the consensus engine tries to build a block by calling the VM's `BuildBlock`, the VM calls the [`block.NewBlock`](https://github.com/ava-labs/blobvm/blob/master/chain/block.go#L53) function to get a new block that is a child of the currently preferred block.
```go
func NewBlock(vm VM, parent snowman.Block, tmstp int64, context *Context) *StatelessBlock {
return &StatelessBlock{
StatefulBlock: &StatefulBlock{
Tmstmp: tmstp,
Prnt: parent.ID(),
Hght: parent.Height() + 1,
Price: context.NextPrice,
Cost: context.NextCost,
},
vm: vm,
st: choices.Processing,
}
}
```
Some `StatelessBlock` fields like the block ID, byte representation, and timestamp aren't populated immediately. These are set during the `StatelessBlock`'s [`init`](https://github.com/ava-labs/blobvm/blob/master/chain/block.go#L113) method, which initializes these fields once the block has been populated with transactions.
```go
func (b *StatelessBlock) init() error {
bytes, err := Marshal(b.StatefulBlock)
if err != nil {
return err
}
b.bytes = bytes
id, err := ids.ToID(crypto.Keccak256(b.bytes))
if err != nil {
return err
}
b.id = id
b.t = time.Unix(b.StatefulBlock.Tmstmp, 0)
g := b.vm.Genesis()
for _, tx := range b.StatefulBlock.Txs {
if err := tx.Init(g); err != nil {
return err
}
}
return nil
}
```
To build the block, the VM will try to remove as many of the highest-paying transactions from the mempool to include them in the new block until the maximum block fee set by genesis is reached.
A block once built, can exist in two states:
1. Rejected: The block was not accepted by consensus. In this case, the mempool will reclaim the rejected block's transactions so they can be included in a future block.
2. Accepted: The block was accepted by consensus. In this case, we write the block to the blockchain by committing it to the database.
When the consensus engine receives the built block, it calls the block's [`Verify`](https://github.com/ava-labs/blobvm/blob/master/chain/block.go#L228) method to validate that the block is well-formed. In BlobVM, the following constraints are placed on valid blocks:
1. A block must contain at least one transaction and the block's timestamp must be within 10s into the future.
```go
if len(b.Txs) == 0 {
return nil, nil, ErrNoTxs
}
if b.Timestamp().Unix() >= time.Now().Add(futureBound).Unix() {
return nil, nil, ErrTimestampTooLate
}
```
2. The sum of the gas units consumed by the transactions in the block must not exceed the gas limit defined by genesis.
```go
blockSize := uint64(0)
for _, tx := range b.Txs {
blockSize += tx.LoadUnits(g)
if blockSize > g.MaxBlockSize {
return nil, nil, ErrBlockTooBig
}
}
```
3. The parent block of the proposed block must exist and have an earlier timestamp.
```go
parent, err := b.vm.GetStatelessBlock(b.Prnt)
if err != nil {
log.Debug("could not get parent", "id", b.Prnt)
return nil, nil, err
}
if b.Timestamp().Unix() < parent.Timestamp().Unix() {
return nil, nil, ErrTimestampTooEarly
}
```
4. The target block price and minimum gas price must meet the minimum enforced by the VM.
```go
context, err := b.vm.ExecutionContext(b.Tmstmp, parent)
if err != nil {
return nil, nil, err
}
if b.Cost != context.NextCost {
return nil, nil, ErrInvalidCost
}
if b.Price != context.NextPrice {
return nil, nil, ErrInvalidPrice
}
```
After the results of consensus are complete, the block is either accepted by committing the block to the database or rejected by returning the block's transactions into the mempool.
```go
// implements "snowman.Block.choices.Decidable"
func (b *StatelessBlock) Accept() error {
if err := b.onAcceptDB.Commit(); err != nil {
return err
}
for _, child := range b.children {
if err := child.onAcceptDB.SetDatabase(b.vm.State()); err != nil {
return err
}
}
b.st = choices.Accepted
b.vm.Accepted(b)
return nil
}
// implements "snowman.Block.choices.Decidable"
func (b *StatelessBlock) Reject() error {
b.st = choices.Rejected
b.vm.Rejected(b)
return nil
}
```
### API
[Service](https://github.com/ava-labs/blobvm/blob/master/vm/public_service.go) implements an API server so users can interact with the VM. The VM implements the interface method [`CreateHandlers`](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L267) that exposes the VM's RPC API.
```go
func (vm *VM) CreateHandlers() (map[string]*common.HTTPHandler, error) {
apis := map[string]*common.HTTPHandler{}
public, err := newHandler(Name, &PublicService{vm: vm})
if err != nil {
return nil, err
}
apis[PublicEndpoint] = public
return apis, nil
}
```
One API that's exposed is [`IssueRawTx`](https://github.com/ava-labs/blobvm/blob/master/vm/public_service.go#L63) to allow users to issue transactions to the BlobVM. It accepts an `IssueRawTxArgs` that contains the transaction the user wants to issue and forwards it to the VM.
```go
func (svc *PublicService) IssueRawTx(_ *http.Request, args *IssueRawTxArgs, reply *IssueRawTxReply) error {
tx := new(chain.Transaction)
if _, err := chain.Unmarshal(args.Tx, tx); err != nil {
return err
}
// otherwise, unexported tx.id field is empty
if err := tx.Init(svc.vm.genesis); err != nil {
return err
}
reply.TxID = tx.ID()
errs := svc.vm.Submit(tx)
if len(errs) == 0 {
return nil
}
if len(errs) == 1 {
return errs[0]
}
return fmt.Errorf("%v", errs)
}
```
### Virtual Machine
We have learned about all the components used in the BlobVM. Most of these components are referenced in the `vm.go` file, which acts as the entry point for the consensus engine as well as users interacting with the blockchain.
For example, the engine calls `vm.BuildBlock()`, that in turn calls `chain.BuildBlock()`. Another example is when a user issues a raw transaction through service APIs, the `vm.Submit()` method is called.
Let's look at some of the important methods of `vm.go` that must be implemented:
#### Initialize Method
[Initialize](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L93) is invoked by `avalanchego` when creating the blockchain. `avalanchego` passes some parameters to the implementing VM.
- `ctx` - Metadata about the VM's execution
- `dbManager` - The database that the VM can write to
- `genesisBytes` - The serialized representation of the genesis state of this VM
- `upgradeBytes` - The serialized representation of network upgrades
- `configBytes` - The serialized VM-specific [configuration](https://github.com/ava-labs/blobvm/blob/master/vm/config.go#L10)
- `toEngine` - The channel used to send messages to the consensus engine
- `fxs` - Feature extensions that attach to this VM
- `appSender` - Used to send messages to other nodes in the network
BlobVM upon initialization persists these fields in its own state to use them throughout the lifetime of its execution.
```go
// implements "snowmanblock.ChainVM.common.VM"
func (vm *VM) Initialize(
ctx *snow.Context,
dbManager manager.Manager,
genesisBytes []byte,
upgradeBytes []byte,
configBytes []byte,
toEngine chan<- common.Message,
_ []*common.Fx,
appSender common.AppSender,
) error {
log.Info("initializing blobvm", "version", version.Version)
// Load config
vm.config.SetDefaults()
if len(configBytes) > 0 {
if err := ejson.Unmarshal(configBytes, &vm.config); err != nil {
return fmt.Errorf("failed to unmarshal config %s: %w", string(configBytes), err)
}
}
vm.ctx = ctx
vm.db = dbManager.Current().Database
vm.activityCache = make([]*chain.Activity, vm.config.ActivityCacheSize)
// Init channels before initializing other structs
vm.stop = make(chan struct{})
vm.builderStop = make(chan struct{})
vm.doneBuild = make(chan struct{})
vm.doneGossip = make(chan struct{})
vm.appSender = appSender
vm.network = vm.NewPushNetwork()
vm.blocks = &cache.LRU{Size: blocksLRUSize}
vm.verifiedBlocks = make(map[ids.ID]*chain.StatelessBlock)
vm.toEngine = toEngine
vm.builder = vm.NewTimeBuilder()
// Try to load last accepted
has, err := chain.HasLastAccepted(vm.db)
if err != nil {
log.Error("could not determine if have last accepted")
return err
}
// Parse genesis data
vm.genesis = new(chain.Genesis)
if err := ejson.Unmarshal(genesisBytes, vm.genesis); err != nil {
log.Error("could not unmarshal genesis bytes")
return err
}
if err := vm.genesis.Verify(); err != nil {
log.Error("genesis is invalid")
return err
}
targetUnitsPerSecond := vm.genesis.TargetBlockSize / uint64(vm.genesis.TargetBlockRate)
vm.targetRangeUnits = targetUnitsPerSecond * uint64(vm.genesis.LookbackWindow)
log.Debug("loaded genesis", "genesis", string(genesisBytes), "target range units", vm.targetRangeUnits)
vm.mempool = mempool.New(vm.genesis, vm.config.MempoolSize)
if has { //nolint:nestif
blkID, err := chain.GetLastAccepted(vm.db)
if err != nil {
log.Error("could not get last accepted", "err", err)
return err
}
blk, err := vm.GetStatelessBlock(blkID)
if err != nil {
log.Error("could not load last accepted", "err", err)
return err
}
vm.preferred, vm.lastAccepted = blkID, blk
log.Info("initialized blobvm from last accepted", "block", blkID)
} else {
genesisBlk, err := chain.ParseStatefulBlock(
vm.genesis.StatefulBlock(),
nil,
choices.Accepted,
vm,
)
if err != nil {
log.Error("unable to init genesis block", "err", err)
return err
}
// Set Balances
if err := vm.genesis.Load(vm.db, vm.AirdropData); err != nil {
log.Error("could not set genesis allocation", "err", err)
return err
}
if err := chain.SetLastAccepted(vm.db, genesisBlk); err != nil {
log.Error("could not set genesis as last accepted", "err", err)
return err
}
gBlkID := genesisBlk.ID()
vm.preferred, vm.lastAccepted = gBlkID, genesisBlk
log.Info("initialized blobvm from genesis", "block", gBlkID)
}
vm.AirdropData = nil
}
```
After initializing its own state, BlobVM also starts asynchronous workers to build blocks and gossip transactions to the rest of the network.
```
{
go vm.builder.Build()
go vm.builder.Gossip()
return nil
}
```
#### GetBlock Method
[`GetBlock`](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L318) returns the block with the provided ID. GetBlock will attempt to fetch the given block from the database, and return an non-nil error if it wasn't able to get it.
```go
func (vm *VM) GetBlock(id ids.ID) (snowman.Block, error) {
b, err := vm.GetStatelessBlock(id)
if err != nil {
log.Warn("failed to get block", "err", err)
}
return b, err
}
```
#### ParseBlock Method
[`ParseBlock`](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L373) deserializes a block.
```go
func (vm *VM) ParseBlock(source []byte) (snowman.Block, error) {
newBlk, err := chain.ParseBlock(
source,
choices.Processing,
vm,
)
if err != nil {
log.Error("could not parse block", "err", err)
return nil, err
}
log.Debug("parsed block", "id", newBlk.ID())
// If we have seen this block before, return it with the most
// up-to-date info
if oldBlk, err := vm.GetBlock(newBlk.ID()); err == nil {
log.Debug("returning previously parsed block", "id", oldBlk.ID())
return oldBlk, nil
}
return newBlk, nil
}
```
#### BuildBlock Method
Avalanche consensus calls [`BuildBlock`](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L397) when it receives a notification from the VM that it has pending transactions that are ready to be issued into a block.
```go
func (vm *VM) BuildBlock() (snowman.Block, error) {
log.Debug("BuildBlock triggered")
blk, err := chain.BuildBlock(vm, vm.preferred)
vm.builder.HandleGenerateBlock()
if err != nil {
log.Debug("BuildBlock failed", "error", err)
return nil, err
}
sblk, ok := blk.(*chain.StatelessBlock)
if !ok {
return nil, fmt.Errorf("unexpected snowman.Block %T, expected *StatelessBlock", blk)
}
log.Debug("BuildBlock success", "blkID", blk.ID(), "txs", len(sblk.Txs))
return blk, nil
}
```
#### SetPreference Method
[`SetPreference`](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L457) sets the block ID preferred by this node. A node votes to accept or reject a block based on its current preference in consensus.
```go
func (vm *VM) SetPreference(id ids.ID) error {
log.Debug("set preference", "id", id)
vm.preferred = id
return nil
}
```
#### LastAccepted Method
[LastAccepted](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L465) returns the block ID of the block that was most recently accepted by this node.
```go
func (vm *VM) LastAccepted() (ids.ID, error) {
return vm.lastAccepted.ID(), nil
}
```
### CLI
BlobVM implements a generic key-value store, but support to read and write arbitrary files into the BlobVM blockchain is implemented in the `blob-cli`
To write a file, BlobVM breaks apart an arbitrarily large file into many small chunks. Each chunk is submitted to the VM in a `SetTx`. A root key is generated which contains all of the hashes of the chunks.
```go
func Upload(
ctx context.Context, cli client.Client, priv *ecdsa.PrivateKey,
f io.Reader, chunkSize int,
) (common.Hash, error) {
hashes := []common.Hash{}
chunk := make([]byte, chunkSize)
shouldExit := false
opts := []client.OpOption{client.WithPollTx()}
totalCost := uint64(0)
uploaded := map[common.Hash]struct{}{}
for !shouldExit {
read, err := f.Read(chunk)
if errors.Is(err, io.EOF) || read == 0 {
break
}
if err != nil {
return common.Hash{}, fmt.Errorf("%w: read error", err)
}
if read < chunkSize {
shouldExit = true
chunk = chunk[:read]
// Use small file optimization
if len(hashes) == 0 {
break
}
}
k := chain.ValueHash(chunk)
if _, ok := uploaded[k]; ok {
color.Yellow("already uploaded k=%s, skipping", k)
} else if exists, _, _, err := cli.Resolve(ctx, k); err == nil && exists {
color.Yellow("already on-chain k=%s, skipping", k)
uploaded[k] = struct{}{}
} else {
tx := &chain.SetTx{
BaseTx: &chain.BaseTx{},
Value: chunk,
}
txID, cost, err := client.SignIssueRawTx(ctx, cli, tx, priv, opts...)
if err != nil {
return common.Hash{}, err
}
totalCost += cost
color.Yellow("uploaded k=%s txID=%s cost=%d totalCost=%d", k, txID, cost, totalCost)
uploaded[k] = struct{}{}
}
hashes = append(hashes, k)
}
r := &Root{}
if len(hashes) == 0 {
if len(chunk) == 0 {
return common.Hash{}, ErrEmpty
}
r.Contents = chunk
} else {
r.Children = hashes
}
rb, err := json.Marshal(r)
if err != nil {
return common.Hash{}, err
}
rk := chain.ValueHash(rb)
tx := &chain.SetTx{
BaseTx: &chain.BaseTx{},
Value: rb,
}
txID, cost, err := client.SignIssueRawTx(ctx, cli, tx, priv, opts...)
if err != nil {
return common.Hash{}, err
}
totalCost += cost
color.Yellow("uploaded root=%v txID=%s cost=%d totalCost=%d", rk, txID, cost, totalCost)
return rk, nil
}
```
#### Example 1
```bash
blob-cli set-file ~/Downloads/computer.gif -> 6fe5a52f52b34fb1e07ba90bad47811c645176d0d49ef0c7a7b4b22013f676c8
```
Given the root hash, a file can be looked up by deserializing all of its children chunk values and reconstructing the original file.
```go
// TODO: make multi-threaded
func Download(ctx context.Context, cli client.Client, root common.Hash, f io.Writer) error {
exists, rb, _, err := cli.Resolve(ctx, root)
if err != nil {
return err
}
if !exists {
return fmt.Errorf("%w:%v", ErrMissing, root)
}
var r Root
if err := json.Unmarshal(rb, &r); err != nil {
return err
}
// Use small file optimization
if contentLen := len(r.Contents); contentLen > 0 {
if _, err := f.Write(r.Contents); err != nil {
return err
}
color.Yellow("downloaded root=%v size=%fKB", root, float64(contentLen)/units.KiB)
return nil
}
if len(r.Children) == 0 {
return ErrEmpty
}
amountDownloaded := 0
for _, h := range r.Children {
exists, b, _, err := cli.Resolve(ctx, h)
if err != nil {
return err
}
if !exists {
return fmt.Errorf("%w:%s", ErrMissing, h)
}
if _, err := f.Write(b); err != nil {
return err
}
size := len(b)
color.Yellow("downloaded chunk=%v size=%fKB", h, float64(size)/units.KiB)
amountDownloaded += size
}
color.Yellow("download complete root=%v size=%fMB", root, float64(amountDownloaded)/units.MiB)
return nil
}
```
#### Example 2
```bash
blob-cli resolve-file 6fe5a52f52b34fb1e07ba90bad47811c645176d0d49ef0c7a7b4b22013f676c8 computer_copy.gif
```
## Conclusion
This documentation covers concepts about Virtual Machine by walking through a VM that implements a decentralized key-value store.
You can learn more about the BlobVM by referencing the [README](https://github.com/ava-labs/blobvm/blob/master/README.md) in the GitHub repository.
# Simple Golang VM (/docs/avalanche-l1s/golang-vms/simple-golang-vm)
---
title: Simple Golang VM
description: In this tutorial, we will learn how to build a virtual machine by referencing the TimestampVM.
---
In this tutorial, we'll create a very simple VM called the [TimestampVM](https://github.com/ava-labs/timestampvm/tree/v1.2.1). Each block in the TimestampVM's blockchain contains a strictly increasing timestamp when the block was created and a 32-byte payload of data.
Such a server is useful because it can be used to prove a piece of data existed at the time the block was created. Suppose you have a book manuscript, and you want to be able to prove in the future that the manuscript exists today. You can add a block to the blockchain where the block's payload is a hash of your manuscript. In the future, you can prove that the manuscript existed today by showing that the block has the hash of your manuscript in its payload (this follows from the fact that finding the pre-image of a hash is impossible).
## TimestampVM Implementation
Now we know the interface our VM must implement and the libraries we can use to build a VM.
Let's write our VM, which implements `block.ChainVM` and whose blocks implement `snowman.Block`. You can also follow the code in the [TimestampVM repository](https://github.com/ava-labs/timestampvm/tree/main).
### Codec
`Codec` is required to encode/decode the block into byte representation. TimestampVM uses the default codec and manager.
```go title="timestampvm/codec.go"
const (
// CodecVersion is the current default codec version
CodecVersion = 0
)
// Codecs do serialization and deserialization
var (
Codec codec.Manager
)
func init() {
// Create default codec and manager
c := linearcodec.NewDefault()
Codec = codec.NewDefaultManager()
// Register codec to manager with CodecVersion
if err := Codec.RegisterCodec(CodecVersion, c); err != nil {
panic(err)
}
}
```
### State
The `State` interface defines the database layer and connections. Each VM should define their own database methods. `State` embeds the `BlockState` which defines block-related state operations.
```go title="timestampvm/state.go"
var (
// These are prefixes for db keys.
// It's important to set different prefixes for each separate database objects.
singletonStatePrefix = []byte("singleton")
blockStatePrefix = []byte("block")
_ State = &state{}
)
// State is a wrapper around avax.SingleTonState and BlockState
// State also exposes a few methods needed for managing database commits and close.
type State interface {
// SingletonState is defined in avalanchego,
// it is used to understand if db is initialized already.
avax.SingletonState
BlockState
Commit() error
Close() error
}
type state struct {
avax.SingletonState
BlockState
baseDB *versiondb.Database
}
func NewState(db database.Database, vm *VM) State {
// create a new baseDB
baseDB := versiondb.New(db)
// create a prefixed "blockDB" from baseDB
blockDB := prefixdb.New(blockStatePrefix, baseDB)
// create a prefixed "singletonDB" from baseDB
singletonDB := prefixdb.New(singletonStatePrefix, baseDB)
// return state with created sub state components
return &state{
BlockState: NewBlockState(blockDB, vm),
SingletonState: avax.NewSingletonState(singletonDB),
baseDB: baseDB,
}
}
// Commit commits pending operations to baseDB
func (s *state) Commit() error {
return s.baseDB.Commit()
}
// Close closes the underlying base database
func (s *state) Close() error {
return s.baseDB.Close()
}
```
#### Block State
This interface and implementation provides storage functions to VM to store and retrieve blocks.
```go title="timestampvm/block_state.go"
const (
lastAcceptedByte byte = iota
)
const (
// maximum block capacity of the cache
blockCacheSize = 8192
)
// persists lastAccepted block IDs with this key
var lastAcceptedKey = []byte{lastAcceptedByte}
var _ BlockState = &blockState{}
// BlockState defines methods to manage state with Blocks and LastAcceptedIDs.
type BlockState interface {
GetBlock(blkID ids.ID) (*Block, error)
PutBlock(blk *Block) error
GetLastAccepted() (ids.ID, error)
SetLastAccepted(ids.ID) error
}
// blockState implements BlocksState interface with database and cache.
type blockState struct {
// cache to store blocks
blkCache cache.Cacher
// block database
blockDB database.Database
lastAccepted ids.ID
// vm reference
vm *VM
}
// blkWrapper wraps the actual blk bytes and status to persist them together
type blkWrapper struct {
Blk []byte `serialize:"true"`
Status choices.Status `serialize:"true"`
}
// NewBlockState returns BlockState with a new cache and given db
func NewBlockState(db database.Database, vm *VM) BlockState {
return &blockState{
blkCache: &cache.LRU{Size: blockCacheSize},
blockDB: db,
vm: vm,
}
}
// GetBlock gets Block from either cache or database
func (s *blockState) GetBlock(blkID ids.ID) (*Block, error) {
// Check if cache has this blkID
if blkIntf, cached := s.blkCache.Get(blkID); cached {
// there is a key but value is nil, so return an error
if blkIntf == nil {
return nil, database.ErrNotFound
}
// We found it return the block in cache
return blkIntf.(*Block), nil
}
// get block bytes from db with the blkID key
wrappedBytes, err := s.blockDB.Get(blkID[:])
if err != nil {
// we could not find it in the db, let's cache this blkID with nil value
// so next time we try to fetch the same key we can return error
// without hitting the database
if err == database.ErrNotFound {
s.blkCache.Put(blkID, nil)
}
// could not find the block, return error
return nil, err
}
// first decode/unmarshal the block wrapper so we can have status and block bytes
blkw := blkWrapper{}
if _, err := Codec.Unmarshal(wrappedBytes, &blkw); err != nil {
return nil, err
}
// now decode/unmarshal the actual block bytes to block
blk := &Block{}
if _, err := Codec.Unmarshal(blkw.Blk, blk); err != nil {
return nil, err
}
// initialize block with block bytes, status and vm
blk.Initialize(blkw.Blk, blkw.Status, s.vm)
// put block into cache
s.blkCache.Put(blkID, blk)
return blk, nil
}
// PutBlock puts block into both database and cache
func (s *blockState) PutBlock(blk *Block) error {
// create block wrapper with block bytes and status
blkw := blkWrapper{
Blk: blk.Bytes(),
Status: blk.Status(),
}
// encode block wrapper to its byte representation
wrappedBytes, err := Codec.Marshal(CodecVersion, &blkw)
if err != nil {
return err
}
blkID := blk.ID()
// put actual block to cache, so we can directly fetch it from cache
s.blkCache.Put(blkID, blk)
// put wrapped block bytes into database
return s.blockDB.Put(blkID[:], wrappedBytes)
}
// DeleteBlock deletes block from both cache and database
func (s *blockState) DeleteBlock(blkID ids.ID) error {
s.blkCache.Put(blkID, nil)
return s.blockDB.Delete(blkID[:])
}
// GetLastAccepted returns last accepted block ID
func (s *blockState) GetLastAccepted() (ids.ID, error) {
// check if we already have lastAccepted ID in state memory
if s.lastAccepted != ids.Empty {
return s.lastAccepted, nil
}
// get lastAccepted bytes from database with the fixed lastAcceptedKey
lastAcceptedBytes, err := s.blockDB.Get(lastAcceptedKey)
if err != nil {
return ids.ID{}, err
}
// parse bytes to ID
lastAccepted, err := ids.ToID(lastAcceptedBytes)
if err != nil {
return ids.ID{}, err
}
// put lastAccepted ID into memory
s.lastAccepted = lastAccepted
return lastAccepted, nil
}
// SetLastAccepted persists lastAccepted ID into both cache and database
func (s *blockState) SetLastAccepted(lastAccepted ids.ID) error {
// if the ID in memory and the given memory are same don't do anything
if s.lastAccepted == lastAccepted {
return nil
}
// put lastAccepted ID to memory
s.lastAccepted = lastAccepted
// persist lastAccepted ID to database with fixed lastAcceptedKey
return s.blockDB.Put(lastAcceptedKey, lastAccepted[:])
}
```
### Block
Let's look at our block implementation. The type declaration is:
```go title="timestampvm/block.go"
// Block is a block on the chain.
// Each block contains:
// 1) ParentID
// 2) Height
// 3) Timestamp
// 4) A piece of data (a string)
type Block struct {
PrntID ids.ID `serialize:"true" json:"parentID"` // parent's ID
Hght uint64 `serialize:"true" json:"height"` // This block's height. The genesis block is at height 0.
Tmstmp int64 `serialize:"true" json:"timestamp"` // Time this block was proposed at
Dt [dataLen]byte `serialize:"true" json:"data"` // Arbitrary data
id ids.ID // hold this block's ID
bytes []byte // this block's encoded bytes
status choices.Status // block's status
vm *VM // the underlying VM reference, mostly used for state
}
```
The `serialize:"true"` tag indicates that the field should be included in the byte representation of the block used when persisting the block or sending it to other nodes.
#### Verify
This method verifies that a block is valid and stores it in the memory. It is important to store the verified block in the memory and return them in the `vm.GetBlock` method.
```go title="timestampvm/block.go"
// Verify returns nil iff this block is valid.
// To be valid, it must be that:
// b.parent.Timestamp < b.Timestamp <= [local time] + 1 hour
func (b *Block) Verify() error {
// Get [b]'s parent
parentID := b.Parent()
parent, err := b.vm.getBlock(parentID)
if err != nil {
return errDatabaseGet
}
// Ensure [b]'s height comes right after its parent's height
if expectedHeight := parent.Height() + 1; expectedHeight != b.Hght {
return fmt.Errorf(
"expected block to have height %d, but found %d",
expectedHeight,
b.Hght,
)
}
// Ensure [b]'s timestamp is after its parent's timestamp.
if b.Timestamp().Unix() < parent.Timestamp().Unix() {
return errTimestampTooEarly
}
// Ensure [b]'s timestamp is not more than an hour
// ahead of this node's time
if b.Timestamp().Unix() >= time.Now().Add(time.Hour).Unix() {
return errTimestampTooLate
}
// Put that block to verified blocks in memory
b.vm.verifiedBlocks[b.ID()] = b
return nil
}
```
#### Accept
`Accept` is called by the consensus to indicate this block is accepted.
```go title="timestampvm/block.go"
// Accept sets this block's status to Accepted and sets lastAccepted to this
// block's ID and saves this info to b.vm.DB
func (b *Block) Accept() error {
b.SetStatus(choices.Accepted) // Change state of this block
blkID := b.ID()
// Persist data
if err := b.vm.state.PutBlock(b); err != nil {
return err
}
// Set last accepted ID to this block ID
if err := b.vm.state.SetLastAccepted(blkID); err != nil {
return err
}
// Delete this block from verified blocks as it's accepted
delete(b.vm.verifiedBlocks, b.ID())
// Commit changes to database
return b.vm.state.Commit()
}
```
#### Reject
`Reject` is called by the consensus to indicate this block is rejected.
```go title="timestampvm/block.go"
// Reject sets this block's status to Rejected and saves the status in state
// Recall that b.vm.DB.Commit() must be called to persist to the DB
func (b *Block) Reject() error {
b.SetStatus(choices.Rejected) // Change state of this block
if err := b.vm.state.PutBlock(b); err != nil {
return err
}
// Delete this block from verified blocks as it's rejected
delete(b.vm.verifiedBlocks, b.ID())
// Commit changes to database
return b.vm.state.Commit()
}
```
#### Block Field Methods
These methods are required by the `snowman.Block` interface.
```go title="timestampvm/block.go"
// ID returns the ID of this block
func (b *Block) ID() ids.ID { return b.id }
// ParentID returns [b]'s parent's ID
func (b *Block) Parent() ids.ID { return b.PrntID }
// Height returns this block's height. The genesis block has height 0.
func (b *Block) Height() uint64 { return b.Hght }
// Timestamp returns this block's time. The genesis block has time 0.
func (b *Block) Timestamp() time.Time { return time.Unix(b.Tmstmp, 0) }
// Status returns the status of this block
func (b *Block) Status() choices.Status { return b.status }
// Bytes returns the byte repr. of this block
func (b *Block) Bytes() []byte { return b.bytes }
```
#### Helper Functions
These methods are convenience methods for blocks, they're not a part of the block interface.
```go
// Initialize sets [b.bytes] to [bytes], [b.id] to hash([b.bytes]),
// [b.status] to [status] and [b.vm] to [vm]
func (b *Block) Initialize(bytes []byte, status choices.Status, vm *VM) {
b.bytes = bytes
b.id = hashing.ComputeHash256Array(b.bytes)
b.status = status
b.vm = vm
}
// SetStatus sets the status of this block
func (b *Block) SetStatus(status choices.Status) { b.status = status }
```
### Virtual Machine
Now, let's look at our timestamp VM implementation, which implements the `block.ChainVM` interface. The declaration is:
```go title="timestampvm/vm.go"
// This Virtual Machine defines a blockchain that acts as a timestamp server
// Each block contains data (a payload) and the timestamp when it was created
const (
dataLen = 32
Name = "timestampvm"
)
// VM implements the snowman.VM interface
// Each block in this chain contains a Unix timestamp
// and a piece of data (a string)
type VM struct {
// The context of this vm
ctx *snow.Context
dbManager manager.Manager
// State of this VM
state State
// ID of the preferred block
preferred ids.ID
// channel to send messages to the consensus engine
toEngine chan<- common.Message
// Proposed pieces of data that haven't been put into a block and proposed yet
mempool [][dataLen]byte
// Block ID --> Block
// Each element is a block that passed verification but
// hasn't yet been accepted/rejected
verifiedBlocks map[ids.ID]*Block
}
```
#### Initialize
This method is called when a new instance of VM is initialized. Genesis block is created under this method.
```go title="timestampvm/vm.go"
// Initialize this vm
// [ctx] is this vm's context
// [dbManager] is the manager of this vm's database
// [toEngine] is used to notify the consensus engine that new blocks are
// ready to be added to consensus
// The data in the genesis block is [genesisData]
func (vm *VM) Initialize(
ctx *snow.Context,
dbManager manager.Manager,
genesisData []byte,
upgradeData []byte,
configData []byte,
toEngine chan<- common.Message,
_ []*common.Fx,
_ common.AppSender,
) error {
version, err := vm.Version()
if err != nil {
log.Error("error initializing Timestamp VM: %v", err)
return err
}
log.Info("Initializing Timestamp VM", "Version", version)
vm.dbManager = dbManager
vm.ctx = ctx
vm.toEngine = toEngine
vm.verifiedBlocks = make(map[ids.ID]*Block)
// Create new state
vm.state = NewState(vm.dbManager.Current().Database, vm)
// Initialize genesis
if err := vm.initGenesis(genesisData); err != nil {
return err
}
// Get last accepted
lastAccepted, err := vm.state.GetLastAccepted()
if err != nil {
return err
}
ctx.Log.Info("initializing last accepted block as %s", lastAccepted)
// Build off the most recently accepted block
return vm.SetPreference(lastAccepted)
}
```
#### `initGenesis`
`initGenesis` is a helper method which initializes the genesis block from given bytes and puts into the state.
```go title="timestampvm/vm.go"
// Initializes Genesis if required
func (vm *VM) initGenesis(genesisData []byte) error {
stateInitialized, err := vm.state.IsInitialized()
if err != nil {
return err
}
// if state is already initialized, skip init genesis.
if stateInitialized {
return nil
}
if len(genesisData) > dataLen {
return errBadGenesisBytes
}
// genesisData is a byte slice but each block contains an byte array
// Take the first [dataLen] bytes from genesisData and put them in an array
var genesisDataArr [dataLen]byte
copy(genesisDataArr[:], genesisData)
// Create the genesis block
// Timestamp of genesis block is 0. It has no parent.
genesisBlock, err := vm.NewBlock(ids.Empty, 0, genesisDataArr, time.Unix(0, 0))
if err != nil {
log.Error("error while creating genesis block: %v", err)
return err
}
// Put genesis block to state
if err := vm.state.PutBlock(genesisBlock); err != nil {
log.Error("error while saving genesis block: %v", err)
return err
}
// Accept the genesis block
// Sets [vm.lastAccepted] and [vm.preferred]
if err := genesisBlock.Accept(); err != nil {
return fmt.Errorf("error accepting genesis block: %w", err)
}
// Mark this vm's state as initialized, so we can skip initGenesis in further restarts
if err := vm.state.SetInitialized(); err != nil {
return fmt.Errorf("error while setting db to initialized: %w", err)
}
// Flush VM's database to underlying db
return vm.state.Commit()
}
```
#### CreateHandlers
Registered handlers defined in `Service`. See [below](/docs/avalanche-l1s/golang-vms/simple-golang-vm#api) for more on APIs.
```go title="timestampvm/vm.go"
// CreateHandlers returns a map where:
// Keys: The path extension for this blockchain's API (empty in this case)
// Values: The handler for the API
// In this case, our blockchain has only one API, which we name timestamp,
// and it has no path extension, so the API endpoint:
// [Node IP]/ext/bc/[this blockchain's ID]
// See API section in documentation for more information
func (vm *VM) CreateHandlers() (map[string]*common.HTTPHandler, error) {
server := rpc.NewServer()
server.RegisterCodec(json.NewCodec(), "application/json")
server.RegisterCodec(json.NewCodec(), "application/json;charset=UTF-8")
// Name is "timestampvm"
if err := server.RegisterService(&Service{vm: vm}, Name); err != nil {
return nil, err
}
return map[string]*common.HTTPHandler{
"": {
Handler: server,
},
}, nil
}
```
#### CreateStaticHandlers
Registers static handlers defined in `StaticService`. See [below](/docs/avalanche-l1s/golang-vms/simple-golang-vm#static-api) for more on static APIs.
```go title="timestampvm/vm.go"
// CreateStaticHandlers returns a map where:
// Keys: The path extension for this VM's static API
// Values: The handler for that static API
func (vm *VM) CreateStaticHandlers() (map[string]*common.HTTPHandler, error) {
server := rpc.NewServer()
server.RegisterCodec(json.NewCodec(), "application/json")
server.RegisterCodec(json.NewCodec(), "application/json;charset=UTF-8")
if err := server.RegisterService(&StaticService{}, Name); err != nil {
return nil, err
}
return map[string]*common.HTTPHandler{
"": {
LockOptions: common.NoLock,
Handler: server,
},
}, nil
}
```
#### BuildBock
`BuildBlock` builds a new block and returns it. This is mainly requested by the consensus engine.
```go title="timestampvm/vm.go"
// BuildBlock returns a block that this vm wants to add to consensus
func (vm *VM) BuildBlock() (snowman.Block, error) {
if len(vm.mempool) == 0 { // There is no block to be built
return nil, errNoPendingBlocks
}
// Get the value to put in the new block
value := vm.mempool[0]
vm.mempool = vm.mempool[1:]
// Notify consensus engine that there are more pending data for blocks
// (if that is the case) when done building this block
if len(vm.mempool) > 0 {
defer vm.NotifyBlockReady()
}
// Gets Preferred Block
preferredBlock, err := vm.getBlock(vm.preferred)
if err != nil {
return nil, fmt.Errorf("couldn't get preferred block: %w", err)
}
preferredHeight := preferredBlock.Height()
// Build the block with preferred height
newBlock, err := vm.NewBlock(vm.preferred, preferredHeight+1, value, time.Now())
if err != nil {
return nil, fmt.Errorf("couldn't build block: %w", err)
}
// Verifies block
if err := newBlock.Verify(); err != nil {
return nil, err
}
return newBlock, nil
}
```
#### NotifyBlockReady
`NotifyBlockReady` is a helper method that can send messages to the consensus engine through `toEngine` channel.
```go title="timestampvm/vm.go"
// NotifyBlockReady tells the consensus engine that a new block
// is ready to be created
func (vm *VM) NotifyBlockReady() {
select {
case vm.toEngine <- common.PendingTxs:
default:
vm.ctx.Log.Debug("dropping message to consensus engine")
}
}
```
#### GetBlock
`GetBlock` returns the block with the given block ID.
```go title="timestampvm/vm.go"
// GetBlock implements the snowman.ChainVM interface
func (vm *VM) GetBlock(blkID ids.ID) (snowman.Block, error) { return vm.getBlock(blkID) }
func (vm *VM) getBlock(blkID ids.ID) (*Block, error) {
// If block is in memory, return it.
if blk, exists := vm.verifiedBlocks[blkID]; exists {
return blk, nil
}
return vm.state.GetBlock(blkID)
}
```
#### `proposeBlock`
This method adds a piece of data to the mempool and notifies the consensus layer of the blockchain that a new block is ready to be built and voted on. This is called by API method `ProposeBlock`, which we'll see later.
```go title="timestampvm/vm.go"
// proposeBlock appends [data] to [p.mempool].
// Then it notifies the consensus engine
// that a new block is ready to be added to consensus
// (namely, a block with data [data])
func (vm *VM) proposeBlock(data [dataLen]byte) {
vm.mempool = append(vm.mempool, data)
vm.NotifyBlockReady()
}
```
#### ParseBlock
Parse a block from its byte representation.
```go title="timestampvm/vm.go"
// ParseBlock parses [bytes] to a snowman.Block
// This function is used by the vm's state to unmarshal blocks saved in state
// and by the consensus layer when it receives the byte representation of a block
// from another node
func (vm *VM) ParseBlock(bytes []byte) (snowman.Block, error) {
// A new empty block
block := &Block{}
// Unmarshal the byte repr. of the block into our empty block
_, err := Codec.Unmarshal(bytes, block)
if err != nil {
return nil, err
}
// Initialize the block
block.Initialize(bytes, choices.Processing, vm)
if blk, err := vm.getBlock(block.ID()); err == nil {
// If we have seen this block before, return it with the most up-to-date
// info
return blk, nil
}
// Return the block
return block, nil
}
```
#### NewBlock
`NewBlock` creates a new block with given block parameters.
```go title="timestampvm/vm.go"
// NewBlock returns a new Block where:
// - the block's parent is [parentID]
// - the block's data is [data]
// - the block's timestamp is [timestamp]
func (vm *VM) NewBlock(parentID ids.ID, height uint64, data [dataLen]byte, timestamp time.Time) (*Block, error) {
block := &Block{
PrntID: parentID,
Hght: height,
Tmstmp: timestamp.Unix(),
Dt: data,
}
// Get the byte representation of the block
blockBytes, err := Codec.Marshal(CodecVersion, block)
if err != nil {
return nil, err
}
// Initialize the block by providing it with its byte representation
// and a reference to this VM
block.Initialize(blockBytes, choices.Processing, vm)
return block, nil
}
```
#### SetPreference
`SetPreference` implements the `block.ChainVM`. It sets the preferred block ID.
```go title="timestampvm/vm.go"
// SetPreference sets the block with ID [ID] as the preferred block
func (vm *VM) SetPreference(id ids.ID) error {
vm.preferred = id
return nil
}
```
#### Other Functions
These functions needs to be implemented for `block.ChainVM`. Most of them are just blank functions returning `nil`.
```go title="timestampvm/vm.go"
// Bootstrapped marks this VM as bootstrapped
func (vm *VM) Bootstrapped() error { return nil }
// Bootstrapping marks this VM as bootstrapping
func (vm *VM) Bootstrapping() error { return nil }
// Returns this VM's version
func (vm *VM) Version() (string, error) {
return Version.String(), nil
}
func (vm *VM) Connected(id ids.ShortID, nodeVersion version.Application) error {
return nil // noop
}
func (vm *VM) Disconnected(id ids.ShortID) error {
return nil // noop
}
// This VM doesn't (currently) have any app-specific messages
func (vm *VM) AppGossip(nodeID ids.ShortID, msg []byte) error {
return nil
}
// This VM doesn't (currently) have any app-specific messages
func (vm *VM) AppRequest(nodeID ids.ShortID, requestID uint32, time time.Time, request []byte) error {
return nil
}
// This VM doesn't (currently) have any app-specific messages
func (vm *VM) AppResponse(nodeID ids.ShortID, requestID uint32, response []byte) error {
return nil
}
// This VM doesn't (currently) have any app-specific messages
func (vm *VM) AppRequestFailed(nodeID ids.ShortID, requestID uint32) error {
return nil
}
// Health implements the common.VM interface
func (vm *VM) HealthCheck() (interface{}, error) { return nil, nil }
```
### Factory
VMs should implement the `Factory` interface. `New` method in the interface returns a new VM instance.
```go title="timestampvm/factory.go"
var _ vms.Factory = &Factory{}
// Factory ...
type Factory struct{}
// New ...
func (f *Factory) New(*snow.Context) (interface{}, error) { return &VM{}, nil }
```
### Static API
A VM may have a static API, which allows clients to call methods that do not query or update the state of a particular blockchain, but rather apply to the VM as a whole. This is analogous to static methods in computer programming. AvalancheGo uses [Gorilla's RPC library](https://www.gorillatoolkit.org/pkg/rpc) to implement HTTP APIs. `StaticService` implements the static API for our VM.
```go title="timestampvm/static_service.go"
// StaticService defines the static API for the timestamp vm
type StaticService struct{}
```
#### Encode
For each API method, there is:
- A struct that defines the method's arguments
- A struct that defines the method's return values
- A method that implements the API method, and is parameterized on the above 2 structs
This API method encodes a string to its byte representation using a given encoding scheme. It can be used to encode data that is then put in a block and proposed as the next block for this chain.
```go title="timestampvm/static_service.go"
// EncodeArgs are arguments for Encode
type EncodeArgs struct {
Data string `json:"data"`
Encoding formatting.Encoding `json:"encoding"`
Length int32 `json:"length"`
}
// EncodeReply is the reply from Encoder
type EncodeReply struct {
Bytes string `json:"bytes"`
Encoding formatting.Encoding `json:"encoding"`
}
// Encoder returns the encoded data
func (ss *StaticService) Encode(_ *http.Request, args *EncodeArgs, reply *EncodeReply) error {
if len(args.Data) == 0 {
return fmt.Errorf("argument Data cannot be empty")
}
var argBytes []byte
if args.Length > 0 {
argBytes = make([]byte, args.Length)
copy(argBytes, args.Data)
} else {
argBytes = []byte(args.Data)
}
bytes, err := formatting.EncodeWithChecksum(args.Encoding, argBytes)
if err != nil {
return fmt.Errorf("couldn't encode data as string: %s", err)
}
reply.Bytes = bytes
reply.Encoding = args.Encoding
return nil
}
```
#### Decode
This API method is the inverse of `Encode`.
```go title="timestampvm/static_service.go"
// DecoderArgs are arguments for Decode
type DecoderArgs struct {
Bytes string `json:"bytes"`
Encoding formatting.Encoding `json:"encoding"`
}
// DecoderReply is the reply from Decoder
type DecoderReply struct {
Data string `json:"data"`
Encoding formatting.Encoding `json:"encoding"`
}
// Decoder returns the Decoded data
func (ss *StaticService) Decode(_ *http.Request, args *DecoderArgs, reply *DecoderReply) error {
bytes, err := formatting.Decode(args.Encoding, args.Bytes)
if err != nil {
return fmt.Errorf("couldn't Decode data as string: %s", err)
}
reply.Data = string(bytes)
reply.Encoding = args.Encoding
return nil
}
```
### API
A VM may also have a non-static HTTP API, which allows clients to query and update the blockchain's state. `Service`'s declaration is:
```go title="timestampvm/service.go"
// Service is the API service for this VM
type Service struct{ vm *VM }
```
Note that this struct has a reference to the VM, so it can query and update state.
This VM's API has two methods. One allows a client to get a block by its ID. The other allows a client to propose the next block of this blockchain. The blockchain ID in the endpoint changes, since every blockchain has an unique ID.
#### `timestampvm.getBlock`
Get a block by its ID. If no ID is provided, get the latest block.
##### `getBlock` Signature
```
timestampvm.getBlock({id: string}) ->
{
id: string,
data: string,
timestamp: int,
parentID: string
}
```
- `id` is the ID of the block being retrieved. If omitted from arguments, gets the latest block
- `data` is the base 58 (with checksum) representation of the block's 32 byte payload
- `timestamp` is the Unix timestamp when this block was created
- `parentID` is the block's parent
##### `getBlock` Example Call
```bash
curl -X POST --data '{
"jsonrpc": "2.0",
"method": "timestampvm.getBlock",
"params":{
"id":"xqQV1jDnCXDxhfnNT7tDBcXeoH2jC3Hh7Pyv4GXE1z1hfup5K"
},
"id": 1
}' -H 'content-type:application/json;' 127.0.0.1:9650/ext/bc/sw813hGSWH8pdU9uzaYy9fCtYFfY7AjDd2c9rm64SbApnvjmk
```
##### `getBlock` Example Response
```json
{
"jsonrpc": "2.0",
"result": {
"timestamp": "1581717416",
"data": "11111111111111111111111111111111LpoYY",
"id": "xqQV1jDnCXDxhfnNT7tDBcXeoH2jC3Hh7Pyv4GXE1z1hfup5K",
"parentID": "22XLgiM5dfCwTY9iZnVk8ZPuPe3aSrdVr5Dfrbxd3ejpJd7oef"
},
"id": 1
}
```
##### `getBlock` Implementation
```go title="timestampvm/service.go"
// GetBlockArgs are the arguments to GetBlock
type GetBlockArgs struct {
// ID of the block we're getting.
// If left blank, gets the latest block
ID *ids.ID `json:"id"`
}
// GetBlockReply is the reply from GetBlock
type GetBlockReply struct {
Timestamp json.Uint64 `json:"timestamp"` // Timestamp of most recent block
Data string `json:"data"` // Data in the most recent block. Base 58 repr. of 5 bytes.
ID ids.ID `json:"id"` // String repr. of ID of the most recent block
ParentID ids.ID `json:"parentID"` // String repr. of ID of the most recent block's parent
}
// GetBlock gets the block whose ID is [args.ID]
// If [args.ID] is empty, get the latest block
func (s *Service) GetBlock(_ *http.Request, args *GetBlockArgs, reply *GetBlockReply) error {
// If an ID is given, parse its string representation to an ids.ID
// If no ID is given, ID becomes the ID of last accepted block
var (
id ids.ID
err error
)
if args.ID == nil {
id, err = s.vm.state.GetLastAccepted()
if err != nil {
return errCannotGetLastAccepted
}
} else {
id = *args.ID
}
// Get the block from the database
block, err := s.vm.getBlock(id)
if err != nil {
return errNoSuchBlock
}
// Fill out the response with the block's data
reply.ID = block.ID()
reply.Timestamp = json.Uint64(block.Timestamp().Unix())
reply.ParentID = block.Parent()
data := block.Data()
reply.Data, err = formatting.EncodeWithChecksum(formatting.CB58, data[:])
return err
}
```
#### `timestampvm.proposeBlock`
Propose the next block on this blockchain.
##### `proposeBlock` Signature
```go
timestampvm.proposeBlock({data: string}) -> {success: bool}
```
- `data` is the base 58 (with checksum) representation of the proposed block's 32 byte payload.
##### `proposeBlock` Example Call
```bash
curl -X POST --data '{
"jsonrpc": "2.0",
"method": "timestampvm.proposeBlock",
"params":{
"data":"SkB92YpWm4Q2iPnLGCuDPZPgUQMxajqQQuz91oi3xD984f8r"
},
"id": 1
}' -H 'content-type:application/json;' 127.0.0.1:9650/ext/bc/sw813hGSWH8pdU9uzaYy9fCtYFfY7AjDd2c9rm64SbApnvjmk
```
###### `proposeBlock` Example Response
```json
{
"jsonrpc": "2.0",
"result": {
"Success": true
},
"id": 1
}
```
##### `proposeBlock` Implementation
```go title="timestampvm/service.go"
// ProposeBlockArgs are the arguments to ProposeValue
type ProposeBlockArgs struct {
// Data for the new block. Must be base 58 encoding (with checksum) of 32 bytes.
Data string
}
// ProposeBlockReply is the reply from function ProposeBlock
type ProposeBlockReply struct{
// True if the operation was successful
Success bool
}
// ProposeBlock is an API method to propose a new block whose data is [args].Data.
// [args].Data must be a string repr. of a 32 byte array
func (s *Service) ProposeBlock(_ *http.Request, args *ProposeBlockArgs, reply *ProposeBlockReply) error {
bytes, err := formatting.Decode(formatting.CB58, args.Data)
if err != nil || len(bytes) != dataLen {
return errBadData
}
var data [dataLen]byte // The data as an array of bytes
copy(data[:], bytes[:dataLen]) // Copy the bytes in dataSlice to data
s.vm.proposeBlock(data)
reply.Success = true
return nil
}
```
### Plugin
In order to make this VM compatible with `go-plugin`, we need to define a `main` package and method, which serves our VM over gRPC so that AvalancheGo can call its methods. `main.go`'s contents are:
```go title="main/main.go"
func main() {
log.Root().SetHandler(log.LvlFilterHandler(log.LvlDebug, log.StreamHandler(os.Stderr, log.TerminalFormat())))
plugin.Serve(&plugin.ServeConfig{
HandshakeConfig: rpcchainvm.Handshake,
Plugins: map[string]plugin.Plugin{
"vm": rpcchainvm.New(×tampvm.VM{}),
},
// A non-nil value here enables gRPC serving for this plugin...
GRPCServer: plugin.DefaultGRPCServer,
})
}
```
Now AvalancheGo's `rpcchainvm` can connect to this plugin and calls its methods.
### Executable Binary
This VM has a [build script](https://github.com/ava-labs/timestampvm/blob/v1.2.1/scripts/build.sh) that builds an executable of this VM (when invoked, it runs the `main` method from above.)
The path to the executable, as well as its name, can be provided to the build script via arguments. For example:
```bash
./scripts/build.sh ../avalanchego/build/plugins timestampvm
```
If no argument is given, the path defaults to a binary named with default VM ID: `$GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH`
This name `tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH` is the CB58 encoded 32 byte identifier for the VM. For the timestampvm, this is the string "timestamp" zero-extended in a 32 byte array and encoded in CB58.
### VM Aliases
Each VM has a predefined, static ID. For instance, the default ID of the TimestampVM is: `tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH`.
It's possible to give an alias for these IDs. For example, we can alias `TimestampVM` by creating a JSON file at `~/.avalanchego/configs/vms/aliases.json` with:
The name of the VM binary is also its static ID and should not be changed manually. Changing the name of the VM binary will result in AvalancheGo failing to start the VM. To reference a VM by another name, define a VM alias as described below.
```json
{
"tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH": [
"timestampvm",
"timestamp"
]
}
```
### Installing a VM
AvalancheGo searches for and registers plugins under the `plugins` [directory](/docs/nodes/configure/configs-flags#--plugin-dir-string).
To install the virtual machine onto your node, you need to move the built virtual machine binary under this directory. Virtual machine executable names must be either a full virtual machine ID (encoded in CB58), or a VM alias.
Copy the binary into the plugins directory.
```bash
cp -n $GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/
```
#### Node Is Not Running
If your node isn't running yet, you can install all virtual machines under your `plugin` directory by starting the node.
#### Node Is Already Running
Load the binary with the `loadVMs` API.
```bash
curl -sX POST --data '{
"jsonrpc":"2.0",
"id" :1,
"method" :"admin.loadVMs",
"params" :{}
}' -H 'content-type:application/json;' 127.0.0.1:9650/ext/admin
```
Confirm the response of `loadVMs` contains the newly installed virtual machine `tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH`. You'll see this virtual machine as well as any others that weren't already installed previously in the response.
```json
{
"jsonrpc": "2.0",
"result": {
"newVMs": {
"tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH": [
"timestampvm",
"timestamp"
],
"spdxUxVJQbX85MGxMHbKw1sHxMnSqJ3QBzDyDYEP3h6TLuxqQ": []
}
},
"id": 1
}
```
Now, this VM's static API can be accessed at endpoints `/ext/vm/timestampvm` and `/ext/vm/timestamp`. For more details about VM configs, see [here](/docs/nodes/configure/configs-flags#virtual-machine-vm-configs).
In this tutorial, we used the VM's ID as the executable name to simplify the process. However, AvalancheGo would also accept `timestampvm` or `timestamp` since those are registered aliases in previous step.
## Wrapping Up
That's it! That's the entire implementation of a VM which defines a blockchain-based timestamp server.
In this tutorial, we learned:
- The `block.ChainVM` interface, which all VMs that define a linear chain must implement
- The `snowman.Block` interface, which all blocks that are part of a linear chain must implement
- The `rpcchainvm` type, which allows blockchains to run in their own processes.
- An actual implementation of `block.ChainVM` and `snowman.Block`.
# Customize an Avalanche L1 (/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1)
---
title: Customize an Avalanche L1
description: Learn how to customize your EVM-powered Avalanche L1.
---
All Avalanche L1s can be customized by utilizing [`L1s Configs`](#avalanche-l1-configs).
an Avalanche L1 can have one or more blockchains. For example, the Primary Network, which is an Avalanche L1, a special one nonetheless, has 3 blockchains. Each chain can be further customized using chain specific configuration file. See [here](/docs/nodes/configure/configs-flags) for detailed explanation.
An Avalanche L1 created by or forked from [Subnet-EVM](https://github.com/ava-labs/subnet-evm) can be customized by utilizing one or more of the following methods:
- [Genesis](#genesis)
- [Precompile](#precompiles)
- [Upgrade Configs](#network-upgrades-enabledisable-precompiles)
- [Chain Configs](#avalanchego-chain-configs)
Avalanche L1 Configs[](#avalanche-l1-configs "Direct link to heading")
-----------------------------------------------------------
an Avalanche L1 can customized by setting parameters for the following:
- [Validator-only communication to create a private Avalanche L1](/docs/nodes/configure/avalanche-l1-configs#validatoronly-bool)
- [Consensus](/docs/nodes/configure/avalanche-l1-configs#consensus-parameters)
- [Gossip](/docs/nodes/configure/avalanche-l1-configs#gossip-configs)
See [here](/docs/nodes/configure/avalanche-l1-configs) for more info.
Genesis[](#genesis "Direct link to heading")
---------------------------------------------
Each blockchain has some genesis state when it's created. Each Virtual Machine defines the format and semantics of its genesis data.
The default genesis Subnet-EVM provided below has some well defined parameters:
```json
{
"config": {
"chainId": 43214,
"homesteadBlock": 0,
"eip150Block": 0,
"eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0",
"eip155Block": 0,
"eip158Block": 0,
"byzantiumBlock": 0,
"constantinopleBlock": 0,
"petersburgBlock": 0,
"istanbulBlock": 0,
"muirGlacierBlock": 0,
"feeConfig": {
"gasLimit": 15000000,
"minBaseFee": 25000000000,
"targetGas": 15000000,
"baseFeeChangeDenominator": 36,
"minBlockGasCost": 0,
"maxBlockGasCost": 1000000,
"targetBlockRate": 2,
"blockGasCostStep": 200000
},
"allowFeeRecipients": false
},
"alloc": {
"8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": {
"balance": "0x295BE96E64066972000000"
}
},
"nonce": "0x0",
"timestamp": "0x0",
"extraData": "0x00",
"gasLimit": "0xe4e1c0",
"difficulty": "0x0",
"mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000",
"coinbase": "0x0000000000000000000000000000000000000000",
"number": "0x0",
"gasUsed": "0x0",
"parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000"
}
```
### Chain Config[](#chain-config "Direct link to heading")
`chainID`: Denotes the ChainID of to be created chain. Must be picked carefully since a conflict with other chains can cause issues. One suggestion is to check with [chainlist.org](https://chainlist.org/) to avoid ID collision, reserve and publish your ChainID properly.
You can use `eth_getChainConfig` RPC call to get the current chain config. See [here](/docs/rpcs/subnet-evm#eth_getchainconfig) for more info.
#### Hard Forks[](#hard-forks "Direct link to heading")
`homesteadBlock`, `eip150Block`, `eip150Hash`, `eip155Block`, `byzantiumBlock`, `constantinopleBlock`, `petersburgBlock`, `istanbulBlock`, `muirGlacierBlock` are EVM hard fork activation times. Changing these may cause issues, so treat them carefully.
#### Fee Config[](#fee-config "Direct link to heading")
`gasLimit`: Sets the max amount of gas consumed per block. This restriction puts a cap on the amount of computation that can be done in a single block, which in turn sets a limit on the maximum gas usage allowed for a single transaction. For reference, C-Chain value is set to `15,000,000`.
`targetBlockRate`: Sets the target rate of block production in seconds. A target of 2 will target producing a block every 2 seconds. If the network starts producing blocks at a faster rate, it indicates that more blocks than anticipated are being issued to the network, resulting in an increase in base fees. For C-chain this value is set to `2`.
`minBaseFee`: Sets a lower bound on the EIP-1559 base fee of a block. Since the block's base fee sets the minimum gas price for any transaction included in that block, this effectively sets a minimum gas price for any transaction.
`targetGas`: Specifies the targeted amount of gas (including block gas cost) to consume within a rolling 10-seconds window. When the dynamic fee algorithm observes that network activity is above/below the `targetGas`, it increases/decreases the base fee proportionally to how far above/below the target actual network activity is. If the network starts producing blocks with gas cost higher than this, base fees are increased accordingly.
`baseFeeChangeDenominator`: Divides the difference between actual and target utilization to determine how much to increase/decrease the base fee. A larger denominator indicates a slower changing, stickier base fee, while a lower denominator allows the base fee to adjust more quickly. For reference, the C-chain value is set to `36`. This value sets the base fee to increase or decrease by a factor of `1/36` of the parent block's base fee.
`minBlockGasCost`: Sets the minimum amount of gas to charge for the production of a block. This value is set to `0` in C-Chain.
`maxBlockGasCost`: Sets the maximum amount of gas to charge for the production of a block.
`blockGasCostStep`: Determines how much to increase/decrease the block gas cost depending on the amount of time elapsed since the previous block.
If the block is produced at the target rate, the block gas cost will stay the same as the block gas cost for the parent block.
If it is produced faster/slower, the block gas cost will be increased/decreased by the step value for each second faster/slower than the target block rate accordingly.
If the `blockGasCostStep` is set to a very large number, it effectively requires block production to go no faster than the `targetBlockRate`. For example, if a block is produced two seconds faster than the target block rate, the block gas cost will increase by `2 * blockGasCostStep`.
#### Custom Fee Recipients[](#custom-fee-recipients "Direct link to heading")
See section [Setting a Custom Fee Recipient](#setting-a-custom-fee-recipient)
### Alloc[](#alloc "Direct link to heading")
The fields `nonce`, `timestamp`, `extraData`, `gasLimit`, `difficulty`, `mixHash`, `coinbase`, `number`, `gasUsed`, `parentHash` defines the genesis block header. The field `gasLimit` should be set to match the `gasLimit` set in the `feeConfig`. You do not need to change any of the other genesis header fields.
`nonce`, `mixHash` and `difficulty` are remnant parameters from Proof of Work systems. For Avalanche, these don't play any relevant role, so you should just leave them as their default values:
`nonce`: The result of the mining process iteration is this value. It can be any value in the genesis block. Default value is `0x0`.
`mixHash`: The combination of `nonce` and `mixHash` allows to verify that the Block has really been cryptographically mined, thus, from this aspect, is valid. Default value is `0x0000000000000000000000000000000000000000000000000000000000000000`.
`difficulty`: The difficulty level applied during the nonce discovering process of this block. Default value is `0x0`.
`timestamp`: The timestamp of the creation of the genesis block. This is commonly set to `0x0`.
`extraData`: Optional extra data that can be included in the genesis block. This is commonly set to `0x`.
`gasLimit`: The total amount of gas that can be used in a single block. It should be set to the same value as in the [fee config](#fee-config). The value `e4e1c0` is hexadecimal and is equal to `15,000,000`.
`coinbase`: Refers to the address of the block producers. This also means it represents the recipient of the block reward. It is usually set to `0x0000000000000000000000000000000000000000` for the genesis block. To allow fee recipients in Subnet-EVM, refer to [this section.](#setting-a-custom-fee-recipient)
`parentHash`: This is the Keccak 256-bit hash of the entire parent block's header. It is usually set to `0x0000000000000000000000000000000000000000000000000000000000000000` for the genesis block.
`gasUsed`: This is the amount of gas used by the genesis block. It is usually set to `0x0`.
`number`: This is the number of the genesis block. This required to be `0x0` for the genesis. Otherwise it will error.
### Genesis Examples[](#genesis-examples "Direct link to heading")
Another example of a genesis file can be found in the [networks folder](https://github.com/ava-labs/public-chain-assets/blob/1951594346dcc91682bdd8929bcf8c1bf6a04c33/chains/11111/genesis.json). Please remove `airdropHash` and `airdropAmount` fields if you want to start with it.
Here are a few examples on how a genesis file is used: [scripts/run.sh](https://github.com/ava-labs/subnet-evm/blob/master/scripts/run.sh#L99)
### Setting the Genesis Allocation[](#setting-the-genesis-allocation "Direct link to heading")
Alloc defines addresses and their initial balances. This should be changed accordingly for each chain. If you don't provide any genesis allocation, you won't be able to interact with your new chain (all transactions require a fee to be paid from the sender's balance).
The `alloc` field expects key-value pairs. Keys of each entry must be a valid `address`. The `balance` field in the value can be either a `hexadecimal` or `number` to indicate initial balance of the address. The default value contains `8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` with `50000000000000000000000000` balance in it. Default:
```json
"alloc": {
"8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": {
"balance": "0x295BE96E64066972000000"
}
}
```
To specify a different genesis allocation, populate the `alloc` field in the genesis JSON as follows:
```json
"alloc": {
"8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": {
"balance": "0x52B7D2DCC80CD2E4000000"
},
"Ab5801a7D398351b8bE11C439e05C5B3259aeC9B": {
"balance": "0xa796504b1cb5a7c0000"
}
},
```
The keys in the allocation are [hex](https://en.wikipedia.org/wiki/Hexadecimal) addresses **without the canonical `0x` prefix**. The balances are denominated in Wei ([10^18 Wei = 1 Whole Unit of Native Token](https://eth-converter.com/)) and expressed as hex strings **with the canonical `0x` prefix**. You can use [this converter](https://www.rapidtables.com/convert/number/hex-to-decimal.html) to translate between decimal and hex numbers.
The above example yields the following genesis allocations (denominated in whole units of the native token, that is 1 AVAX/1 WAGMI):
```bash
0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC: 100000000 (0x52B7D2DCC80CD2E4000000=100000000000000000000000000 Wei)
0xAb5801a7D398351b8bE11C439e05C5B3259aeC9B: 49463 (0xa796504b1cb5a7c0000=49463000000000000000000 Wei)
```
### Setting a Custom Fee Recipient[](#setting-a-custom-fee-recipient "Direct link to heading")
By default, all fees are burned (sent to the black hole address with `"allowFeeRecipients": false`). However, it is possible to enable block producers to set a fee recipient (who will get compensated for blocks they produce).
To enable this feature, you'll need to add the following to your genesis file (under the `"config"` key):
```json
{
"config": {
"allowFeeRecipients": true
}
}
```
#### Fee Recipient Address[](#fee-recipient-address "Direct link to heading")
With `allowFeeRecipients` enabled, your validators can specify their addresses to collect fees. They need to update their EVM [chain config](#avalanchego-chain-configs) with the following to specify where the fee should be sent to.
```json
{
"feeRecipient": ""
}
```
If `allowFeeRecipients` feature is enabled on the Avalanche L1, but a validator doesn't specify a "feeRecipient", the fees will be burned in blocks it produces.
This mechanism can be also activated as a precompile. See [Changing Fee Reward Mechanisms](#changing-fee-reward-mechanisms) section for more details.
Precompiles[](#precompiles "Direct link to heading")
-----------------------------------------------------
Subnet-EVM can provide custom functionalities with precompiled contracts. These precompiled contracts can be activated through `ChainConfig` (in genesis or as an upgrade).
### AllowList Interface[](#allowlist-interface "Direct link to heading")
The `AllowList` interface is used by precompiles to check if a given address is allowed to use a precompiled contract. `AllowList` consist of three roles, `Admin`, `Manager` and `Enabled`. `Admin` can add/remove other `Admin` and `Enabled` addresses. `Manager` is introduced with Durango upgrade and can add/remove `Enabled` addresses, without the ability to add/remove `Admin` or `Manager` addresses. `Enabled` addresses can use the precompiled contract, but cannot modify other roles.
`AllowList` adds `adminAddresses`, `managerAddresses`, `enabledAddresses` fields to precompile contract configurations. For instance fee manager precompile contract configuration looks like this:
```json
{
"feeManagerConfig": {
"blockTimestamp": 0,
"adminAddresses": [],
"managerAddresses": [],
"enabledAddresses": [],
}
}
```
`AllowList` configuration affects only the related precompile. For instance, the admin address in `feeManagerConfig` does not affect admin addresses in other activated precompiles.
The `AllowList` solidity interface is defined as follows, and can be found in [IAllowList.sol](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/contracts/contracts/interfaces/IAllowList.sol):
```solidity
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.0;
interface IAllowList {
event RoleSet(
uint256 indexed role,
address indexed account,
address indexed sender,
uint256 oldRole
);
// Set [addr] to have the admin role over the precompile contract.
function setAdmin(address addr) external;
// Set [addr] to be enabled on the precompile contract.
function setEnabled(address addr) external;
// Set [addr] to have the manager role over the precompile contract.
function setManager(address addr) external;
// Set [addr] to have no role for the precompile contract.
function setNone(address addr) external;
// Read the status of [addr].
function readAllowList(address addr) external view returns (uint256 role);
}
```
`readAllowList(addr)` will return a uint256 with a value of 0, 1, or 2, corresponding to the roles `None`, `Enabled`, and `Admin` respectively.
`RoleSet` is an event that is emitted when a role is set for an address. It includes the role, the modified address, the sender as indexed parameters and the old role as non-indexed parameter. Events in precompiles are activated after Durango upgrade.
Note: `AllowList` is not an actual contract but just an interface. It's not callable by itself. This is used by other precompiles. Check other precompile sections to see how this works.
### Restricting Smart Contract Deployers[](#restricting-smart-contract-deployers "Direct link to heading")
If you'd like to restrict who has the ability to deploy contracts on your Avalanche L1, you can provide an `AllowList` configuration in your genesis or upgrade file:
```json
{
"contractDeployerAllowListConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
```
In this example, `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` is named as the `Admin` of the `ContractDeployerAllowList`. This enables it to add other `Admin` or to add `Enabled` addresses. Both `Admin` and `Enabled` can deploy contracts. To provide a great UX with factory contracts, the `tx.Origin` is checked for being a valid deployer instead of the caller of `CREATE`. This means that factory contracts will still be able to create new contracts as long as the sender of the original transaction is an allow listed deployer.
The `Stateful Precompile` contract powering the `ContractDeployerAllowList` adheres to the [AllowList Solidity interface](#allowlist-interface) at `0x0200000000000000000000000000000000000000` (you can load this interface and interact directly in Remix):
- If you attempt to add a `Enabled` and you are not an `Admin`, you will see something like:
- If you attempt to deploy a contract but you are not an `Admin` not a `Enabled`, you will see something like:
- If you call `readAllowList(addr)` then you can read the current role of `addr`, which will return a uint256 with a value of 0, 1, or 2, corresponding to the roles `None`, `Enabled`, and `Admin` respectively.
If you remove all of the admins from the allow list, it will no longer be possible to update the allow list without modifying the Subnet-EVM to schedule a network upgrade.
#### Initial Contract Allow List Configuration[](#initial-contract-allow-list-configuration "Direct link to heading")
It's possible to enable this precompile with an initial configuration to activate its effect on activation timestamp. This provides a way to enable the precompile without an admin address to manage the deployer list. With this, you can define a list of addresses that are allowed to deploy contracts. Since there will be no admin address to manage the deployer list, it can only be modified through a network upgrade.
To use initial configuration, you need to specify addresses in `enabledAddresses` field in your genesis or upgrade file:
```json
{
"contractDeployerAllowListConfig": {
"blockTimestamp": 0,
"enabledAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
```
This will allow only `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` to deploy contracts. For further information about precompile initial configurations see [Initial Precompile Configurations](#initial-precompile-configurations).
### Restricting Who Can Submit Transactions[](#restricting-who-can-submit-transactions "Direct link to heading")
Similar to restricting contract deployers, this precompile restricts which addresses may submit transactions on chain. Like the previous section, you can activate the precompile by including an `AllowList` configuration in your genesis file:
```json
{
"config": {
"txAllowListConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
}
```
In this example, `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` is named as the `Admin` of the `TransactionAllowList`. This enables them to add other `Admins` or to add `Allowed`. `Admins`, `Manager` and `Enabled` can submit transactions to the chain.
The `Stateful Precompile` contract powering the `TxAllowList` adheres to the [AllowList Solidity interface](#allowlist-interface) at `0x0200000000000000000000000000000000000002` (you can load this interface and interact directly in Remix):
- If you attempt to add an `Enabled` and you are not an `Admin`, you will see something like:
- If you attempt to submit a transaction but you are not an `Admin`, `Manager` or not `Enabled`, you will see something like: `cannot issue transaction from non-allow listed address`
- If you call `readAllowList(addr)` then you can read the current role of `addr`, which will return a `uint256` with a value of 0, 1, 2 or 3 corresponding to the roles `None`, `Allowed`, `Admin` and `Manager` respectively.
If you remove all of the admins and managers from the allow list, it will no longer be possible to update the allow list without modifying the Subnet-EVM to schedule a network upgrade.
#### Initial TX Allow List Configuration[](#initial-tx-allow-list-configuration "Direct link to heading")
It's possible to enable this precompile with an initial configuration to activate its effect on activation timestamp. This provides a way to enable the precompile without an admin address to manage the TX allow list. With this, you can define a list of addresses that are allowed to submit transactions.
Since there will be no admin address to manage the TX list, it can only be modified through a network upgrade. To use initial configuration, you need to specify addresses in `enabledAddresses` field in your genesis or upgrade file:
```json
{
"txAllowListConfig": {
"blockTimestamp": 0,
"enabledAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
```
This will allow only `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` to submit transactions. For further information about precompile initial configurations see [Initial Precompile Configurations](#initial-precompile-configurations).
### Minting Native Coins[](#minting-native-coins "Direct link to heading")
You can mint native(gas) coins with a precompiled contract. In order to activate this feature, you can provide `nativeMinterConfig` in genesis:
```json
{
"config": {
"contractNativeMinterConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
}
```
`adminAddresses` denotes admin accounts who can add other `Admin`, `Manager` or `Enabled` accounts. `Admin`, `Manager` and `Enabled` are both eligible to mint native coins for other addresses. `ContractNativeMinter` uses same methods as in `ContractDeployerAllowList`.
The `Stateful Precompile` contract powering the `ContractNativeMinter` adheres to the following Solidity interface at `0x0200000000000000000000000000000000000001` (you can load this interface and interact directly in Remix):
```solidity
// (c) 2022-2023, Ava Labs, Inc. All rights reserved.
// See the file LICENSE for licensing terms.
pragma solidity ^0.8.0;
import "./IAllowList.sol";
interface INativeMinter is IAllowList {
event NativeCoinMinted(
address indexed sender,
address indexed recipient,
uint256 amount
);
// Mint [amount] number of native coins and send to [addr]
function mintNativeCoin(address addr, uint256 amount) external;
}
```
`mintNativeCoin` takes an address and amount of native coins to be minted. The amount denotes the amount in minimum denomination of native coins (10^18). For example, if you want to mint 1 native coin (in AVAX), you need to pass 1 \* 10^18 as the amount. A `NativeCoinMinted` event is emitted with the sender, recipient and amount when a native coin is minted.
Note that this uses `IAllowList` interface directly, meaning that it uses the same `AllowList` interface functions like `readAllowList` and `setAdmin`, `setManager`, `setEnabled`, `setNone`. For more information see [AllowList Solidity interface](#allowlist-interface).
EVM does not prevent overflows when storing the address balance. Overflows in balance opcodes are handled by setting the balance to maximum. However the same won't apply for API calls. If you try to mint more than the maximum balance, API calls will return the overflowed hex-balance. This can break external tooling. Make sure the total supply of native coins is always less than 2^256-1.
#### Initial Native Minter Configuration[](#initial-native-minter-configuration "Direct link to heading")
It's possible to enable this precompile with an initial configuration to activate its effect on activation timestamp. This provides a way to enable the precompile without an admin address to mint native coins. With this, you can define a list of addresses that will receive an initial mint of the native coin when this precompile activates. This can be useful for networks that require a one-time mint without specifying any admin addresses. To use initial configuration, you need to specify a map of addresses with their corresponding mint amounts in `initialMint` field in your genesis or upgrade file:
```json
{
"contractNativeMinterConfig": {
"blockTimestamp": 0,
"initialMint": {
"0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": "1000000000000000000",
"0x10037Fb06Ec4aB8c870a92AE3f00cD58e5D484b3": "0xde0b6b3a7640000"
}
}
}
```
In the amount field you can specify either decimal or hex string. This will mint 1000000000000000000 (equivalent of 1 Native Coin denominated as 10^18) to both addresses. Note that these are both in string format. "0xde0b6b3a7640000" hex is equivalent to 1000000000000000000. For further information about precompile initial configurations see [Initial Precompile Configurations](#initial-precompile-configurations).
### Configuring Dynamic Fees[](#configuring-dynamic-fees "Direct link to heading")
You can configure the parameters of the dynamic fee algorithm on chain using the `FeeConfigManager`. In order to activate this feature, you will need to provide the `FeeConfigManager` in the genesis:
```json
{
"config": {
"feeManagerConfig": {
"blockTimestamp": 0,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
}
```
The precompile implements the `FeeManager` interface which includes the same `AllowList` interface used by ContractNativeMinter, TxAllowList, etc. For an example of the `AllowList` interface, see the [TxAllowList](#allowlist-interface) above.
The `Stateful Precompile` contract powering the `FeeConfigManager` adheres to the following Solidity interface at `0x0200000000000000000000000000000000000003` (you can load this interface and interact directly in Remix). It can be also found in [IFeeManager.sol](https://github.com/ava-labs/subnet-evm/blob/5faabfeaa021a64c2616380ed2d6ec0a96c8f96d/contract-examples/contracts/IFeeManager.sol):
```solidity
//SPDX-License-Identifier: MIT
pragma solidity ^0.8.0;
import "./IAllowList.sol";
interface IFeeManager is IAllowList {
struct FeeConfig {
uint256 gasLimit;
uint256 targetBlockRate;
uint256 minBaseFee;
uint256 targetGas;
uint256 baseFeeChangeDenominator;
uint256 minBlockGasCost;
uint256 maxBlockGasCost;
uint256 blockGasCostStep;
}
event FeeConfigChanged(
address indexed sender,
FeeConfig oldFeeConfig,
FeeConfig newFeeConfig
);
// Set fee config fields to contract storage
function setFeeConfig(
uint256 gasLimit,
uint256 targetBlockRate,
uint256 minBaseFee,
uint256 targetGas,
uint256 baseFeeChangeDenominator,
uint256 minBlockGasCost,
uint256 maxBlockGasCost,
uint256 blockGasCostStep
) external;
// Get fee config from the contract storage
function getFeeConfig()
external
view
returns (
uint256 gasLimit,
uint256 targetBlockRate,
uint256 minBaseFee,
uint256 targetGas,
uint256 baseFeeChangeDenominator,
uint256 minBlockGasCost,
uint256 maxBlockGasCost,
uint256 blockGasCostStep
);
// Get the last block number changed the fee config from the contract storage
function getFeeConfigLastChangedAt()
external
view
returns (uint256 blockNumber);
}
```
FeeConfigManager precompile uses `IAllowList` interface directly, meaning that it uses the same `AllowList` interface functions like `readAllowList` and `setAdmin`, `setManager`, `setEnabled`, `setNone`. For more information see [AllowList Solidity interface](#allowlist-interface).
In addition to the `AllowList` interface, the FeeConfigManager adds the following capabilities:
- `getFeeConfig`: retrieves the current dynamic fee config
- `getFeeConfigLastChangedAt`: retrieves the timestamp of the last block where the fee config was updated
- `setFeeConfig`: sets the dynamic fee config on chain (see [here](#fee-config) for details on the fee config parameters). This function can only be called by an `Admin`, `Manager` or `Enabled` address.
- `FeeConfigChanged`: an event that is emitted when the fee config is updated. Topics include the sender, the old fee config, and the new fee config.
You can also get the fee configuration at a block with the `eth_feeConfig` RPC method. For more information see [here](/docs/rpcs/subnet-evm#eth_feeconfig).
#### Initial Fee Config Configuration[](#initial-fee-config-configuration "Direct link to heading")
It's possible to enable this precompile with an initial configuration to activate its effect on activation timestamp. This provides a way to define your fee structure to take effect at the activation.
To use the initial configuration, you need to specify the fee config in `initialFeeConfig` field in your genesis or upgrade file:
```json
{
"feeManagerConfig": {
"blockTimestamp": 0,
"initialFeeConfig": {
"gasLimit": 20000000,
"targetBlockRate": 2,
"minBaseFee": 1000000000,
"targetGas": 100000000,
"baseFeeChangeDenominator": 48,
"minBlockGasCost": 0,
"maxBlockGasCost": 10000000,
"blockGasCostStep": 500000
}
}
}
```
This will set the fee config to the values specified in the `initialFeeConfig` field. For further information about precompile initial configurations see [Initial Precompile Configurations](#initial-precompile-configurations).
### Avalanche Warp Messaging[](#avalanche-warp-messaging "Direct link to heading")
Currently Warp Precompile can only be activated in Mainnet after Durango occurs. Durango in Mainnet is set at 11 AM ET (4 PM UTC) on Wednesday, March 6th, 2024. If you plan to use Warp messaging in your own Subnet-EVM chain in Mainnet you should upgrade to AvalancheGo 1.11.11 or later and coordinate your precompile upgrade. Warp Config's "blockTimestamp" must be set after `1709740800`, Durango date (11 AM ET (4 PM UTC) on Wednesday, March 6th, 2024).
Contract Examples[](#contract-examples "Direct link to heading")
-----------------------------------------------------------------
Subnet-EVM contains example contracts for precompiles under `/contracts`. It's a hardhat project with tests and tasks. For more information see [contract examples README](https://github.com/ava-labs/subnet-evm/tree/master/contracts#subnet-evm-contracts).
Network Upgrades: Enable/Disable Precompiles[](#network-upgrades-enabledisable-precompiles "Direct link to heading")
---------------------------------------------------------------------------------------------------------------------
Performing a network upgrade requires coordinating the upgrade network-wide. A network upgrade changes the rule set used to process and verify blocks, such that any node that upgrades incorrectly or fails to upgrade by the time that upgrade goes into effect may become out of sync with the rest of the network.
Any mistakes in configuring network upgrades or coordinating them on validators may cause the network to halt and recovering may be difficult.
In addition to specifying the configuration for each of the above precompiles in the genesis chain config, they can be individually enabled or disabled at a given timestamp as a network upgrade. Disabling a precompile disables calling the precompile and destructs its storage so it can be enabled at a later timestamp with a new configuration if desired.
These upgrades must be specified in a file named `upgrade.json` placed in the same directory where [`config.json`](#avalanchego-chain-configs) resides: `{chain-config-dir}/{blockchainID}/upgrade.json`. For example, `WAGMI Subnet` upgrade should be placed in `~/.avalanchego/configs/chains/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt/upgrade.json`.
The content of the `upgrade.json` should be formatted according to the following:
```json
{
"precompileUpgrades": [
{
"[PRECOMPILE_NAME]": {
"blockTimestamp": "[ACTIVATION_TIMESTAMP]", // unix timestamp precompile should activate at
"[PARAMETER]": "[VALUE]" // precompile specific configuration options, eg. "adminAddresses"
}
}
]
}
```
An invalid `blockTimestamp` in an upgrade file results the update failing. The `blockTimestamp` value should be set to a valid Unix timestamp value which is in the _future_ relative to the _head of the chain_. If the node encounters a `blockTimestamp` which is in the past, it will fail on startup.
To disable a precompile, the following format should be used:
```json
{
"precompileUpgrades": [
{
"": {
"blockTimestamp": "[DEACTIVATION_TIMESTAMP]", // unix timestamp the precompile should deactivate at
"disable": true
}
}
]
}
```
Each item in `precompileUpgrades` must specify exactly one precompile to enable or disable and the block timestamps must be in increasing order. Once an upgrade has been activated (a block after the specified timestamp has been accepted), it must always be present in `upgrade.json` exactly as it was configured at the time of activation (otherwise the node will refuse to start).
Enabling and disabling a precompile is a network upgrade and should always be done with caution.
For safety, you should always treat `precompileUpgrades` as append-only.
As a last resort measure, it is possible to abort or reconfigure a precompile upgrade that has not been activated since the chain is still processing blocks using the prior rule set.
If aborting an upgrade becomes necessary, you can remove the precompile upgrade from `upgrade.json` from the end of the list of upgrades. As long as the blockchain has not accepted a block with a timestamp past that upgrade's timestamp, it will abort the upgrade for that node.
### Example[](#example "Direct link to heading")
```json
{
"precompileUpgrades": [
{
"feeManagerConfig": {
"blockTimestamp": 1668950000,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
},
{
"txAllowListConfig": {
"blockTimestamp": 1668960000,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
},
{
"feeManagerConfig": {
"blockTimestamp": 1668970000,
"disable": true
}
}
]
}
```
This example enables the `feeManagerConfig` at the first block with timestamp >= `1668950000`, enables `txAllowListConfig` at the first block with timestamp >= `1668960000`, and disables `feeManagerConfig` at the first block with timestamp >= `1668970000`.
When a precompile disable takes effect (that is, after its `blockTimestamp` has passed), its storage will be wiped. If you want to reenable it, you will need to treat it as a new configuration.
After you have created the `upgrade.json` and placed it in the chain config directory, you need to restart the node for the upgrade file to be loaded (again, make sure you don't restart all Avalanche L1 validators at once!). On node restart, it will print out the configuration of the chain, where you can double-check that the upgrade has loaded correctly. In our example:
```bash
INFO [08-15|15:09:36.772] <2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt Chain>
github.com/ava-labs/subnet-evm/eth/backend.go:155: Initialised chain configuration
config=“{ChainID: 11111 Homestead: 0 EIP150: 0 EIP155: 0 EIP158: 0 Byzantium: 0
Constantinople: 0 Petersburg: 0 Istanbul: 0, Muir Glacier: 0, Subnet EVM: 0, FeeConfig:
{\“gasLimit\“:20000000,\“targetBlockRate\“:2,\“minBaseFee\“:1000000000,\“targetGas\
“:100000000,\“baseFeeChangeDenominator\“:48,\“minBlockGasCost\“:0,\“maxBlockGasCost\
“:10000000,\“blockGasCostStep\“:500000}, AllowFeeRecipients: false, NetworkUpgrades: {\
“subnetEVMTimestamp\“:0}, PrecompileUpgrade: {}, UpgradeConfig: {\"precompileUpgrades\":[{\"feeManagerConfig\":{\"adminAddresses\":[\"0x8db97c7cece249c2b98bdc0226cc4c2a57bf52fc\"],\"enabledAddresses\":null,\"blockTimestamp\":1668950000}},{\"txAllowListConfig\":{\"adminAddresses\":[\"0x8db97c7cece249c2b98bdc0226cc4c2a57bf52fc\"],\"enabledAddresses\":null,\"blockTimestamp\":1668960000}},{\"feeManagerConfig\":{\"adminAddresses\":null,\"enabledAddresses\":null,\"blockTimestamp\":1668970000,\"disable\":true}}]}, Engine: Dummy Consensus Engine}"
```
Notice that `precompileUpgrades` entry correctly reflects the changes. You can also check the activated precompiles at a timestamp with the [`eth_getActivePrecompilesAt`](/docs/rpcs/subnet-evm#eth_getactiveprecompilesat) RPC method. The [`eth_getChainConfig`](/docs/rpcs/subnet-evm#eth_getchainconfig) RPC method will also return the configured upgrades in the response.
That's it, your Avalanche L1 is all set and the desired upgrades will be activated at the indicated timestamp!
### Initial Precompile Configurations[](#initial-precompile-configurations "Direct link to heading")
Precompiles can be managed by some privileged addresses to change their configurations and activate their effects. For example, the `feeManagerConfig` precompile can have `adminAddresses` which can change the fee structure of the network.
```json
{
"precompileUpgrades": [
{
"feeManagerConfig": {
"blockTimestamp": 1668950000,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
]
}
```
In this example, only the address `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` is allowed to change the fee structure of the network. The admin address has to call the precompile in order to activate its effect; that is it needs to send a transaction with a new fee config to perform the update. This is a very powerful feature, but it also gives a large amount of power to the admin address. If the address `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` is compromised, the network is compromised.
With the initial configurations, precompiles can immediately activate their effect on the activation timestamp. With this way admin addresses can be omitted from the precompile configuration. For example, the `feeManagerConfig` precompile can have `initialFeeConfig` to setup the fee configuration on the activation:
```json
{
"precompileUpgrades": [
{
"feeManagerConfig": {
"blockTimestamp": 1668950000,
"initialFeeConfig": {
"gasLimit": 20000000,
"targetBlockRate": 2,
"minBaseFee": 1000000000,
"targetGas": 100000000,
"baseFeeChangeDenominator": 48,
"minBlockGasCost": 0,
"maxBlockGasCost": 10000000,
"blockGasCostStep": 500000
}
}
}
]
}
```
Notice that there is no `adminAddresses` field in the configuration. This means that there will be no admin addresses to manage the fee structure with this precompile. The precompile will simply update the fee configuration to the specified fee config when it activates on the `blockTimestamp` `1668950000`.
It's still possible to add `adminAddresses` or `enabledAddresses` along with these initial configurations. In this case, the precompile will be activated with the initial configuration, and admin/enabled addresses can access to the precompiled contract normally.
If you want to change the precompile initial configuration, you will need to first disable it then activate the precompile again with the new configuration.
See every precompile initial configuration in their relevant `Initial Configuration` sections under [Precompiles](#precompiles).
AvalancheGo Chain Configs[](#avalanchego-chain-configs "Direct link to heading")
---------------------------------------------------------------------------------
As described in [this doc](/docs/nodes/configure/configs-flags#avalanche-l1-chain-configs), each blockchain of Avalanche L1s can have its own custom configuration. If an Avalanche L1's ChainID is `2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt`, the config file for this chain is located at `{chain-config-dir}/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt/config.json`.
For blockchains created by or forked from Subnet-EVM, most [C-Chain configs](/docs/nodes/chain-configs/primary-network/c-chain) are applicable except [Avalanche Specific APIs](/docs/nodes/chain-configs/primary-network/c-chain#enabling-avalanche-specific-apis).
### Priority Regossip[](#priority-regossip "Direct link to heading")
A transaction is "regossiped" when the node does not find the transaction in a block after `priority-regossip-frequency` (defaults to `1m`). By default, up to 16 transactions (max 1 per address) are regossiped to validators per minute.
Operators can use "priority regossip" to more aggressively "regossip" transactions for a set of important addresses (like bridge relayers). To do so, you'll need to update your [chain config](/docs/nodes/configure/configs-flags#avalanche-l1-chain-configs) with the following:
```json
{
"priority-regossip-addresses": [""]
}
```
By default, up to 32 transactions from priority addresses (max 16 per address) are regossipped to validators per second. You can override these defaults with the following config:
```json
{
"priority-regossip-frequency": "1s",
"priority-regossip-max-txs": 32,
"priority-regossip-addresses": [""],
"priority-regossip-txs-per-address": 16
}
```
### Fee Recipient[](#fee-recipient "Direct link to heading")
This works together with [`allowFeeRecipients`](#setting-a-custom-fee-recipient) and [RewardManager precompile](/docs/avalanche-l1s/precompiles/reward-manager) to specify where the fees should be sent to.
With `allowFeeRecipients` enabled, validators can specify their addresses to collect fees.
```json
{
"feeRecipient": ""
}
```
If `allowFeeRecipients` or `RewardManager` precompile is enabled on the Avalanche L1, but a validator doesn't specify a "feeRecipient", the fees will be burned in blocks it produces.
### Archival Node Configuration[](#archival-node-configuration "Direct link to heading")
Running an archival node that retains all historical state data requires specific configuration settings. Incorrect configuration can lead to historical data being pruned despite attempts to run in archival mode. Here are the key settings to configure:
#### Disabling Pruning
To retain all historical state, you must disable pruning. For EVM chains (like C-Chain or Subnet-EVM chains), add the following to your chain's `config.json`:
```json
{
"pruning-enabled": false
}
```
#### State Sync Considerations
State sync allows nodes to quickly sync by downloading recent state without processing all historical blocks. This can lead to missing historical data. For archival nodes, either disable state sync or ensure you start from genesis:
```json
{
"state-sync-enabled": false
}
```
#### Transaction History Settings
To maintain access to all historical transactions, you might need to configure these additional settings:
```json
{
"transaction-history": 0
}
```
#### Database Considerations
Important: An already synced database cannot be fully converted to an archival node retroactively. The cleanest and most reliable way to set up an archival node is to start from scratch with the proper configuration.
When switching between database types (e.g., from LevelDB to PebbleDB), historical data does not carry over. If you need to change the database type for your archival node, you must start a fresh sync from genesis.
For information about all available configuration options and directory structures, see the [AvalancheGo Config Flags documentation](https://build.avax.network/docs/nodes/configure/configs-flags).
Network Upgrades: State Upgrades[](#network-upgrades-state-upgrades "Direct link to heading")
----------------------------------------------------------------------------------------------
Subnet-EVM allows the network operators to specify a modification to state that will take place at the beginning of the first block with a timestamp greater than or equal to the one specified in the configuration.
This provides a last resort path to updating non-upgradeable contracts via a network upgrade (for example, to fix issues when you are running your own blockchain).
This should only be used as a last resort alternative to forking `subnet-evm` and specifying the network upgrade in code.
Using a network upgrade to modify state is not part of normal operations of the EVM. You should ensure the modifications do not invalidate any of the assumptions of deployed contracts or cause incompatibilities with downstream infrastructure such as block explorers.
The timestamps for upgrades in `stateUpgrades` must be in increasing order. `stateUpgrades` can be specified along with `precompileUpgrades` or by itself.
The following three state modifications are supported:
- `balanceChange`: adds a specified amount to the balance of a given account. This amount can be specified as hex or decimal and must be positive.
- `storage`: modifies the specified storage slots to the specified values. Keys and values must be 32 bytes specified in hex, with a `0x` prefix.
- `code`: modifies the code stored in the specified account. The code must _only_ be the runtime portion of a code. The code must start with a `0x` prefix.
If modifying the code, _only_ the runtime portion of the bytecode should be provided in `upgrades.json`. Do not use the bytecode that would be used for deploying a new contract, as this includes the constructor code as well. Refer to your compiler's documentation for information on how to find the runtime portion of the contract you wish to modify.
The `upgrades.json` file shown below describes a network upgrade that will make the following state modifications at the first block after (or at) `March 8, 2023 1:30:00 AM GMT`:
- Sets the code for the account at `0x71562b71999873DB5b286dF957af199Ec94617F7`,
- And adds `100` wei to the balance of the account at `0xb794f5ea0ba39494ce839613fffba74279579268`,
- Sets the storage slot `0x1234` to the value `0x6666` for the account at `0xb794f5ea0ba39494ce839613fffba74279579268`.
```json
{
"stateUpgrades": [
{
"blockTimestamp": 1678239000,
"accounts": {
"0x71562b71999873DB5b286dF957af199Ec94617F7": {
"code": "0x6080604052348015600f57600080fd5b506004361060285760003560e01c80632e64cec114602d575b600080fd5b60336047565b604051603e91906067565b60405180910390f35b60008054905090565b6000819050919050565b6061816050565b82525050565b6000602082019050607a6000830184605a565b9291505056fea26469706673582212209421042a1fdabcfa2486fb80942da62c28e61fc8362a3f348c4a96a92bccc63c64736f6c63430008120033"
},
"0xb794f5ea0ba39494ce839613fffba74279579268": {
"balanceChange": "0x64",
"storage": {
"0x0000000000000000000000000000000000000000000000000000000000001234": "0x0000000000000000000000000000000000000000000000000000000000006666"
}
}
}
}
]
}
```
Network Upgrades: Rescheduling Mandatory Network Upgrades[](#network-upgrades-rescheduling-mandatory-network-upgrades "Direct link to heading")
------------------------------------------------------------------------------------------------------------------------------------------------
A typical case when a network misses any mandatory activation would result in a network that is not able to operate. This is because validators/nodes running the old version would process transactions differently than nodes running the new version and end up different state. This would result in a fork in the network and new nodes would not be able to sync with the network. Normally this puts the chain in a halt and requires a hard fork to fix the issue. Starting with Subnet-EVM v0.6.3, you can reschedule mandatory activations like Durango via upgrade configs (upgrade.json in chain directory). This is a very advanced operation and should be done only if your network cannot operate going forward. The reschedule operation should be coordinated with your entire network nodes. Network upgrade overrides can be defined in the `upgrade.json` as follows:
```json
{
"networkUpgradeOverrides": {
"{networkUpgrade1}": timestamp1,
"{networkUpgrade2}": timestamp2,
}
}
```
The `timestamp` should be a Unix timestamp in seconds.
For instance, if you missed the Durango activation in Fuji (February 13th, 2024, 16:00 UTC) or Mainnet (March 6th, 2024, 16:00 UTC) and having issues in your network, you can reschedule the Durango activation via upgrades. In order to do this, you need to prepare a new upgrade.json including following:
```json
{
"networkUpgradeOverrides": {
"durangoTimestamp": 1712419200
}
}
```
This reschedules the Durango activation to 2024-11-06 16:00:00 UTC (one month later than the actual activation). After preparing the upgrade.json, you need to update the chain directory with the new upgrade.json and restart your nodes. You should see logs similar to the following:
```bash
INFO [03-22|14:04:48.284] github.com/ava-labs/subnet-evm/plugin/evm/vm.go:367: Applying network upgrade overrides overrides="{\"durangoTimestamp\":1712419200}"
...
INFO [03-22|14:04:48.288] github.com/ava-labs/subnet-evm/core/blockchain.go:335: Avalanche Upgrades (timestamp based):
INFO [03-22|14:04:48.288] github.com/ava-labs/subnet-evm/core/blockchain.go:335: - SubnetEVM Timestamp: @0 (https://github.com/ava-labs/avalanchego/releases/tag/v1.10.0)
INFO [03-22|14:04:48.288] github.com/ava-labs/subnet-evm/core/blockchain.go:335: - Durango Timestamp: @1712419200 (https://github.com/ava-labs/avalanchego/releases/tag/v1.11.0)
...
```
This means your node is lock and loaded for the new Durango activation. After the new timestamp is reached, your node will activate Durango and start processing transactions with the new Durango features.
Nodes running non-compatible version (running pre-Durango version after Durango activation), should be updated to most recent version of Subnet-EVM (v0.6.3+) and must have the new upgrade.json to reschedule the Durango activation. Running a new version without the rescheduling upgrade.json might create a fork in the network.
All of network nodes, even ones correctly upgraded to Durango and running the correct version since Durango activation, should be restarted with the new upgrade.json to reschedule the Durango activation. This is a network-wide operation and should be coordinated with all network nodes.
# Introduction (/docs/avalanche-l1s/evm-configuration/evm-l1-customization)
---
title: Introduction
description: Learn how to customize the Ethereum Virtual Machine with EVM and Precompiles.
root: true
---
Welcome to the EVM configuration guide. This documentation explores how to extend and customize your Avalanche L1 using **EVM** and **precompiles**. Building upon the Validator Manager capabilities we discussed in the previous section, we'll now dive into other powerful customization features available in EVM.
## Overview of EVM
EVM is Avalanche's customized version of the Ethereum Virtual Machine, tailored to run on Avalanche L1s. It allows developers to deploy Solidity smart contracts with enhanced capabilities, benefiting from Avalanche's high throughput and low latency. EVM enables more flexibility and performance optimizations compared to the standard EVM.
Beyond the Validator Manager functionality we've covered, EVM provides additional configuration options through precompiles, allowing you to extend your L1's capabilities even further.
## Genesis Configuration
Each blockchain has some genesis state when it's created. Each Virtual Machine defines the format and semantics of its genesis data. The genesis configuration is crucial for setting up your Avalanche L1's initial state and behavior.
### Chain Configuration
The chain configuration section in your genesis file defines fundamental parameters of your blockchain:
```json
{
"config": {
"chainId": 43214,
"homesteadBlock": 0,
"eip150Block": 0,
"eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0",
"eip155Block": 0,
"eip158Block": 0,
"byzantiumBlock": 0,
"constantinopleBlock": 0,
"petersburgBlock": 0,
"istanbulBlock": 0,
"muirGlacierBlock": 0
}
}
```
#### Chain ID
`chainID`: Denotes the ChainID of to be created chain. Must be picked carefully since a conflict with other chains can cause issues. One suggestion is to check with [chainlist.org](https://chainlist.org/) to avoid ID collision, reserve and publish your ChainID properly.
You can use `eth_getChainConfig` RPC call to get the current chain config. See [here](/docs/rpcs/subnet-evm#eth_getchainconfig) for more info.
#### Hard Forks
The following parameters define EVM hard fork activation times. These should be handled with care as changes may cause compatibility issues:
- `homesteadBlock`
- `eip150Block`
- `eip150Hash`
- `eip155Block`
- `byzantiumBlock`
- `constantinopleBlock`
- `petersburgBlock`
- `istanbulBlock`
- `muirGlacierBlock`
### Genesis Block Header
The genesis block header is defined by several parameters that set the initial state of your blockchain:
```json
{
"nonce": "0x0",
"timestamp": "0x0",
"extraData": "0x00",
"difficulty": "0x0",
"mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000",
"coinbase": "0x0000000000000000000000000000000000000000",
"number": "0x0",
"gasUsed": "0x0",
"parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000"
}
```
These parameters have specific roles:
- `nonce`, `mixHash`, `difficulty`: These are remnants from Proof of Work systems. For Avalanche, they don't play any relevant role and should be left as their default values.
- `timestamp`: The creation timestamp of the genesis block (commonly set to `0x0`).
- `extraData`: Optional extra data field (commonly set to `0x`).
- `coinbase`: The address of block producers (usually set to zero address for genesis).
- `parentHash`: The hash of the parent block (set to zero hash for genesis).
- `gasUsed`: Amount of gas used by the genesis block (usually `0x0`).
- `number`: The block number (must be `0x0` for genesis).
## Precompiles
Precompiles are specialized smart contracts that execute native Go code within the EVM context. They act as a bridge between Solidity and lower-level functionalities, allowing for performance optimizations and access to features not available in Solidity alone.
### Default Precompiles in EVM
EVM comes with a set of default precompiles that extend the EVM's functionality:
- **[AllowList Interface](/docs/avalanche-l1s/precompiles/allowlist-interface)**: Interface that manages access control by allowing or restricting specific addresses, inherited by all precompiles.
- **[Deployer AllowList](/docs/avalanche-l1s/precompiles/deployer-allowlist)**: Restricts which addresses can deploy smart contracts.
- **[Transaction AllowList](/docs/avalanche-l1s/precompiles/transaction-allowlist)**: Controls which addresses can submit transactions.
- **[Native Minter](/docs/avalanche-l1s/precompiles/native-minter)**: Manages the minting and burning of native tokens.
- **[Fee Manager](/docs/avalanche-l1s/precompiles/fee-manager)**: Controls gas fee parameters and fee markets.
- **[Reward Manager](/docs/avalanche-l1s/precompiles/reward-manager)**: Handles the distribution of staking rewards to validators.
- **[Warp Messenger](/docs/avalanche-l1s/precompiles/warp-messenger)**: Enables cross-chain communication between Avalanche L1s.
### Precompile Addresses and Configuration
If a precompile is enabled within the `genesis.json` using the respective `ConfigKey`, you can interact with the precompile using Foundry or other tools such as Remix.
Below are the addresses and `ConfigKey` values of default precompiles available in EVM. The address and `ConfigKey` [are defined in the `module.go` of each precompile contract](https://github.com/ava-labs/subnet-evm/tree/master/precompile/contracts).
| Precompile | ConfigKey | Address |
| ---------------------- | --------------------------------- | -------------------------------------------- |
| [Deployer AllowList](/docs/avalanche-l1s/precompiles/deployer-allowlist) | `contractDeployerAllowListConfig` | `0x0200000000000000000000000000000000000000` |
| [Native Minter](/docs/avalanche-l1s/precompiles/native-minter) | `contractNativeMinterConfig` | `0x0200000000000000000000000000000000000001` |
| [Transaction AllowList](/docs/avalanche-l1s/precompiles/transaction-allowlist) | `txAllowListConfig` | `0x0200000000000000000000000000000000000002` |
| [Fee Manager](/docs/avalanche-l1s/precompiles/fee-manager) | `feeManagerConfig` | `0x0200000000000000000000000000000000000003` |
| [Reward Manager](/docs/avalanche-l1s/precompiles/reward-manager) | `rewardManagerConfig` | `0x0200000000000000000000000000000000000004` |
| [Warp Messenger](/docs/avalanche-l1s/precompiles/warp-messenger) | `warpConfig` | `0x0200000000000000000000000000000000000005` |
#### Example Interaction
For example, if `contractDeployerAllowListConfig` is enabled in the `genesis.json`:
```json title="genesis.json"
"contractDeployerAllowListConfig": {
"adminAddresses": [ // Addresses that can manage (add/remove) enabled addresses. They are also enabled themselves for contract deployment.
"0x4f9e12d407b18ad1e96e4f139ef1c144f4058a4e",
"0x4b9e5977a46307dd93674762f9ddbe94fb054def"
],
"blockTimestamp": 0,
"enabledAddresses": [
"0x09c6fa19dd5d41ec6d0f4ca6f923ec3d941cc569" // Addresses that can only deploy contracts
]
},
```
We can then add an `Enabled` address to the Deployer AllowList by interacting with the `IAllowList` interface at `0x0200000000000000000000000000000000000000`:
```bash
cast send 0x0200000000000000000000000000000000000000 setEnabled(address addr) --rpc-url $MY_L1_RPC --private-key $ADMIN_PRIVATE_KEY
```
# WarpMessenger Precompile - Technical Details (/docs/avalanche-l1s/evm-configuration/warpmessenger)
---
title: "WarpMessenger Precompile - Technical Details"
description: "Technical documentation for the WarpMessenger precompile implementation in subnet-evm."
edit_url: https://github.com/ava-labs/subnet-evm/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/precompile/contracts/warp/README.md
---
# Integrating Avalanche Warp Messaging into the EVM
Avalanche Warp Messaging offers a basic primitive to enable Cross-L1 communication on the Avalanche Network.
It is intended to allow communication between arbitrary Custom Virtual Machines (including, but not limited to Subnet-EVM and Coreth).
## How does Avalanche Warp Messaging Work?
Avalanche Warp Messaging uses BLS Multi-Signatures with Public-Key Aggregation where every Avalanche validator registers a public key alongside its NodeID on the Avalanche P-Chain.
Every node tracking an Avalanche L1 has read access to the Avalanche P-Chain. This provides weighted sets of BLS Public Keys that correspond to the validator sets of each L1 on the Avalanche Network. Avalanche Warp Messaging provides a basic primitive for signing and verifying messages between L1s: the receiving network can verify whether an aggregation of signatures from a set of source L1 validators represents a threshold of stake large enough for the receiving network to process the message.
For more details on Avalanche Warp Messaging, see the AvalancheGo [Warp README](https://docs.avax.network/build/cross-chain/awm/deep-dive).
### Flow of Sending / Receiving a Warp Message within the EVM
The Avalanche Warp Precompile enables this flow to send a message from blockchain A to blockchain B:
1. Call the Warp Precompile `sendWarpMessage` function with the arguments for the `UnsignedMessage`
2. Warp Precompile emits an event / log containing the `UnsignedMessage` specified by the caller of `sendWarpMessage`
3. Network accepts the block containing the `UnsignedMessage` in the log, so that validators are willing to sign the message
4. An off-chain relayer queries the validators for their signatures of the message and aggregates the signatures to create a `SignedMessage`
5. The off-chain relayer encodes the `SignedMessage` as the [predicate](#predicate-encoding) in the AccessList of a transaction to deliver on blockchain B
6. The transaction is delivered on blockchain B, the signature is verified prior to executing the block, and the message is accessible via the Warp Precompile's `getVerifiedWarpMessage` during the execution of that transaction
### Warp Precompile
The Warp Precompile is broken down into three functions defined in the Solidity interface file [here](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/contracts/contracts/interfaces/IWarpMessenger.sol).
#### sendWarpMessage
`sendWarpMessage` is used to send a verifiable message. Calling this function results in sending a message with the following contents:
- `SourceChainID` - blockchainID of the sourceChain on the Avalanche P-Chain
- `SourceAddress` - `msg.sender` encoded as a 32 byte value that calls `sendWarpMessage`
- `Payload` - `payload` argument specified in the call to `sendWarpMessage` emitted as the unindexed data of the resulting log
Calling this function will issue a `SendWarpMessage` event from the Warp Precompile. Since the EVM limits the number of topics to 4 including the EventID, this message includes only the topics that would be expected to help filter messages emitted from the Warp Precompile the most.
Specifically, the `payload` is not emitted as a topic because each topic must be encoded as a hash. Therefore, we opt to take advantage of each possible topic to maximize the possible filtering for emitted Warp Messages.
Additionally, the `SourceChainID` is excluded because anyone parsing the chain can be expected to already know the blockchainID. Therefore, the `SendWarpMessage` event includes the indexable attributes:
- `sender`
- The `messageID` of the unsigned message (sha256 of the unsigned message)
The actual `message` is the entire [Avalanche Warp Unsigned Message](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/unsigned_message.go#L14) including an [AddressedCall](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm/warp/payload#readme). The unsigned message is emitted as the unindexed data in the log.
#### getVerifiedMessage
`getVerifiedMessage` is used to read the contents of the delivered Avalanche Warp Message into the expected format.
It returns the message if present and a boolean indicating if a message is present.
To use this function, the transaction must include the signed Avalanche Warp Message encoded in the [predicate](#predicate-encoding) of the transaction. Prior to executing a block, the VM iterates through transactions and pre-verifies all predicates. If a transaction's predicate is invalid, then it is considered invalid to include in the block and dropped.
This leads to the following advantages:
1. The EVM execution does not need to verify the Warp Message at runtime (no signature verification or external calls to the P-Chain)
2. The EVM can deterministically re-execute and re-verify blocks assuming the predicate was verified by the network (e.g., in bootstrapping)
This pre-verification is performed using the ProposerVM Block header during [block verification](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/plugin/evm/block.go#L220) and [block building](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/miner/worker.go#L200).
#### getBlockchainID
`getBlockchainID` returns the blockchainID of the blockchain that the VM is running on.
This is different from the conventional Ethereum ChainID registered to [ChainList](https://chainlist.org/).
The `blockchainID` in Avalanche refers to the txID that created the blockchain on the Avalanche P-Chain ([docs](https://docs.avax.network/specs/platform-transaction-serialization#unsigned-create-chain-tx)).
### Predicate Encoding
Avalanche Warp Messages are encoded as a signed Avalanche [Warp Message](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/message.go) where the [UnsignedMessage](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/unsigned_message.go)'s payload includes an [AddressedPayload](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/payload/payload.go).
Since the predicate is encoded into the [Transaction Access List](https://eips.ethereum.org/EIPS/eip-2930), it is packed into 32 byte hashes intended to declare storage slots that should be pre-warmed into the cache prior to transaction execution.
Therefore, we use the [Predicate Utils](https://github.com/ava-labs/subnet-evm/blob/master/predicate/Predicate.md) package to encode the actual byte slice of size N into the access list.
### Performance Optimization: Primary Network to Avalanche L1
The Primary Network has a large validator set compared to most Subnets and L1s, which makes Warp signature collection and verification from the entire Primary Network validator set costly. All Subnets and L1s track at least one blockchain of the Primary Network, so we can instead optimize this by using the validator set of the receiving L1 instead of the Primary Network for certain Warp messages.
#### Subnets
Recall that Avalanche Subnet validators must also validate the Primary Network, so it tracks all of the blockchains in the Primary Network (X, C, and P-Chains).
When an Avalanche Subnet receives a message from a blockchain on the Primary Network, we use the validator set of the receiving Subnet instead of the entire network when validating the message.
Sending messages from the X, C, or P-Chain remains unchanged.
However, when the Subnet receives the message, it changes the semantics to the following:
1. Read the `SourceChainID` of the signed message
2. Look up the `SubnetID` that validates `SourceChainID`. In this case it will be the Primary Network's `SubnetID`
3. Look up the validator set of the Subnet (instead of the Primary Network) and the registered BLS Public Keys of the Subnet validators at the P-Chain height specified by the ProposerVM header
4. Continue Warp Message verification using the validator set of the Subnet instead of the Primary Network
This means that Primary Network to Subnet communication only requires a threshold of stake on the receiving Subnet to sign the message instead of a threshold of stake for the entire Primary Network.
Since the security of the Subnet is provided by trust in its validator set, requiring a threshold of stake from the receiving Subnet's validator set instead of the whole Primary Network does not meaningfully change the security of the receiving L1.
Note: this special case is ONLY applied during Warp Message verification. The message sent by the Primary Network will still contain the blockchainID of the Primary Network chain that sent the message as the sourceChainID and signatures will be served by querying the source chain directly.
#### L1s
Avalanche L1s are only required to sync the P-Chain, but are not required to validate the Primary Network. Therefore, **for L1s, this optimization only applies to Warp messages sent by the P-Chain.** The rest of the description of this optimization in the above section applies to L1s.
Note that **in order to properly verify messages from the C-Chain and X-Chain, the Warp precompile must be configured with `requirePrimaryNetworkSigners` set to `true`**. Otherwise, we will attempt to verify the message signature against the receiving L1's validator set, which is not required to track the C-Chain or X-Chain, and therefore will not in general be able to produce a valid Warp message.
## Design Considerations
### Re-Processing Historical Blocks
Avalanche Warp Messaging depends on the Avalanche P-Chain state at the P-Chain height specified by the ProposerVM block header.
Verifying a message requires looking up the validator set of the source L1 on the P-Chain. To support this, Avalanche Warp Messaging uses the ProposerVM header, which includes the P-Chain height it was issued at as the canonical point to lookup the source L1's validator set.
This means verifying the Warp Message and therefore the state transition on a block depends on state that is external to the blockchain itself: the P-Chain.
The Avalanche P-Chain tracks only its current state and reverse diff layers (reversing the changes from past blocks) in order to re-calculate the validator set at a historical height. This means calculating a very old validator set that is used to verify a Warp Message in an old block may become prohibitively expensive.
Therefore, we need a heuristic to ensure that the network can correctly re-process old blocks (note: re-processing old blocks is a requirement to perform bootstrapping and is used in some VMs to serve or verify historical data).
As a result, we require that the block itself provides a deterministic hint which determines which Avalanche Warp Messages were considered valid/invalid during the block's execution. This ensures that we can always re-process blocks and use the hint to decide whether an Avalanche Warp Message should be treated as valid/invalid even after the P-Chain state that was used at the original execution time may no longer support fast lookups.
To provide that hint, we've explored two designs:
1. Include a predicate in the transaction to ensure any referenced message is valid
2. Append the results of checking whether a Warp Message is valid/invalid to the block data itself
The current implementation uses option (1).
The original reason for this was that the notion of predicates for precompiles was designed with Shared Memory in mind. In the case of shared memory, there is no canonical "P-Chain height" in the block which determines whether or not Avalanche Warp Messages are valid.
Instead, the VM interprets a shared memory import operation as valid as soon as the UTXO is available in shared memory. This means that if it were up to the block producer to staple the valid/invalid results of whether or not an attempted atomic operation should be treated as valid, a byzantine block producer could arbitrarily report that such atomic operations were invalid and cause a griefing attack to burn the gas of users that attempted to perform an import.
Therefore, a transaction specified predicate is required to implement the shared memory precompile to prevent such a griefing attack.
In contrast, Avalanche Warp Messages are validated within the context of an exact P-Chain height. Therefore, if a block producer attempted to lie about the validity of such a message, the network would interpret that block as invalid.
### Guarantees Offered by Warp Precompile vs. Built on Top
#### Guarantees Offered by Warp Precompile
The Warp Precompile was designed with the intention of minimizing the trusted computing base for the VM as much as possible. Therefore, it makes several tradeoffs which encourage users to use protocols built ON TOP of the Warp Precompile itself as opposed to directly using the Warp Precompile.
The Warp Precompile itself provides ONLY the following ability:
- Emit a verifiable message from (Address A, Blockchain A) to (Address B, Blockchain B) that can be verified by the destination chain
#### Explicitly Not Provided / Built on Top
The Warp Precompile itself does not provide any guarantees of:
- Eventual message delivery (may require re-send on blockchain A and additional assumptions about off-chain relayers and chain progress)
- Ordering of messages (requires ordering provided a layer above)
- Replay protection (requires replay protection provided a layer above)
# Installing Your VM (/docs/avalanche-l1s/rust-vms/installing-vm)
---
title: Installing Your VM
description: Learn how to install your VM on your node.
---
AvalancheGo searches for and registers VM plugins under the `plugins` [directory](/docs/nodes/configure/configs-flags#--plugin-dir-string).
To install the virtual machine onto your node, you need to move the built virtual machine binary under this directory. Virtual machine executable names must be either a full virtual machine ID (encoded in CB58), or a VM alias.
Copy the binary into the plugins directory.
```bash
cp -n $GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/
```
## Node Is Not Running
If your node isn't running yet, you can install all virtual machines under your `plugin` directory by starting the node.
## Node Is Already Running
Load the binary with the `loadVMs` API.
```bash
curl -sX POST --data '{
"jsonrpc":"2.0",
"id" :1,
"method" :"admin.loadVMs",
"params" :{}
}' -H 'content-type:application/json;' 127.0.0.1:9650/ext/admin
```
Confirm the response of `loadVMs` contains the newly installed virtual machine `tGas3T58KzdjcJ32c6GpePhtqo9rrHJ1oR9wFBtCcMgaosthX`. You'll see this virtual machine as well as any others that weren't already installed previously in the response.
```json
{
"jsonrpc": "2.0",
"result": {
"newVMs": {
"tGas3T58KzdjcJ32c6GpePhtqo9rrHJ1oR9wFBtCcMgaosthX": [
"timestampvm-rs",
"timestamp-rs"
],
"spdxUxVJQbX85MGxMHbKw1sHxMnSqJ3QBzDyDYEP3h6TLuxqQ": []
}
},
"id": 1
}
```
Now, this VM's static API can be accessed at endpoints `/ext/vm/timestampvm-rs` and `/ext/vm/timestamp-rs`. For more details about VM configs, see [here](/docs/nodes/configure/configs-flags#virtual-machine-vm-configs).
In this tutorial, we used the VM's ID as the executable name to simplify the process. However, AvalancheGo would also accept `timestampvm-rs` or `timestamp-rs` since those are registered aliases in previous step.
# Introduction to Avalanche-RS (/docs/avalanche-l1s/rust-vms/intro-avalanche-rs)
---
title: Introduction to Avalanche-RS
description: Learn how to write a simple virtual machine in Rust using Avalanche-RS.
---
Since Rust is a language which we can write and implement Proto interfaces, this implies that we can also use Rust to write VMs which can then be deployed on Avalanche.
However, rather than build Rust-based from the ground-up, we can utilize Avalanche-RS, a developer toolkit comprised of powerful building blocks and primitive types which allow us to focus exclusively on the business logic of our VM rather than working on low-level logic.
## Structure of Avalanche-RS
Although Avalanche-RS is currently primarily used to build Rust-based VMs, Avalanche-RS actually consists of three different frameworks; as per the [GitHub](https://github.com/ava-labs/avalanche-rs) description of the Avalanche-RS repository, the three frameworks are as follows:
- Core: framework for core networking components for a P2P Avalanche node
- Avalanche-Consensus: a Rust implementation of the novel Avalanche consensus protocol
- Avalanche-Types: implements foundational types used in Avalanche and provides an SDK for building Rust-based VMs
As the above might make it obvious, the Avalanche-Types crate is the main framework that one would use to build Rust-based VMs.
## Documentation
For the most up-to-date information regarding the Avalache-Types library, please refer to the associated [crates.io](https://crates.io/crates/avalanche-types) page for the Avalanche-Types crate.
# Setting Up Your Environment (/docs/avalanche-l1s/rust-vms/setting-up-environment)
---
title: Setting Up Your Environment
description: Learn how to set up your environment to build a Rust VM.
---
In this section, we will focus on getting set up with the Rust environment necessary to build with the `avalanche-types` crates (recall that `avalanche-types` contains the SDK we want to use to build our Rust VM).
## Installing Rust
First and foremost, we will need to have Rust installed locally. If you do not have Rust installed, you can install `rustup` (the tool that manages your Rust installation) [here](https://www.rust-lang.org/tools/install).
## Adding `avalanche-types` to Your Project
Once you have Rust installed and are ready to build, you will want to add the Avalanche-Types crate to your project. Below is a baseline example of how you can do this:
```toml title="Cargo.toml"
[dependencies]
avalanche-types = "0.1.4"
```
However, if you want to use the [TimestampVM](https://github.com/ava-labs/timestampvm-rs) as a reference for your project, a more appropriate import would be the following:
```toml title="Cargo.toml"
[dependencies]
avalanche-types = { version = "0.1.4", features = ["subnet", "codec_base64"] }
```
# APIs (/docs/avalanche-l1s/timestamp-vm/apis)
---
title: APIs
description: Learn how to interact with TimestampVM.
---
Throughout this case study, we have been focusing of the functionality of the TimestampVM. However, one thing we haven't discussed is how external users can interact with an instance of TimestampVM.
Without a way for users to interact with TimestampVM, the blockchain itself will be stagnant. In this section, we will go over the two types of APIs used in TimestampVM:
- Static APIs
- Chain APIs
## Precursor: Static and Instance Methods
When understanding the static and chain APIs used in TimestampVM, a good way to think about these APIs is to compare them to static and instance methods in object-oriented programming. That is,
- **Static Methods**: functions which belong to the class itself, and not any instance of the class
- **Instance Methods**: functions which belong to the instance of a class
## Static APIs
We can think of the static APIs in TimestampVM as functions which call the VM and are not associated with any specific instance of the TimestampVM. Within TimestampVM, we have just one static API function - the ping function:
```rust title="timestampvm/src/api/static_handlers.rs"
/// Defines static handler RPCs for this VM.
#[rpc]
pub trait Rpc {
#[rpc(name = "ping", alias("timestampvm.ping"))]
fn ping(&self) -> BoxFuture>;
}
```
## Chain APIs
In contrast to the static API, the chain API of TimestampVM is much more rich in the sense that we have functions with read from and write to an instance of TimestampVM. In this case, we have four functions defined in the chain API:
- `ping`: when called, this function pings an instance of TimestampVM
- `propose_Block`: write function which passes a block to TimestampVM for consideration to be appended to the blockchain
- `last_accepted`: read function which returns the last accepted block (that is, the block at the tip of the blockchain)
- `get_block`: read function which fetches the requested block
We can see the functions included in the chain API here:
```rust title="timestampvm/src/api/chain_handlers.rs"
/// Defines RPCs specific to the chain.
#[rpc]
pub trait Rpc {
/// Pings th e VM.
#[rpc(name = "ping", alias("timestampvm.ping"))]
fn ping(&self) -> BoxFuture>;
/// Proposes th e arbitrary data.
#[rpc(name = "proposeBlock", alias("timestampvm.proposeBlock"))]
fn propose_block(&self,args:ProposeBlockArgs)->BoxFuture>;
/// Fetches th e last accepted block.
#[rpc(name="lastAccepted",alias("timestampvm.lastAccepted"))]
fn last_accepted(&self)->BoxFuture>;
/// Fetches th e block.
#[rpc(name="getBlock",alias("timestampvm.getBlock"))]
fn get_block(&self,args:GetBlockArgs)->BoxFutur e >;
}
```
# Blocks (/docs/avalanche-l1s/timestamp-vm/blocks)
---
title: Blocks
descscription: Learn about the Block data structure in TimestampVM.
---
In this section, we will examine the Block data structure. In contrast to the design choice of the TimestampVM state (which was mostly in control of the implementers), blocks in TimestampVM must adhere to the SnowmanVM Block Interface.
## SnowmanVM.Block Interface
TimestampVM is designed to be used in tandem with the Snowman Consensus Engine. In particular, this relationship is defined by the usage of blocks - TimestampVM will produce blocks which the Snowman Consensus Engine will use and eventually mark as accepted or rejected. Therefore, the Snowman Consensus Engine requires for all blocks to have the following interface:
```go
type Block interface {
choices.Decidable
// Parent returns the ID of this block's parent.
Parent() ids.ID
// Verify that the state transition this block would make if accepted is
// valid. If the state transition is invalid, a non-nil error should be
// returned.
//
// It is guaranteed that the Parent has been successfully verified.
//
// If nil is returned, it is guaranteed that either Accept or Reject will be
// called on this block, unless the VM is shut down.
Verify(context.Context) error
// Bytes returns the binary representation of this block.
//
// This is used for sending blocks to peers. The bytes should be able to be
// parsed into the same block on another node.
Bytes() []byte
// Height returns the height of this block in the chain.
Height() uint64
// Time this block was proposed at. This value should be consistent across
// all nodes. If this block hasn't been successfully verified, any value can
// be returned. If this block is the last accepted block, the timestamp must
// be returned correctly. Otherwise, accepted blocks can return any value.
Timestamp() time.Time
}
```
## Implementing the Block Data Structure
With the above in mind, we now examine the block data structure:
```rust
/// Represents a block, specific to `Vm` (crate::vm::Vm).
#[serde_as]
#[derive(Serialize, Deserialize, Clone, Derivative, Default)]
#[derivative(Debug, PartialEq, Eq)]
pub struct Block {
/// The block Id of the parent block.
parent_id: ids::Id,
/// This block's height.
/// The height of the genesis block is 0.
height: u64,
/// Unix second when this block was proposed.
timestamp: u64,
/// Arbitrary data.
#[serde_as(as = "Hex0xBytes")]
data: Vec,
/// Current block status.
#[serde(skip)]
status: choices::status::Status,
/// This block's encoded bytes.
#[serde(skip)]
bytes: Vec,
/// Generated block Id.
#[serde(skip)]
id: ids::Id,
/// Reference to the Vm state manager for blocks.
#[derivative(Debug = "ignore", PartialEq = "ignore")]
#[serde(skip)]
state: state::State,
}
```
Notice above that many of the fields of the `Block` struct store the information required to implement the `Snowman.Block` interface we saw previously. Tying the concept of Blocks back to the VM State, notice the last field `state` within the `Block` struct. This is where the `Block` struct stores a copy of the `State` struct from the previous section (and since each field of the `State` struct is wrapped in an `Arc` pointer, this implies that `Block` is really just storing a reference to both the `db` and `verified_blocks` data structures).
## `Block` Functions
In this section, we examine some of the functions associated with the `Block` struct:
### `verify`
This function verifies that a block is valid and stores it in memory. Note that a verified block does not mean that it has been accepted - rather, a verified block is eligible to be accepted.
```rust
/// Verifies [`Block`](Block) properties (e.g., heights),
/// and once verified, records it to the `State` (crate::state::State).
/// # Errors
/// Can fail if the parent block can't be retrieved.
pub async fn verify(&mut self) -> io::Result<()> {
if self.height == 0 && self.parent_id == ids::Id::empty() {
log::debug!(
"block {} has an empty parent Id since it's a genesis block -- skipping verify",
self.id
);
self.state.add_verified(&self.clone()).await;
return Ok(());
}
// if already exists in database, it means it's already accepted
// thus no need to verify once more
if self.state.get_block(&self.id).await.is_ok() {
log::debug!("block {} already verified", self.id);
return Ok(());
}
let prnt_blk = self.state.get_block(&self.parent_id).await?;
// ensure the height of the block is immediately following its parent
if prnt_blk.height != self.height - 1 {
return Err(Error::new(
ErrorKind::InvalidData,
format!(
"parent block height {} != current block height {} - 1",
prnt_blk.height, self.height
),
));
}
// ensure block timestamp is after its parent
if prnt_blk.timestamp > self.timestamp {
return Err(Error::new(
ErrorKind::InvalidData,
format!(
"parent block timestamp {} > current block timestamp {}",
prnt_blk.timestamp, self.timestamp
),
));
}
let one_hour_from_now = Utc::now() + Duration::hours(1);
let one_hour_from_now = one_hour_from_now
.timestamp()
.try_into()
.expect("failed to convert timestamp from i64 to u64");
// ensure block timestamp is no more than an hour ahead of this nodes time
if self.timestamp >= one_hour_from_now {
return Err(Error::new(
ErrorKind::InvalidData,
format!(
"block timestamp {} is more than 1 hour ahead of local time",
self.timestamp
),
));
}
// add newly verified block to memory
self.state.add_verified(&self.clone()).await;
Ok(())
}
```
### `reject`
When called by the Snowman Consensus Engine, this tells the VM that the particular block has been rejected.
```rust
/// Mark this [`Block`](Block) rejected and updates `State` (crate::state::State) accordingly.
/// # Errors
/// Returns an error if the state can't be updated.
pub async fn reject(&mut self) -> io::Result<()> {
self.set_status(choices::status::Status::Rejected);
// only decided blocks are persistent -- no reorg
self.state.write_block(&self.clone()).await?;
self.state.remove_verified(&self.id()).await;
Ok(())
}
```
### `accept`
When called by the Snowman Consensus Engine, this tells the VM that the particular block has been rejected.
```rust
/// Mark this [`Block`](Block) accepted and updates `State` (crate::state::State) accordingly.
/// # Errors
/// Returns an error if the state can't be updated.
pub async fn accept(&mut self) -> io::Result<()> {
self.set_status(choices::status::Status::Accepted);
// only decided blocks are persistent -- no reorg
self.state.write_block(&self.clone()).await?;
self.state.set_last_accepted_block(&self.id()).await?;
self.state.remove_verified(&self.id()).await;
Ok(())
}
```
# Architecture of TimestampVM (/docs/avalanche-l1s/timestamp-vm/defining-vm-itself)
---
title: Architecture of TimestampVM
description: After examining several of the data structures and functionalities that TimestampVM relies on, it is time that we examine the architecture of the TimestampVM itself. In addition, we will look at some data structures that TimestampVM utilizes.
---
## Aside: SnowmanVM
In addition to blocks having to adhere to the `Snowman.Block` interface, VMs which interact with the Snowman Consensus Engine must also implement the `SnowmanVM` interface. In the context of a Rust-based VM, this means that we must satisfy the `ChainVM` trait in `avalanche-types`:
```rust title="avalanche-types/src/subnet/rpc/snowman/block.rs"
/// ref.
#[tonic::async_trait]
pub trait ChainVm: CommonVm + BatchedChainVm + Getter + Parser {
type Block: snowman::Block;
/// Attempt to create a new block from ChainVm data
/// Returns either a block or an error
async fn build_block(&self) -> Result<::Block>;
/// Issues a transaction to the chain
async fn issue_tx(&self) -> Result<::Block>;
/// Notify the Vm of the currently preferred block.
async fn set_preference(&self, id: Id) -> Result<()>;
/// Returns ID of last accepted block.
async fn last_accepted(&self) -> Result;
}
```
## Defining TimestampVM
Below is definition of VM struct which represents TimestampVM:
```rust title="timestampvm/src/vm/mod.rs"
pub struct Vm {
/// Maintains Vm-specific states.
pub state: Arc>,
pub app_sender: Option,
/// A queue not yet proposed into a block.
pub mempool: Arc>>>,
}
```
We see following three fields:
- `state`: represents state of VM. Note different than earlier seen State structure.
- `app_sender`: channel for receiving and sending requests by our VM
- `mempool`: where proposed blocks are kept before being processed.
We now examine the `state` data structure mentioned earlier:
```rust title="timestampvm/src/vm/mod.rs"
/// Represents VM-specific states.
/// Defined separately for interior mutability in [`Vm`](vm).
/// Protected with 'Arc' and 'RwLock'.
pub struct State {
pub ctx : Option>,
pub version : Version,
pub genesis : Genesis,
// Persistent Vm state representation
pub state : Option,
// Preferred block Id
pub preferred : ids::Id,
// Channel for messages to snowman consensus engine
pub bootstrapped : bool,
}
```
Relationship between State and state - contains alongside other fields relevant to Snowman consensus algorithm.
# Introduction (/docs/avalanche-l1s/timestamp-vm/introduction)
---
title: Introduction
description: Learn about the TimestampVM Virtual Machine.
---
To really get an understanding of how one can use the `avalanche-types` library to build a Rust-based VM, we will look at [TimeStampVM](https://github.com/ava-labs/timestampvm-rs/tree/main), a basic VM which utilizes the `avalanche-types` library.
## Idea of TimestampVM
In contrast to complex VMs like the EVM which provide a general-purpose computing environment, TimestampVM is _much, much_ simpler. In fact, we can describe the goal of TimestampVM in two bullet points:
- To store the timestamp when each block was appended to the blockchain
- To store arbitrary payloads of data (within each block)
Even though the above seems quite simple, this still requires us to define and build out an architecture to support such functionalities. In this case study, we will look at the following pieces of the architecture that define TimestampVM:
- State
- Blocks
- API
- The VM itself
# State (/docs/avalanche-l1s/timestamp-vm/state)
---
title: State
description: Learn about the state within the context of TimestampVM.
---
Blockchains can be defined as follows:
> A linked-list where each list element consists of a block
Implementations of blockchains, while adhering to the functionality above from a white-box perspective, are defined much more like databases than regular linked lists themselves. In fact, this is what TimestampVM utilizes! By utilizing a general database, TimestampVM is able to store blocks (and thus, store its blockchain) while also being able to store additional data such as pending blocks.
## State Definition
Below is the definition of the `State` struct which is used to maintain the state of the TimestampVM:
```rust
/// Manages block and chain states for this Vm, both in-memory and persistent.
#[derive(Clone)]
pub struct State {
pub db: Arc>>,
/// Maps block Id to Block.
/// Each element is verified but not yet accepted/rejected (e.g., preferred).
pub verified_blocks: Arc>>,
}
```
`State` in this context acts like the database of TimestampVM. Within `State`, we are managing two different data structures:
- `db`: a byte-based mapping which maps bytes to bytes. This is where finalized (that is, accepted blocks are stored)
- `verified_blocks`: a hashmap which maps block numbers to their respective blocks. This is where all verified, but pending blocks are stored
While one could have guessed the functionalities of `db` and `verified_blocks` from their respective types `subnet::rpc::database::Database + Send + Sync` and `HashMap`, it is not immediately clear why we are wrapping these fields with Read/Write locks and Arc pointers. However, as we'll see soon when we examine the Block data structure, blocks need access to the VM state so they can add themselves to state. This is due to the `SetPrefernce` function of SnowmanVM interface, which states:
> `Set Preference`
>
> The VM implements the function SetPreference(blkID ids.ID) to allow the consensus engine to notify the VM which block is currently preferred to be accepted. The VM should use this information to set the head of its blockchain. Most importantly, when the consensus engine calls BuildBlock, the VM should be sure to build on top of the block that is the most recently set preference.
>
> Note: SetPreference will always be called with a block that has no verified children.
Therefore, when building a Rust-based VM (or a VM in any supported language), the VM itself is only responsible for tracking the ID of the most recent finalized block; blocks bear the responsibility of storing themselves in VM state. As a result, we will need to wrap the `db` and `verified_blocks` fields with the following:
- An `Arc` pointer so that whenever we clone the `State` structure, the cloned versions of `db` and `verified_blocks` are still pointing to the same data structures in memory. This allows for multiple Blocks to share the same `db` and `verified_blocks`
- A read/write lock (that is, `RwLock`) so that we safely utilize concurrency in our VM
## `State` Functions
Below are the functions associated with the `State` struct:
```rust title="timestampvm/src/state/mod.rs"
impl State {
/// Persists the last accepted block Id to state.
/// # Errors
/// Fails if the db can't be updated
pub async fn set_last_accepted_block(&self, blk_id: &ids::Id) -> io::Result<()> {
let mut db = self.db.write().await;
db.put(LAST_ACCEPTED_BLOCK_KEY, &blk_id.to_vec())
.await
.map_err(|e| {
Error::new(
ErrorKind::Other,
format!("failed to put last accepted block: {e:?}"),
)
})
}
/// Returns "true" if there's a last accepted block found.
/// # Errors
/// Fails if the db can't be read
pub async fn has_last_accepted_block(&self) -> io::Result {
let db = self.db.read().await;
match db.has(LAST_ACCEPTED_BLOCK_KEY).await {
Ok(found) => Ok(found),
Err(e) => Err(Error::new(
ErrorKind::Other,
format!("failed to load last accepted block: {e}"),
)),
}
}
/// Returns the last accepted block Id from state.
/// # Errors
/// Can fail if the db can't be read
pub async fn get_last_accepted_block_id(&self) -> io::Result {
let db = self.db.read().await;
match db.get(LAST_ACCEPTED_BLOCK_KEY).await {
Ok(d) => Ok(ids::Id::from_slice(&d)),
Err(e) => {
if subnet::rpc::errors::is_not_found(&e) {
return Ok(ids::Id::empty());
}
Err(e)
}
}
}
/// Adds a block to "`verified_blocks`".
pub async fn add_verified(&mut self, block: &Block) {
let blk_id = block.id();
log::info!("verified added {blk_id}");
let mut verified_blocks = self.verified_blocks.write().await;
verified_blocks.insert(blk_id, block.clone());
}
/// Removes a block from "`verified_blocks`".
pub async fn remove_verified(&mut self, blk_id: &ids::Id) {
let mut verified_blocks = self.verified_blocks.write().await;
verified_blocks.remove(blk_id);
}
/// Returns "true" if the block Id has been already verified.
pub async fn has_verified(&self, blk_id: &ids::Id) -> bool {
let verified_blocks = self.verified_blocks.read().await;
verified_blocks.contains_key(blk_id)
}
/// Writes a block to the state storage.
/// # Errors
/// Can fail if the block fails to serialize or if the db can't be updated
pub async fn write_block(&mut self, block: &Block) -> io::Result<()> {
let blk_id = block.id();
let blk_bytes = block.to_vec()?;
let mut db = self.db.write().await;
let blk_status = BlockWithStatus {
block_bytes: blk_bytes,
status: block.status(),
};
let blk_status_bytes = blk_status.encode()?;
db.put(&block_with_status_key(&blk_id), &blk_status_bytes)
.await
.map_err(|e| Error::new(ErrorKind::Other, format!("failed to put block: {e:?}")))
}
/// Reads a block from the state storage using the `block_with_status_key`.
/// # Errors
/// Can fail if the block is not found in the state storage, or if the block fails to deserialize
pub async fn get_block(&self, blk_id: &ids::Id) -> io::Result {
// check if the block exists in memory as previously verified.
let verified_blocks = self.verified_blocks.read().await;
if let Some(b) = verified_blocks.get(blk_id) {
return Ok(b.clone());
}
let db = self.db.read().await;
let blk_status_bytes = db.get(&block_with_status_key(blk_id)).await?;
let blk_status = BlockWithStatus::from_slice(blk_status_bytes)?;
let mut blk = Block::from_slice(&blk_status.block_bytes)?;
blk.set_status(blk_status.status);
Ok(blk)
}
}
```
The functions above are called will be called by both blocks and the VM itself.
# Considerations (/docs/avalanche-l1s/upgrade/considerations)
---
title: Considerations
description: Learn about some of the key considerations while upgrading your Avalanche L1.
---
In the course of Avalanche L1 operation, you will inevitably need to upgrade or change some part of the software stack that is running your Avalanche L1. If nothing else, you will have to upgrade the AvalancheGo node client. Same goes for the VM plugin binary that is used to run the blockchain on your Avalanche L1, which is most likely the [Subnet-EVM](https://github.com/ava-labs/subnet-evm), the Avalanche L1 implementation of the Ethereum virtual machine.
Node and VM upgrades usually don't change the way your Avalanche L1 functions, instead they keep your Avalanche L1 in sync with the rest of the network, bringing security, performance and feature upgrades. Most upgrades are optional, but all of them are recommended, and you should make optional upgrades part of your routine Avalanche L1 maintenance. Some upgrades will be mandatory, and those will be clearly communicated as such ahead of time, you need to pay special attention to those.
Besides the upgrades due to new releases, you also may want to change the configuration of the VM, to alter the way Avalanche L1 runs, for various business or operational needs. These upgrades are solely the purview of your team, and you have complete control over the timing of their roll out. Any such change represents a **network upgrade** and needs to be carefully planned and executed.
Network Upgrades Permanently Change the Rules of Your Avalanche L1. Procedural mistakes or a botched upgrade can halt your Avalanche L1 or lead to data loss!
When performing an Avalanche L1 upgrade, every single validator on the Avalanche L1 will need to perform the identical upgrade.
If you are coordinating a network upgrade, you must schedule advance notice to every Avalanche L1 validator so that they have time to perform the upgrade prior to activation. Make sure you have direct line of communication to all your validators!
This tutorial will guide you through the process of doing various Avalanche L1 upgrades and changes. We will point out things to watch out for and precautions you need to be mindful about.
General Upgrade Considerations[](#general-upgrade-considerations "Direct link to heading")
-------------------------------------------------------------------------------------------
When operating an Avalanche L1, you should always keep in mind that Proof of Stake networks like Avalanche can only make progress if sufficient amount of validating nodes are connected and processing transactions. Each validator on an Avalanche L1 is assigned a certain `weight`, which is a numerical value representing the significance of the node in consensus decisions. On the Primary Network, weight is equal to the amount of AVAX staked on the node. On Avalanche L1s, weight is currently assigned by the Avalanche L1 owners when they issue the transaction adding a validator to the Avalanche L1.
Avalanche L1s can operate normally only if validators representing 80% or more of the cumulative validator weight is connected. If the amount of connected stake falls close to or below 80%, Avalanche L1 performance (time to finality) will suffer, and ultimately the Avalanche L1 will halt (stop processing transactions).
You as an Avalanche L1 operator need to ensure that whatever you do, at least 80% of the validators' cumulative weight is connected and working at all times.
It is mandatory that the cumulative weight of all validators in the Avalanche L1 must be at least the value of [`snow-sample-size`](/docs/nodes/configure/configs-flags#--snow-sample-size-int) (default 20). For example, if there is only one validator in the Avalanche L1, its weight must be at least `snow-sample-size` . Hence, when assigning weight to the nodes, always use values greater than 20. Recall that a validator's weight can't be changed while it is validating, so take care to use an appropriate value.
Upgrading Avalanche L1 Validator Nodes[](#upgrading-avalanche-l1-validator-nodes "Direct link to heading")
-----------------------------------------------------------------------------------------------
AvalancheGo, the node client that is running the Avalanche validators is under constant and rapid development. New versions come out often (roughly every two weeks), bringing added capabilities, performance improvements or security fixes. Updates are usually optional, but from time to time (much less frequently than regular updates) there will be an update that includes a mandatory network upgrade. Those upgrades are **MANDATORY** for every node running the Avalanche L1. Any node that does not perform the update before the activation timestamp will immediately stop working when the upgrade activates.
That's why having a node upgrade strategy is absolutely vital, and you should always update to the latest AvalancheGo client immediately when it is made available.
For a general guide on upgrading AvalancheGo check out [this tutorial](/docs/nodes/maintain/upgrade). When upgrading Avalanche L1 nodes and keeping in mind the previous section, make sure to stagger node upgrades and start a new upgrade only once the previous node has successfully upgraded. Use the [Health API](/docs/rpcs/other/health-rpc#healthhealth) to check that `healthy` value in the response is `true` on the upgraded node, and on other Avalanche L1 validators check that [platform.getCurrentValidators()](/docs/rpcs/p-chain#platformgetcurrentvalidators) has `true` in `connected` attribute for the upgraded node's `nodeID`. Once those two conditions are satisfied, node is confirmed to be online and validating the Avalanche L1 and you can start upgrading another node.
Continue the upgrade cycle until all the Avalanche L1 nodes are upgraded.
Upgrading Avalanche L1 VM Plugin Binaries[](#upgrading-avalanche-l1-vm-plugin-binaries "Direct link to heading")
-----------------------------------------------------------------------------------------------------
Besides the AvalancheGo client itself, new versions get released for the VM binaries that run the blockchains on the Avalanche L1. On most Avalanche L1s, that is the [Subnet-EVM](https://github.com/ava-labs/subnet-evm), so this tutorial will go through the steps for updating the `subnet-evm` binary. The update process will be similar for updating any VM plugin binary.
All the considerations for doing staggered node upgrades as discussed in previous section are valid for VM upgrades as well.
In the future, VM upgrades will be handled by the [Avalanche-CLI tool](https://github.com/ava-labs/avalanche-cli), but for now we need to do it manually.
Go to the [releases page](https://github.com/ava-labs/subnet-evm/releases) of the Subnet-EVM repository. Locate the latest version, and copy link that corresponds to the OS and architecture of the machine the node is running on (`darwin` = Mac, `amd64` = Intel/AMD processor, `arm64` = Arm processor). Log into the machine where the node is running and download the archive, using `wget` and the link to the archive, like this:
```bash
wget https://github.com/ava-labs/subnet-evm/releases/download/v0.2.9/subnet-evm_0.2.9_linux_amd64.tar.gz
```
This will download the archive to the machine. Unpack it like this (use the correct filename, of course):
```bash
tar xvf subnet-evm_0.2.9_linux_amd64.tar.gz
```
This will unpack and place the contents of the archive in the current directory, file `subnet-evm` is the plugin binary. You need to stop the node now (if the node is running as a service, use `sudo systemctl stop avalanchego` command). You need to place that file into the plugins directory where the AvalancheGo binary is located. If the node is installed using the install script, the path will be `~/avalanche-node/plugins` Instead of the `subnet-evm` filename, VM binary needs to be named as the VM ID of the chain on the Avalanche L1. For example, for the [WAGMI Avalanche L1](/docs/avalanche-l1s/wagmi-avalanche-l1) that VM ID is `srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy`. So, the command to copy the new plugin binary would look like:
```bash
cp subnet-evm ~/avalanche-node/plugins/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy
```
Make sure you use the correct VM ID, otherwise, your VM will not get updated and your Avalanche L1 may halt.
After you do that, you can start the node back up (if running as service do `sudo systemctl start avalanchego`). You can monitor the log output on the node to check that everything is OK, or you can use the [info.getNodeVersion()](/docs/rpcs/other/info-rpc#infogetnodeversion) API to check the versions. Example output would look like:
```json
{
"jsonrpc": "2.0",
"result": {
"version": "avalanche/1.7.18",
"databaseVersion": "v1.4.5",
"gitCommit": "b6d5827f1a87e26da649f932ad649a4ea0e429c4",
"vmVersions": {
"avm": "v1.7.18",
"evm": "v0.8.15",
"platform": "v1.7.18",
"sqja3uK17MJxfC7AN8nGadBw9JK5BcrsNwNynsqP5Gih8M5Bm": "v0.0.7",
"srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy": "v0.2.9"
}
},
"id": 1
}
```
Note that entry next to the VM ID we upgraded correctly says `v0.2.9`. You have successfully upgraded the VM!
Refer to the previous section on how to make sure node is healthy and connected before moving on to upgrading the next Avalanche L1 validator.
If you don't get the expected result, you can stop the `AvalancheGo`, examine and follow closely step-by-step of the above. You are free to remove files under `~/avalanche-node/plugins`, however, you should keep in mind that removing files is to remove an existing VM binary. You must put the correct VM plugin in place before you restart AvalancheGo.
Network Upgrades[](#network-upgrades "Direct link to heading")
---------------------------------------------------------------
Sometimes you need to do a network upgrade to change the configured rules in the genesis under which the Chain operates. In regular EVM, network upgrades are a pretty involved process that includes deploying the new EVM binary, coordinating the timed upgrade and deploying changes to the nodes. But since [Subnet-EVM v0.2.8](https://github.com/ava-labs/subnet-evm/releases/tag/v0.2.8), we introduced the long awaited feature to perform network upgrades by just using a few lines of JSON. Upgrades can consist of enabling/disabling particular precompiles, or changing their parameters. Currently available precompiles allow you to:
- Restrict Smart Contract Deployers
- Restrict Who Can Submit Transactions
- Mint Native Coins
- Configure Dynamic Fees
Please refer to [Customize an Avalanche L1](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#network-upgrades-enabledisable-precompiles) for a detailed discussion of possible precompile upgrade parameters.
Summary[](#summary "Direct link to heading")
---------------------------------------------
Vital part of Avalanche L1 maintenance is performing timely upgrades at all levels of the software stack running your Avalanche L1. We hope this tutorial will give you enough information and context to allow you to do those upgrades with confidence and ease. If you have additional questions or any issues, please reach out to us on [Discord](https://chat.avalabs.org/).
# Precompile Upgrades (/docs/avalanche-l1s/upgrade/precompile-upgrades)
---
title: Precompile Upgrades
description: Learn how to enable, disable, and configure precompiles in your Subnet-EVM.
---
# Precompile Upgrades
Performing a network upgrade requires coordinating the upgrade network-wide. A network upgrade changes the rule set used to process and verify blocks, such that any node that upgrades incorrectly or fails to upgrade by the time that upgrade goes into effect may become out of sync with the rest of the network.
Any mistakes in configuring network upgrades or coordinating them on validators may cause the network to halt and recovering may be difficult.
Subnet-EVM precompiles can be individually enabled or disabled at a given timestamp as a network upgrade. When disabling a precompile, it disables calling the precompile and destructs its storage, allowing it to be enabled later with a new configuration if desired.
## Configuration File
These upgrades must be specified in a file named `upgrade.json` placed in the same directory where `config.json` resides: `{chain-config-dir}/{blockchainID}/upgrade.json`. For example, `WAGMI Subnet` upgrade should be placed in `~/.avalanchego/configs/chains/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt/upgrade.json`.
The content of the `upgrade.json` should be formatted according to the following:
```json
{
"precompileUpgrades": [
{
"[PRECOMPILE_NAME]": {
"blockTimestamp": "[ACTIVATION_TIMESTAMP]", // unix timestamp precompile should activate at
"[PARAMETER]": "[VALUE]" // precompile specific configuration options, eg. "adminAddresses"
}
}
]
}
```
An invalid `blockTimestamp` in an upgrade file results the update failing. The `blockTimestamp` value should be set to a valid Unix timestamp value which is in the _future_ relative to the _head of the chain_. If the node encounters a `blockTimestamp` which is in the past, it will fail on startup.
## Disabling Precompiles
To disable a precompile, use the following format:
```json
{
"precompileUpgrades": [
{
"": {
"blockTimestamp": "[DEACTIVATION_TIMESTAMP]", // unix timestamp the precompile should deactivate at
"disable": true
}
}
]
}
```
Each item in `precompileUpgrades` must specify exactly one precompile to enable or disable and the block timestamps must be in increasing order. Once an upgrade has been activated (a block after the specified timestamp has been accepted), it must always be present in `upgrade.json` exactly as it was configured at the time of activation (otherwise the node will refuse to start).
For safety, you should always treat `precompileUpgrades` as append-only.
As a last resort measure, it is possible to abort or reconfigure a precompile upgrade that has not been activated since the chain is still processing blocks using the prior rule set.
If aborting an upgrade becomes necessary, you can remove the precompile upgrade from `upgrade.json` from the end of the list of upgrades. As long as the blockchain has not accepted a block with a timestamp past that upgrade's timestamp, it will abort the upgrade for that node.
## Example Configuration
Here's a complete example that demonstrates enabling and disabling precompiles:
```json
{
"precompileUpgrades": [
{
"feeManagerConfig": {
"blockTimestamp": 1668950000,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
},
{
"txAllowListConfig": {
"blockTimestamp": 1668960000,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
},
{
"feeManagerConfig": {
"blockTimestamp": 1668970000,
"disable": true
}
}
]
}
```
This example:
1. Enables the `feeManagerConfig` at timestamp `1668950000`
2. Enables `txAllowListConfig` at timestamp `1668960000`
3. Disables `feeManagerConfig` at timestamp `1668970000`
## Initial Precompile Configurations
Precompiles can be managed by privileged addresses to change their configurations and activate their effects. For example, the `feeManagerConfig` precompile can have `adminAddresses` which can change the fee structure of the network:
```json
{
"precompileUpgrades": [
{
"feeManagerConfig": {
"blockTimestamp": 1668950000,
"adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"]
}
}
]
}
```
In this example, only the specified address can change the network's fee structure. The admin must call the precompile to activate changes by sending a transaction with a new fee config.
### Initial Configurations Without Admin
Precompiles can also activate their effect immediately at the activation timestamp without admin addresses. For example:
```json
{
"precompileUpgrades": [
{
"feeManagerConfig": {
"blockTimestamp": 1668950000,
"initialFeeConfig": {
"gasLimit": 20000000,
"targetBlockRate": 2,
"minBaseFee": 1000000000,
"targetGas": 100000000,
"baseFeeChangeDenominator": 48,
"minBlockGasCost": 0,
"maxBlockGasCost": 10000000,
"blockGasCostStep": 500000
}
}
}
]
}
```
It's still possible to add `adminAddresses` or `enabledAddresses` along with these initial configurations. In this case, the precompile will be activated with the initial configuration, and admin/enabled addresses can access to the precompiled contract normally.
If you want to change the precompile initial configuration, you will need to first disable it then activate the precompile again with the new configuration.
## Verifying Upgrades
After creating or modifying `upgrade.json`, restart your node to load the changes. The node will print the chain configuration on startup, allowing you to verify the upgrade configuration:
```bash
INFO [08-15|15:09:36.772] <2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt Chain>
github.com/ava-labs/subnet-evm/eth/backend.go:155: Initialised chain configuration
config="{ChainID: 11111 Homestead: 0 EIP150: 0 EIP155: 0 EIP158: 0 Byzantium: 0
Constantinople: 0 Petersburg: 0 Istanbul: 0, Muir Glacier: 0, Subnet EVM: 0, FeeConfig:
{\"gasLimit\":20000000,\"targetBlockRate\":2,\"minBaseFee\":1000000000,\"targetGas\
":100000000,\"baseFeeChangeDenominator\":48,\"minBlockGasCost\":0,\"maxBlockGasCost\
":10000000,\"blockGasCostStep\":500000}, AllowFeeRecipients: false, NetworkUpgrades: {\
"subnetEVMTimestamp\":0}, PrecompileUpgrade: {}, UpgradeConfig: {\"precompileUpgrades\":[{\"feeManagerConfig\":{\"adminAddresses\":[\"0x8db97c7cece249c2b98bdc0226cc4c2a57bf52fc\"],\"enabledAddresses\":null,\"blockTimestamp\":1668950000}},{\"txAllowListConfig\":{\"adminAddresses\":[\"0x8db97c7cece249c2b98bdc0226cc4c2a57bf52fc\"],\"enabledAddresses\":null,\"blockTimestamp\":1668960000}},{\"feeManagerConfig\":{\"adminAddresses\":null,\"enabledAddresses\":null,\"blockTimestamp\":1668970000,\"disable\":true}}]}, Engine: Dummy Consensus Engine}"
```
You can also verify precompile configurations using:
- [`eth_getActiveRulesAt`](/docs/rpcs/subnet-evm#eth_getactiverulesat) RPC method to check activated precompiles at a timestamp
- [`eth_getChainConfig`](/docs/rpcs/subnet-evm#eth_getchainconfig) RPC method to view the complete configuration including upgrades
# Data API vs RPC (/docs/api-reference/data-api/data-vs-rpc)
---
title: Data API vs RPC
description: Comparison of the Data API and RPC methods
icon: Server
---
In the rapidly evolving world of Web3 development, efficiently retrieving token balances for a user's address is a fundamental requirement. Whether you're building DeFi platforms, wallets, analytics tools, or exchanges, displaying accurate token balances is crucial for user engagement and trust. A typical use case involves showing a user's token portfolio in a wallet application, in this case, we have sAvax and USDC.
Developers generally have two options to fetch this data:
1. **Using RPC methods to index blockchain data on their own**
2. **Leveraging an indexer provider like the Data API**
While both methods aim to achieve the same goal, the Data API offers a more efficient, scalable, and developer-friendly solution. This article delves into why using the Data API is better than relying on traditional RPC (Remote Procedure Call) methods.
### What Are RPC methods and their challenges?
Remote Procedure Call (RPC) methods allow developers to interact directly with blockchain nodes. One of their key advantages is that they are standardized and universally understood by blockchain developers across different platforms. With RPC, you can perform tasks such as querying data, submitting transactions, and interacting with smart contracts. These methods are typically low-level and synchronous, meaning they require a deep understanding of the blockchain’s architecture and specific command structures.
You can refer to the [official documentation](https://ethereum.org/en/developers/docs/apis/json-rpc/) to gain a more comprehensive understanding of the JSON-RPC API.
Here’s an example using the `eth_getBalance` method to retrieve the native balance of a wallet:
```bash
curl --location 'https://api.avax.network/ext/bc/C/rpc' \
--header 'Content-Type: application/json' \
--data '{"method":"eth_getBalance","params":["0x8ae323046633A07FB162043f28Cea39FFc23B50A", "latest"],"id":1,"jsonrpc":"2.0"}'
```
This call returns the following response:
```json
{
"jsonrpc": "2.0",
"id": 1,
"result": "0x284476254bc5d594"
}
```
The balance in this wallet is 2.9016 AVAX. However, despite the wallet holding multiple tokens such as USDC, the `eth_getBalance` method only returns the AVAX amount and it does so in Wei and in hexadecimal format. This is not particularly human-readable, adding to the challenge for developers who need to manually convert the balance to a more understandable format.
#### No direct RPC methods to retrieve token balances
Despite their utility, RPC methods come with significant limitations when it comes to retrieving detailed token and transaction data. Currently, RPC methods do not provide direct solutions for the following:
* **Listing all tokens held by a wallet**: There is no RPC method that provides a complete list of ERC-20 tokens owned by a wallet.
* **Retrieving all transactions for a wallet**: : There is no direct method for fetching all transactions associated with a wallet.
* **Getting ERC-20/721/1155 token balances**: The `eth_getBalance` method only returns the balance of the wallet’s native token (such as AVAX on Avalanche) and cannot be used to retrieve ERC-20/721/1155 token balances.
To achieve these tasks using RPC methods alone, you would need to:
* **Query every block for transaction logs**: Scan the entire blockchain, which is resource-intensive and impractical.
* **Parse transaction logs**: Identify and extract ERC-20 token transfer events from each transaction.
* **Aggregate data**: Collect and process this data to compute balances and transaction histories.
#### Manual blockchain indexing is difficult and costly
Using RPC methods to fetch token balances involves an arduous process:
1. You must connect to a node and subscribe to new block events.
2. For each block, parse every transaction to identify ERC-20 token transfers involving the user's address.
3. Extract contract addresses and other relevant data from the parsed transactions.
4. Compute balances by processing transfer events.
5. Store the processed data in a database for quick retrieval and aggregation.
#### Why this is difficult:
* **Resource-Intensive**: Requires significant computational power and storage to process and store blockchain data.
* **Time-consuming**: Processing millions of blocks and transactions can take an enormous amount of time.
* **Complexity**: Handling edge cases like contract upgrades, proxy contracts, and non-standard implementations adds layers of complexity.
* **Maintenance**: Keeping the indexed data up-to-date necessitates continuous synchronization with new blocks being added to the blockchain.
* **High Costs**: Associated with servers, databases, and network bandwidth.
### The Data API Advantage
The Data API provides a streamlined, efficient, and scalable solution for fetching token balances. Here's why it's the best choice:
With a single API call, you can retrieve all ERC-20 token balances for a user's address:
```javascript
avalancheSDK.data.evm.balances.listErc20Balances({
address: "0xYourAddress",
});
```
Sample Response:
```json
{
"erc20TokenBalances": [
{
"ercType": "ERC-20",
"chainId": "43114",
"address": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E",
"name": "USD Coin",
"symbol": "USDC",
"decimals": 6,
"price": {
"value": 1.0,
"currencyCode": "usd"
},
"balance": "15000000",
"balanceValue": {
"currencyCode": "usd",
"value": 9.6
},
"logoUri": "https://images.ctfassets.net/gcj8jwzm6086/e50058c1-2296-4e7e-91ea-83eb03db95ee/8db2a492ce64564c96de87c05a3756fd/43114-0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E.png"
}
// Additional tokens...
]
}
```
As you can see with a single call the API returns an array of token balances for all the wallet tokens, including:
* **Token metadata**: Contract address, name, symbol, decimals.
* **Balance information**: Token balance in both hexadecimal and decimal formats, Also retrieves balances of native assets like ETH or AVAX.
* **Price data**: Current value in USD or other supported currencies, saving you the effort of integrating another API.
* **Visual assets**: Token logo URI for better user interface integration.
If you’re building a wallet, DeFi app, or any application that requires displaying balances, transaction history, or smart contract interactions, relying solely on RPC methods can be challenging. Just as there’s no direct RPC method to retrieve token balances, there’s also no simple way to fetch all transactions associated with a wallet, especially for ERC-20, ERC-721, or ERC-1155 token transfers.
However, by using the Data API, you can retrieve all token transfers for a given wallet **with a single API call**, making the process much more efficient. This approach simplifies tracking and displaying wallet activity without the need to manually scan the entire blockchain.
Below are two examples that demonstrate the power of the Data API: in the first, it returns all ERC transfers, including ERC-20, ERC-721, and ERC-1155 tokens, and in the second, it shows all internal transactions, such as when one contract interacts with another.
[Lists ERC transfers](/data-api/evm-transactions/list-erc-transfers) for an ERC-20, ERC-721, or ERC-1155 contract address.
```javascript theme={null}
import { Avalanche } from "@avalanche-sdk/chainkit";
const avalancheSDK = new Avalanche({
apiKey: "",
chainId: "43114",
network: "mainnet",
});
async function run() {
const result = await avalancheSDK.data.evm.transactions.listTransfers({
startBlock: 6479329,
endBlock: 6479330,
pageSize: 10,
address: "0x71C7656EC7ab88b098defB751B7401B5f6d8976F",
});
for await (const page of result) {
// Handle the page
console.log(page);
}
}
run();
```
Example response
```json theme={null}
{
"nextPageToken": "",
"transfers": [
{
"blockNumber": "339",
"blockTimestamp": 1648672486,
"blockHash": "0x17533aeb5193378b9ff441d61728e7a2ebaf10f61fd5310759451627dfca2e7c",
"txHash": "0x3e9303f81be00b4af28515dab7b914bf3dbff209ea10e7071fa24d4af0a112d4",
"from": {
"name": "Wrapped AVAX",
"symbol": "WAVAX",
"decimals": 18,
"logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg",
"address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F"
},
"to": {
"name": "Wrapped AVAX",
"symbol": "WAVAX",
"decimals": 18,
"logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg",
"address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F"
},
"logIndex": 123,
"value": "10000000000000000000",
"erc20Token": {
"address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F",
"name": "Wrapped AVAX",
"symbol": "WAVAX",
"decimals": 18,
"logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg",
"ercType": "ERC-20",
"price": {
"currencyCode": "usd",
"value": "42.42"
}
}
}
]
}
```
[Returns a list of internal transactions](/data-api/evm-transactions/list-internal-transactions) for an address and chain. Filterable by block range.
```javascript theme={null}
import { Avalanche } from "@avalanche-sdk/chainkit";
const avalancheSDK = new Avalanche({
apiKey: "",
chainId: "43114",
network: "mainnet",
});
async function run() {
const result = await avalancheSDK.data.evm.transactions.listInternalTransactions({
startBlock: 6479329,
endBlock: 6479330,
pageSize: 10,
address: "0x71C7656EC7ab88b098defB751B7401B5f6d8976F",
});
for await (const page of result) {
// Handle the page
console.log(page);
}
}
run();
```
Example response
```json theme={null}
{
"nextPageToken": "",
"transactions": [
{
"blockNumber": "339",
"blockTimestamp": 1648672486,
"blockHash": "0x17533aeb5193378b9ff441d61728e7a2ebaf10f61fd5310759451627dfca2e7c",
"txHash": "0x3e9303f81be00b4af28515dab7b914bf3dbff209ea10e7071fa24d4af0a112d4",
"from": {
"name": "Wrapped AVAX",
"symbol": "WAVAX",
"decimals": 18,
"logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg",
"address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F"
},
"to": {
"name": "Wrapped AVAX",
"symbol": "WAVAX",
"decimals": 18,
"logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg",
"address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F"
},
"internalTxType": "UNKNOWN",
"value": "10000000000000000000",
"isReverted": true,
"gasUsed": "",
"gasLimit": ""
}
]
}
```
### Conclusion
Using the Data API over traditional RPC methods for fetching token balances offers significant advantages:
* **Efficiency**: Retrieve all necessary information in a single API call.
* **Simplicity**: Eliminates complex data processing and reduces development time.
* **Scalability**: Handles large volumes of data efficiently, suitable for real-time applications.
* **Comprehensive Data**: Provides enriched information, including token prices and logos.
* **Reliability**: Ensures data accuracy and consistency without the need for extensive error handling.
For developers building Web3 applications, leveraging the Data API is the smarter choice. It not only simplifies your codebase but also enhances the user experience by providing accurate and timely data.
If you’re building cutting-edge Web3 applications, this API is the key to improving your workflow and performance. Whether you’re developing DeFi solutions, wallets, or analytics platforms, take your project to the next level. [Start today with the Data API](/data-api/getting-started) and experience the difference!
# Getting Started (/docs/api-reference/data-api/getting-started)
---
title: Getting Started
description: Getting Started with the Data API
icon: Book
---
To begin, create your free account by visiting [Builder Hub Console](https://build.avax.network/login?callbackUrl=%2Fconsole%2Futilities%2Fdata-api-keys).
Once the account is created:
1. Navigating to [**Data API Keys**](https://build.avax.network/console/utilities/data-api-keys)
2. Click on **Create API Key**
3. Set an alias and click on **create**
4. Copy the the value
Always keep your API keys in a secure environment. Never expose them in public repositories, such as GitHub, or share them with unauthorized individuals. Compromised API keys can lead to unauthorized access and potential misuse of your account.
With your API Key you can start making queries, for example to get the latest block on the C-chain(43114):
```bash theme={null}
curl --location 'https://data-api.avax.network/v1/chains/43114/blocks' \
--header 'accept: application/json' \
--header 'x-glacier-api-key: ' \
```
And you should see something like this:
```json theme={null}
{
"blocks": [
{
"blockNumber": "49889407",
"blockTimestamp": 1724990250,
"blockHash": "0xd34becc82943e3e49048cdd3f75b80a87e44eb3aed6b87cc06867a7c3b9ee213",
"txCount": 1,
"baseFee": "25000000000",
"gasUsed": "53608",
"gasLimit": "15000000",
"gasCost": "0",
"parentHash": "0xf4917efb4628a1d8f4d101b3d15bce9826e62ef2c93c3e16ee898d27cf02f3d4",
"feesSpent": "1435117553916960",
"cumulativeTransactions": "500325352"
},
{
"blockNumber": "49889406",
"blockTimestamp": 1724990248,
"blockHash": "0xf4917efb4628a1d8f4d101b3d15bce9826e62ef2c93c3e16ee898d27cf02f3d4",
"txCount": 2,
"baseFee": "25000000000",
"gasUsed": "169050",
"gasLimit": "15000000",
"gasCost": "0",
"parentHash": "0x2a54f142fa3acee92a839b071bb6c7cca7abc2a797cf4aac68b07f79406ac0cb",
"feesSpent": "4226250000000000",
"cumulativeTransactions": "500325351"
},
{
"blockNumber": "49889405",
"blockTimestamp": 1724990246,
"blockHash": "0x2a54f142fa3acee92a839b071bb6c7cca7abc2a797cf4aac68b07f79406ac0cb",
"txCount": 4,
"baseFee": "25000000000",
"gasUsed": "618638",
"gasLimit": "15000000",
"gasCost": "0",
"parentHash": "0x0cda1bb5c86e790976c9330c9fc26e241a705afbad11a4caa44df1c81058451d",
"feesSpent": "16763932426044724",
"cumulativeTransactions": "500325349"
},
{
"blockNumber": "49889404",
"blockTimestamp": 1724990244,
"blockHash": "0x0cda1bb5c86e790976c9330c9fc26e241a705afbad11a4caa44df1c81058451d",
"txCount": 3,
"baseFee": "25000000000",
"gasUsed": "254544",
"gasLimit": "15000000",
"gasCost": "0",
"parentHash": "0x60e55dd9eacc095c07f50a73e02d81341c406584f7abbf5d10d938776a4c893c",
"feesSpent": "6984642298020000",
"cumulativeTransactions": "500325345"
},
{
"blockNumber": "49889403",
"blockTimestamp": 1724990242,
"blockHash": "0x60e55dd9eacc095c07f50a73e02d81341c406584f7abbf5d10d938776a4c893c",
"txCount": 2,
"baseFee": "25000000000",
"gasUsed": "65050",
"gasLimit": "15000000",
"gasCost": "0",
"parentHash": "0xa3e9f91f45a85ed00b8ebe8e5e976ed1a1f52612143eddd3de9d2588d05398b8",
"feesSpent": "1846500000000000",
"cumulativeTransactions": "500325342"
},
{
"blockNumber": "49889402",
"blockTimestamp": 1724990240,
"blockHash": "0xa3e9f91f45a85ed00b8ebe8e5e976ed1a1f52612143eddd3de9d2588d05398b8",
"txCount": 2,
"baseFee": "25000000000",
"gasUsed": "74608",
"gasLimit": "15000000",
"gasCost": "0",
"parentHash": "0x670db772edfc2fdae322d55473ba0670690aed6358a067a718492c819d63356a",
"feesSpent": "1997299851936960",
"cumulativeTransactions": "500325340"
},
{
"blockNumber": "49889401",
"blockTimestamp": 1724990238,
"blockHash": "0x670db772edfc2fdae322d55473ba0670690aed6358a067a718492c819d63356a",
"txCount": 1,
"baseFee": "25000000000",
"gasUsed": "273992",
"gasLimit": "15000000",
"gasCost": "0",
"parentHash": "0x75742cf45383ce54823690b9dd2e85a743be819281468163d276f145d077902a",
"feesSpent": "7334926295195040",
"cumulativeTransactions": "500325338"
},
{
"blockNumber": "49889400",
"blockTimestamp": 1724990236,
"blockHash": "0x75742cf45383ce54823690b9dd2e85a743be819281468163d276f145d077902a",
"txCount": 1,
"baseFee": "25000000000",
"gasUsed": "291509",
"gasLimit": "15000000",
"gasCost": "0",
"parentHash": "0xe5055eae3e1fd2df24b61e9c691f756c97e5619cfc66b69cbcb6025117d1bde7",
"feesSpent": "7724988500000000",
"cumulativeTransactions": "500325337"
},
{
"blockNumber": "49889399",
"blockTimestamp": 1724990234,
"blockHash": "0xe5055eae3e1fd2df24b61e9c691f756c97e5619cfc66b69cbcb6025117d1bde7",
"txCount": 8,
"baseFee": "25000000000",
"gasUsed": "824335",
"gasLimit": "15000000",
"gasCost": "0",
"parentHash": "0xbcacff928f7dd20cc1522155e7c9b9716997914b53ab94034b813c3f207174ef",
"feesSpent": "21983004380692400",
"cumulativeTransactions": "500325336"
},
{
"blockNumber": "49889398",
"blockTimestamp": 1724990229,
"blockHash": "0xbcacff928f7dd20cc1522155e7c9b9716997914b53ab94034b813c3f207174ef",
"txCount": 1,
"baseFee": "25000000000",
"gasUsed": "21000",
"gasLimit": "15000000",
"gasCost": "0",
"parentHash": "0x0b686812078429d33e4224d2b48bd26b920db8dbb464e7f135d980759ca7e947",
"feesSpent": "562182298020000",
"cumulativeTransactions": "500325328"
}
],
"nextPageToken": "9f9e1d25-14a9-49f4-8742-fd4bf12f7cd8"
}
```
Congratulations! You’ve successfully set up your account and made your first query to the Data API 🚀🚀🚀
# Data API (/docs/api-reference/data-api)
---
title: Data API
description: Access comprehensive blockchain data for Avalanche networks
icon: Database
---
### What is the Data API?
The Data API provides web3 application developers with multi-chain data related to Avalanche's primary network, Avalanche L1s, and Ethereum. With the Data API, you can easily build products that leverage real-time and historical transaction and transfer history, native and token balances, and various types of token metadata.
The [Data API](/docs/api-reference/data-api), along with the [Metrics API](/docs/api-reference/metrics-api), are the engines behind the [Avalanche Explorer](https://subnets.avax.network/stats/) and the [Core wallet](https://core.app/en/). They are used to display transactions, logs, balances, NFTs, and more. The data and visualizations presented are all powered by these APIs, offering real-time and historical insights that are essential for building sophisticated, data-driven blockchain products.
### Features
* **Extensive L1 Support**: Gain access to data from over 100+ L1s across both mainnet and testnet. If an L1 is listed on the [Avalanche Explorer](https://subnets.avax.network/), you can query its data using the Data API.
* **Transactions and UTXOs**: easily retrieve details related to transactions, UTXOs, and token transfers from Avalanche EVMs, Ethereum, and Avalanche's Primary Network - the P-Chain, X-Chain and C-Chain.
* **Blocks**: retrieve latest blocks and block details
* **Balances**: fetch balances of native, ERC-20, ERC-721, and ERC-1155 tokens along with relevant metadata.
* **Tokens**: augment your user experience with asset details.
* **Staking**: get staking related data for active and historical validations.
### Supported Chains
Avalanche’s architecture supports a diverse ecosystem of interconnected L1 blockchains, each operating independently while retaining the ability to seamlessly communicate with other L1s within the network. Central to this architecture is the Primary Network—Avalanche’s foundational network layer, which all validators are required to validate prior to [ACP-77](/docs/acps/77-reinventing-subnets). The Primary Network runs three essential blockchains:
* The Contract Chain (C-Chain)
* The Platform Chain (P-Chain)
* The Exchange Chain (X-Chain)
However, with the implementation of [ACP-77](/docs/acps/77-reinventing-subnets), this requirement will change. Subnet Validators will be able to operate independently of the Primary Network, allowing for more flexible and affordable Subnet creation and management.
The **Data API** supports a wide range of L1 blockchains (**over 100**) across both **mainnet** and **testnet**, including popular ones like Beam, DFK, Lamina1, Dexalot, Shrapnel, and Pulsar. In fact, every L1 you see on the [Avalanche Explorer](https://explorer.avax.network/) can be queried through the Data API. This list is continually expanding as we keep adding more L1s. For a full list of supported chains, visit [List chains](/docs/api-reference/data-api/evm-chains/supportedChains).
#### The Contract Chain (C-Chain)
The C-Chain is an implementation of the Ethereum Virtual Machine (EVM). The primary network endpoints only provide information related to C-Chain atomic memory balances and import/export transactions. For additional data, please reference the [EVM APIs](/docs/rpcs/c-chain/rpc).
#### The Platform Chain (P-Chain)
The P-Chain is responsible for all validator and L1-level operations. The P-Chain supports the creation of new blockchains and L1s, the addition of validators to L1s, staking operations, and other platform-level operations.
#### The Exchange Chain (X-Chain)
The X-Chain is responsible for operations on digital smart assets known as Avalanche Native Tokens. A smart asset is a representation of a real-world resource (for example, equity, or a bond) with sets of rules that govern its behavior, like "can’t be traded until tomorrow." The X-Chain supports the creation and trade of Avalanche Native Tokens.
| Feature | Description |
| :--------------- | :--------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------- |
| **Chains** | Utilize this endpoint to retrieve the Primary Network chains that an address has transaction history associated with. |
| **Blocks** | Blocks are the container for transactions executed on the Primary Network. Retrieve the latest blocks, a specific block by height or hash, or a list of blocks proposed by a specified NodeID on Primary Network chains. |
| **Vertices** | Prior to Avalanche Cortina (v1.10.0), the X-Chain functioned as a DAG with vertices rather than blocks. These endpoints allow developers to retrieve historical data related to that period of chain history. Retrieve the latest vertices, a specific vertex, or a list of vertices at a specific height from the X-Chain. |
| **Transactions** | Transactions are a user's primary form of interaction with a chain and provide details around their on-chain activity, including staking-related behavior. Retrieve a list of the latest transactions, a specific transaction, a list of active staking transactions for a specified address, or a list of transactions associated with a provided asset id from Primary Network chains. |
| **UTXOs** | UTXOs are fundamental elements that denote the funds a user has available. Get a list of UTXOs for provided addresses from the Primary Network chains. |
| **Balances** | User balances are an essential function of the blockchain. Retrieve balances related to the X and P-Chains, as well as atomic memory balances for the C-Chain. |
| **Rewards** | Staking is the process where users lock up their tokens to support a blockchain network and, in return, receive rewards. It is an essential part of proof-of-stake (PoS) consensus mechanisms used by many blockchain networks, including Avalanche. Using the Data API, you can easily access pending and historical rewards associated with a set of addresses. |
| **Assets** | Get asset details corresponding to the given asset id on the X-Chain. |
#### EVM
The C-Chain is an instance of the Coreth Virtual Machine, and many Avalanche L1s are instances of the *Subnet-EVM*, which is a Virtual Machine (VM) that defines the L1 Contract Chains. *Subnet-EVM* is a simplified version of *Coreth VM* (C-Chain).
| Feature | Description |
| :--------------- | :------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------ |
| **Chains** | There are a number of chains supported by the Data API. These endpoints can be used to understand which chains are included/indexed as part of the API and retrieve information related to a specific chain. |
| **Blocks** | Blocks are the container for transactions executed within the EVM. Retrieve the latest blocks or a specific block by height or hash. |
| **Transactions** | Transactions are a user's primary form of interaction with a chain and provide details around their on-chain activity. These endpoints can be used to retrieve information related to specific transaction details, internal transactions, contract deployments, specific token standard transfers, and more! |
| **Balances** | User balances are an essential function of the blockchain. Easily retrieve native token, collectible, and fungible token balances related to an EVM chain with these endpoints. |
#### Operations
The Operations API allows users to easily access their on-chain history by creating transaction exports returned in a CSV format. This API supports EVMs as well as non-EVM Primary Network chains.
# Rate Limits (/docs/api-reference/data-api/rate-limits)
---
title: Rate Limits
description: Rate Limits for the Data API
icon: Clock
---
Rate limiting is managed through a weighted scoring system, known as Compute Units (CUs). Each API request consumes a specified number of CUs, determined by the complexity of the request. This system is designed to accommodate basic requests while efficiently handling more computationally intensive operations.
## Rate Limit Tiers
The maximum CUs (rate-limiting score) for a user depends on their subscription level and is delineated in the following table:
| Subscription Level | Per Minute Limit (CUs) | Per Day Limit (CUs) |
| :----------------- | :--------------------- | :------------------ |
| Unauthenticated | 6,000 | 1,200,000 |
| Free | 8,000 | 2,000,000 |
| Base | 10,000 | 3,750,000 |
| Growth | 14,000 | 11,200,000 |
| Pro | 20,000 | 25,000,000 |
To update your subscription level use the [AvaCloud Portal](https://app.avacloud.io/)
Note: Rate limits apply collectively across both Webhooks and Data APIs, with usage from each counting toward your total CU limit.
## Rate Limit Categories
The CUs for each category are defined in the following table:
| Weight | CU Value |
| :----- | :------- |
| Free | 1 |
| Small | 10 |
| Medium | 20 |
| Large | 50 |
| XL | 100 |
| XXL | 200 |
## Rate Limits for Data API Endpoints
The CUs for each route are defined in the table below:
| Endpoint | Method | Weight | CU Value |
| :-------------------------------------------------------------------------------- | :----- | :----- | :------- |
| `/v1/health-check` | GET | Medium | 20 |
| `/v1/address/{address}/chains` | GET | Medium | 20 |
| `/v1/transactions` | GET | Medium | 20 |
| `/v1/blocks` | GET | Medium | 20 |
| `/v1/chains/{chainId}/nfts/collections/{address}/tokens/{tokenId}:reindex` | POST | Small | 10 |
| `/v1/chains/{chainId}/nfts/collections/{address}/tokens` | GET | Medium | 20 |
| `/v1/chains/{chainId}/nfts/collections/{address}/tokens/{tokenId}` | GET | Medium | 20 |
| `/v1/operations/{operationId}` | GET | Small | 10 |
| `/v1/operations/transactions:export` | POST | Medium | 20 |
| `/v1/networks/{network}/blockchains/{blockchainId}/transactions/{txHash}` | GET | Medium | 20 |
| `/v1/networks/{network}/blockchains/{blockchainId}/transactions` | GET | XL | 100 |
| `/v1/networks/{network}/blockchains/{blockchainId}/transactions:listStaking` | GET | XL | 100 |
| `/v1/networks/{network}/rewards:listPending` | GET | XL | 100 |
| `/v1/networks/{network}/rewards` | GET | XL | 100 |
| `/v1/networks/{network}/blockchains/{blockchainId}/utxos` | GET | XL | 100 |
| `/v1/networks/{network}/blockchains/{blockchainId}/balances` | GET | XL | 100 |
| `/v1/networks/{network}/blockchains/{blockchainId}/blocks/{blockId}` | GET | XL | 100 |
| `/v1/networks/{network}/blockchains/{blockchainId}/nodes/{nodeId}/blocks` | GET | Medium | 20 |
| `/v1/networks/{network}/blockchains/{blockchainId}/blocks` | GET | Medium | 20 |
| `/v1/networks/{network}/blockchains/{blockchainId}/vertices` | GET | Medium | 20 |
| `/v1/networks/{network}/blockchains/{blockchainId}/vertices/{vertexHash}` | GET | Medium | 20 |
| `/v1/networks/{network}/blockchains/{blockchainId}/vertices:listByHeight` | GET | Medium | 20 |
| `/v1/networks/{network}/blockchains/{blockchainId}/assets/{assetId}` | GET | XL | 100 |
| `/v1/networks/{network}/blockchains/{blockchainId}/assets/{assetId}/transactions` | GET | XL | 100 |
| `/v1/networks/{network}/addresses:listChainIds` | GET | XL | 100 |
| `/v1/networks/{network}` | GET | XL | 100 |
| `/v1/networks/{network}/blockchains` | GET | Medium | 20 |
| `/v1/networks/{network}/subnets` | GET | Medium | 20 |
| `/v1/networks/{network}/subnets/{subnetId}` | GET | Medium | 20 |
| `/v1/networks/{network}/validators` | GET | Medium | 20 |
| `/v1/networks/{network}/validators/{nodeId}` | GET | Medium | 20 |
| `/v1/networks/{network}/delegators` | GET | Medium | 20 |
| `/v1/networks/{network}/l1Validators` | GET | Medium | 20 |
| `/v1/teleporter/messages/{messageId}` | GET | Medium | 20 |
| `/v1/teleporter/messages` | GET | Medium | 20 |
| `/v1/teleporter/addresses/{address}/messages` | GET | Medium | 20 |
| `/v1/icm/messages/{messageId}` | GET | Medium | 20 |
| `/v1/icm/messages` | GET | Medium | 20 |
| `/v1/icm/addresses/{address}/messages` | GET | Medium | 20 |
| `/v1/apiUsageMetrics` | GET | XXL | 200 |
| `/v1/apiLogs` | GET | XXL | 200 |
| `/v1/subnetRpcUsageMetrics` | GET | XXL | 200 |
| `/v1/rpcUsageMetrics` | GET | XXL | 200 |
| `/v1/primaryNetworkRpcUsageMetrics` | GET | XXL | 200 |
| `/v1/signatureAggregator/{network}/aggregateSignatures` | POST | Medium | 20 |
| `/v1/signatureAggregator/{network}/aggregateSignatures/{txHash}` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/balances:getNative` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/balances:listErc20` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/balances:listErc721` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/balances:listErc1155` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/balances:listCollectibles` | GET | Medium | 20 |
| `/v1/chains/{chainId}/blocks` | GET | Small | 10 |
| `/v1/chains/{chainId}/blocks/{blockId}` | GET | Small | 10 |
| `/v1/chains/{chainId}/contracts/{address}/transactions:getDeployment` | GET | Medium | 20 |
| `/v1/chains/{chainId}/contracts/{address}/deployments` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}` | GET | Medium | 20 |
| `/v1/chains` | GET | Free | 1 |
| `/v1/chains/{chainId}` | GET | Free | 1 |
| `/v1/chains/address/{address}` | GET | Free | 1 |
| `/v1/chains/allTransactions` | GET | Free | 1 |
| `/v1/chains/allBlocks` | GET | Free | 1 |
| `/v1/chains/{chainId}/tokens/{address}/transfers` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/transactions` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/transactions:listNative` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/transactions:listErc20` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/transactions:listErc721` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/transactions:listErc1155` | GET | Medium | 20 |
| `/v1/chains/{chainId}/addresses/{address}/transactions:listInternals` | GET | Medium | 20 |
| `/v1/chains/{chainId}/transactions/{txHash}` | GET | Medium | 20 |
| `/v1/chains/{chainId}/blocks/{blockId}/transactions` | GET | Medium | 20 |
| `/v1/chains/{chainId}/transactions` | GET | Medium | 20 |
## Rate Limits for RPC endpoints
The CUs for RPC calls are calculated based on the RPC method(s) within the request. The CUs assigned to each method are defined in the table below:
| Method | Weight | CU Value |
| :---------------------------------------- | :----- | :------- |
| `eth_accounts` | Free | 1 |
| `eth_blockNumber` | Small | 10 |
| `eth_call` | Small | 10 |
| `eth_coinbase` | Small | 10 |
| `eth_chainId` | Free | 1 |
| `eth_gasPrice` | Small | 10 |
| `eth_getBalance` | Small | 10 |
| `eth_getBlockByHash` | Small | 10 |
| `eth_getBlockByNumber` | Small | 10 |
| `eth_getBlockTransactionCountByNumber` | Medium | 20 |
| `eth_getCode` | Medium | 20 |
| `eth_getLogs` | XXL | 200 |
| `eth_getStorageAt` | Medium | 20 |
| `eth_getTransactionByBlockNumberAndIndex` | Medium | 20 |
| `eth_getTransactionByHash` | Small | 10 |
| `eth_getTransactionCount` | Small | 10 |
| `eth_getTransactionReceipt` | Small | 10 |
| `eth_signTransaction` | Medium | 20 |
| `eth_sendTransaction` | Medium | 20 |
| `eth_sign` | Medium | 20 |
| `eth_sendRawTransaction` | Small | 10 |
| `eth_syncing` | Free | 1 |
| `net_listening` | Free | 1 |
| `net_peerCount` | Medium | 20 |
| `net_version` | Free | 1 |
| `web3_clientVersion` | Small | 10 |
| `web3_sha3` | Small | 10 |
| `eth_newPendingTransactionFilter` | Medium | 20 |
| `eth_maxPriorityFeePerGas` | Small | 10 |
| `eth_baseFee` | Small | 10 |
| `rpc_modules` | Free | 1 |
| `eth_getChainConfig` | Small | 10 |
| `eth_feeConfig` | Small | 10 |
| `eth_getActivePrecompilesAt` | Small | 10 |
All rate limits, weights, and CU values are subject to change.
# Snowflake Datashare (/docs/api-reference/data-api/snowflake)
---
title: Snowflake Datashare
description: Snowflake Datashare for Avalanche blockchain data
icon: Snowflake
---
Avalanche Primary Network data (C-chain, P-chain, and X-chain blockchains) can be accessed in a sql-based table format via the [Snowflake Data Marketplace.](https://app.snowflake.com/marketplace)
Explore the blockchain state since the Genesis Block. These tables provide insights on transaction gas fees, DeFi activity, the historical stake of validators on the primary network, AVAX emissions rewarded to past validators/delegators, and fees paid by Avalanche L1 Validators to the primary network.
## Available Blockchain Data
#### Primary Network
* **C-chain:**
* Blocks
* Transactions
* Logs
* Internal Transactions
* Receipts
* Messages
* **P-chain:**
* Blocks
* Transactions
* UTXOs
* **X-chain:**
* Blocks
* Transactions
* Vertices before the [X-chain Linearization](https://www.avax.network/blog/cortina-x-chain-linearization) in the Cortina Upgrade
* **Dictionary:** A data dictionary is provided with the listing with column and table descriptions. Example columns include:
* `c_blocks.blockchash`
* `c_transactions.transactionfrom`
* `c_logs.topichex_0`
* `p_blocks.block_hash`
* `p_blocks.block_index`
* `p_blocks.type`
* `p_transactions.timestamp`
* `p_transactions.transaction_hash`
* `utxos.utxo_id`
* `utxos.address`
* `vertices.vertex_hash`
* `vertices.parent_hash`
* `x_blocks.timestamp`
* `x_blocks.proposer_id`
* `x_transactions.transaction_hash`
* `x_transactions.type`
#### Available Avalanche L1s
* **Gunzilla**
* **Dexalot**
* **DeFi Kingdoms (DFK)**
* **Henesys (MapleStory Universe)**
#### L1 Data
* Blocks
* Transactions
* Logs
* Internal Transactions (currently unavailable for DFK)
* Receipts
* Messages
## Access
Search for "Ava Labs" on the [Snowflake Data Marketplace](https://app.snowflake.com/marketplace).
# Usage Guide (/docs/api-reference/data-api/usage)
---
title: Usage Guide
description: Usage Guide for the Data API
icon: Code
---
### Setup and Authentication
In order to utilize your accounts rate limits, you will need to make API requests with an API key. You can generate API Keys from the AvaCloud portal. Once you've created and retrieved that, you will be able to make authenticated queries by passing in your API key in the `x-glacier-api-key` header of your HTTP request.
An example curl request can be found below:
```bash
curl -H "Content-Type: Application/json" -H "x-glacier-api-key: your_api_key" \
"https://glacier-api.avax.network/v1/chains"
```
### Rate Limits
The Data API has rate limits in place to maintain it's stability and protect from bursts of incoming traffic. The rate limits associated with various plans can be found within AvaCloud.
When you hit your rate limit, the server will respond with a 429 http response code, and response headers to help you determine when you should start to make additional requests. The response headers follow the standards set in the RateLimit header fields for HTTP draft from the Internet Engineering Task Force.
With every response with a valid api key, the server will include the following headers:
* `ratelimit-policy` - The rate limit policy tied to your api key.
* `ratelimit-limit` - The number of requests you can send according to your policy.
* `ratelimit-remaining` - How many request remaining you can send in the period for your policy
For any request after the rate limit has been reached, the server will also respond with these headers:
* `ratelimit-reset`
* `retry-after`
Both of these headers are set to the number of seconds until your period is over and requests will start succeeding again.
If you start receiving rate limit errors with the 429 response code, we recommend you discontinue sending requests to the server. You should wait to retry requests for the duration specified in the response headers. Alternatively, you can implement an exponential backoff algorithm to prevent continuous errors. Failure to discontinue requests may result in being temporarily blocked from accessing the API.
Error Types
The Data API generates standard error responses along with error codes based on provided requests and parameters.
Typically, response codes within the `2XX` range signifies successful requests, while those within the `4XX` range points to errors originating from the client's side. Meanwhile, response codes within the `5XX` range indicates problems on the server's side.
### Error Types
The Glacier API generates standard error responses along with error codes based on provided requests and parameters.
Typically, response codes within the `2XX` range signifies successful requests, while those within the `4XX` range points to errors originating from the client's side. Meanwhile, response codes within the `5XX` range indicates problems on the server's side.
The error response body is formatted like this:
```json
{
"message": ["Invalid address format"], // route specific error message
"error": "Bad Request", // error type
"statusCode": 400 // http response code
}
```
Let's go through every error code that we can respond with:
| Error Code | Error Type | Description |
| :--------- | :-------------------- | :---------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------- |
| **400** | Bad Request | Bad requests generally mean the client has passed invalid or malformed parameters. Error messages in the response could help in evaluating the error. |
| **401** | Unauthorized | When a client attempts to access resources that require authorization credentials but the client lacks proper authentication in the request, the server responds with 401. |
| **403** | Forbidden | When a client attempts to access resources with valid credentials but doesn't have the privilege to perform that action, the server responds with 403. |
| **404** | Not Found | The 404 error is mostly returned when the client requests with either mistyped URL, or the passed resource is moved or deleted, or the resource doesn't exist. |
| **500** | Internal Server Error | The 500 error is a generic server-side error that is returned for any uncaught and unexpected issues on the server side. This should be very rare, and you may reach out to us if the problem persists for a longer duration. |
| **502** | Bad Gateway | This is an internal error indicating invalid response received by the client-facing proxy or gateway from the upstream server. |
| **503** | Service Unavailable | The 503 error is returned for certain routes on a particular Subnet. This indicates an internal problem with our Subnet node, and may not necessarily mean the Subnet is down or affected. |
The above list is not exhaustive of all the errors that you'll receive, but is categorized on the basis of error codes. You may see route-specific errors along with detailed error messages for better evaluating the response.
Reach out to our team when you see an error in the `5XX` range for a longer duration. These errors should be very rare, but we try to fix them as soon as possible once detected.
### Pagination
When utilizing pagination for endpoints that return lists of data such as transactions, UTXOs, or blocks, our API uses a straightforward mechanism to manage the navigation through large datasets. We divide data into pages and each page is limited with a `pageSize` number of elements as passed in the request. Users can navigate to subsequent pages using the page token received in the `nextPageToken` field. This method ensures efficient retrieval.
Routes with pagination have a following common response format:
```json
{
"blocks": [""], // This field name will vary by route
"nextPageToken": "3d22deea-ea64-4d30-8a1e-c2a353b67e90"
}
```
### Page Token Structure
* If there's more data in the dataset for the request, the API will include a UUID-based page token in the response. This token acts as a pointer to the next page of data.
* The UUID page token is generated randomly and uniquely for each pagination scenario, enhancing security and minimizing predictability.
* It's important to note that the page token is only returned when a next page is present. If there's no further data to retrieve, a page token will not be included in the response.
* The generated page token has an expiration window of 24 hours. Beyond this timeframe, the token will no longer be valid for accessing subsequent pages.
### Integration and Usage:
To make use of the pagination system, simply examine the API response. If a UUID page token is present, it indicates the availability of additional data on the next page. You can extract this token and include it in the subsequent request to access the subsequent page of results.
Please note that you must ensure that the subsequent request is made within the 24-hour timeframe after the original token's generation. Beyond this duration, the token will expire, and you will need to initiate a fresh request from the initial page.
By incorporating UUID page tokens, our API offers a secure, efficient, and user-friendly approach to navigating large datasets, streamlining your data retrieval proces
### Swagger API Reference
You can explore the full API definitions and interact with the endpoints in the Swagger documentation at:
[https://glacier-api.avax.network/api](https://glacier-api.avax.network/api)
# Validator Manager Contracts (/docs/avalanche-l1s/validator-manager/contract)
---
title: "Validator Manager Contracts"
description: "This page lists all available contracts for the Validator Manager."
edit_url: https://github.com/ava-labs/icm-contracts/edit/main/contracts/validator-manager/README.md
---
# Validator Manager Contracts
The contracts in this directory define the Validator Manager used to manage Avalanche L1 validators, as defined in [ACP-77](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets). They comply with [ACP-99](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/99-validatorsetmanager-contract), which specifies the standard minimal functionality that Validator Managers should implement. The contracts in this directory are are related as follows:
> ACP99Manager
class ValidatorManager {
+initializeValidatorSet()
+completeValidatorRegistration() onlyOwner
+completeValidatorRemoval() onlyOwner
+completeValidatorWeightUpdate() onlyOwner
+initiateValidatorRegistration() onlyOwner
+initiateValidatorRemoval() onlyOwner
+initiateValidatorWeightUpdate() onlyOwner
}
class PoAManager {
+completeValidatorRegistration()
+completeValidatorRemoval()
+completeValidatorWeightUpdate()
+initiateValidatorRegistration() onlyOwner
+initiateValidatorRemoval() onlyOwner
+initiateValidatorWeightUpdate() onlyOwner
+transferValidatorManagerOwnership() onlyOwner
}
class StakingManager {
+completeValidatorRegistration()
+initiateValidatorRemoval()
+completeValidatorRemoval()
+completeDelegatorRegistration()
+initiateDelegatorRemoval()
+completeDelegatorRemoval()
-_initiateValidatorRegistration()
-_initiateDelegatorRegistration()
}
<> StakingManager
class ERC20TokenStakingManager {
+initiateValidatorRegistration()
+initiateDelegatorRegistration()
}
class NativeTokenStakingManager {
+initiateValidatorRegistration() payable
+initiateDelegatorRegistration() payable
}
ACP99Manager <|-- ValidatorManager
ValidatorManager --o PoAManager : owner
ValidatorManager --o StakingManager : owner
StakingManager <|-- ERC20TokenStakingManager
StakingManager <|-- NativeTokenStakingManager`} />
## A Note on Nomenclature
The contracts in this directory are only useful to L1s that have been converted from Subnets as described in ACP-77. As such, `l1`/`L1` is generally preferred over `subnet`/`Subnet` in the source code. The one major exception is that `subnetID` should be used to refer to both Subnets that have not been converted, and L1s that have. This is because an L1 must first be initialized as a Subnet by issuing a `CreateSubnetTx` on the P-Chain, the transaction hash of which becomes the `subnetID`. Rather than change the name and/or value of this identifier, it is simpler for both to remain static in perpetuity.
## Deploying
The validator manager system consists of a `ValidatorManager`, and one of `NativeTokenStakingManager`, `ERC20TokenStakingManager`, or `PoAManager`. `ValidatorManager` is `Ownable`, and its owner should be set to the address of the other contract.
All of these are implemented as [upgradeable](https://github.com/OpenZeppelin/openzeppelin-contracts-upgradeable/blob/3d6a15108b50491ec3c51c03b32802c33e092a0f/contracts/proxy/utils/Initializable.sol#L56) contracts. There are numerous [guides](https://blog.chain.link/upgradable-smart-contracts/) for deploying upgradeable smart contracts, but the general steps are as follows:
1. Deploy the implementation contract
2. Deploy the proxy contract
3. Call the implementation contract's `initialize` function
- Each deployed contract requires different settings. For example, `ValidatorManagerSettings` specifies the churn parameters, while `StakingManagerSettings` specifies the staking and rewards parameters.
4. Initialize the validator set by calling `initializeValidatorSet` on `ValidatorManager`
- When an L1 is first created on the P-Chain, it must be explicitly converted to an L1 via [`ConvertSubnetToL1Tx`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#convertsubnettol1tx). The resulting `SubnetToL1ConversionMessage` ICM [message](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#subnettol1conversionmessage) is provided in the call to `initializeValidatorSet` to specify the starting validator set in the `ValidatorManager`. Regardless of the setup of the overall validator manager system, these initial validators are treated as PoA and are not eligible for staking rewards.
### Proof-of-Authority
PoA validator management is provided by `PoAManager` by providing an `owner` in the call to `initialize`. Only the `owner` may initiate validator set changes, but anybody can complete the validator set change by providing the corresponding ICM message signed by the P-Chain.
> [!NOTE]
> PoA validator management can also be implemented by `ValidatorManager` on its own, by setting the `owner` to the desired admin address. Unlike `PoAManager`, only the admin is able to initiate or complete validator set changes.
### Proof-of-Stake
PoS validator management is provided by the abstract contract `StakingManager`, which has two concrete implementations: `NativeTokenStakingManager` and `ERC20TokenStakingManager`. `StakingManager` supports uptime-based validation rewards, as well as delegation to a chosen validator. The `uptimeBlockchainID` used to initialize the `StakingManager` **must** be validated by the L1 validator set that the contract manages. **There is no way to verify this from within the contract, so take care when setting this value.** This [state transition diagram](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/StateTransition.md) illustrates the relationship between validators and delegators. After deploying `StakingManager` and a proxy, call the `initialize` function, which takes a `StakingManagerSettings` as well as any implementation-specific arguments.
> [!NOTE]
> The `weightToValueFactor` fields of `StakingManagerSettings` sets the factor used to convert between the weight that the validator is registered with on the P-Chain, and the value transferred to the contract as stake. This involves integer division, which may result in loss of precision. When selecting `weightToValueFactor`, it's important to make the following considerations:
>
> 1. If `weightToValueFactor` is near the denomination of the asset, then staking amounts on the order of 1 unit of the asset may cause the converted weight to round down to 0. This may impose a larger-than-expected minimum stake amount.
> - Ex: If USDC (denomination of 6) is used as the staking token and `weightToValueFactor` is 1e9, then any amount less than 1,000 USDC will round down to 0 and therefore be invalid.
> 2. Staked amounts up to `weightValueFactor - 1` may be lost in the contract as dust, as the validator's registered weight is used to calculate the original staked amount.
> - Ex: `value=1001` and `weightToValueFactor=1e3`. The resulting weight will be `1`. Converting the weight back to a value results in `value=1000`.
> 3. The validator's weight is represented on the P-Chain as a `uint64`. `StakingManager` restricts values such that the calculated weight does not exceed the maximum value for that type.
### Migrating from Proof-of-Authority to Proof-of-Stake
See the [migration guide](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/PoAMigration.md) for details.
#### NativeTokenStakingManager
`NativeTokenStakingManager` allows permissionless addition and removal of validators that post the L1's native token as stake. Staking rewards are minted via the Native Minter Precompile, which is configured with a set of addresses with minting privileges. As such, the address that `NativeTokenStakingManager` is deployed to must be added as an admin to the precompile. This can be done by either calling the precompile's `setAdmin` method from an admin address, or setting the address in the Native Minter precompile settings in the chain's genesis (`config.contractNativeMinterConfig.adminAddresses`). There are a couple of methods to get this address: one is to calculate the resulting deployed address based on the deployer's address and account nonce: `keccak256(rlp.encode(address, nonce))`. The second method involves manually placing the `NativeTokenStakingManager` bytecode at a particular address in the genesis, then setting that address as an admin.
```json
{
"config" : {
...
"contractNativeMinterConfig": {
"blockTimestamp": 0,
"adminAddresses": [
"0xffffffffffffffffffffffffffffffffffffffff"
]
}
},
"alloc": {
"0xffffffffffffffffffffffffffffffffffffffff": {
"balance": "0x0",
"code": "",
"nonce": 1
}
}
}
```
#### ERC20TokenStakingManager
`ERC20TokenStakingManager` allows permissionless addition and removal of validators that post the an ERC20 token as stake. The ERC20 is specified in the call to `initialize`, and must implement [`IERC20Mintable`](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/interfaces/IERC20Mintable.sol). Care should be taken to enforce that only authorized users are able to `mint` the ERC20 staking token.
## Usage
### Register a Validator
#### PoA
Validator registration is initiated with a call to `PoAManager.initiateValidatorRegistration`. Churn limitations are checked - only a certain (configurable) percentage of the total weight is allowed to be added or removed in a (configurable) period of time. The `ValidatorManager` then constructs a [`RegisterL1ValidatorMessage`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#registerl1validatormessage) ICM message to be sent to the P-Chain. Each validator registration request includes all of the information needed to identify the validator and its stake weight, as well as an `expiry` timestamp before which the `RegisterL1ValidatorMessage` must be delivered to the P-Chain. If the validator is not registered on the P-Chain before the `expiry`, then the validator may be removed from the contract state by calling `completeValidatorRemoval`.
The `RegisterL1ValidatorMessage` is delivered to the P-Chain as the ICM message payload of a `RegisterL1ValidatorTx`. Please see the transaction [specification](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#registerl1validatortx) for validity requirements. The P-Chain then signs a [`L1ValidatorRegistrationMessage`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#l1validatorregistrationmessage) ICM message indicating that the specified validator was successfully registered on the P-Chain.
The `L1ValidatorRegistrationMessage` is delivered by calling `ValidatorManager.completeValidatorRegistration`.
#### PoS
When registering a PoS validator, the same steps as the PoA case apply, with the only difference being that `StakingManager.initiateValidatorRegistration` and `StakingManager.completeValidatorRegistration` must be called instead.
The sender of the transaction that called `StakingManager.initiateValidatorRegistration` is registered as the validator owner. Only this owner can remove the validator.
Staking rewards begin accruing once `StakingManager.completeValidatorRegistration` is called.
### Remove a Validator
### PoA
Validator exit is initiated with a call to `PoAManager.initiateValidatorRemoval`. The `ValidatorManager` contructs an [`L1ValidatorWeightMessage`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#l1validatorweightmessage) ICM message with the weight set to `0`. This is delivered to the P-Chain as the payload of a [`SetL1ValidatorWeightTx`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#setl1validatorweighttx). The P-Chain acknowledges the validator exit by signing an `L1ValidatorRegistrationMessage` with `valid=0`, which is delivered by calling `ValidatorManager.completeValidatorRemoval`. The validation is removed from the contract's state.
### PoS
PoS validator removal follows the same flow as the PoA case, except that `StakingManager.initiateValidatorRemoval` and `StakingManager.completeValidatorRemoval` must be called instead.
There are two additional considerations:
- A [`ValidationUptimeMessage`](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/UptimeMessageSpec.md) ICM message may optionally be provided in the call to `StakingManager.initiateValidatorRemoval` in order to calculate the staking rewards; otherwise the latest received uptime will be used (see [(PoS only) Submit and Uptime Proof](#pos-only-submit-an-uptime-proof)). This proof may be requested directly from the L1 validators, which will provide it in a `ValidationUptimeMessage` ICM message. If the uptime is not sufficient to earn validation rewards, the call to `initiateValidatorRemoval` will fail. `forceInitiateValidatorRemoval` acts the same as `initiateValidatorRemoval`, but bypasses the uptime-based rewards check. Once `initiateValidatorRemoval` or `forceInitiateValidatorRemoval` is called, staking rewards cease accruing for `StakingManagers`.
- Unlike with PoA, PoS validators are not able to decrease their weight. This can lead to a scenario in which a PoS validator manager with a high proportion of the L1's weight is not able to exit the validator set due to churn restrictions. Additional validators or delegators will need to first be registered to more evenly distribute weight across the L1's validator set.
Once acknowledgement from the P-Chain has been received via a call to `StakingManager.completeValidatorRemoval`, staking rewards are disbursed and stake is returned.
#### Disable a Validator Directly on the P-Chain
ACP-77 also provides a method to disable a validator without interacting with the L1 directly. The P-Chain transaction [`DisableL1ValidatorTx`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#disablel1validatortx) disables the validator on the P-Chain. The disabled validator's weight will still count towards the L1's total weight.
Disabled L1 validators can re-activate at any time by increasing their balance with an `IncreaseBalanceTx`. Anyone can call `IncreaseBalanceTx` for any validator on the P-Chain. A disabled validator can only be completely and permanently removed from the validator set by a call to `initiateValidatorRemoval`.
### (PoS only) Register a Delegator
`StakingManager` supports delegation to an actively staked validator as a way for users to earn staking rewards without having to validate the chain. Delegators pay a configurable percentage fee on any earned staking rewards to the host validator. A delegator may be registered by calling `initiateDelegatorRegistration` and providing an amount to stake. The delegator will be registered as long as churn restrictions are not violated. The delegator is reflected on the P-Chain by adjusting the validator's registered weight via a [`SetL1ValidatorWeightTx`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#setl1validatorweighttx). The weight change acknowledgement is delivered to the `StakingManager` via an [`L1ValidatorWeightMessage`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#l1validatorweightmessage), which is provided by calling `completeDelegatorRegistration`.
> [!NOTE]
> The P-Chain is only willing to sign an `L1ValidatorWeightMessage` for a validator in the L1's validator set. Once a validator exit has been initiated (via a call to `initiateValidatorRemoval`), the `StakingManager` must assume that the validator has been removed from the L1's validator set on the P-Chain, and therefore that the P-Chain will not sign any further weight updates. The contracts prohibit _initiating_ adding or removing a delegator in between calls to `initiateValidatorRemoval` and `completeValidatorRemoval`. However, if the `L1ValidatorWeightMessage` pertaining to an already initiated delegator action is constructed _before_ the validator is removed on the P-Chain, then the delegator action may be completed. Otherwise, `completeValidatorRemoval` must be called before completing the delegator action.
### (PoS only) Remove a Delegator
Delegator removal may be initiated by calling `initiateDelegatorRemoval`, as long as churn restrictions are not violated. Similar to `initiateValidatorRemoval`, an uptime proof may be provided to be used to determine delegator rewards eligibility. If no proof is provided, the latest known uptime will be used (see [(PoS only) Submit and Uptime Proof](#pos-only-submit-an-uptime-proof)). The validator's weight is updated on the P-Chain by the same mechanism used to register a delegator. The `L1ValidatorWeightMessage` from the P-Chain is delivered to the `StakingManager` in the call to `completeDelegatorRemoval`.
Either the delegator owner or the validator owner may initiate removing a delegator. This is to prevent the validator from being unable to remove itself due to churn limitations if it is has too high a proportion of the Subnet's total weight due to delegator additions. The validator owner may only remove Delegators after the minimum stake duration has elapsed.
### (PoS only) Submit an Uptime Proof
The [rewards calculator](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/interfaces/IRewardCalculator.sol) is a function of uptime seconds since the validator's start time. In addition to doing so in the calls to `initiateValidatorRemoval` and `initiateDelegatorRemoval` as described above, uptime proofs may also be supplied by calling `submitUptimeProof`. Unlike `initiateValidatorRemoval` and `initiateDelegatorRemoval`, `submitUptimeProof` may be called by anyone, decreasing the likelihood of a validation or delegation not being able to claim rewards that it deserved based on its actual uptime.
### (PoS only) Collect Staking Rewards
#### Validation Rewards
Validation rewards are distributed in the call to `completeValidatorRemoval` on the `StakingManager`.
#### Delegation Rewards
Delegation rewards are distributed in the call to `completeDelegatorRemoval` on the `StakingManager`.
#### Delegation Fees
Delegation fees owed to validators are _not_ distributed when the validation ends as to bound the amount of gas consumed in the call to `completeValidatorRemoval`. Instead, `claimDelegationFees` on the `StakingManager` may be called after the validation is completed.
# Consensus Protocols (/docs/nodes/architecture/consensus)
---
title: Consensus Protocols
description: Deep dive into Avalanche's Snow* family of consensus protocols including Snowball, Snowman, and Avalanche consensus.
---
Avalanche uses a novel family of consensus protocols collectively known as the **Snow* protocols**. These protocols achieve consensus through repeated random sampling, providing probabilistic safety guarantees with sub-second finality.
## Consensus Overview
Traditional consensus protocols (like PBFT) require all-to-all communication, limiting scalability. Avalanche's approach is fundamentally different:
| Property | Traditional (PBFT) | Avalanche Snow* |
|----------|-------------------|-----------------|
| **Communication** | All-to-all (O(n²)) | Random sampling (O(k log n)) |
| **Finality** | Deterministic | Probabilistic (tunable) |
| **Scalability** | ~100 nodes | Thousands of nodes |
| **Latency** | Seconds | Sub-second |
The Snow* protocols are named after their "snowball" effect - once a preference starts forming, it quickly avalanches to a decision.
## The Snow* Protocol Family
### Snowball: Binary Consensus
Snowball is the foundational protocol for deciding between two conflicting options:
>S1: Query preference?
V->>S2: Query preference?
V->>S3: Query preference?
S1-->>V: A
S2-->>V: A
S3-->>V: B
Note over V: Supermajority 2/3 for A
Note over V: Increment confidence for A
loop Until confidence threshold
V->>S1: Query preference?
Note over V: Continue sampling
end
Note over V: Decision Accept A
`} />
**Key Parameters:**
- **k (sample size)**: Number of validators to query (default `20`)
- **αₚ (preference threshold)**: Votes needed to switch preference (default `15`)
- **α꜀ (confidence threshold)**: Votes needed to increase confidence (default `15`)
- **β (finalization threshold)**: Consecutive successful rounds (default `20`)
- **Concurrent polls**: Parallel polls while processing (default `4`)
- **Optimal processing**: Soft cap on in-flight items (default `10`)
### Snowman: Linear Chain Consensus
Snowman extends Snowball to decide on a linear sequence of blocks. It's used by:
- **P-Chain** (Platform Chain)
- **C-Chain** (Contract Chain)
- **X-Chain** (Exchange Chain) - linearized in the Cortina upgrade (April 2023)
- **Most Avalanche L1s**
[View source on GitHub](https://github.com/ava-labs/avalanchego/blob/master/snow/consensus/snowman/consensus.go)
```go title="snow/consensus/snowman/consensus.go"
type Consensus interface {
// Initialize with last accepted block
Initialize(
ctx *snow.ConsensusContext,
params snowball.Parameters,
lastAcceptedID ids.ID,
lastAcceptedHeight uint64,
lastAcceptedTime time.Time,
) error
// Tracking & liveness
NumProcessing() int
Processing(ids.ID) bool
IsPreferred(ids.ID) bool
// Add a new block to consensus
Add(Block) error
// Get the preferred blocks
Preference() ids.ID
PreferenceAtHeight(height uint64) (ids.ID, bool)
// Get the last accepted block
LastAccepted() (ids.ID, uint64)
// Record poll results from network sampling
RecordPoll(context.Context, bag.Bag[ids.ID]) error
// Lightweight ancestry lookup
GetParent(id ids.ID) (ids.ID, bool)
}
```
**Block Lifecycle in Snowman:**
Processing: ParseBlock
Processing --> Processing: Verify
Processing --> Accepted: Accept
Processing --> Rejected: Reject
Accepted --> [*]
Rejected --> [*]
`} />
### Avalanche DAG Consensus (Historical)
The Avalanche DAG consensus engine is **no longer used on the Primary Network**. The X-Chain was linearized in the **Cortina upgrade** (April 2023 on Mainnet) and now uses Snowman consensus. The DAG engine code remains in the codebase for historical compatibility only.
Historically, Avalanche consensus operated on a Directed Acyclic Graph (DAG) of transactions, where non-conflicting transactions could be processed in parallel:
```
┌───┐
│ G │ Genesis
└─┬─┘
┌──┴──┐
┌─┴─┐ ┌─┴─┐
│ A │ │ B │ Vertices could have
└─┬─┘ └─┬─┘ multiple parents
│ ╲╱ │
│ ╱╲ │
┌─┴─┐ ┌─┴─┐
│ C │ │ D │
└───┘ └───┘
```
The linearization was implemented via the `LinearizableVMWithEngine` interface, which allows a DAG-based VM to transition to linear block production after a designated "stop vertex."
## Consensus Engine Architecture
The consensus engine sits between the VM and the network:
E
E <--> S
S <--> Network
B --> E
`} />
### Engine States
The consensus engine progresses through several states ([`snow/state.go`](https://github.com/ava-labs/avalanchego/blob/master/snow/state.go)):
```go
type State uint8
const (
Initializing State = iota // 0
StateSyncing // 1
Bootstrapping // 2
NormalOp // 3
)
```
| State | Description |
|-------|-------------|
| **Initializing** | Initial setup before sync begins |
| **StateSyncing** | Fast catch-up using state summaries |
| **Bootstrapping** | Catching up with network state via block replay |
| **NormalOp** | Participating in consensus |
### The Snowman Engine
[View source on GitHub](https://github.com/ava-labs/avalanchego/blob/master/snow/engine/snowman/engine.go)
```go title="snow/engine/snowman/engine.go"
type Engine struct {
Config
// Consensus instance
Consensus smcon.Consensus
// VM interface
VM block.ChainVM
// Network communication
Sender common.Sender
// Block management
pending map[ids.ID]snowman.Block
blocked map[ids.ID][]snowman.Block
}
```
**Engine Responsibilities:**
1. **Block fetching**: Request missing blocks from peers
2. **Block verification**: Validate blocks via the VM
3. **Consensus voting**: Query peers and record votes
4. **Block finalization**: Accept or reject blocks based on consensus
## Block Processing Flow
### 1. Receiving a Block
```go
func (e *Engine) Put(ctx context.Context, nodeID ids.NodeID, requestID uint32, blkBytes []byte) error {
// Parse the block
blk, err := e.VM.ParseBlock(ctx, blkBytes)
// Verify ancestry exists
if !e.hasAncestry(blk) {
// Request missing ancestors
e.requestAncestors(blk.Parent())
return nil
}
// Issue to consensus
return e.issue(ctx, blk)
}
```
### 2. Issuing to Consensus
```go
func (e *Engine) issue(ctx context.Context, blk snowman.Block) error {
// Verify the block
if err := blk.Verify(ctx); err != nil {
return err
}
// Add to consensus
if err := e.Consensus.Add(blk); err != nil {
return err
}
// Start voting
e.sendQuery(ctx, blk.ID())
return nil
}
```
### 3. Recording Votes
```go
func (e *Engine) Chits(ctx context.Context, nodeID ids.NodeID, requestID uint32, preferredID ids.ID, ...) error {
// Collect votes in a bag
votes := bag.Of(preferredID)
// When enough votes collected, record the poll
if e.polls.Finished() {
return e.Consensus.RecordPoll(ctx, e.polls.Result())
}
return nil
}
```
## Snowman++ (ProposerVM)
Snowman++ adds **soft proposer windows** on top of Snowman to pace block production. It is implemented by wrapping a ChainVM in the [ProposerVM](https://github.com/ava-labs/avalanchego/tree/master/vms/proposervm) and is enabled on the P-Chain and C-Chain.
```go title="vms/proposervm/vm.go"
// ProposerVM wraps a ChainVM to add proposer selection
type VM struct {
inner block.ChainVM
// Proposer selection
windower Windower
}
```
**How it works:**
1. Validators are sampled (by stake) to form a proposer list for the next block.
2. Each proposer gets a 5s window; up to 6 windows are scheduled from the parent timestamp.
3. Within their window, only the designated proposer can build a valid block.
4. After the final window, any validator may propose, which preserves liveness if proposers are offline.
**Benefits:**
- **Predictable pacing**: Prevents multiple validators from racing the same height.
- **Stake-weighted fairness**: Windows are derived from the subnet validator set.
- **Graceful fallback**: Production opens to everyone after the final window.
## Consensus Parameters
Consensus parameters live in [`snow/consensus/snowball/parameters.go`](https://github.com/ava-labs/avalanchego/blob/master/snow/consensus/snowball/parameters.go):
```go
type Parameters struct {
// Sample size for each poll
K int `json:"k"`
// Switch preference threshold
AlphaPreference int `json:"alphaPreference"`
// Increase confidence threshold
AlphaConfidence int `json:"alphaConfidence"`
// Finalization threshold
Beta int `json:"beta"`
// Concurrent polls
ConcurrentRepolls int `json:"concurrentRepolls"`
// Congestion control
OptimalProcessing int `json:"optimalProcessing"`
MaxOutstandingItems int `json:"maxOutstandingItems"`
MaxItemProcessingTime time.Duration `json:"maxItemProcessingTime"`
}
```
| Parameter | Default | Description |
|-----------|---------|-------------|
| **K** | 20 | Validators sampled per round |
| **AlphaPreference** | 15 | Votes needed to change preference |
| **AlphaConfidence** | 15 | Votes needed to increase confidence |
| **Beta** | 20 | Consecutive successful polls to finalize |
| **ConcurrentRepolls** | 4 | Parallel polls while processing |
| **OptimalProcessing** | 10 | Soft target for in-flight vertices/blocks |
| **MaxOutstandingItems** | 256 | Health threshold for queued items |
| **MaxItemProcessingTime** | 30s | Health threshold for a single item |
These parameters are network-wide and cannot be changed for individual nodes. Modifying them would cause consensus failures.
## Security Properties
### Probabilistic Safety
The probability of a safety violation (accepting conflicting blocks) is:
$$P(\text{safety violation}) < \left(1 - \frac{\alpha_{confidence}}{k}\right)^\beta$$
With default parameters: $P < \left(1 - \frac{15}{20}\right)^{20} \approx 10^{-12}$
### Liveness
Avalanche guarantees liveness as long as:
- More than `α/k` (75%) of stake is honest
- Network is eventually synchronous
## Next Steps
Learn how VMs implement block building and verification
Understand how consensus messages are transmitted
# Core Components (/docs/nodes/architecture/core-components)
---
title: Core Components
description: Deep dive into AvalancheGo's package structure, startup flow, and how components interact.
---
This page provides a detailed overview of AvalancheGo's internal architecture, including the main packages, startup sequence, and how components communicate.
## Package Structure
AvalancheGo is organized into well-defined packages, each responsible for specific functionality (top-level folders only):
```
avalanchego/
├── main/ # CLI entry point
├── app/ # Process lifecycle (signals, shutdown)
├── config/ # Flags/env/config parsing
├── node/ # Node wiring and initialization
├── chains/ # Chain manager and handlers
├── snow/ # Consensus protocols and engines
├── vms/ # Built-in VMs, proposerVM, rpcchainvm
├── network/ # P2P stack
├── message/ # Message codecs
├── database/ # LevelDB/Pebble/memdb backends
├── graft/ # Grafted Coreth (C-Chain EVM)
├── subnets/ # Subnet configs and validator utilities
├── staking/ # TLS/BLS staking keys and POP
├── upgrade/ # Network upgrade rules
├── trace/ # OpenTelemetry tracing helpers
├── utils/ # Common utilities
└── genesis/ # Genesis configuration and samples
```
## Startup Flow
When you run AvalancheGo, the following initialization sequence occurs:
>Config: Parse flags & config
Config-->>Main: NodeConfig
Main->>App: New(nodeConfig)
App->>Node: Initialize components
Node->>Node: Init database
Node->>Node: Init networking
Node->>Node: Init API server
Node->>Node: Register VMs
Node->>Node: Start chain manager
Main->>App: Run()
App->>Node: Dispatch (event loop)
`} />
### 1. Configuration Parsing
[View source on GitHub](https://github.com/ava-labs/avalanchego/blob/master/main/main.go)
```go title="main/main.go"
func main() {
evm.RegisterAllLibEVMExtras()
// Build configuration from flags/env/config file
fs := config.BuildFlagSet()
v, err := config.BuildViper(fs, os.Args[1:])
if errors.Is(err, pflag.ErrHelp) {
os.Exit(0)
}
if v.GetBool(config.VersionJSONKey) && v.GetBool(config.VersionKey) {
fmt.Println("can't print both JSON and human readable versions")
os.Exit(1)
}
if v.GetBool(config.VersionJSONKey) {
versions := version.GetVersions()
jsonBytes, err := json.MarshalIndent(versions, "", " ")
if err != nil {
fmt.Printf("couldn't marshal versions: %s\n", err)
os.Exit(1)
}
fmt.Println(string(jsonBytes))
os.Exit(0)
}
if v.GetBool(config.VersionKey) {
fmt.Println(version.GetVersions().String())
os.Exit(0)
}
nodeConfig, err := config.GetNodeConfig(v)
if term.IsTerminal(int(os.Stdout.Fd())) {
fmt.Println(app.Header)
}
nodeApp, err := app.New(nodeConfig)
exitCode := app.Run(nodeApp)
os.Exit(exitCode)
}
```
The configuration system supports:
- **Command-line flags**: `--network-id=fuji`, `--http-port=9650`
- **Config file**: Pass `--config-file=/path/to/file`. The installer writes `~/.avalanchego/configs/node.json`; source builds do not create a default file.
- **Environment variables**: Prefixed with `AVAGO_`
### 2. Node Initialization
The `Node` struct in [`node/node.go`](https://github.com/ava-labs/avalanchego/blob/master/node/node.go) orchestrates all components:
```go title="node/node.go"
type Node struct {
Log logging.Logger
ID ids.NodeID
Config *node.Config
// Networking & routing
Net network.Network
chainRouter router.Router
msgCreator message.Creator
// Storage & shared state
DB database.Database
sharedMemory *atomic.Memory
// VM/chain orchestration
VMAliaser ids.Aliaser
VMManager vms.Manager
VMRegistry registry.VMRegistry
chainManager chains.Manager
// APIs and services
APIServer server.Server
health health.Health
resourceManager resource.Manager
}
```
### 3. Component Initialization Order
Components are initialized in a specific order to satisfy dependencies:
| Order | Component | Purpose |
|-------|-----------|---------|
| 1 | **Identity & logging** | Staking certs/POP, VM aliases, log factories |
| 2 | **Metrics** | Prometheus registries + `/ext/metrics` |
| 3 | **APIs** | HTTP server + metrics API (health/info/admin added later) |
| 4 | **Database & shared memory** | Open LevelDB/PebbleDB/memdb and atomic memory |
| 5 | **Message codec** | `message.Creator` shared by network/engines |
| 6 | **Validators & resources** | Validator manager, CPU/disk targeters, resource manager |
| 7 | **Networking** | Listener, NAT/port mapping, throttlers, IP updater |
| 8 | **Health & aliases** | Health API, default VM/API/chain aliases |
| 9 | **Chain manager & VM registry** | Chain manager, register PlatformVM/AVM/EVM + plugins |
| 10 | **Indexer & profiler** | Optional index API and continuous profiler |
| 11 | **Chains** | Start PlatformVM, then other chains/bootstrap |
## The Node Struct
The `Node` struct is the central coordinator. Here are its key responsibilities:
### VM Management
```go
// Register built-in VMs
n.VMManager.RegisterFactory(ctx, constants.PlatformVMID, &platformvm.Factory{})
n.VMManager.RegisterFactory(ctx, constants.AVMID, &avm.Factory{})
n.VMManager.RegisterFactory(ctx, constants.EVMID, &coreth.Factory{})
```
### Chain Creation
When a new chain needs to be created (e.g., during P-Chain bootstrap):
```go
type ChainParameters struct {
ID ids.ID // Chain ID
SubnetID ids.ID // Subnet that validates this chain
GenesisData []byte // Genesis state
VMID ids.ID // Which VM to run
FxIDs []ids.ID // Feature extensions
CustomBeacons validators.Manager // Optional: bootstrap peers for P-Chain
}
```
### API Registration
Each VM can register its own API endpoints:
```go
// VM implements CreateHandlers
func (vm *VM) CreateHandlers(ctx context.Context) (map[string]http.Handler, error) {
return map[string]http.Handler{
"/rpc": vm.rpcHandler,
"/ws": vm.wsHandler,
}, nil
}
```
## Chain Manager
The Chain Manager ([`chains/manager.go`](https://github.com/ava-labs/avalanchego/blob/master/chains/manager.go)) is responsible for:
1. **Creating chains** when requested by the P-Chain
2. **Managing chain lifecycle** (start, stop, restart)
3. **Handling bootstrapping** and state sync
4. **Routing messages** between chains and the network
```go title="chains/manager.go"
type Manager interface {
// Queue a chain to be created after P-Chain bootstraps
QueueChainCreation(ChainParameters)
// Check if a chain has finished bootstrapping
IsBootstrapped(ids.ID) bool
// Resolve chain aliases
Lookup(string) (ids.ID, error)
// Start the chain creation process
StartChainCreator(platformChain ChainParameters) error
}
```
### Chain Bootstrapping
When a chain starts, it progresses through several states to catch up with the network:
Initializing
Initializing --> StateSyncing: State sync enabled
Initializing --> Bootstrapping: State sync disabled
StateSyncing --> Bootstrapping: State summaries applied
Bootstrapping --> NormalOp: Bootstrap complete
NormalOp --> [*]
`} />
## Database Layer
AvalancheGo supports multiple database backends:
### Database Backends
| Backend | Description |
|---------|-------------|
| **LevelDB** | Default, widely tested |
| **PebbleDB** | Modern alternative, better performance |
| **memdb** | In-memory (non-persistent), useful for fast testing |
### Database Organization
Data is organized using prefix databases:
```go
// Each component gets its own namespace
vmDB := prefixdb.New(VMDBPrefix, db)
chainDB := prefixdb.New(chainID[:], vmDB)
```
This allows:
- **Isolation**: Each VM and chain has isolated storage
- **Metrics**: Per-database metrics via `meterdb`
- **Cleanup**: Easy removal of chain data
## Message Flow
Here's how a transaction flows through the system:
>API: Submit transaction
API->>VM: IssueTx(tx)
VM->>VM: Validate tx
VM->>Engine: Notify pending txs
Engine->>VM: BuildBlock()
VM-->>Engine: New block
Engine->>Network: Broadcast block
Network->>Engine: Receive votes
Engine->>VM: Accept/Reject block
VM-->>API: Confirmation
API-->>Client: Response
`} />
## Health Checks
AvalancheGo exposes health checks at `/ext/health`:
```go
type Checker interface {
// HealthCheck returns nil if healthy
HealthCheck(context.Context) (interface{}, error)
}
```
Components that implement health checks:
- **Network**: Peer connectivity
- **Chains**: Bootstrap status
- **Database**: I/O health
- **Consensus**: Liveness
## Metrics
Prometheus metrics are exposed at `/ext/metrics`:
```go
// Example metrics namespaces
const (
networkNamespace = "avalanche_network"
dbNamespace = "avalanche_db"
consensusNS = "avalanche_snowman"
)
```
Key metrics include:
- `avalanche_network_peers`: Connected peer count
- `avalanche_db_*`: Database operations
- `avalanche_snowman_*`: Consensus metrics
- `avalanche_api_*`: API request metrics
## Next Steps
Learn how Snowman and Avalanche consensus work
Understand VM architecture and interfaces
# AvalancheGo Architecture (/docs/nodes/architecture)
---
title: AvalancheGo Architecture
description: Understand the internal architecture and components of AvalancheGo, the official Avalanche node implementation.
---
AvalancheGo is the official Go implementation of an Avalanche node. It powers the Primary Network (P/C/X) and any Avalanche L1s you launch, delivering high throughput and sub-second probabilistic finality.
**Source Code**: [github.com/ava-labs/avalanchego](https://github.com/ava-labs/avalanchego)
## What is AvalancheGo?
AvalancheGo is a full-node implementation that:
- **Validates transactions** across the Primary Network (P-Chain, C-Chain, X-Chain)
- **Participates in consensus** using Avalanche's Snow* family of protocols
- **Serves API requests** for wallets, dApps, and other clients
- **Supports Avalanche L1s** (blockchains validated by Subnets) for custom networks
AvalancheGo is written in Go and is designed to be modular, allowing developers to build custom Virtual Machines (VMs) that define their own blockchain logic.
## Execution at a glance
- **Networking**: Custom P2P stack with mutual TLS (staking certs), throttling, peer scoring, and subnet-aware gossip.
- **Consensus engines**: Snowman/Snowman++ for all Primary Network chains (P/C/X post-Cortina). The legacy Avalanche DAG engine exists but is unused.
- **VMs**: PlatformVM (P-Chain), Coreth (C-Chain), AVM (X-Chain), plus pluggable/`rpcchainvm` VMs for custom L1s.
- **Chain manager**: Boots P/C/X, creates new chains on request, routes consensus messages.
- **APIs**: HTTP/WS via `/ext/*`, with health/metrics, admin/info, and per-chain RPCs.
- **Storage**: LevelDB (default) or PebbleDB, shared atomic UTXO memory for cross-chain transfers, optional indexer.
## Core Components
| Component | Description |
|-----------|-------------|
| **Network Layer** | P2P networking for peer discovery, message routing, and validator communication |
| **Chain Manager** | Orchestrates blockchain lifecycle, bootstrapping, and state synchronization |
| **Consensus Engines** | Snowman/Snowman++ for all Primary Network chains and most L1s |
| **Virtual Machines** | PlatformVM, Coreth, AVM, and custom VMs (native Go or `rpcchainvm`) |
| **API Server** | HTTP/HTTPS endpoints for interacting with the node |
| **Database** | Persistent storage using LevelDB (default) or PebbleDB; shared atomic memory |
## Primary Network Chains
AvalancheGo validates three chains on the Primary Network:
Manages validators, staking, subnets, and chain creation. Uses PlatformVM (Snowman++).
EVM-compatible chain for smart contracts. Uses Coreth (grafted go-ethereum) with Snowman++.
High-throughput asset transfers using UTXO model. Uses AVM with Snowman (linearized in Cortina).
## Key Design Principles
### Modularity
AvalancheGo separates concerns into distinct layers:
- **Consensus** is decoupled from application logic
- **VMs** are pluggable and can be developed independently
- **Networking** is abstracted from chain-specific operations
### Extensibility
- Custom VMs can be loaded as plugins (native) or via `rpcchainvm` (any language)
- Avalanche L1s can run any VM that implements the required interface
- Chain configurations and upgrades can be customized per-network/chain
### Performance
- Sub-second finality through probabilistic consensus
- Parallel transaction processing across independent chains
- State sync and Snowman++ proposer windows to reduce contention and bootstrap faster
## Next Steps
Deep dive into AvalancheGo's package structure and component interactions
Learn how Snowman and Avalanche consensus work under the hood
Understand how VMs define blockchain behavior and how to build custom VMs
Explore the P2P protocol and peer management system
# Networking Layer (/docs/nodes/architecture/networking)
---
title: Networking Layer
description: Understanding AvalancheGo's P2P networking, peer management, and message protocols.
---
AvalancheGo uses a custom peer-to-peer (P2P) networking layer designed for high-throughput consensus messaging. This page covers the network architecture, peer management, and message protocols.
## Network Overview
PM
PM <--> NM
NM <--> Router
Router --> PC & CC & XC
`} />
## Network Interface
The core network interface ([`network/network.go`](https://github.com/ava-labs/avalanchego/blob/master/network/network.go)) handles all P2P operations:
```go title="network/network.go"
type Network interface {
// Message sending (from consensus)
sender.ExternalSender
// Health monitoring
health.Checker
// Peer management
peer.Network
// Lifecycle
StartClose()
Dispatch() error
// Manual peer tracking
ManuallyTrack(nodeID ids.NodeID, ip netip.AddrPort)
// Peer information
PeerInfo(nodeIDs []ids.NodeID) []peer.Info
// Uptime tracking
NodeUptime() (UptimeResult, error)
}
```
## Peer Discovery
AvalancheGo discovers peers through multiple mechanisms:
### Bootstrap Nodes
Initial connections to known bootstrap nodes are configured per-network (sampled from genesis) and can be overridden with `--bootstrap-ips`/`--bootstrap-ids`. See `config/config.go:getBootstrapConfig`.
### Peer Exchange
Nodes share known peers with each other:
>B: Connect
A->>B: PeerList request
B-->>A: Node C, Node D, ...
A->>C: Connect discovered
`} />
### IP Tracking
The network maintains IP information for reconnection:
```go title="network/ip_tracker.go"
type ipTracker struct {
// Known peer IPs
mostRecentTrackedIPs map[ids.NodeID]*ips.ClaimedIPPort
// Bloom filter for efficient gossip
bloom *bloom.ReadFilter
}
```
## Connection Lifecycle
### Establishing Connections
>B: TCP Connect
A->>B: Mutual TLS with staking cert
A->>B: Handshake (network ID, POP, subnets)
B-->>A: Handshake + PeerList
A-->>B: PeerList (optional pull)
Note over A,B: Connection Established
`} />
### TLS Authentication
All connections use mutual TLS with staking certificates:
```go
// Each node has a staking keypair
type Node struct {
StakingTLSSigner crypto.Signer
StakingTLSCert *staking.Certificate
ID ids.NodeID // Derived from certificate
}
```
**Node ID Derivation:**
```go
// NodeID is derived from the staking certificate
nodeID := ids.NodeIDFromCert(stakingCert)
```
### Peer States
Connecting: Dial
Connecting --> Upgrading: TCP Connected
Upgrading --> Handshaking: TLS Complete
Handshaking --> Connected: Handshake + PeerList
Connected --> Disconnected: Error or Timeout
Disconnected --> Connecting: Reconnect
Disconnected --> [*]: Manual Remove
`} />
## Message Protocol
### Message Types
Messages are defined using Protocol Buffers ([`proto/p2p/p2p.proto`](https://github.com/ava-labs/avalanchego/blob/master/proto/p2p/p2p.proto)):
```protobuf title="proto/p2p/p2p.proto"
message Message {
reserved 1;
oneof message {
// Optional compression for supported message types
bytes compressed_zstd = 2;
// Handshake & peering
Ping ping = 11;
Pong pong = 12;
Handshake handshake = 13;
GetPeerList get_peer_list = 35;
PeerList peer_list = 14;
// State sync
GetStateSummaryFrontier get_state_summary_frontier = 15;
StateSummaryFrontier state_summary_frontier = 16;
GetAcceptedStateSummary get_accepted_state_summary = 17;
AcceptedStateSummary accepted_state_summary = 18;
// Bootstrapping
GetAcceptedFrontier get_accepted_frontier = 19;
AcceptedFrontier accepted_frontier = 20;
GetAccepted get_accepted = 21;
Accepted accepted = 22;
GetAncestors get_ancestors = 23;
Ancestors ancestors = 24;
// Consensus
Get get = 25;
Put put = 26;
PushQuery push_query = 27;
PullQuery pull_query = 28;
Chits chits = 29;
// Application-level
AppRequest app_request = 30;
AppResponse app_response = 31;
AppGossip app_gossip = 32;
AppError app_error = 34;
// Streaming
Simplex simplex = 36;
}
}
```
### Consensus Messages
| Message | Purpose |
|---------|---------|
| `PushQuery` | Send block and request vote |
| `PullQuery` | Request vote without sending block |
| `Chits` | Vote response with preferences |
| `Get` | Request a specific block |
| `Put` | Send a requested block |
| `GetAcceptedFrontier` / `AcceptedFrontier` | Bootstrap frontier exchange |
| `GetAccepted` / `Accepted` | Request/return accepted containers for heights |
| `GetAncestors` / `Ancestors` | Fetch a container and its ancestors |
| `GetStateSummaryFrontier` / `StateSummaryFrontier` | State sync frontier |
| `GetAcceptedStateSummary` / `AcceptedStateSummary` | State summaries at heights |
### Application Messages
VMs send custom messages through the `common.AppSender` provided at initialization:
```go
type AppSender interface {
SendAppRequest(ctx context.Context, nodeIDs set.Set[ids.NodeID],
requestID uint32, appRequestBytes []byte) error
SendAppResponse(ctx context.Context, nodeID ids.NodeID,
requestID uint32, appResponseBytes []byte) error
SendAppError(ctx context.Context, nodeID ids.NodeID,
requestID uint32, errorCode int32, errorMessage string) error
SendAppGossip(ctx context.Context, config common.SendConfig,
appGossipBytes []byte) error
}
```
Inbound app traffic is delivered to the VM's `AppRequest`/`AppResponse`/`AppGossip` handlers via `common.AppHandler`.
## Message Routing
The router ([`snow/networking/router`](https://github.com/ava-labs/avalanchego/tree/master/snow/networking/router)) directs messages to appropriate handlers:
```go title="snow/networking/router/router.go"
type Router interface {
// Route messages to chains
HandleInbound(ctx context.Context, msg message.InboundMessage)
// Register chain handlers
AddChain(ctx context.Context, chain handler.Handler) error
// Health checking
health.Checker
}
```
### Chain Message Handler
```go title="snow/networking/handler/handler.go"
type Handler interface {
// Consensus messages
HandleMsg(ctx context.Context, msg Message) error
// Lifecycle
Start(ctx context.Context, recoverPanic bool)
Stop(ctx context.Context)
}
```
## Throttling & Rate Limiting
### Inbound Throttling
Protects nodes from message floods ([`network/throttling`](https://github.com/ava-labs/avalanchego/tree/master/network/throttling)):
```go title="network/throttling/inbound_msg_throttler.go"
type InboundMsgThrottler interface {
// Check if message should be allowed
Acquire(msg message.InboundMessage, nodeID ids.NodeID) ReleaseFunc
// Release acquired resources
ReleaseFunc func()
}
```
**Throttling Dimensions:**
- **Bandwidth**: Bytes per second per peer
- **Message count**: Messages per second
- **CPU time**: Processing time limits
### Outbound Throttling
Prevents overwhelming peers:
```go title="network/throttling/outbound_msg_throttler.go"
type OutboundMsgThrottler interface {
// Acquire permission to send
Acquire(msg message.OutboundMessage, nodeID ids.NodeID) ReleaseFunc
}
```
### Connection Throttling
Limits connection attempts:
```go
type InboundConnUpgradeThrottler interface {
// Check if connection upgrade should proceed
ShouldUpgrade(ip netip.AddrPort) bool
}
```
## Peer Scoring
Nodes track peer behavior for connection prioritization:
```go
type PeerInfo struct {
IP netip.AddrPort
PublicIP netip.AddrPort
ID ids.NodeID
Version string
LastSent time.Time
LastReceived time.Time
ObservedUptime uint32
TrackedSubnets []ids.ID
}
```
### Benchlisting
Misbehaving peers are temporarily blacklisted ([`snow/networking/benchlist`](https://github.com/ava-labs/avalanchego/tree/master/snow/networking/benchlist)):
```go title="snow/networking/benchlist/benchlist.go"
type Benchlist interface {
// Add peer to benchlist
RegisterFailure(validatorID ids.NodeID)
// Check if peer is benched
IsBenched(validatorID ids.NodeID) bool
}
```
**Benchlist Triggers:**
- Repeated query timeouts
- Invalid message responses
- Resource exhaustion
## Health Monitoring
Network health is exposed via the health API:
```go
type UptimeResult struct {
// Percent of stake that sees us as meeting uptime requirement
RewardingStakePercentage float64
// Weighted average of observed uptimes
WeightedAveragePercentage float64
}
```
### Health Metrics
```go
const (
ConnectedPeersKey = "connectedPeers"
TimeSinceLastMsgReceivedKey = "timeSinceLastMsgReceived"
TimeSinceLastMsgSentKey = "timeSinceLastMsgSent"
SendFailRateKey = "sendFailRate"
)
```
**Example Health Response:**
```json
{
"healthy": true,
"checks": {
"network": {
"message": {
"connectedPeers": 45,
"timeSinceLastMsgReceived": "1.2s",
"timeSinceLastMsgSent": "0.8s",
"sendFailRate": 0.001
}
}
}
}
```
## Network Configuration
Key configuration options:
```go title="config/config.go"
type NetworkConfig struct {
// Connection limits
MaxInboundConnections int
MaxOutboundConnections int
// Timeouts
PingFrequency time.Duration
PongTimeout time.Duration
ReadHandshake time.Duration
// Throttling
InboundThrottlerAtLargeAllocSize uint64
InboundThrottlerVdrAllocSize uint64
OutboundThrottlerAtLargeAllocSize uint64
// Peer management
PeerListGossipFrequency time.Duration
PeerListPullGossipFreq time.Duration
}
```
### Command Line Flags
```bash
# Connection settings
--network-max-reconnect-delay=1m
--network-initial-reconnect-delay=1s
--network-peer-list-gossip-frequency=1m
# Throttling
--network-inbound-throttler-at-large-alloc-size=6291456
--network-outbound-throttler-at-large-alloc-size=6291456
```
## Subnet Networking
Validators can participate in multiple subnets:
```go
type SubnetTracker interface {
// Track additional subnet
TrackedSubnets() set.Set[ids.ID]
}
```
**Subnet-Specific Peers:**
- Handshake carries tracked subnet IDs (and `all_subnets` flag)
- Nodes connect preferentially to same-subnet validators
- Gossip is scoped to relevant subnets
- Cross-subnet communication uses explicit routing
## Debugging Network Issues
### Common Issues
| Symptom | Possible Cause | Solution |
|---------|---------------|----------|
| No peers | Firewall blocking 9651 | Open port 9651 |
| High latency | Geographic distance | Add regional bootstrappers |
| Disconnections | Rate limiting | Increase throttle limits |
| Benchmark failures | Peer misbehavior | Check peer logs |
### Useful Endpoints
```bash
# Get connected peers
curl -X POST --data '{
"jsonrpc":"2.0",
"id" :1,
"method" :"info.peers"
}' -H 'content-type:application/json;' localhost:9650/ext/info
# Get network health
curl localhost:9650/ext/health
```
## Next Steps
Set up and configure your own AvalancheGo node
Full reference for network configuration options
# Virtual Machines (/docs/nodes/architecture/virtual-machines)
---
title: Virtual Machines
description: Understand how Virtual Machines (VMs) define blockchain behavior in AvalancheGo, including the VM interface and built-in VMs.
---
A Virtual Machine (VM) defines the application-level logic of a blockchain. In AvalancheGo, VMs are decoupled from consensus, allowing developers to create custom blockchain behavior while reusing the battle-tested consensus layer.
## What is a Virtual Machine?
Think of a VM as the "personality" of a blockchain:
| Aspect | What the VM Defines |
|--------|---------------------|
| **State** | What data the blockchain stores |
| **Transactions** | Valid operations and their effects |
| **Blocks** | How transactions are packaged |
| **APIs** | How users interact with the chain |
| **Validation** | Rules for accepting blocks |
VMs are reusable. Multiple blockchains can run the same VM, each with independent state. This is similar to how a class can have multiple instances in object-oriented programming.
## VM Architecture
|BuildBlock, Verify, Accept| VMI
VMI --> BM
VMI --> TXP
VMI --> API
BM --> ST
ST --> DB
User -->|RPC| API
API -->|Submit TX| TXP
`} />
## Core VM Interface
Every VM must implement the [`ChainVM`](https://github.com/ava-labs/avalanchego/blob/master/snow/engine/snowman/block/vm.go) interface for linear chain consensus:
```go title="snow/engine/snowman/block/vm.go"
type ChainVM interface {
common.VM
// Block building
BuildBlock(ctx context.Context) (snowman.Block, error)
// Block retrieval
GetBlock(ctx context.Context, blkID ids.ID) (snowman.Block, error)
ParseBlock(ctx context.Context, blockBytes []byte) (snowman.Block, error)
// Consensus integration
SetPreference(ctx context.Context, blkID ids.ID) error
LastAccepted(ctx context.Context) (ids.ID, error)
// Optional: height-indexed access
GetBlockIDAtHeight(ctx context.Context, height uint64) (ids.ID, error)
}
```
### Base VM Interface
The foundation interface that all VMs implement ([source](https://github.com/ava-labs/avalanchego/blob/master/snow/engine/common/vm.go)):
```go title="snow/engine/common/vm.go"
type VM interface {
common.AppHandler // AppRequest/AppResponse/AppGossip hooks
health.Checker // Exposed via /ext/health
validators.Connector // Called on peer connect/disconnect
// Lifecycle
Initialize(ctx context.Context, chainCtx *snow.Context,
db database.Database, genesisBytes []byte,
upgradeBytes []byte, configBytes []byte,
fxs []*common.Fx, appSender common.AppSender) error
SetState(ctx context.Context, state snow.State) error
Shutdown(ctx context.Context) error
// Info
Version(ctx context.Context) (string, error)
// APIs
CreateHandlers(ctx context.Context) (map[string]http.Handler, error)
NewHTTPHandler(ctx context.Context) (http.Handler, error)
// Engine notifications (PendingTxs, etc.)
WaitForEvent(ctx context.Context) (common.Message, error)
}
```
## Block Interface
Blocks are the fundamental unit of consensus ([source](https://github.com/ava-labs/avalanchego/blob/master/snow/consensus/snowman/block.go)):
```go title="snow/consensus/snowman/block.go"
type Block interface {
// ID(), Accept(), Reject(), Status() come from snow.Decidable
snow.Decidable
// Identity
Parent() ids.ID
Height() uint64
Timestamp() time.Time
Bytes() []byte
// Validation
Verify(context.Context) error
}
```
### Block Lifecycle
Received: ParseBlock
Received --> Pending: Waiting for ancestors
Pending --> Processing: Ancestors verified
Processing --> Verified: Verify succeeds
Processing --> Invalid: Verify fails
Verified --> Accepted: Accept
Verified --> Rejected: Reject
Invalid --> [*]: Discarded
Accepted --> [*]: Committed to state
Rejected --> [*]: Discarded
`} />
### Block Status
```go
type Status int
const (
Unknown Status = iota
Processing
Rejected
Accepted
)
```
## Built-in Virtual Machines
### Platform VM (P-Chain)
The Platform VM ([`vms/platformvm`](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm)) manages the Avalanche network itself:
```go title="vms/platformvm/vm.go"
type VM struct {
// State management
state state.State
atomicUTXOs atomic.SharedMemory
// Block building
Builder blockbuilder.Builder
Network network.Network
// Validators
Validators validators.Manager
}
```
**Responsibilities:**
- **Validator Management**: Add/remove validators, track stake
- **Subnet Creation**: Create new validator sets
- **Chain Creation**: Launch new blockchains
- **Staking**: Manage delegation and rewards
- **Warp Messaging**: Sign cross-chain messages
**Key Transaction Types:**
| Transaction | Purpose | Era |
|-------------|---------|-----|
| `AddValidatorTx` | Add a Primary Network validator | Apricot |
| `AddDelegatorTx` | Delegate stake to a validator | Apricot |
| `CreateSubnetTx` | Create a new subnet | Apricot |
| `CreateChainTx` | Launch a blockchain on a subnet | Apricot |
| `ImportTx` / `ExportTx` | Cross-chain asset transfers | Apricot |
| `AddPermissionlessValidatorTx` | Add validator to permissionless subnet | Banff |
| `AddPermissionlessDelegatorTx` | Delegate to permissionless validator | Banff |
| `TransformSubnetTx` | Convert subnet to permissionless | Banff |
| `TransferSubnetOwnershipTx` | Transfer subnet ownership | Durango |
| `ConvertSubnetToL1Tx` | Convert subnet to Avalanche L1 | Etna |
| `RegisterL1ValidatorTx` | Register validator on L1 | Etna |
| `SetL1ValidatorWeightTx` | Set L1 validator weight | Etna |
| `IncreaseL1ValidatorBalanceTx` | Add balance to L1 validator | Etna |
| `DisableL1ValidatorTx` | Disable an L1 validator | Etna |
The **Etna upgrade** introduced 5 new transaction types for managing Avalanche L1s. These enable converting subnets to sovereign L1s with their own validator management.
### AVM (X-Chain)
The AVM ([`vms/avm`](https://github.com/ava-labs/avalanchego/tree/master/vms/avm)) handles asset creation and transfers using the UTXO model:
The X-Chain was linearized in the **Cortina upgrade** (April 2023). It now uses Snowman consensus like the P-Chain and C-Chain, rather than the legacy Avalanche DAG consensus. The AVM implements the `LinearizableVMWithEngine` interface to support this transition.
```go title="vms/avm/vm.go"
type VM struct {
// Asset management
fxs []*Fx
state state.State
// UTXO handling
utxoSet atomic.SharedMemory
}
```
**Features:**
- **Multi-Asset Support**: Native AVAX and custom assets
- **UTXO Model**: Bitcoin-style transaction inputs/outputs
- **Snowman Consensus**: Linear chain consensus (linearized from DAG in Cortina upgrade)
- **Feature Extensions (Fxs)**: Pluggable transaction types
- `secp256k1fx`: Standard signatures
- `nftfx`: Non-fungible tokens
- `propertyfx`: Property ownership
**Transaction Types:**
| Transaction | Purpose |
|-------------|---------|
| `CreateAssetTx` | Create a new asset |
| `OperationTx` | Mint/burn assets |
| `BaseTx` | Transfer assets |
| `ImportTx` | Import from other chains |
| `ExportTx` | Export to other chains |
### Coreth (C-Chain)
Coreth is the EVM implementation for the C-Chain:
Coreth is **grafted** into the AvalancheGo repository at `graft/coreth/`. The standalone [`ava-labs/coreth`](https://github.com/ava-labs/coreth) repository has been archived and is now read-only. All active development occurs within the AvalancheGo monorepo.
**Features:**
- Full Ethereum Virtual Machine compatibility
- Supports Solidity smart contracts
- Web3 JSON-RPC API (`eth`, `personal`, `txpool`, `debug` namespaces)
- EIP-1559 dynamic fees
- Atomic transactions with other Avalanche chains (via shared memory)
- Support for Ethereum upgrades through Cancun
### ProposerVM (Snowman++)
The ProposerVM ([`vms/proposervm`](https://github.com/ava-labs/avalanchego/tree/master/vms/proposervm)) wraps other VMs to add Snowman++ proposer windows:
```go title="vms/proposervm/vm.go"
type VM struct {
// Wrapped VM
ChainVM block.ChainVM
// Proposer selection
windower proposer.Windower
// Block timing
MinBlockDelay time.Duration
}
```
**How it Works:**
1. Stake-weighted proposers are sampled for each height.
2. Each proposer has a 5s slot (up to 6 slots) counted from the parent timestamp.
3. Only the active proposer can build during its slot; after the final slot any validator may build.
4. The wrapper enforces proposer signatures/timestamps before issuing to consensus.
Snowman++ is enabled on all Primary Network chains (P-Chain, C-Chain, X-Chain) to pace block production without sacrificing liveness.
## Custom VMs
You can build custom VMs that run on Avalanche L1s. There are two approaches:
### 1. Native Go VM
Implement the `ChainVM` interface directly in Go:
```go
type MyVM struct {
db database.Database
state *MyState
builder *BlockBuilder
pending <-chan struct{}
}
func (vm *MyVM) Initialize(ctx context.Context, ...) error {
// Set up database and state
vm.db = db
vm.state = NewState(db)
vm.pending = vm.builder.Subscribe() // emits when there are pending txs
return nil
}
func (vm *MyVM) WaitForEvent(ctx context.Context) (common.Message, error) {
select {
case <-ctx.Done():
return 0, ctx.Err()
case <-vm.pending:
return common.PendingTxs, nil
}
}
func (vm *MyVM) BuildBlock(ctx context.Context) (snowman.Block, error) {
// Collect pending transactions
txs := vm.builder.GetPendingTxs()
// Create new block
return NewBlock(vm.state.LastAccepted(), txs), nil
}
```
### 2. RPC VM (Any Language)
Use the [`rpcchainvm`](https://github.com/ava-labs/avalanchego/tree/master/vms/rpcchainvm) interface to build VMs in any language:
|gRPC| Server
Server --> Logic
`} />
**Benefits:**
- Write VMs in Rust, TypeScript, etc.
- Process isolation
- Independent deployment
**Protocol:**
```go
// gRPC service definition
service VM {
rpc Initialize(InitializeRequest) returns (InitializeResponse);
rpc BuildBlock(BuildBlockRequest) returns (BuildBlockResponse);
rpc ParseBlock(ParseBlockRequest) returns (ParseBlockResponse);
rpc GetBlock(GetBlockRequest) returns (GetBlockResponse);
// ... more methods
}
```
## VM Registration
VMs are registered with the node at startup:
```go title="node/node.go"
func (n *Node) initVMs() error {
// Built-in VMs
n.VMManager.RegisterFactory(ctx, constants.PlatformVMID,
&platformvm.Factory{})
n.VMManager.RegisterFactory(ctx, constants.AVMID,
&avm.Factory{})
n.VMManager.RegisterFactory(ctx, constants.EVMID,
&coreth.Factory{})
// Plugin VMs are discovered from the plugins directory
// (default: ~/.avalanchego/plugins/)
}
```
**Plugin Discovery:**
1. VMs are placed in `~/.avalanchego/plugins/`
2. Filename is the VM ID (e.g., `srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy`)
3. Node discovers and loads plugins at startup
## VM Configuration
Each chain can have custom VM configuration:
```json title="~/.avalanchego/configs/chains/{chainID}/config.json"
{
"pruning-enabled": true,
"state-sync-enabled": true,
"eth-apis": ["eth", "eth-filter", "net", "web3"]
}
```
**Chain-Specific Configs:**
- Stored in `~/.avalanchego/configs/chains/{chainID}/`
- `config.json`: VM configuration
- `upgrade.json`: Upgrade coordination
## Best Practices
### State Management
```go
// Use versioned database for atomic commits
func (vm *VM) Accept(ctx context.Context, blk *Block) error {
batch := vm.db.NewBatch()
defer batch.Reset()
// Apply state changes
for _, tx := range blk.Txs {
if err := vm.state.Apply(batch, tx); err != nil {
return err
}
}
// Commit atomically
return batch.Write()
}
```
### Block Building
```go
// Drive block production: return PendingTxs when mempool has work
func (vm *VM) WaitForEvent(ctx context.Context) (common.Message, error) {
select {
case <-ctx.Done():
return 0, ctx.Err()
case <-vm.pending:
return common.PendingTxs, nil
}
}
```
### API Design
```go
func (vm *VM) CreateHandlers(ctx context.Context) (map[string]http.Handler, error) {
return map[string]http.Handler{
"/rpc": vm.newJSONRPCHandler(),
"/ws": vm.newWebSocketHandler(),
"/health": vm.newHealthHandler(),
}, nil
}
```
## Next Steps
Learn how VMs communicate over the network
Start building your own Virtual Machine
# Backup and Restore (/docs/nodes/maintain/backup-restore)
---
title: Backup and Restore
---
Once you have your node up and running, it's time to prepare for disaster recovery. Should your machine ever have a catastrophic failure due to either hardware or software issues, or even a case of natural disaster, it's best to be prepared for such a situation by making a backup.
When running, a complete node installation along with the database can grow to be multiple gigabytes in size. Having to back up and restore such a large volume of data can be expensive, complicated and time-consuming. Luckily, there is a better way.
Instead of having to back up and restore everything, we need to back up only what is essential, that is, those files that cannot be reconstructed because they are unique to your node. For AvalancheGo node, unique files are those that identify your node on the network, in other words, files that define your NodeID.
Even if your node is a validator on the network and has multiple delegations on it, you don't need to worry about backing up anything else, because the validation and delegation transactions are also stored on the blockchain and will be restored during bootstrapping, along with the rest of the blockchain data.
The installation itself can be easily recreated by installing the node on a new machine, and all the remaining gigabytes of blockchain data can be easily recreated by the process of bootstrapping, which copies the data over from other network peers. However, if you would like to speed up the process, see the [Database Backup and Restore section](#database)
NodeID[](#nodeid "Direct link to heading")
-------------------------------------------
If more than one running nodes share the same NodeID, the communications from other nodes in the Avalanche network to this NodeID will be random to one of these nodes. If this NodeID is of a validator, it will dramatically impact the uptime calculation of the validator which will very likely disqualify the validator from receiving the staking rewards. Please make sure only one node with the same NodeID run at one time.
NodeID is a unique identifier that differentiates your node from all the other peers on the network. It's a string formatted like `NodeID-5mb46qkSBj81k9g9e4VFjGGSbaaSLFRzD`. You can look up the technical background of how the NodeID is constructed [here](/docs/rpcs/other/standards/cryptographic-primitives#tls-addresses). In essence, NodeID is defined by two files:
- `staker.crt`
- `staker.key`
NodePOP is this node's BLS key and proof of possession. Nodes must register a BLS key to act as a validator on the Primary Network. Your node's POP is logged on startup and is accessible over this endpoint.
- `publicKey` is the 48 byte hex representation of the BLS key.
- `proofOfPossession` is the 96 byte hex representation of the BLS signature.
NodePOP is defined by the `signer.key` file.
For enhanced security, you can use [CubeSigner remote signing](/docs/nodes/maintain/cube-signer-sidecar) instead of storing BLS keys locally. CubeSigner stores keys in hardware-backed enclaves and eliminates the need to back up `signer.key` files.
In the default installation, they can be found in the working directory, specifically in `~/.avalanchego/staking/`. All we need to do to recreate the node on another machine is to run a new installation with those same three files.
If `staker.key` and `staker.crt` are removed from a node, which is restarted afterwards, they will be recreated and a new node ID will be assigned.
If the `signer.key` is regenerated, the node will lose its previous BLS identity, which includes its public key and proof of possession. This change means that the node's former identity on the network will no longer be recognized, affecting its ability to participate in the consensus mechanism as before. Consequently, the node may lose its established reputation and any associated staking rewards.
If you have users defined in the keystore of your node, then you need to back up and restore those as well. [Keystore API](/docs/rpcs/other) has methods that can be used to export and import user keys. Note that Keystore API is used by developers only and not intended for use in production nodes. If you don't know what a keystore API is and have not used it, you don't need to worry about it.
### Backup[](#backup "Direct link to heading")
To back up your node, we need to store `staker.crt` and `staker.key` files somewhere safe and private, preferably to a different computer, to your private To back up your node, we need to store `staker.crt`, `staker.key` and `signer.key` files somewhere safe and private, preferably to a different computer.
If someone gets a hold of your staker files, they still cannot get to your funds, as they are controlled by the wallet private keys, not by the node. But, they could re-create your node somewhere else, and depending on the circumstances make you lose the staking rewards. So make sure your staker files are secure.
If someone gains access to your `signer.key`, they could potentially sign transactions on behalf of your node, which might disrupt the operations and integrity of your node on the network.
Let's get the files off the machine running the node.
#### From Local Node[](#from-local-node "Direct link to heading")
If you're running the node locally, on your desktop computer, just navigate to where the files are and copy them somewhere safe.
On a default Linux installation, the path to them will be `/home/USERNAME/.avalanchego/staking/`, where `USERNAME` needs to be replaced with the actual username running the node. Select and copy the files from there to a backup location. You don't need to stop the node to do that.
#### From Remote Node Using `scp`[](#from-remote-node-using-scp "Direct link to heading")
`scp` is a 'secure copy' command line program, available built-in on Linux and MacOS computers. There is also a Windows version, `pscp`, as part of the [PuTTY](https://www.chiark.greenend.org.uk/~sgtatham/putty/latest.html) package. If using `pscp`, in the following commands replace each usage of `scp` with `pscp -scp`.
To copy the files from the node, you will need to be able to remotely log into the machine. You can use account password, but the secure and recommended way is to use the SSH keys. The procedure for acquiring and setting up SSH keys is highly dependent on your cloud provider and machine configuration. You can refer to our [Amazon Web Services](/docs/nodes/run-a-node/on-third-party-services/amazon-web-services) and [Microsoft Azure](/docs/nodes/run-a-node/on-third-party-services/microsoft-azure) setup guides for those providers. Other providers will have similar procedures.
When you have means of remote login into the machine, you can copy the files over with the following command:
```bash
scp -r ubuntu@PUBLICIP:/home/ubuntu/.avalanchego/staking ~/avalanche_backup
```
This assumes the username on the machine is `ubuntu`, replace with correct username in both places if it is different. Also, replace `PUBLICIP` with the actual public IP of the machine. If `scp` doesn't automatically use your downloaded SSH key, you can point to it manually:
```bash
scp -i /path/to/the/key.pem -r ubuntu@PUBLICIP:/home/ubuntu/.avalanchego/staking ~/avalanche_backup
```
Once executed, this command will create `avalanche_backup` directory and place those three files in it. You need to store them somewhere safe.
### Restore[](#restore "Direct link to heading")
To restore your node from a backup, we need to do the reverse: restore `staker.key`, `staker.crt` and `signer.key` from the backup to the working directory of the new node.
First, we need to do the usual [installation](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go) of the node. This will create a new NodeID, a new BLS key and a new BLS signature, which we need to replace. When the node is installed correctly, log into the machine where the node is running and stop it:
```bash
sudo systemctl stop avalanchego
```
We're ready to restore the node.
#### To Local Node[](#to-local-node "Direct link to heading")
If you're running the node locally, just copy the `staker.key`, `staker.crt` and `signer.key` files from the backup location into the working directory, which on the default Linux installation will be `/home/USERNAME/.avalanchego/staking/`. Replace `USERNAME` with the actual username used to run the node.
#### To Remote Node Using `scp`[](#to-remote-node-using-scp "Direct link to heading")
Again, the process is just the reverse operation. Using `scp` we need to copy the `staker.key`, `staker.crt` and `signer.key` files from the backup location into the remote working directory. Assuming the backed up files are located in the directory where the above backup procedure placed them:
```bash
scp ~/avalanche_backup/{staker.*,signer.key} ubuntu@PUBLICIP:/home/ubuntu/.avalanchego/staking
```
Or if you need to specify the path to the SSH key:
```bash
scp -i /path/to/the/key.pem ~/avalanche_backup/{staker.*,signer.key} ubuntu@PUBLICIP:/home/ubuntu/.avalanchego/staking
```
And again, replace `ubuntu` with correct username if different, and `PUBLICIP` with the actual public IP of the machine running the node, as well as the path to the SSH key if used.
#### Restart the Node and Verify[](#restart-the-node-and-verify "Direct link to heading")
Once the files have been replaced, log into the machine and start the node using:
```bash
sudo systemctl start avalanchego
```
You can now check that the node is restored with the correct NodeID and NodePOP by issuing the [getNodeID](/docs/rpcs/other/info-rpc#infogetnodeid) API call in the same console you ran the previous command:
```bash
curl -X POST --data '{
"jsonrpc":"2.0",
"id" :1,
"method" :"info.getNodeID"
}' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info
```
You should see your original NodeID and NodePOP (BLS key and BLS signature). Restore process is done.
Database[](#database "Direct link to heading")
-----------------------------------------------
Normally, when starting a new node, you can just bootstrap from scratch. However, there are situations when you may prefer to reuse an existing database (ex: preserve keystore records, reduce sync time).
This tutorial will walk you through compressing your node's DB and moving it to another computer using `zip` and `scp`.
### Database Backup[](#database-backup "Direct link to heading")
First, make sure to stop AvalancheGo, run:
```bash
sudo systemctl stop avalanchego
```
You must stop the Avalanche node before you back up the database otherwise data could become corrupted.
Once the node is stopped, you can `zip` the database directory to reduce the size of the backup and speed up the transfer using `scp`:
```bash
zip -r avalanche_db_backup.zip .avalanchego/db
```
_Note: It may take > 30 minutes to zip the node's DB._
Next, you can transfer the backup to another machine:
```bash
scp -r ubuntu@PUBLICIP:/home/ubuntu/avalanche_db_backup.zip ~/avalanche_db_backup.zip
```
This assumes the username on the machine is `ubuntu`, replace with correct username in both places if it is different. Also, replace `PUBLICIP` with the actual public IP of the machine. If `scp` doesn't automatically use your downloaded SSH key, you can point to it manually:
```bash
scp -i /path/to/the/key.pem -r ubuntu@PUBLICIP:/home/ubuntu/avalanche_db_backup.zip ~/avalanche_db_backup.zip
```
Once executed, this command will create `avalanche_db_backup.zip` directory in you home directory.
### Database Restore[](#database-restore "Direct link to heading")
_This tutorial assumes you have already completed "Database Backup" and have a backup at ~/avalanche\_db\_backup.zip._
First, we need to do the usual [installation](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go) of the node. When the node is installed correctly, log into the machine where the node is running and stop it:
```bash
sudo systemctl stop avalanchego
```
You must stop the Avalanche node before you restore the database otherwise data could become corrupted.
We're ready to restore the database. First, let's move the DB on the existing node (you can remove this old DB later if the restore was successful):
```bash
mv .avalanchego/db .avalanchego/db-old
```
Next, we'll unzip the backup we moved from another node (this will place the unzipped files in `~/.avalanchego/db` when the command is run in the home directory):
```bash
unzip avalanche_db_backup.zip
```
After the database has been restored on a new node, use this command to start the node:
```bash
sudo systemctl start avalanchego
```
Node should now be running from the database on the new instance. To check that everything is in order and that node is not bootstrapping from scratch (which would indicate a problem), use:
```bash
sudo journalctl -u avalanchego -f
```
The node should be catching up to the network and fetching a small number of blocks before resuming normal operation (all the ones produced from the time when the node was stopped before the backup).
Once the backup has been restored and is working as expected, the zip can be deleted:
```bash
rm avalanche_db_backup.zip
```
### Database Direct Copy[](#database-direct-copy "Direct link to heading")
You may be in a situation where you don't have enough disk space to create the archive containing the whole database, so you cannot complete the backup process as described previously.
In that case, you can still migrate your database to a new computer, by using a different approach: `direct copy`. Instead of creating the archive, moving the archive and unpacking it, we can do all of that on the fly.
To do so, you will need `ssh` access from the destination machine (where you want the database to end up) to the source machine (where the database currently is). Setting up `ssh` is the same as explained for `scp` earlier in the document.
Same as shown previously, you need to stop the node (on both machines):
```bash
sudo systemctl stop avalanchego
```
You must stop the Avalanche node before you back up the database otherwise data could become corrupted.
Then, on the destination machine, change to a directory where you would like to the put the database files, enter the following command:
```bash
ssh -i /path/to/the/key.pem ubuntu@PUBLICIP 'tar czf - .avalanchego/db' | tar xvzf - -C .
```
Make sure to replace the correct path to the key, and correct IP of the source machine. This will compress the database, but instead of writing it to a file it will pipe it over `ssh` directly to destination machine, where it will be decompressed and written to disk. The process can take a long time, make sure it completes before continuing.
After copying is done, all you need to do now is move the database to the correct location on the destination machine. Assuming there is a default AvalancheGo node installation, we remove the old database and replace it with the new one:
```bash
rm -rf ~/.avalanchego/db
mv db ~/.avalanchego/db
```
You can now start the node on the destination machine:
```bash
sudo systemctl start avalanchego
```
Node should now be running from the copied database. To check that everything is in order and that node is not bootstrapping from scratch (which would indicate a problem), use:
```bash
sudo journalctl -u avalanchego -f
```
The node should be catching up to the network and fetching a small number of blocks before resuming normal operation (all the ones produced from the time when the node was stopped before the backup).
Summary[](#summary "Direct link to heading")
---------------------------------------------
Essential part of securing your node is the backup that enables full and painless restoration of your node. Following this tutorial you can rest easy knowing that should you ever find yourself in a situation where you need to restore your node from scratch, you can easily and quickly do so.
If you have any problems following this tutorial, comments you want to share with us or just want to chat, you can reach us on our [Discord](https://chat.avalabs.org/) server.
# Chain State Management (/docs/nodes/maintain/chain-state-management)
---
title: Chain State Management
description: Understanding active state vs archival state in EVM chains, and node configuration options.
---
When running an EVM-based blockchain (C-Chain or Subnet-EVM L1s), your node stores blockchain state on disk. Understanding the difference between **active state** and **archival state** is crucial for choosing the right configuration.
## State Types
Your node's storage requirements depend on which type of state you're maintaining:
| Property | Active State | Active State with Snapshots | Archival State |
|----------|--------------|------------------------------|----------------|
| **Size (C-Chain)** | ~500 GB | ~750 GB - 1 TB | ~3 TB+ (and growing) |
| **Contents** | Current account balances, contract storage, code | Current state + state sync snapshots for serving peers | Complete state history at every block |
| **Required for** | Validating, sending transactions, reading current state | Same as Active State, helps other nodes bootstrap | Historical queries at any block height, block explorers, analytics |
| **Sync method** | State sync (fast, hours) | State sync, then grows over time | Full sync from genesis (slow, days) |
| **Maintenance** | Periodic pruning or resync recommended | Periodic pruning or resync recommended | None needed (intentional full history) |
### Active State
The **active state** represents the current state of the blockchain—all account balances, contract storage, and code as of the latest block. This is what your node needs to validate new transactions and participate in consensus. When you bootstrap with state sync, you start with just the active state.
### Active State with State Sync Snapshots
**Active state with state sync snapshots** is what your node accumulates over time after starting with active state. As blocks are processed, state sync snapshots are retained for serving other nodes that want to bootstrap via state sync. This causes disk usage to grow beyond the active state size. Running offline pruning periodically removes these snapshots while keeping your node functional. Most long-running validators operate in this state.
### Archival State
The **archival state** includes the complete history of all state changes since genesis. This allows querying historical state at any block height (e.g., "What was this account's balance at block 1,000,000?"). Archive nodes are typically only required for block explorers, indexers, and specialized analytics applications.
Most validators and RPC nodes only need **active state**. Archive nodes are specialized infrastructure for historical data access.
## State Growth Rates
Even with the same configuration, different types of state grow at different rates:
| Growth Type | Rate | Description |
|-------------|------|-------------|
| Archival state | ~[TBD] GB/month | Complete history stored at every block |
| Active state + snapshots | ~[TBD] GB/month | Active state + Snapshots every 4000 blocks for serving peers |
| Active state | ~[TBD] GB/month | Current blockchain state only |
State sync snapshots are retained to help other nodes bootstrap. Even if you don't need archival state, these snapshots accumulate over time and increase disk usage.
## Node Configuration Matrix
Your node's final state depends on two factors: **how you bootstrap** and **whether pruning is enabled**.
| Bootstrap Method | Pruning Disabled | Pruning Enabled |
|------------------|------------------|-----------------|
| **State Sync** | Active + Snapshots (~750GB - 1TB) | Active State only (~500GB) |
| **Full Sync** | Full Archival (~3TB+) | Contradictory goals |
### Key Insight
If you start with **state sync** and have **pruning disabled**, you will accumulate state sync snapshots over time but will NOT have full archival state. To get full archival state, you must do a **full sync from genesis**.
## Choosing Your Configuration
| Use Case | Bootstrap | Pruning | Result | Disk Size |
|----------|-----------|---------|--------|-----------|
| Validator | State Sync | Periodic | Active state, minimal disk | ~500 GB |
| Standard RPC | State Sync | Optional | Current state queries | ~500 GB - 1 TB |
| Archival RPC | State Sync | Disabled | Full state after sync point | ~750 GB - 1 TB |
| Block Explorer / Indexer | Full Sync | Disabled | Complete archival history | ~3 TB+ |
**Archival RPC vs Block Explorer**: An archival RPC started via state sync can answer queries from the sync point forward. For complete historical queries from genesis, you need a full sync.
## State Growth Visualization

**Understanding the chart:**
- **Archival State** (gray line): Grows fastest over time as it stores complete state history
- Includes all historical state changes since genesis
- Required only for block explorers, indexers, and specialized analytics
- **Active State with State Sync Snapshots** (red line): Represents typical node disk usage over time
- Grows at a moderate rate as state sync snapshots accumulate
- This is what most long-running nodes experience without maintenance
- **Active State** (black line): Grows at the slowest, steady rate
- Represents only the current blockchain state needed for validation
- This is your starting point after state sync
- **Active State with periodic snapshot deletion** (green line): Shows nodes performing maintenance periodically
- After reaching active state, the node accumulates state sync snapshots over time
- When maintenance is performed, state drops back to active state level
- This sawtooth pattern represents the recommended maintenance cycle
[Firewood](https://github.com/ava-labs/firewood) is an upcoming database upgrade that will address the issue of state growing too large. This next-generation storage layer is designed to efficiently manage state growth and reduce disk space requirements for node operators.
### New Validator State Sync Visualization
The following diagram illustrates the state lifecycle for a new validator joining the network:

**Understanding the diagram:**
- **New validator (State Sync)**: When a new validator joins (blue line) via state sync, it quickly reaches the active state level
- **Active State** (black line): The minimal state required for validation
- **Green line**: After bootstrapping, the node accumulates snapshots. Periodic maintenance brings state back down
## Managing Disk Usage
For nodes that don't need archival state, disk usage will grow over time as state sync snapshots accumulate. See [State Size Reduction](/docs/nodes/maintain/chain-state-size-reduction) for options to reclaim disk space:
- **Offline Pruning**: Remove snapshots while keeping database intact (requires downtime)
- **Fresh State Sync**: Bootstrap a new node and transfer validator identity (no downtime)
## Configuring State Sync
State sync is enabled by default for the C-Chain. For Avalanche L1s, you can configure it per-chain:
- **C-Chain configuration**: See [C-Chain Config](/docs/nodes/chain-configs/primary-network/c-chain#state-sync-enabled)
- **Avalanche L1 configuration**: See [Subnet-EVM Config](/docs/nodes/chain-configs/avalanche-l1s/subnet-evm#state-sync-enabled)
## P-Chain and X-Chain State
The P-Chain and X-Chain have significantly smaller state footprints compared to the C-Chain:
- **P-Chain**: Stores validator metadata, Avalanche L1 definitions, and staking transactions. State size is typically < 10 GB and grows very slowly.
- **X-Chain**: Handles AVAX transfers using the UTXO model. State size is typically < 50 GB and grows slowly.
**Important limitations:**
- State sync is **not available** for P-Chain or X-Chain
- These chains always sync from genesis by replaying all transactions
- Bootstrap time is faster than C-Chain despite no state sync due to much smaller state size (typically < 1 hour)
- Disk space management is rarely needed for these chains
## L1-Specific Considerations
For Avalanche L1s running Subnet-EVM:
- **State size scales with usage**: High-throughput chains accumulate state faster
- **Same management options apply**: Offline pruning and state sync work identically to C-Chain
- **State sync available**: Configure via [Subnet-EVM chain config](/docs/nodes/chain-configs/avalanche-l1s/subnet-evm#state-sync-enabled)
- **Plan storage accordingly**: Reference the [system requirements](/docs/nodes/system-requirements) for your throughput tier
# State Size Reduction (/docs/nodes/maintain/chain-state-size-reduction)
---
title: State Size Reduction
description: Options for reducing disk usage on non-archival nodes through offline pruning or fresh state sync.
---
For nodes that don't need archival state, disk usage grows over time as state sync snapshots accumulate. Here are two options to reclaim disk space.
## Option 1: Offline Pruning (State Sync Snapshot Deletion)
Removes accumulated state sync snapshots while keeping your database intact.
| Pros | Cons |
|------|------|
| Only need a single node | Need to stop the node |
| Preserves transaction index | Downtime required (duration varies) |
| No network bandwidth required | Requires temporary disk space for bloom filter |
The duration of offline pruning depends on how many state sync snapshots have accumulated since the last pruning. A node pruned regularly may complete quickly, while one never pruned could take significantly longer.

The green line shows a node performing periodic offline pruning. Each black vertical drop represents a pruning event: the node's state drops from "Active + Snapshots" back to just "Active State". Frequent pruning is recommended: it keeps disk usage low and each pruning operation completes faster since there are fewer snapshots to remove.
### How Offline Pruning Works
Offline Pruning is ported from `go-ethereum` to reduce the amount of disk space taken up by the TrieDB (storage for the Merkle Forest).
Offline pruning creates a bloom filter and adds all trie nodes in the active state to the bloom filter to mark the data as protected. This ensures that any part of the active state will not be removed during offline pruning.
After generating the bloom filter, offline pruning iterates over the database and searches for trie nodes that are safe to be removed from disk.
A bloom filter is a probabilistic data structure that reports whether an item is definitely not in a set or possibly in a set. Therefore, for each key we iterate, we check if it is in the bloom filter. If the key is definitely not in the bloom filter, then it is not in the active state and we can safely delete it. If the key is possibly in the set, then we skip over it to ensure we do not delete any active state.
During iteration, the underlying database (LevelDB) writes deletion markers, causing a temporary increase in disk usage.
After iterating over the database and deleting any old trie nodes that it can, offline pruning then runs compaction to minimize the DB size after the potentially large number of delete operations.
### Finding the C-Chain Config File
In order to enable offline pruning, you need to update the C-Chain config file to include the parameters `offline-pruning-enabled` and `offline-pruning-data-directory`.
The default location of the C-Chain config file is `~/.avalanchego/configs/chains/C/config.json`. **Please note that by default, this file does not exist. You would need to create it manually.** You can update the directory for chain configs by passing in the directory of your choice via the CLI argument: `chain-config-dir`. See [this](/docs/nodes/configure/configs-flags) for more info. For example, if you start your node with:
```bash
./build/avalanchego --chain-config-dir=/home/ubuntu/chain-configs
```
The chain config directory will be updated to `/home/ubuntu/chain-configs` and the corresponding C-Chain config file will be: `/home/ubuntu/chain-configs/C/config.json`.
### Running Offline Pruning
In order to enable offline pruning, update the C-Chain config file to include the following parameters:
```json
{
"offline-pruning-enabled": true,
"offline-pruning-data-directory": "/home/ubuntu/offline-pruning"
}
```
This will set `/home/ubuntu/offline-pruning` as the directory to be used by the offline pruner. Offline pruning will store the bloom filter in this location, so you must ensure that the path exists.
Now that the C-Chain config file has been updated, you can start your node with the command (no CLI arguments are necessary if using the default chain config directory):
Once AvalancheGo starts the C-Chain, you can expect to see update logs from the offline pruner:
```bash
INFO [02-09|00:20:15.625] Iterating state snapshot accounts=297,231 slots=6,669,708 elapsed=16.001s eta=1m29.03s
INFO [02-09|00:20:23.626] Iterating state snapshot accounts=401,907 slots=10,698,094 elapsed=24.001s eta=1m32.522s
INFO [02-09|00:20:31.626] Iterating state snapshot accounts=606,544 slots=13,891,948 elapsed=32.002s eta=1m10.927s
...
INFO [02-09|00:21:47.342] Iterated snapshot accounts=1,950,875 slots=49,667,870 elapsed=1m47.718s
INFO [02-09|00:21:47.351] Writing state bloom to disk name=/home/ubuntu/offline-pruning/statebloom.0xd6fca36db4b60b34330377040ef6566f6033ed8464731cbb06dc35c8401fa38e.bf.gz
INFO [02-09|00:23:04.421] State bloom filter committed name=/home/ubuntu/offline-pruning/statebloom.0xd6fca36db4b60b34330377040ef6566f6033ed8464731cbb06dc35c8401fa38e.bf.gz
```
The bloom filter should be populated and committed to disk after about 5 minutes. At this point, if the node shuts down, it will resume the offline pruning session when it restarts (note: this operation cannot be cancelled).
In order to ensure that users do not mistakenly leave offline pruning enabled for the long term (which could result in an hour of downtime on each restart), we have added a manual protection which requires that after an offline pruning session, the node must be started with offline pruning disabled at least once before it will start with offline pruning enabled again. Therefore, once the bloom filter has been committed to disk, you should update the C-Chain config file to include the following parameters:
```json
{
"offline-pruning-enabled": false,
"offline-pruning-data-directory": "/home/ubuntu/offline-pruning"
}
```
It is important to keep the same data directory in the config file, so that the node knows where to look for the bloom filter on a restart if offline pruning has not finished.
Now if your node restarts, it will be marked as having correctly disabled offline pruning after the run and be allowed to resume normal operation once offline pruning has finished running.
You will see progress logs throughout the offline pruning run which will indicate the session's progress:
```bash
INFO [02-09|00:31:51.920] Pruning state data nodes=40,116,759 size=10.08GiB elapsed=8m47.499s eta=12m50.961s
INFO [02-09|00:31:59.921] Pruning state data nodes=41,659,059 size=10.47GiB elapsed=8m55.499s eta=12m13.822s
...
INFO [02-09|00:42:45.359] Pruned state data nodes=98,744,430 size=24.82GiB elapsed=19m40.938s
INFO [02-09|00:42:45.360] Compacting database range=0x00-0x10 elapsed="2.157µs"
...
INFO [02-09|00:59:34.367] Database compaction finished elapsed=16m49.006s
INFO [02-09|00:59:34.367] State pruning successful pruned=24.82GiB elapsed=39m34.749s
INFO [02-09|00:59:34.367] Completed offline pruning. Re-initializing blockchain.
```
At this point, the node will go into bootstrapping and (once bootstrapping completes) resume consensus and operate as normal.
### Disk Space Considerations
To ensure the node does not enter an inconsistent state, the bloom filter used for pruning is persisted to `offline-pruning-data-directory` for the duration of the operation. This directory should have `offline-pruning-bloom-filter-size` available in disk space (default 512 MB).
The underlying database (LevelDB) uses deletion markers (tombstones) to identify newly deleted keys. These markers are temporarily persisted to disk until they are removed during a process known as compaction. This will lead to an increase in disk usage during pruning. If your node runs out of disk space during pruning, you may safely restart the pruning operation. This may succeed as restarting the node triggers compaction.
If restarting the pruning operation does not succeed, additional disk space should be provisioned.
---
## Option 2: Replace with Freshly State Synced Node
Bootstrap a new node via state sync and transfer your validator identity to achieve zero downtime.
| Pros | Cons |
|------|------|
| No downtime for validator | Needs separate machine to bootstrap |
| Fresh, clean database | Network bandwidth for sync |
| No bloom filter disk overhead | More complex multi-step process |
### How It Works
This works because your validator identity is determined by cryptographic keys in the staking directory, not the database.
Your validator identity consists of three key files in `~/.avalanchego/staking/`:
- **staker.crt** - TLS certificate (determines your Node ID)
- **staker.key** - TLS private key (for encrypted P2P communication)
- **signer.key** - BLS signing key (for consensus signatures)
These files define your validator identity. The Node ID shown on the P-Chain is cryptographically derived from `staker.crt`, so copying these files transfers your complete validator identity.

The diagram shows the process: stop the old node, let a new node state sync, then transfer the staking keys to continue validating with a fresh database.
### Step-by-Step Process
1. **Provision a new server** with the same or better specs than your current validator
2. **Install and configure AvalancheGo** on the new server, but don't start it yet:
```bash
# Install AvalancheGo on new server
# Follow: /docs/nodes/run-a-node/using-install-script/installing-avalanche-go
```
3. **Let the new node sync completely** (start it normally to download the blockchain):
```bash
# On new server
sudo systemctl start avalanchego
# Monitor sync progress (wait until fully synced)
# This may take several hours
curl -X POST --data '{
"jsonrpc":"2.0",
"id" :1,
"method" :"info.isBootstrapped",
"params": {
"chain":"C"
}
}' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info
```
4. **Stop both nodes** simultaneously to prepare for the identity transfer:
```bash
# On old validator
sudo systemctl stop avalanchego
# On new server
sudo systemctl stop avalanchego
```
5. **Backup the new server's auto-generated keys** (optional but recommended):
```bash
# On new server
mv ~/.avalanchego/staking ~/.avalanchego/staking.backup
```
6. **Copy the staking directory** from your old validator to the new server:
```bash
# From your old validator, copy to new server
scp -r ~/.avalanchego/staking/ user@new-server:~/.avalanchego/
# Or use rsync for better control:
rsync -avz ~/.avalanchego/staking/ user@new-server:~/.avalanchego/staking/
```
7. **Verify file permissions** on the new server:
```bash
# On new server
chmod 700 ~/.avalanchego/staking
chmod 400 ~/.avalanchego/staking/staker.key
chmod 400 ~/.avalanchego/staking/staker.crt
chmod 400 ~/.avalanchego/staking/signer.key
chown -R avalanche:avalanche ~/.avalanchego/staking # If using avalanche user
```
8. **Start the new node** with your validator identity:
```bash
# On new server
sudo systemctl start avalanchego
```
9. **Verify the Node ID matches**:
```bash
# On new server - confirm this matches your registered validator Node ID
curl -X POST --data '{
"jsonrpc":"2.0",
"id" :1,
"method" :"info.getNodeID"
}' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info
```
10. **Monitor for successful validation**:
```bash
# Check if you're validating
curl -X POST --data '{
"jsonrpc":"2.0",
"id" :1,
"method" :"platform.getCurrentValidators",
"params": {
"subnetID": null
}
}' -H 'content-type:application/json;' 127.0.0.1:9650/ext/P
```
### Important Notes
- **Timing**: The entire stop → transfer → start process typically takes 5-15 minutes. Your validator will miss some blocks during this window, but won't be penalized as long as you're back online before your uptime drops below 80%.
- **Don't run both nodes simultaneously**: Running two nodes with the same staking keys simultaneously can cause network issues and potential penalties. Always stop the old node before starting the new one.
- **Database not needed**: You don't need to copy `~/.avalanchego/db/` - the new node already has a fresh, synced database from step 3.
- **Config files**: If you have custom configuration in `~/.avalanchego/configs/`, copy those as well to maintain the same node behavior.
### Alternative: Update node in place
If your server supports it, you can also achieve zero downtime by:
1. Attaching additional storage to your existing server
2. Syncing a new database to the new disk in a separate directory
3. Stopping AvalancheGo briefly
4. Updating the data directory config to point to the new disk
5. Starting AvalancheGo with the fresh database
This avoids transferring staking keys but requires more complex storage management.
---
## Comparison: Which Option to Choose?
| Consideration | Offline Pruning | Fresh State Sync |
|---------------|-----------------|------------------|
| Downtime | Required (duration varies) | None (if done correctly) |
| Hardware needed | Single node | Two machines temporarily |
| Complexity | Simple config change | Multi-step process |
| Disk during process | +512MB bloom filter | Second full node |
| Best for | Single validators, scheduled maintenance | Critical uptime requirements |
---
## Monitoring Disk Usage
Track your node's disk usage over time to plan maintenance:
```bash
# Check database size
du -sh ~/.avalanchego/db
# Check available disk space
df -h /
```
Consider setting up alerts when disk usage exceeds 80% to give yourself time to plan maintenance.
# CubeSigner Remote BLS Signing (/docs/nodes/maintain/cube-signer-sidecar)
---
title: CubeSigner Remote BLS Signing
description: Learn how to use CubeSigner for secure hardware-backed BLS key management with AvalancheGo validators.
---
The CubeSigner sidecar enables AvalancheGo validators to use hardware-backed remote signing for BLS keys instead of storing them locally. This guide walks you through setting up and configuring the CubeSigner sidecar for enhanced security.
## Introduction
By default, AvalancheGo nodes store their BLS signing keys locally in a `signer.key` file. While functional, this approach has security limitations:
- Keys stored on disk are vulnerable to theft or compromise
- Lost or corrupted keys mean permanent loss of validator identity and staking rewards
- No protection against unauthorized signing operations
The CubeSigner sidecar solves these problems by delegating all BLS signing operations to [CubeSigner](https://cubist.dev/), a hardware-backed key management platform. Your BLS keys remain in secure AWS Nitro Enclaves and never touch local storage.
### Benefits
- **Hardware Security**: Keys stored in AWS Nitro Enclaves, never exposed in memory
- **Anti-Slashing Protection**: Built-in safeguards prevent double signing
- **High Availability**: 99.99% uptime with millisecond latency
- **Policy Enforcement**: Control what operations can be signed at the platform level
- **Disaster Recovery**: Keys remain safe even if validator node is compromised
## Prerequisites
Before you begin, ensure you have:
- **AvalancheGo v1.13.4 or later**: The `--staking-rpc-signer-endpoint` flag was added in the Fortuna.4 release
- **Cubist Account**: Sign up at [cubist.dev](https://cubist.dev/) for CubeSigner access
- **CubeSigner CLI**: Install the `cs` command-line tool ([installation guide](https://docs.cubist.dev/))
- **Shell Access**: Ability to configure and restart your AvalancheGo node
The CubeSigner sidecar is an advanced configuration for production validators. Make sure you understand the setup process before implementing on mainnet.
## Architecture Overview
The CubeSigner sidecar acts as a gRPC proxy between AvalancheGo and the CubeSigner API:
```
AvalancheGo Node
↓
gRPC Request (localhost:50051)
↓
CubeSigner Sidecar
↓
HTTPS Request
↓
CubeSigner API (AWS Nitro Enclaves)
↓
BLS Signature
↓
Returns to AvalancheGo
```
The sidecar implements AvalancheGo's `signer.proto` gRPC interface, translating node signing requests into CubeSigner API calls. All cryptographic operations happen inside CubeSigner's secure enclaves.
## Step 1: Set Up CubeSigner
### Create a Role
First, create a CubeSigner role for your BLS signing operations:
```bash
cs role create --role-name avalanche-bls-signer
```
This command returns a role ID. Save this ID, as you'll need it in subsequent steps.
### Generate a BLS Key
Create a new BLS key for Avalanche ICM (Interchain Messaging):
```bash
cs keys create --key-type=bls-ava-icm
```
CubeSigner uses the key type `bls-ava-icm` specifically for Avalanche BLS signing operations. This ensures the correct signing algorithm is used.
The command outputs a key ID in the format `Key#BlsAvaIcm_0x...`. Copy this key ID.
### Configure Signing Policy
Set the policy to allow raw BLS blob signing:
```bash
cs key set-policy --key-id --policy '"AllowRawBlobSigning"'
```
Replace `` with the key ID from the previous step.
The `AllowRawBlobSigning` policy is required for AvalancheGo to sign messages. Without this policy, signing requests will be rejected.
### Associate Key with Role
Link your BLS key to the role you created:
```bash
cs role add-key --role-id --key-id
```
### Generate Authentication Token
Create a token file that the sidecar will use to authenticate with CubeSigner:
```bash
cs token create --role-id > token.json
```
This creates a JSON file containing authentication credentials. Keep this file secure.
The `token.json` file grants access to your BLS signing key. Store it securely with restricted file permissions (`chmod 600 token.json`) and never commit it to version control. The sidecar refreshes this file automatically, so it must remain writable by the process.
## Step 2: Run the Sidecar
You can run the CubeSigner sidecar using Docker or as a standalone binary.
### Using Docker
Pull and run the official Docker image:
```bash
docker run -d \
--name cube-signer-sidecar \
-p 50051:50051 \
-v $(pwd)/token.json:/token.json \
-e SIGNER_ENDPOINT=https://gamma.signer.cubist.dev \
-e KEY_ID=Key#BlsAvaIcm_0x... \
-e TOKEN_FILE_PATH=/token.json \
avaplatform/cube-signer-sidecar:0.0.0-rc9 start
```
Replace the `KEY_ID` value with your actual key ID from Step 1.
Check [Docker Hub](https://hub.docker.com/r/avaplatform/cube-signer-sidecar/tags) for the latest available image tag. The `:latest` tag will be available once a stable release is published.
Do not mount `token.json` as read-only; the sidecar writes refreshed session data back to this file. The default bind mount is read/write, which is required.
The default CubeSigner endpoint for production is `https://gamma.signer.cubist.dev`. For testnet or development, CubeSigner may provide alternative endpoints.
### Running Locally
If you prefer to build from source:
```bash
# Clone the repository
git clone https://github.com/ava-labs/cube-signer-sidecar.git
cd cube-signer-sidecar
# Build the binary
go build -o cube-signer-sidecar main/main.go
# Run the sidecar
export SIGNER_ENDPOINT=https://gamma.signer.cubist.dev
export KEY_ID=Key#BlsAvaIcm_0x...
export TOKEN_FILE_PATH=./token.json
./cube-signer-sidecar start
```
### Configuration Options
The sidecar supports configuration via command-line flags, environment variables, or a JSON config file:
| Option | Environment Variable | Required | Default | Description |
|--------|---------------------|----------|---------|-------------|
| `--token-file-path` | `TOKEN_FILE_PATH` | Yes | - | Path to the token JSON file |
| `--signer-endpoint` | `SIGNER_ENDPOINT` | Yes | - | CubeSigner API endpoint URL |
| `--key-id` | `KEY_ID` | Yes | - | BLS key identifier |
| `--port` | `PORT` | No | 50051 | gRPC server listening port |
| `--config-file` | `CONFIG_FILE` | No | - | Path to JSON configuration file |
**Example JSON Configuration:**
```json
{
"token-file-path": "/path/to/token.json",
"signer-endpoint": "https://gamma.signer.cubist.dev",
"key-id": "Key#BlsAvaIcm_0x...",
"port": 50051
}
```
Use with:
```bash
./cube-signer-sidecar start --config-file config.json
```
## Step 3: Configure AvalancheGo
Once the sidecar is running, configure AvalancheGo to use it for BLS signing.
### Add the Signer Endpoint Flag
Update your AvalancheGo startup command to include the `--staking-rpc-signer-endpoint` flag:
```bash
avalanchego \
--staking-rpc-signer-endpoint=127.0.0.1:50051 \
[other flags...]
```
If your sidecar is running on a different machine, replace `127.0.0.1` with the appropriate IP address. Ensure network connectivity and firewall rules allow gRPC traffic on port 50051.
### Using a Configuration File
Alternatively, add the setting to your AvalancheGo configuration JSON:
```json
{
"staking-rpc-signer-endpoint": "127.0.0.1:50051"
}
```
### Using Systemd
If you run AvalancheGo as a systemd service, edit the service file:
```bash
sudo systemctl edit avalanchego
```
Add the flag to the `ExecStart` line or add an environment variable:
```ini
[Service]
Environment="AVALANCHEGO_STAKING_RPC_SIGNER_ENDPOINT=127.0.0.1:50051"
```
Then restart the service:
```bash
sudo systemctl daemon-reload
sudo systemctl restart avalanchego
```
## Verifying the Setup
After starting both the sidecar and AvalancheGo, verify the configuration is working correctly.
### Check Sidecar Logs
If running via Docker:
```bash
docker logs cube-signer-sidecar
```
You should see log messages indicating the gRPC server is running and receiving requests from AvalancheGo.
### Verify Node BLS Key
Call the AvalancheGo Info API to confirm your node is using the CubeSigner BLS key:
```bash
curl -X POST --data '{
"jsonrpc":"2.0",
"id" :1,
"method" :"info.getNodeID"
}' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info
```
The response should include your NodeID and NodePOP (BLS public key and proof of possession):
```json
{
"jsonrpc": "2.0",
"result": {
"nodeID": "NodeID-...",
"nodePOP": {
"publicKey": "0x...",
"proofOfPossession": "0x..."
}
},
"id": 1
}
```
The `publicKey` value should match the BLS key you created in CubeSigner.
### Monitor Node Logs
Check AvalancheGo logs to ensure there are no signing errors:
```bash
sudo journalctl -u avalanchego -f
```
Look for successful connection messages to the RPC signer endpoint. Any signing failures will appear as errors in these logs.
## Security Considerations
When using the CubeSigner sidecar, follow these security best practices:
### Token Management
- **Restrict File Permissions**: Set `token.json` to read-only for the user running the sidecar:
```bash
chmod 600 token.json
chown avalanchego:avalanchego token.json
```
- **Never Commit Tokens**: Add `token.json` to `.gitignore` to prevent accidental commits
- **Rotate Regularly**: Generate new tokens periodically and update your configuration
- **Monitor Usage**: Check CubeSigner logs for unauthorized signing attempts
### Network Security
- **Isolate the Sidecar**: Run the sidecar on the same machine as AvalancheGo or on a private network
- **Firewall Rules**: Restrict access to port 50051 to only the AvalancheGo process
- **TLS for Remote Connections**: The sidecar serves plaintext gRPC only; if you need TLS, place it behind a terminating reverse proxy or tunnel traffic over a private/secure network.
### Key Management
- **One Key Per Validator**: Each validator node should have its own unique BLS key
- **Backup Policies**: Document your CubeSigner role and key IDs for disaster recovery
- **Test First**: Always test the configuration on a testnet validator before deploying to mainnet
If someone gains access to your `token.json` file, they can sign messages on behalf of your validator. Treat this file with the same security as you would a private key.
## Troubleshooting
### Connection Refused Errors
**Problem**: AvalancheGo logs show "connection refused" when trying to reach the sidecar.
**Solution**:
- Verify the sidecar is running: `docker ps` or check the process
- Confirm the sidecar is listening on the correct port: `netstat -tlnp | grep 50051`
- Check firewall rules allow connections on port 50051
### Invalid Token Errors
**Problem**: Sidecar logs show authentication failures or invalid token errors.
**Solution**:
- Verify `token.json` contains valid JSON
- Ensure the token hasn't expired (tokens have a limited lifetime)
- Regenerate the token with `cs token create` and restart the sidecar
### Key Not Found Errors
**Problem**: Sidecar reports the key ID doesn't exist or isn't accessible.
**Solution**:
- Double-check the `KEY_ID` matches exactly what `cs keys create` returned
- Verify the key is associated with the role: `cs role keys --role-id `
- Ensure the key has the `AllowRawBlobSigning` policy set
### Signing Policy Errors
**Problem**: Signing requests are rejected with policy errors.
**Solution**:
- Confirm the key policy allows raw blob signing:
```bash
cs key set-policy --key-id --policy '"AllowRawBlobSigning"'
```
- Restart the sidecar after policy changes
### AvalancheGo Won't Start
**Problem**: AvalancheGo fails to start after adding the `--staking-rpc-signer-endpoint` flag.
**Solution**:
- Verify you're running AvalancheGo v1.13.4 or later: `avalanchego --version`
- Remove any existing `signer.key` file (it conflicts with remote signing)
- Check the sidecar is reachable before starting AvalancheGo
## Migration from Local BLS Keys
If you're migrating an existing validator from local `signer.key` to CubeSigner, you have two options:
### Option 1: New BLS Key (Recommended for Testnet)
Generate a new BLS key in CubeSigner and update your validator registration. This is the cleanest approach but requires re-registering your validator.
### Option 2: Import Existing Key (Production Validators)
Importing existing BLS keys into CubeSigner requires coordination with the CubeSigner team. This is typically only done for production validators with active stake. Contact [CubeSigner support](https://cubist.dev/contact) for assistance.
## Alternative: Local BLS Key Backup
If CubeSigner's remote signing doesn't fit your needs, consider traditional backup approaches for local BLS keys. See the [Backup and Restore](/docs/nodes/maintain/backup-restore) guide for instructions on backing up your `signer.key` file.
Traditional backups are simpler but lack the security benefits of hardware-backed signing.
## Next Steps
- [Monitor your node](/docs/nodes/maintain/monitoring) to ensure signing operations are working correctly
- [Upgrade AvalancheGo](/docs/nodes/maintain/upgrade) when new versions are released
- [Learn about Avalanche L1 validators](/docs/avalanche-l1s) if you're validating additional Subnets
## Resources
- [CubeSigner Documentation](https://docs.cubist.dev/)
- [CubeSigner for Validators](https://cubist.dev/cubesigner-hardware-backed-remote-signing-for-validator-infrastructure)
- [cube-signer-sidecar GitHub Repository](https://github.com/ava-labs/cube-signer-sidecar)
- [AvalancheGo Release Notes (v1.13.4)](https://github.com/ava-labs/avalanchego/releases/tag/v1.13.4)
# Enroll in Avalanche Notify (/docs/nodes/maintain/enroll-in-avalanche-notify)
---
title: Enroll in Avalanche Notify
---
To receive email alerts if a validator becomes unresponsive or out-of-date, sign up with the Avalanche Notify tool: [http://notify.avax.network](http://notify.avax.network/).
Avalanche Notify is an active monitoring system that checks a validator's responsiveness each minute.
An email alert is sent if a validator is down for 5 consecutive checks and when a validator recovers (is responsive for 5 checks in a row).
} >
When signing up for email alerts, consider using a new, alias, or auto-forwarding email address to protect your privacy. Otherwise, it will be possible to link your NodeID to your email.
This tool is currently in BETA and validator alerts may erroneously be triggered, not triggered, or delayed. The best way to maximize the likelihood of earning staking rewards is to run redundant monitoring/alerting.
# Monitoring (/docs/nodes/maintain/monitoring)
---
title: Monitoring
description: Learn how to monitor an AvalancheGo node.
---
This tutorial demonstrates how to set up infrastructure to monitor an instance of [AvalancheGo](https://github.com/ava-labs/avalanchego). We will use:
- [Prometheus](https://prometheus.io/) to gather and store data
- [`node_exporter`](https://github.com/prometheus/node_exporter) to get information about the machine,
- AvalancheGo's [Metrics API](/docs/api-reference/metrics-api) to get information about the node
- [Grafana](https://grafana.com/) to visualize data on a dashboard.
- A set of pre-made [Avalanche dashboards](https://github.com/ava-labs/avalanche-monitoring/tree/main/grafana/dashboards)
## Prerequisites:
- A running AvalancheGo node
- Shell access to the machine running the node
- Administrator privileges on the machine
This tutorial assumes you have Ubuntu 20.04 running on your node. Other Linux flavors that use `systemd` for running services and `apt-get` for package management might work but have not been tested. Community member has reported it works on Debian 10, might work on other Debian releases as well.
### Caveat: Security
The system as described here **should not** be opened to the public internet. Neither Prometheus nor Grafana as shown here is hardened against unauthorized access. Make sure that both of them are accessible only over a secured proxy, local network, or VPN. Setting that up is beyond the scope of this tutorial, but exercise caution. Bad security practices could lead to attackers gaining control over your node! It is your responsibility to follow proper security practices.
Monitoring Installer Script[](#monitoring-installer-script "Direct link to heading")
-------------------------------------------------------------------------------------
In order to make node monitoring easier to install, we have made a script that does most of the work for you. To download and run the script, log into the machine the node runs on with a user that has administrator privileges and enter the following command:
```bash
wget -nd -m https://raw.githubusercontent.com/ava-labs/avalanche-monitoring/main/grafana/monitoring-installer.sh ;\
chmod 755 monitoring-installer.sh;
```
This will download the script and make it executable.
Script itself is run multiple times with different arguments, each installing a different tool or part of the environment. To make sure it downloaded and set up correctly, begin by running:
```bash
./monitoring-installer.sh --help
```
It should display:
```bash
Usage: ./monitoring-installer.sh [--1|--2|--3|--4|--5|--help]
Options:
--help Shows this message
--1 Step 1: Installs Prometheus
--2 Step 2: Installs Grafana
--3 Step 3: Installs node_exporter
--4 Step 4: Installs AvalancheGo Grafana dashboards
--5 Step 5: (Optional) Installs additional dashboards
Run without any options, script will download and install latest version of AvalancheGo dashboards.
```
Let's get to it.
Step 1: Set up Prometheus [](#step-1-set-up-prometheus- "Direct link to heading")
----------------------------------------------------------------------------------
Run the script to execute the first step:
```bash
./monitoring-installer.sh --1
```
It should produce output something like this:
```bash
AvalancheGo monitoring installer
--------------------------------
STEP 1: Installing Prometheus
Checking environment...
Found arm64 architecture...
Prometheus install archive found:
https://github.com/prometheus/prometheus/releases/download/v2.31.0/prometheus-2.31.0.linux-arm64.tar.gz
Attempting to download:
https://github.com/prometheus/prometheus/releases/download/v2.31.0/prometheus-2.31.0.linux-arm64.tar.gz
prometheus.tar.gz 100%[=========================================================================================>] 65.11M 123MB/s in 0.5s
2021-11-05 14:16:11 URL:https://github-releases.githubusercontent.com/6838921/a215b0e7-df1f-402b-9541-a3ec9d431f76?X-Amz-Algorithm=AWS4-HMAC-SHA256&X-Amz-Credential=AKIAIWNJYAX4CSVEH53A%2F20211105%2Fus-east-1%2Fs3%2Faws4_request&X-Amz-Date=20211105T141610Z&X-Amz-Expires=300&X-Amz-Signature=72a8ae4c6b5cea962bb9cad242cb4478082594b484d6a519de58b8241b319d94&X-Amz-SignedHeaders=host&actor_id=0&key_id=0&repo_id=6838921&response-content-disposition=attachment%3B%20filename%3Dprometheus-2.31.0.linux-arm64.tar.gz&response-content-type=application%2Foctet-stream [68274531/68274531] -> "prometheus.tar.gz" [1]
...
```
You may be prompted to confirm additional package installs, do that if asked. Script run should end with instructions on how to check that Prometheus installed correctly. Let's do that, run:
```bash
sudo systemctl status prometheus
```
It should output something like:
```bash
● prometheus.service - Prometheus
Loaded: loaded (/etc/systemd/system/prometheus.service; enabled; vendor preset: enabled)
Active: active (running) since Fri 2021-11-12 11:38:32 UTC; 17min ago
Docs: https://prometheus.io/docs/introduction/overview/
Main PID: 548 (prometheus)
Tasks: 10 (limit: 9300)
Memory: 95.6M
CGroup: /system.slice/prometheus.service
└─548 /usr/local/bin/prometheus --config.file=/etc/prometheus/prometheus.yml --storage.tsdb.path=/var/lib/prometheus --web.console.templates=/etc/prometheus/con>
Nov 12 11:38:33 ip-172-31-36-200 prometheus[548]: ts=2021-11-12T11:38:33.644Z caller=head.go:590 level=info component=tsdb msg="WAL segment loaded" segment=81 maxSegment=84
Nov 12 11:38:33 ip-172-31-36-200 prometheus[548]: ts=2021-11-12T11:38:33.773Z caller=head.go:590 level=info component=tsdb msg="WAL segment loaded" segment=82 maxSegment=84
```
Note the `active (running)` status (press `q` to exit). You can also check Prometheus web interface, available on `http://your-node-host-ip:9090/`
You may need to do `sudo ufw allow 9090/tcp` if the firewall is on, and/or adjust the security settings to allow connections to port 9090 if the node is running on a cloud instance. For AWS, you can look it up [here](/docs/nodes/run-a-node/on-third-party-services/amazon-web-services#create-a-security-group). If on public internet, make sure to only allow your IP to connect!
If everything is OK, let's move on.
Step 2: Install Grafana [](#step-2-install-grafana- "Direct link to heading")
------------------------------------------------------------------------------
Run the script to execute the second step:
```bash
./monitoring-installer.sh --2
```
It should produce output something like this:
```bash
AvalancheGo monitoring installer
--------------------------------
STEP 2: Installing Grafana
OK
deb https://packages.grafana.com/oss/deb stable main
Hit:1 http://us-east-2.ec2.ports.ubuntu.com/ubuntu-ports focal InRelease
Get:2 http://us-east-2.ec2.ports.ubuntu.com/ubuntu-ports focal-updates InRelease [114 kB]
Get:3 http://us-east-2.ec2.ports.ubuntu.com/ubuntu-ports focal-backports InRelease [101 kB]
Hit:4 http://ppa.launchpad.net/longsleep/golang-backports/ubuntu focal InRelease
Get:5 http://ports.ubuntu.com/ubuntu-ports focal-security InRelease [114 kB]
Get:6 https://packages.grafana.com/oss/deb stable InRelease [12.1 kB]
...
```
To make sure it's running properly:
```bash
sudo systemctl status grafana-server
```
which should again show Grafana as `active`. Grafana should now be available at `http://your-node-host-ip:3000/` from your browser. Log in with username: admin, password: admin, and you will be prompted to set up a new, secure password. Do that.
You may need to do `sudo ufw allow 3000/tcp` if the firewall is on, and/or adjust the cloud instance settings to allow connections to port 3000. If on public internet, make sure to only allow your IP to connect!
Prometheus and Grafana are now installed, we're ready for the next step.
Step 3: Set up `node_exporter` [](#step-3-set-up-node_exporter- "Direct link to heading")
------------------------------------------------------------------------------------------
In addition to metrics from AvalancheGo, let's set up monitoring of the machine itself, so we can check CPU, memory, network and disk usage and be aware of any anomalies. For that, we will use `node_exporter`, a Prometheus plugin.
Run the script to execute the third step:
```bash
./monitoring-installer.sh --3
```
The output should look something like this:
```bash
AvalancheGo monitoring installer
--------------------------------
STEP 3: Installing node_exporter
Checking environment...
Found arm64 architecture...
Downloading archive...
https://github.com/prometheus/node_exporter/releases/download/v1.2.2/node_exporter-1.2.2.linux-arm64.tar.gz
node_exporter.tar.gz 100%[=========================================================================================>] 7.91M --.-KB/s in 0.1s
2021-11-05 14:57:25 URL:https://github-releases.githubusercontent.com/9524057/6dc22304-a1f5-419b-b296-906f6dd168dc?X-Amz-Algorithm=AWS4-HMAC-SHA256&X-Amz-Credential=AKIAIWNJYAX4CSVEH53A%2F20211105%2Fus-east-1%2Fs3%2Faws4_request&X-Amz-Date=20211105T145725Z&X-Amz-Expires=300&X-Amz-Signature=3890e09e58ea9d4180684d9286c9e791b96b0c411d8f8a494f77e99f260bdcbb&X-Amz-SignedHeaders=host&actor_id=0&key_id=0&repo_id=9524057&response-content-disposition=attachment%3B%20filename%3Dnode_exporter-1.2.2.linux-arm64.tar.gz&response-content-type=application%2Foctet-stream [8296266/8296266] -> "node_exporter.tar.gz" [1]
node_exporter-1.2.2.linux-arm64/LICENSE
```
Again, we check that the service is running correctly:
```bash
sudo systemctl status node_exporter
```
If the service is running, Prometheus, Grafana and `node_exporter` should all work together now. To check, in your browser visit Prometheus web interface on `http://your-node-host-ip:9090/targets`. You should see three targets enabled:
- Prometheus
- AvalancheGo
- `avalanchego-machine`
Make sure that all of them have `State` as `UP`.
If you run your AvalancheGo node with TLS enabled on your API port, you will need to manually edit the `/etc/prometheus/prometheus.yml` file and change the `avalanchego` job to look like this:
```yml
- job_name: "avalanchego"
metrics_path: "/ext/metrics"
scheme: "https"
tls_config:
insecure_skip_verify: true
static_configs:
- targets: ["localhost:9650"]
```
Mind the spacing (leading spaces too)! You will need admin privileges to do that (use `sudo`). Restart Prometheus service afterwards with `sudo systemctl restart prometheus`.
All that's left to do now is to provision the data source and install the actual dashboards that will show us the data.
Step 4: Dashboards [](#step-4-dashboards- "Direct link to heading")
--------------------------------------------------------------------
Run the script to install the dashboards:
```bash
./monitoring-installer.sh --4
```
It will produce output something like this:
```bash
AvalancheGo monitoring installer
--------------------------------
Downloading...
Last-modified header missing -- time-stamps turned off.
2021-11-05 14:57:47 URL:https://raw.githubusercontent.com/ava-labs/avalanche-monitoring/master/grafana/dashboards/c_chain.json [50282/50282] -> "c_chain.json" [1]
FINISHED --2021-11-05 14:57:47--
Total wall clock time: 0.2s
Downloaded: 1 files, 49K in 0s (132 MB/s)
Last-modified header missing -- time-stamps turned off.
...
```
This will download the latest versions of the dashboards from GitHub and provision Grafana to load them, as well as defining Prometheus as a data source. It may take up to 30 seconds for the dashboards to show up. In your browser, go to: `http://your-node-host-ip:3000/dashboards`. You should see 7 Avalanche dashboards:

Select 'Avalanche Main Dashboard' by clicking its title. It should load, and look similar to this:

Some graphs may take some time to populate fully, as they need a series of data points in order to render correctly.
You can bookmark the main dashboard as it shows the most important information about the node at a glance. Every dashboard has a link to all the others as the first row, so you can move between them easily.
Step 5: Additional Dashboards (Optional)[](#step-5-additional-dashboards-optional "Direct link to heading")
------------------------------------------------------------------------------------------------------------
Step 4 installs the basic set of dashboards that make sense to have on any node. Step 5 is for installing additional dashboards that may not be useful for every installation.
Currently, there is only one additional dashboard: Avalanche L1s. If your node is running any Avalanche L1s, you may want to add this as well. Do:
```bash
./monitoring-installer.sh --5
```
This will add the Avalanche L1s dashboard. It allows you to monitor operational data for any Avalanche L1 that is synced on the node. There is an Avalanche L1 switcher that allows you to switch between different Avalanche L1s. As there are many Avalanche L1s and not every node will have all of them, by default, it comes populated only with Spaces and WAGMI Avalanche L1s that exist on Fuji testnet:

To configure the dashboard and add any Layer 1s that your node is syncing, you will need to edit the dashboard. Select the `dashboard settings` icon (image of a cog) in the upper right corner of the dashboard display and switch to `Variables` section and select the `subnet` variable. It should look something like this:

The variable format is:
```bash
Subnet name:
```
and the separator between entries is a comma. Entries for Spaces and WAGMI look like:
```bash
Spaces (Fuji) : 2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt, WAGMI (Fuji) : 2AM3vsuLoJdGBGqX2ibE8RGEq4Lg7g4bot6BT1Z7B9dH5corUD
```
After editing the values, press `Update` and then click `Save dashboard` button and confirm. Press the back arrow in the upper left corner to return to the dashboard. New values should now be selectable from the dropdown and data for the selected Avalanche L1 will be shown in the panels.
Updating[](#updating "Direct link to heading")
-----------------------------------------------
Available node metrics are updated constantly, new ones are added and obsolete removed, so it is good a practice to update the dashboards from time to time, especially if you notice any missing data in panels. Updating the dashboards is easy, just run the script with no arguments, and it will refresh the dashboards with the latest available versions. Allow up to 30s for dashboards to update in Grafana.
If you added the optional extra dashboards (step 5), they will be updated as well.
Summary[](#summary "Direct link to heading")
---------------------------------------------
Using the script to install node monitoring is easy, and it gives you insight into how your node is behaving and what's going on under the hood. Also, pretty graphs!
If you have feedback on this tutorial, problems with the script or following the steps, send us a message on [Discord](https://chat.avalabs.org/).
# Run Avalanche Node in Background (/docs/nodes/maintain/run-as-background-service)
---
title: Run Avalanche Node in Background
---
This page demonstrates how to set up a `avalanchego.service` file to enable a manually deployed validator node to run in the background of a server instead of in the terminal directly.
Make sure that AvalancheGo is already installed on your machine.
Steps[](#steps "Direct link to heading")
-----------------------------------------
### Fuji Testnet Config[](#fuji-testnet-config "Direct link to heading")
Run this command in your terminal to create the `avalanchego.service` file
```bash
sudo nano /etc/systemd/system/avalanchego.service
```
Paste the following configuration into the `avalanchego.service` file
Remember to modify the values of:
- _**user=**_
- _**group=**_
- _**WorkingDirectory=**_
- _**ExecStart=**_
For those that you have configured on your Server:
```toml
[Unit]
Description=Avalanche Node service
After=network.target
[Service]
User='YourUserHere'
Group='YourUserHere'
Restart=always
PrivateTmp=true
TimeoutStopSec=60s
TimeoutStartSec=10s
StartLimitInterval=120s
StartLimitBurst=5
WorkingDirectory=/Your/Path/To/avalanchego
ExecStart=/Your/Path/To/avalanchego/./avalanchego \
--network-id=fuji \
--api-metrics-enabled=true
[Install]
WantedBy=multi-user.target
```
Press **Ctrl + X** then **Y** then **Enter** to save and exit.
Now, run:
```bash
sudo systemctl daemon-reload
```
### Mainnet Config[](#mainnet-config "Direct link to heading")
Run this command in your terminal to create the `avalanchego.service` file
```bash
sudo nano /etc/systemd/system/avalanchego.service
```
Paste the following configuration into the `avalanchego.service` file
```toml
[Unit]
Description=Avalanche Node service
After=network.target
[Service]
User='YourUserHere'
Group='YourUserHere'
Restart=always
PrivateTmp=true
TimeoutStopSec=60s
TimeoutStartSec=10s
StartLimitInterval=120s
StartLimitBurst=5
WorkingDirectory=/Your/Path/To/avalanchego
ExecStart=/Your/Path/To/avalanchego/./avalanchego \
--api-metrics-enabled=true
[Install]
WantedBy=multi-user.target
```
Press **Ctrl + X** then **Y** then **Enter** to save and exit.
Now, run:
```bash
sudo systemctl daemon-reload
```
Start the Node[](#start-the-node "Direct link to heading")
-----------------------------------------------------------
This command makes your node start automatically in case of a reboot, run it:
```bash
sudo systemctl enable avalanchego
```
To start the node, run:
```bash
sudo systemctl start avalanchego
sudo systemctl status avalanchego
```
Output:
```bash
socopower@avalanche-node-01:~$ sudo systemctl status avalanchego
● avalanchego.service - Avalanche Node service
Loaded: loaded (/etc/systemd/system/avalanchego.service; enabled; vendor p>
Active: active (running) since Tue 2023-08-29 23:14:45 UTC; 5h 46min ago
Main PID: 2226 (avalanchego)
Tasks: 27 (limit: 38489)
Memory: 8.7G
CPU: 5h 50min 31.165s
CGroup: /system.slice/avalanchego.service
└─2226 /usr/local/bin/avalanchego/./avalanchego --network-id=fuji
Aug 30 03:02:50 avalanche-node-01 avalanchego[2226]: INFO [08-30|03:02:50.685] >
Aug 30 03:02:51 avalanche-node-01 avalanchego[2226]: INFO [08-30|03:02:51.185] >
Aug 30 03:03:09 avalanche-node-01 avalanchego[2226]: [08-30|03:03:09.380] INFO >
Aug 30 03:03:23 avalanche-node-01 avalanchego[2226]: [08-30|03:03:23.983] INFO >
Aug 30 03:05:15 avalanche-node-01 avalanchego[2226]: [08-30|03:05:15.192] INFO >
Aug 30 03:05:15 avalanche-node-01 avalanchego[2226]: [08-30|03:05:15.237] INFO >
Aug 30 03:05:15 avalanche-node-01 avalanchego[2226]: [08-30|03:05:15.238] INFO >
Aug 30 03:05:19 avalanche-node-01 avalanchego[2226]: [08-30|03:05:19.809] INFO >
Aug 30 03:05:19 avalanche-node-01 avalanchego[2226]: [08-30|03:05:19.809] INFO >
Aug 30 05:00:47 avalanche-node-01 avalanchego[2226]: [08-30|05:00:47.001] INFO
```
To see the synchronization process, you can run the following command:
```bash
sudo journalctl -fu avalanchego
```
# Upgrade Your AvalancheGo Node (/docs/nodes/maintain/upgrade)
---
title: Upgrade Your AvalancheGo Node
---
Backup Your Node[](#backup-your-node "Direct link to heading")
---------------------------------------------------------------
Before upgrading your node, it is recommended you backup your staker files which are used to identify your node on the network. In the default installation, you can copy them by running following commands:
```bash
cd
cp ~/.avalanchego/staking/staker.crt .
cp ~/.avalanchego/staking/staker.key .
```
Then download `staker.crt` and `staker.key` files and keep them somewhere safe and private. If anything happens to your node or the machine node runs on, these files can be used to fully recreate your node.
If you use your node for development purposes and have keystore users on your node, you should back up those too.
Node Installed Using the Installer Script[](#node-installed-using-the-installer-script "Direct link to heading")
-----------------------------------------------------------------------------------------------------------------
If you installed your node using the [installer script](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go), to upgrade your node, just run the installer script again.
```bash
./avalanchego-installer.sh
```
It will detect that you already have AvalancheGo installed:
```bash
AvalancheGo installer
---------------------
Preparing environment...
Found 64bit Intel/AMD architecture...
Found AvalancheGo systemd service already installed, switching to upgrade mode.
Stopping service...
```
It will then upgrade your node to the latest version, and after it's done, start the node back up, and print out the information about the latest version:
```bash
Node upgraded, starting service...
New node version:
avalanche/1.1.1 [network=mainnet, database=v1.0.0, commit=f76f1fd5f99736cf468413bbac158d6626f712d2]
Done!
```
And that is it, your node is upgraded to the latest version.
If you installed your node manually, proceed with the rest of the tutorial.
Stop the Old Node Version[](#stop-the-old-node-version "Direct link to heading")
---------------------------------------------------------------------------------
After the backup is secured, you may start upgrading your node. Begin by stopping the currently running version.
### Node Running from Terminal[](#node-running-from-terminal "Direct link to heading")
If your node is running in a terminal stop it by pressing `ctrl+c`.
### Node Running as a Service[](#node-running-as-a-service "Direct link to heading")
If your node is running as a service, stop it by entering: `sudo systemctl stop avalanchego.service`
(your service may be named differently, `avalanche.service`, or similar)
### Node Running in Background[](#node-running-in-background "Direct link to heading")
If your node is running in the background (by running with `nohup`, for example) then find the process running the node by running `ps aux | grep avalanche`. This will produce output like:
```bash
ubuntu 6834 0.0 0.0 2828 676 pts/1 S+ 19:54 0:00 grep avalanche
ubuntu 2630 26.1 9.4 2459236 753316 ? Sl Dec02 1220:52 /home/ubuntu/build/avalanchego
```
In this example, second line shows information about your node. Note the process id, in this case, `2630`. Stop the node by running `kill -2 2630`.
Now we are ready to download the new version of the node. You can either download the source code and then build the binary program, or you can download the pre-built binary. You don't need to do both.
Downloading pre-built binary is easier and recommended if you're just looking to run your own node and stake on it.
Building the node [from source](/docs/nodes/maintain/upgrade#build-from-source) is recommended if you're a developer looking to experiment and build on Avalanche.
Download Pre-Built Binary[](#download-pre-built-binary "Direct link to heading")
---------------------------------------------------------------------------------
If you want to download a pre-built binary instead of building it yourself, go to our [releases page](https://github.com/ava-labs/avalanchego/releases), and select the release you want (probably the latest one.)
If you have a node, you can subscribe to the [avalanche notify service](/docs/nodes/maintain/enroll-in-avalanche-notify) with your node ID to be notified about new releases.
In addition, or if you don't have a node ID, you can get release notifications from github. To do so, you can go to our [repository](https://github.com/ava-labs/avalanchego) and look on the top-right corner for the **Watch** option. After you click on it, select **Custom**, and then **Releases**. Press **Apply** and it is done.
Under `Assets`, select the appropriate file.
For MacOS:
Download: `avalanchego-macos-.zip`
Unzip: `unzip avalanchego-macos-.zip`
The resulting folder, `avalanchego-`, contains the binaries.
For Linux on PCs or cloud providers:
Download: `avalanchego-linux-amd64-.tar.gz`
Unzip: `tar -xvf avalanchego-linux-amd64-.tar.gz`
The resulting folder, `avalanchego--linux`, contains the binaries.
For Linux on Arm64-based computers:
Download: `avalanchego-linux-arm64-.tar.gz`
Unzip: `tar -xvf avalanchego-linux-arm64-.tar.gz`
The resulting folder, `avalanchego--linux`, contains the binaries.
You are now ready to run the new version of the node.
### Running the Node from Terminal[](#running-the-node-from-terminal "Direct link to heading")
If you are using the pre-built binaries on MacOS:
```bash
./avalanchego-/build/avalanchego
```
If you are using the pre-built binaries on Linux:
```bash
./avalanchego--linux/avalanchego
```
Add `nohup` at the start of the command if you want to run the node in the background.
### Running the Node as a Service[](#running-the-node-as-a-service "Direct link to heading")
If you're running the node as a service, you need to replace the old binaries with the new ones.
```bash
cp -r avalanchego--linux/*
```
and then restart the service with: `sudo systemctl start avalanchego.service`.
Build from Source[](#build-from-source "Direct link to heading")
-----------------------------------------------------------------
First clone our GitHub repo (you can skip this step if you've done this before):
```bash
git clone https://github.com/ava-labs/avalanchego.git
```
The repository cloning method used is HTTPS, but SSH can be used too:
`git clone git@github.com:ava-labs/avalanchego.git`
You can find more about SSH and how to use it [here](https://docs.github.com/en/authentication/connecting-to-github-with-ssh/about-ssh).
Then move to the AvalancheGo directory:
```bash
cd avalanchego
```
Pull the latest code:
```bash
git pull
```
If the master branch has not been updated with the latest release tag, you can get to it directly via first running `git fetch --all --tags` and then `git checkout --force tags/` (where `` is the latest release tag; for example `v1.3.2`) instead of `git pull`.
Note that your local copy will be in a 'detached HEAD' state, which is not an issue if you do not make changes to the source that you want push back to the repository (in which case you should check out to a branch and to the ordinary merges).
Note also that the `--force` flag will disregard any local changes you might have.
Check that your local code is up to date. Do:
```bash
git rev-parse HEAD
```
and check that the first 7 characters printed match the Latest commit field on our [GitHub](https://github.com/ava-labs/avalanchego).
If you used the `git checkout tags/` then these first 7 characters should match commit hash of that tag.
Now build the binary:
```bash
./scripts/build.sh
```
This should print: `Build Successful`
You can check what version you're running by doing:
```bash
./build/avalanchego --version
```
You can run your node with:
```bash
./build/avalanchego
```
# Subnet-EVM Configs (/docs/nodes/chain-configs/subnet-evm)
---
title: "Subnet-EVM Configs"
description: "This page describes the configuration options available for the Subnet-EVM."
edit_url: https://github.com/ava-labs/subnet-evm/edit/master/plugin/evm/config/config.md
---
# Subnet-EVM Configuration
> **Note**: These are the configuration options available in the Subnet-EVM codebase. To set these values, you need to create a configuration file at `~/.avalanchego/configs/chains//config.json`.
>
> For the AvalancheGo node configuration options, see the AvalancheGo Configuration page.
This document describes all configuration options available for Subnet-EVM.
## Example Configuration
```json
{
"eth-apis": ["eth", "eth-filter", "net", "web3"],
"pruning-enabled": true,
"commit-interval": 4096,
"trie-clean-cache": 512,
"trie-dirty-cache": 512,
"snapshot-cache": 256,
"rpc-gas-cap": 50000000,
"log-level": "info",
"metrics-expensive-enabled": true,
"continuous-profiler-dir": "./profiles",
"state-sync-enabled": false,
"accepted-cache-size": 32
}
```
## Configuration Format
Configuration is provided as a JSON object. All fields are optional unless otherwise specified.
## API Configuration
### Ethereum APIs
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `eth-apis` | array of strings | List of Ethereum services that should be enabled | `["eth", "eth-filter", "net", "web3", "internal-eth", "internal-blockchain", "internal-transaction"]` |
### Subnet-EVM Specific APIs
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `validators-api-enabled` | bool | Enable the validators API | `true` |
| `admin-api-enabled` | bool | Enable the admin API for administrative operations | `false` |
| `admin-api-dir` | string | Directory for admin API operations | - |
| `warp-api-enabled` | bool | Enable the Warp API for cross-chain messaging | `false` |
### API Limits and Security
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `rpc-gas-cap` | uint64 | Maximum gas limit for RPC calls | `50,000,000` |
| `rpc-tx-fee-cap` | float64 | Maximum transaction fee cap in AVAX | `100` |
| `api-max-duration` | duration | Maximum duration for API calls (0 = no limit) | `0` |
| `api-max-blocks-per-request` | int64 | Maximum number of blocks per getLogs request (0 = no limit) | `0` |
| `http-body-limit` | uint64 | Maximum size of HTTP request bodies | - |
| `batch-request-limit` | uint64 | Maximum number of requests that can be batched in an RPC call. For no limit, set either this or `batch-response-max-size` to 0 | `1000` |
| `batch-response-max-size` | uint64 | Maximum size (in bytes) of response that can be returned from a batched RPC call. For no limit, set either this or `batch-request-limit` to 0. Defaults to `25 MB`| `1000` |
### WebSocket Settings
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `ws-cpu-refill-rate` | duration | Rate at which WebSocket CPU usage quota is refilled (0 = no limit) | `0` |
| `ws-cpu-max-stored` | duration | Maximum stored WebSocket CPU usage quota (0 = no limit) | `0` |
## Cache Configuration
### Trie Caches
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `trie-clean-cache` | int | Size of the trie clean cache in MB | `512` |
| `trie-dirty-cache` | int | Size of the trie dirty cache in MB | `512` |
| `trie-dirty-commit-target` | int | Memory limit to target in the dirty cache before performing a commit in MB | `20` |
| `trie-prefetcher-parallelism` | int | Maximum concurrent disk reads trie prefetcher should perform | `16` |
### Other Caches
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `snapshot-cache` | int | Size of the snapshot disk layer clean cache in MB | `256` |
| `accepted-cache-size` | int | Depth to keep in the accepted headers and logs cache (blocks) | `32` |
| `state-sync-server-trie-cache` | int | Trie cache size for state sync server in MB | `64` |
## Ethereum Settings
### Transaction Processing
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `preimages-enabled` | bool | Enable preimage recording | `false` |
| `allow-unfinalized-queries` | bool | Allow queries for unfinalized blocks | `false` |
| `allow-unprotected-txs` | bool | Allow unprotected transactions (without EIP-155) | `false` |
| `allow-unprotected-tx-hashes` | array | List of specific transaction hashes allowed to be unprotected | EIP-1820 registry tx |
| `local-txs-enabled` | bool | Enable treatment of transactions from local accounts as local | `false` |
### Snapshots
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `snapshot-wait` | bool | Wait for snapshot generation on startup | `false` |
| `snapshot-verification-enabled` | bool | Enable snapshot verification | `false` |
## Pruning and State Management
> **Note**: If a node is ever run with `pruning-enabled` as `false` (archival mode), setting `pruning-enabled` to `true` will result in a warning and the node will shut down. This is to protect against unintentional misconfigurations of an archival node. To override this and switch to pruning mode, in addition to `pruning-enabled: true`, `allow-missing-tries` should be set to `true` as well.
### Basic Pruning
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `pruning-enabled` | bool | Enable state pruning to save disk space | `true` |
| `commit-interval` | uint64 | Interval at which to persist EVM and atomic tries (blocks) | `4096` |
| `accepted-queue-limit` | int | Maximum blocks to queue before blocking during acceptance | `64` |
### State Reconstruction
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `allow-missing-tries` | bool | Suppress warnings about incomplete trie index | `false` |
| `populate-missing-tries` | uint64 | Starting block for re-populating missing tries (null = disabled) | `null` |
| `populate-missing-tries-parallelism` | int | Concurrent readers for re-populating missing tries | `1024` |
### Offline Pruning
> **Note**: If offline pruning is enabled it will run on startup and block until it completes (approximately one hour on Mainnet). This will reduce the size of the database by deleting old trie nodes. **While performing offline pruning, your node will not be able to process blocks and will be considered offline.** While ongoing, the pruning process consumes a small amount of additional disk space (for deletion markers and the bloom filter). For more information see the [disk space considerations documentation](https://build.avax.network/docs/nodes/maintain/reduce-disk-usage#disk-space-considerations). Since offline pruning deletes old state data, this should not be run on nodes that need to support archival API requests. This is meant to be run manually, so after running with this flag once, it must be toggled back to false before running the node again. Therefore, you should run with this flag set to true and then set it to false on the subsequent run.
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `offline-pruning-enabled` | bool | Enable offline pruning | `false` |
| `offline-pruning-bloom-filter-size` | uint64 | Bloom filter size for offline pruning in MB | `512` |
| `offline-pruning-data-directory` | string | Directory for offline pruning data | - |
### Historical Data
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `historical-proof-query-window` | uint64 | Number of blocks before last accepted for proof queries (archive mode only, ~24 hours) | `43200` |
| `state-history` | uint64 | Number of most recent states that are accesible on disk (pruning mode only) | `32` |
## Transaction Pool Configuration
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `tx-pool-price-limit` | uint64 | Minimum gas price for transaction acceptance | - |
| `tx-pool-price-bump` | uint64 | Minimum price bump percentage for transaction replacement | - |
| `tx-pool-account-slots` | uint64 | Maximum number of executable transaction slots per account | - |
| `tx-pool-global-slots` | uint64 | Maximum number of executable transaction slots for all accounts | - |
| `tx-pool-account-queue` | uint64 | Maximum number of non-executable transaction slots per account | - |
| `tx-pool-global-queue` | uint64 | Maximum number of non-executable transaction slots for all accounts | - |
| `tx-pool-lifetime` | duration | Maximum time transactions can stay in the pool | - |
## Gossip Configuration
### Push Gossip Settings
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `push-gossip-percent-stake` | float64 | Percentage of total stake to push gossip to (range: [0, 1]) | `0.9` |
| `push-gossip-num-validators` | int | Number of validators to push gossip to | `100` |
| `push-gossip-num-peers` | int | Number of non-validator peers to push gossip to | `0` |
### Regossip Settings
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `push-regossip-num-validators` | int | Number of validators to regossip to | `10` |
| `push-regossip-num-peers` | int | Number of non-validator peers to regossip to | `0` |
| `priority-regossip-addresses` | array | Addresses to prioritize for regossip | - |
### Timing Configuration
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `push-gossip-frequency` | duration | Frequency of push gossip | `100ms` |
| `pull-gossip-frequency` | duration | Frequency of pull gossip | `1s` |
| `regossip-frequency` | duration | Frequency of regossip | `30s` |
## Logging and Monitoring
### Logging
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `log-level` | string | Logging level (trace, debug, info, warn, error, crit) | `"info"` |
| `log-json-format` | bool | Use JSON format for logs | `false` |
### Profiling
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `continuous-profiler-dir` | string | Directory for continuous profiler output (empty = disabled) | - |
| `continuous-profiler-frequency` | duration | Frequency to run continuous profiler | `15m` |
| `continuous-profiler-max-files` | int | Maximum number of profiler files to maintain | `5` |
### Metrics
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `metrics-expensive-enabled` | bool | Enable expensive debug-level metrics; this includes Firewood metrics | `true` |
## Security and Access
### Keystore
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `keystore-directory` | string | Directory for keystore files (absolute or relative path) | - |
| `keystore-external-signer` | string | External signer configuration | - |
| `keystore-insecure-unlock-allowed` | bool | Allow insecure account unlocking | `false` |
### Fee Configuration
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `feeRecipient` | string | Address to send transaction fees to (leave empty if not supported) | - |
## Network and Sync
### Network
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `max-outbound-active-requests` | int64 | Maximum number of outbound active requests for VM2VM network | `16` |
### State Sync
> **Note:** If state-sync is enabled, the peer will download chain state from peers up to a recent block near tip, then proceed with normal bootstrapping. Please note that if you need historical data, state sync isn't the right option. However, it is sufficient if you are just running a validator.
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `state-sync-enabled` | bool | Enable state sync | `false` |
| `state-sync-skip-resume` | bool | Force state sync to use highest available summary block | `false` |
| `state-sync-ids` | string | Comma-separated list of state sync IDs | - |
| `state-sync-commit-interval` | uint64 | Commit interval for state sync (blocks) | `16384` |
| `state-sync-min-blocks` | uint64 | Minimum blocks ahead required for state sync | `300000` |
| `state-sync-request-size` | uint16 | Number of key/values to request per state sync request | `1024` |
## Database Configuration
> **WARNING**: `firewood` and `path` schemes are untested in production. Using `path` is strongly discouraged. To use `firewood`, you must also set the following config options:
>
> - `populate-missing-tries: nil`
> - `state-sync-enabled: false`
> - `snapshot-cache: 0`
Failing to set these options will result in errors on VM initialization. Additionally, not all APIs are available - see these portions of the config documentation for more details.
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `database-type` | string | Type of database to use | `"pebbledb"` |
| `database-path` | string | Path to database directory | - |
| `database-read-only` | bool | Open database in read-only mode | `false` |
| `database-config` | string | Inline database configuration | - |
| `database-config-file` | string | Path to database configuration file | - |
| `use-standalone-database` | bool | Use standalone database instead of shared one | - |
| `inspect-database` | bool | Inspect database on startup | `false` |
| `state-scheme` | string | EXPERIMENTAL: specifies the database scheme to store state data; can be one of `hash` or `firewood` | `hash` |
## Transaction Indexing
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `transaction-history` | uint64 | Maximum number of blocks from head whose transaction indices are reserved (0 = no limit) | - |
| `tx-lookup-limit` | uint64 | **Deprecated** - use `transaction-history` instead | - |
| `skip-tx-indexing` | bool | Skip indexing transactions entirely | `false` |
## Warp Configuration
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `warp-off-chain-messages` | array | Off-chain messages the node should be willing to sign | - |
| `prune-warp-db-enabled` | bool | Clear warp database on startup | `false` |
## Miscellaneous
| Option | Type | Description | Default |
|--------|------|-------------|---------|
| `airdrop` | string | Path to airdrop file | - |
| `skip-upgrade-check` | bool | Skip checking that upgrades occur before last accepted block ⚠️ **Warning**: Only use when you understand the implications | `false` |
| `min-delay-target` | integer | The minimum delay between blocks (in milliseconds) that this node will attempt to use when creating blocks | Parent block's target |
## Gossip Constants
The following constants are defined for transaction gossip behavior and cannot be configured without a custom build of Subnet-EVM:
| Constant | Type | Description | Value |
|----------|------|-------------|-------|
| Bloom Filter Min Target Elements | int | Minimum target elements for bloom filter | `8,192` |
| Bloom Filter Target False Positive Rate | float | Target false positive rate | `1%` |
| Bloom Filter Reset False Positive Rate | float | Reset false positive rate | `5%` |
| Bloom Filter Churn Multiplier | int | Churn multiplier | `3` |
| Push Gossip Discarded Elements | int | Number of discarded elements | `16,384` |
| Tx Gossip Target Message Size | size | Target message size for transaction gossip | `20 KiB` |
| Tx Gossip Throttling Period | duration | Throttling period | `10s` |
| Tx Gossip Throttling Limit | int | Throttling limit | `2` |
| Tx Gossip Poll Size | int | Poll size | `1` |
## Validation Notes
- Cannot enable `populate-missing-tries` while pruning or offline pruning is enabled
- Cannot run offline pruning while pruning is disabled
- Commit interval must be non-zero when pruning is enabled
- `push-gossip-percent-stake` must be in range `[0, 1]`
- Some settings may require node restart to take effect
# Avalanche L1 Configs (/docs/nodes/configure/avalanche-l1-configs)
---
title: "Avalanche L1 Configs"
description: "This page describes the configuration options available for Avalanche L1s."
edit_url: https://github.com/ava-labs/avalanchego/edit/master/subnets/config.md
---
# Subnet Configs
It is possible to provide parameters for a Subnet. Parameters here apply to all
chains in the specified Subnet.
AvalancheGo looks for files specified with `{subnetID}.json` under
`--subnet-config-dir` as documented
[here](https://build.avax.network/docs/nodes/configure/configs-flags#subnet-configs).
Here is an example of Subnet config file:
```json
{
"validatorOnly": false,
"consensusParameters": {
"k": 25,
"alpha": 18
}
}
```
## Parameters
### Private Subnet
#### `validatorOnly` (bool)
If `true` this node does not expose Subnet blockchain contents to non-validators
via P2P messages. Defaults to `false`.
Avalanche Subnets are public by default. It means that every node can sync and
listen ongoing transactions/blocks in Subnets, even they're not validating the
listened Subnet.
Subnet validators can choose not to publish contents of blockchains via this
configuration. If a node sets `validatorOnly` to true, the node exchanges
messages only with this Subnet's validators. Other peers will not be able to
learn contents of this Subnet from this node.
:::tip
This is a node-specific configuration. Every validator of this Subnet has to use
this configuration in order to create a full private Subnet.
:::
#### `allowedNodes` (string list)
If `validatorOnly=true` this allows explicitly specified NodeIDs to be allowed
to sync the Subnet regardless of validator status. Defaults to be empty.
:::tip
This is a node-specific configuration. Every validator of this Subnet has to use
this configuration in order to properly allow a node in the private Subnet.
:::
### Consensus Parameters
Subnet configs supports loading new consensus parameters. JSON keys are
different from their matching `CLI` keys. These parameters must be grouped under
`consensusParameters` key. The consensus parameters of a Subnet default to the
same values used for the Primary Network, which are given [CLI Snow Parameters](https://build.avax.network/docs/nodes/configure/configs-flags#snow-parameters).
| CLI Key | JSON Key |
| :------------------------------- | :-------------------- |
| --snow-sample-size | k |
| --snow-quorum-size | alpha |
| --snow-commit-threshold | `beta` |
| --snow-concurrent-repolls | concurrentRepolls |
| --snow-optimal-processing | `optimalProcessing` |
| --snow-max-processing | maxOutstandingItems |
| --snow-max-time-processing | maxItemProcessingTime |
| --snow-avalanche-batch-size | `batchSize` |
| --snow-avalanche-num-parents | `parentSize` |
#### `proposerMinBlockDelay` (duration)
The minimum delay performed when building snowman++ blocks. Default is set to 1 second.
As one of the ways to control network congestion, Snowman++ will only build a
block `proposerMinBlockDelay` after the parent block's timestamp. Some
high-performance custom VMs may find this too strict. This flag allows tuning the
frequency at which blocks are built.
### Gossip Configs
It's possible to define different Gossip configurations for each Subnet without
changing values for Primary Network. JSON keys of these
parameters are different from their matching `CLI` keys. These parameters
default to the same values used for the Primary Network. For more information
see [CLI Gossip Configs](https://build.avax.network/docs/nodes/configure/configs-flags#gossiping).
| CLI Key | JSON Key |
| :------------------------------------------------------ | :------------------------------------- |
| --consensus-accepted-frontier-gossip-validator-size | gossipAcceptedFrontierValidatorSize |
| --consensus-accepted-frontier-gossip-non-validator-size | gossipAcceptedFrontierNonValidatorSize |
| --consensus-accepted-frontier-gossip-peer-size | gossipAcceptedFrontierPeerSize |
| --consensus-on-accept-gossip-validator-size | gossipOnAcceptValidatorSize |
| --consensus-on-accept-gossip-non-validator-size | gossipOnAcceptNonValidatorSize |
| --consensus-on-accept-gossip-peer-size | gossipOnAcceptPeerSize |
# AvalancheGo Config Flags (/docs/nodes/configure/configs-flags)
---
title: "AvalancheGo Config Flags"
description: "This page lists all available configuration options for AvalancheGo nodes."
edit_url: https://github.com/ava-labs/avalanchego/edit/master/config/config.md
---
# AvalancheGo Configs and Flags
This document lists all available configuration options for AvalancheGo nodes. You can configure your node using either command-line flags or environment variables.
> **Note:** For comparison with the previous documentation format (using individual flag headings), see the [archived version](https://gist.github.com/navillanueva/cdb9c49c411bd89a9480f05a7afbab37).
## Environment Variable Naming Convention
All environment variables follow the pattern: `AVAGO_` + flag name where the flag name is converted to uppercase with hyphens replaced by underscores.
For example:
- Flag: `--api-admin-enabled`
- Environment Variable: `AVAGO_API_ADMIN_ENABLED`
## Example Usage
### Using Command-Line Flags
```bash
avalanchego --network-id=fuji --http-host=0.0.0.0 --log-level=debug
```
### Using Environment Variables
```bash
export AVAGO_NETWORK_ID=fuji
export AVAGO_HTTP_HOST=0.0.0.0
export AVAGO_LOG_LEVEL=debug
avalanchego
```
### Using Config File
Create a JSON config file:
```json
{
"network-id": "fuji",
"http-host": "0.0.0.0",
"log-level": "debug"
}
```
Run with:
```bash
avalanchego --config-file=/path/to/config.json
```
## Configuration Precedence
Configuration sources are applied in the following order (highest to lowest precedence):
1. Command-line flags
2. Environment variables
3. Config file
4. Default values
# Configuration Options
